Table of Contents
1.1 Background
1.2 Scope
of Report
1.3 Organization
Structure
1.4 Summary
of Construction Works
2.1 Air
quality
2.2 Noise
Monitoring
2.3 Water
Quality Monitoring
2.4 Dolphin
monitoring
2.5 EM&A
Site inspection
2.6 Waste
Management Status
2.7 Environmental
Licenses and Permits
2.8 Implementation
Status of Environmental Mitigation Measures
2.9 Summary
of Exceedances of the Environmental Quality Performance Limit
2.10 Summary
of Complaints, Notification of Summons and Successful Prosecutions
3.1 Construction
Programme for the Coming Months
3.2 Key
Issues for the Coming Month
3.3 Monitoring
Schedule for the Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
List
of Appendices
Appendix A |
|
Appendix B |
|
Appendix C |
Implementation Schedule
of Environmental Mitigation Measures (EMIS) |
Appendix D |
|
Appendix E |
|
Appendix F |
|
Appendix G |
Impact Air Quality
Monitoring Results and Graphical Presentation |
Appendix H |
|
Appendix I |
|
Appendix J |
Impact Water Quality
Monitoring Results and Graphical Presentation |
Appendix K |
|
Appendix L |
|
Appendix M |
|
Appendix N |
Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Southern
Connection Viaduct Section of the Tuen Mun ¡V Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON
Hong Kong Ltd. was employed by the HyD as the
Independent Environmental Checker (IEC) and Environmental Project Office (ENPO)
in accordance with Environmental Permit
No. EP-354/2009/A.
Further applications
for variation of environmental permit (VEP), EP-354/2009/B and EP-354/2009/C,
were granted on 28 January 2014 and 10 December 2014, respectively.
The
construction phase of the Contract commenced on 31 October 2013 and will
tentatively be completed by 2018.
The impact monitoring of the EM&A programme, including air quality,
noise, water quality and marine ecological monitoring as well as environmental
site inspections, commenced on 31 October 2013.
This
is the Fifteenth Monthly EM&A report presenting the EM&A works carried
out during the period from 1 to 31 January 2015 for the Southern
Connection Viaduct Section in accordance with the Updated EM&A Manual of the
TM-CLK Link Project. As informed by the Contractor, major
activities in the reporting period included:
Marine Works
¡P
Construction of Pile caps at Viaducts B, C & E;
¡P
Marine piling platform installation for Viaducts A, B,
C, D & E;
¡P
Marine Piling at Viaducts B, C, D & E; and
¡P
Additional marine ground investigation (GI) and
laboratory testing.
Land-based
Works
¡P
Construction of pile cap superstructure of Viaduct B
& C;
¡P
Channel re-construction at Area 1;
¡P
Land Piling at Viaducts B, C & D;
¡P
Pre-drilling works at Viaduct A;
¡P
Construction of pile cap at Viaducts B & D;
¡P
Additional land GI, trial pits & lab testing;
¡P
Utility surveys; and
¡P
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
A summary of
monitoring and audit activities conducted in the reporting period is listed
below:
24-hour
TSP monitoring 6
sessions
1-hour
TSP monitoring 6
sessions
Noise
monitoring 6
sessions
Impact Water
Quality Monitoring 14
sessions
Impact Dolphin
Monitoring 2
sessions
Joint
Environmental site inspection 4
sessions
Breaches of Action and Limit Levels for Air Quality
No exceedance
of Action and Limit Levels was recorded for construction air monitoring in the
reporting month.
Breaches of Action and Limit Levels for Noise
No exceedance
of Action and Limit Levels was recorded for construction noise monitoring in
the reporting month.
Breaches of Action and Limit Levels for Water Quality
No exceedance
of Action and Limit Levels was recorded for impact water quality monitoring in
the reporting month.
Impact Dolphin Monitoring
During
this month of dolphin monitoring, no unacceptable impact from the construction activities
of the TM-CLKL Southern Connection Viaduct Section on Chinese White Dolphins
was noticeable from general observations.
Due to monthly variation in dolphin occurrence within the study area, it
would be more appropriate to draw conclusion on whether any impacts on dolphins
have been detected related to the construction activities of the TM-CLKL
Southern Connection Viaduct Section in the quarterly EM&A reports, where
comparison on distribution, group size and encounter rates of dolphins between
the quarterly impact monitoring period and baseline monitoring period will be
made.
Daily
marine mammal exclusion zone monitoring was undertaken during the period of
marine works under this Contract. No Passive Acoustic Monitoring (PAM) was
carried out as there was no marine works carried out outside the daylight hours
in this reporting month. No sighting of the Indo-Pacific humpback dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was recorded in January 2015 during the exclusion
zone monitoring.
Environmental Complaints, Non-compliance & Summons
No environmental
complaint, notification of summons and successful prosecution was received in
the reporting month.
Reporting Change
There was no
reporting change required in the reporting period.
Upcoming Works for the Next Reporting Period
Works to be
undertaken in the next monitoring period of February 2015 include the
following:
Marine
Works
¡P
Construction of Pile caps at Viaducts B & E;
¡P
Marine piling platform installation for Viaducts A, B,
C, D & E;
¡P
Marine Piling at Viaducts B, C, D & E; and
¡P
Additional marine ground investigation (GI) and
laboratory testing.
Land-based
Works
¡P
Construction of pile cap superstructure of Viaduct B;
¡P
Channel re-construction at Area 1;
¡P
Land Piling at Viaducts B, C & D;
¡P
Pre-drilling works at Viaduct A;
¡P
Construction of pile cap at Viaducts B & D;
¡P
Additional land GI, trial pits & lab testing;
¡P
Utility surveys; and
¡P
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
Future Key Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of February 2015 are mainly associated with dust, noise,
marine water quality, marine ecology and waste management issues.
According to
the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure
Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau
Link and North Lantau Highway would be operating beyond capacity after
2016. This forecast has been based
on the estimated increase in cross boundary traffic, developments in the
Northwest New Territories (NWNT), and possible developments in North Lantau,
including the Airport developments, the Lantau Logistics Park (LLP) and the
Hong Kong ¡V Zhuhai ¡V Macao Bridge (HZMB).
In order to cope with the anticipated traffic demand, two new road
sections between NWNT and North Lantau ¡V Tuen Mun ¡V Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The
EIA Report was submitted under the Environmental Impact Assessment Ordinance
(EIAO) in August 2009. Subsequent
to the approval of the EIA Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (EP-354/2009/A)
was issued on 8 December 2010.
Under
Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of TM-CLKL (¡§the Contract¡¨) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON
Hong Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO) in
accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of
environmental permit (VEP), EP-354/2009/B
and EP-354/2009/C, were granted
on 28 January 2014 and 10 December 2014, respectively.
The organization
structure of the Contract is shown in Appendix A. The key personnel contact names and
contact details are summarized in Table
1.1 below.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD
(Highways Department) |
Project
Coordinator |
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior
Engineer |
Steven Shum |
2762 4133 |
3188 6614 |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident Engineer |
Kingman Chan |
3691 3950 |
3691 2899 |
ENPO / IEC (ENVIRON
Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465 2888 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3465 2828 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Marine Works
¡P
Construction of Pile caps at Viaducts B, C & E;
¡P
Marine piling platform installation for Viaducts A, B,
C, D & E;
¡P
Marine Piling at Viaducts B, C, D & E; and
¡P
Additional marine ground investigation (GI) and
laboratory testing.
Land-based
Works
¡P
Construction of pile cap superstructure of Viaduct B
& C;
¡P
Channel re-construction at Area 1;
¡P
Land Piling at Viaducts B, C & D;
¡P
Pre-drilling works at Viaduct A;
¡P
Construction of pile cap at Viaducts B & D;
¡P
Additional land GI, trial pits & lab testing;
¡P
Utility surveys; and
¡P
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
The

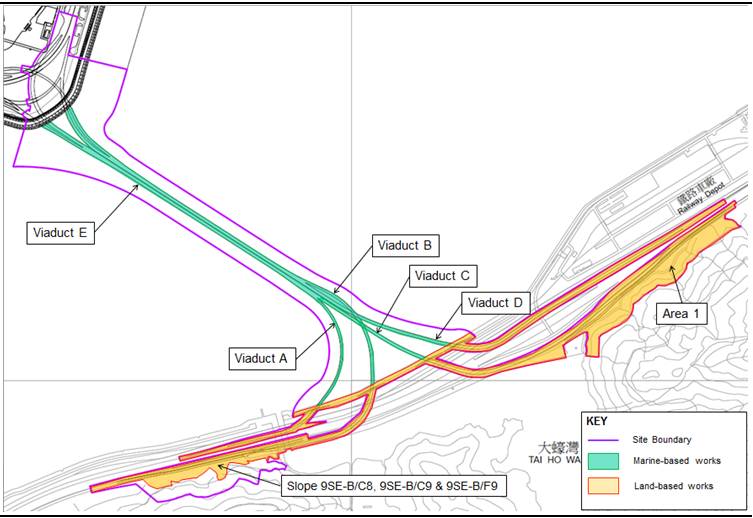

locations of the construction activities are shown in Figure 1.3. The Environmental Sensitive Receivers in
the vicinity of the Project are shown in Figure 1.4.
The EM&A
programme required environmental monitoring for air quality, noise, water
quality and marine ecology as well as environmental site inspections for air
quality, noise, water quality, waste management, marine ecology and landscape
and visual impacts. The EM&A
requirements and related findings for each component are summarized in the
following sections.
Table 2.1 Locations
of Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
Description |
Monitoring Dates |
ASR 9 |
MTR Depot |
On the
ground nearby MTR Depot Entrance |
2, 7, 13, 19,
22 and 28 January 2015 |
ASR 8A |
Area 4 |
On ground at
the works area, Area 4 |
2, 7, 13,
19, 22 and 28 January 2015 |
High Volume Samplers (HVSs) were used for carried out 1-hour and 24-hour
TSP monitoring on 2, 7, 13, 19, 22 and 28 January 2015 at ASR8A and ASR9 in
accordance with the requirements of the Updated EM&A Manual. The TSP monitoring stations are
illustrated in Figure 2.1 and detailed
in Table 2.1. Wind anemometer was deployed at Area 4
for logging wind speed and wind direction.
Copies of the calibration certificates for the
equipment are presented in Appendix E. Details
of the deployed equipment are given in Table
2.2.
Table 2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow
Controlled Total Suspended Particulate (TSP) High
Volume Sampler (Model No. TE-5170) |
Wind Sensor |
Global Water (Wind
Speed Sensor: WE550; Wind Direction Sensor: WE570) |
Wind Anemometer for
calibration |
Lutron (Model No.
AM-4201) |
Table 2.3 Summary
of 1-hour TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
109 |
73
- 176 |
394 |
500 |
ASR
9 |
148 |
77
- 217 |
393 |
500 |
Table 2.4 Summary
of 24-hour TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
76 |
57
- 99 |
178 |
260 |
ASR
9 |
97 |
64
- 123 |
178 |
260 |
All
1-hour and 24-hour TSP results were below the Action and Limit levels at all
monitoring locations in the reporting period. No action is thus required to be
undertaken in accordance with the Event Action Plan presented in Appendix L.
Meteorological
information collected at ASR8A including
wind speed and wind direction is provided in Appendix H.
Noise
monitoring was performed on 2, 7, 13, 19, 22 and 28
January 2015 by using sound level meter at the designated monitoring
station NSR1A (Figure 2.2; Table 2.5) in
accordance with the requirements stipulated in the Updated EM&A Manual. Acoustic calibrator was deployed to
check the sound level meters at a known sound pressure level. Details of the deployed equipment are provided
in Table 2.6. Copies of the calibration certificates
for the equipment are presented in Appendix E.
Table 2.5 Location
of Impact Noise Monitoring Station
Monitoring Station |
Location |
Description |
Parameter |
Frequency and Duration |
Monitoring Dates |
NSR 1A |
Pak Mong Village Pavilion |
On the
ground at the village entrance |
30-minute
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. |
At least
once per week |
2, 7, 13, 19, 22 and 28 January 2015 |
Table 2.6 Noise
Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic
Calibrator |
Rion
NC-73 |
Table 2.7 Summary
of Construction Noise Monitoring Results in the Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
|
NSR
1A |
61 |
59
¡V 62 |
75 |
|
Table 2.8 Locations
of Impact Water Quality Monitoring Stations and its Corresponding Monitoring
Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Frequency |
Depth |
|
|
|
|
Easting |
Northing |
|
|
|
|
IS(Mf)9 |
Impact
Station (Close to HKBCF construction site) |
813273 |
818850 |
Temperature(¢XC)
pH (pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) ¡P SS (mg/L) |
Impact monitoring: 3 days per week, at mid-flood
and mid-ebb tides during the construction period of the Contract |
3 water depths: 1m below
sea surface, mid-depth and 1m above sea bed. If the water depth is less than 3m,
mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted |
|
IS(Mf)16 |
Impact Station
(Close to HKBCF construction site) |
814328 |
819497 |
|
|||
IS8 |
Impact Station (Close
to HKBCF construction site) |
814251 |
818412 |
|
|||
SR4 |
Sensitive receiver
(Tai Ho Inlet) |
814760 |
817867 |
|
|||
SR4a |
Sensitive receiver |
815247 |
818067 |
|
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|
|||
*Notes: |
|
Table 2.9 Water
Quality Monitoring Equipment
Equipment |
Brand and Model |
DO and Salinity |
YSI Pro2030 |
Turbidity meter |
HACH Model 2100Q |
pH meter |
HANNA HI8314 |
Positioning
Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
No
Action and Limit levels exceedances was recorded at all monitoring stations for
impact water quality monitoring in the reporting month. No action is thus required to be
undertaken in accordance with the Event Action Plan presented in Appendix L.
Table
2.10 Dolphin
Monitoring Equipment
Equipment |
Model |
|
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and
reticules 65 foot single engine motor vessel with viewing platform 4.5m above
water level |
|
Table
2.11 Impact
Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
|
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
814577 |
|
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
|
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805475 |
815457 |
|
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805477 |
826654 |
|
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
819435 |
|
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
|
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
819771 |
|
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
|
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
820220 |
|
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
|
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
820466 |
|
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
|
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
820690 |
|
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
|
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
820847 |
|
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
|
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
820892 |
|
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
|
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
820872 |
|
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
|
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818449 |
|
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
|
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
|
|
|
|
|
12 |
End
Point |
815542 |
824882 |
|
|
|
|
|
The Action and
Limit levels of dolphin impact monitoring are shown in Appendix D. The Event and Action plan is presented
in Appendix L.
A
total of eleven (11) groups of forty-six (46) Chinese White Dolphins were
sighted during the two sets of monitoring surveys in January 2015. All sightings were made in NWL during
the two sets of surveys in January 2015, while no dolphin was sighted at all in
NEL in this month. Eight (8) of the
eleven (11) sightings were made on primary lines during on-effort search, and
none of the dolphin groups was associated with operating fishing vessel. No
sighting was made in the proximity of the Project¡¦s alignment. The
distribution of dolphin sightings during the reporting month is shown in
Figure 2.5.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable
conditions (Beaufort 3 or below) in January 2015 are shown in Tables 2.12 and 2.13.
Table 2.12 Individual
Survey Event Encounter Rates
|
|
Encounter rate (STG) (no.
of on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per
100 km of survey effort) |
Primary
Lines Only |
Primary
Lines Only |
||
NEL |
Set 1: Jan 8th / 15th |
0.0 |
0.0 |
Set 2: Jan 27th / 29th |
0.0 |
0.0 |
|
NWL |
Set 1: Jan 8th / 15th |
4.3 |
21.6 |
Set 2: Jan 27th / 29th |
7.5 |
37.6 |
|
Note:
Dolphin Encounter Rates are deduced from the two sets of surveys ( two
surveys in each set) in January 2015 in Northeast (NEL) and Northwest Lantau
(NWL) |
Table 2.13 Monthly
Average Encounter Rates
|
Encounter
rate (STG) (no.
of on-effort dolphin sightings per 100 km of survey effort) |
Encounter
rate (ANI)
(no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
||
Primary Lines Only |
Both
Primary and Secondary Lines |
Primary Lines Only |
Both
Primary and Secondary Lines |
|
Northeast
Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest
Lantau |
5.9 |
6.3 |
29.4 |
26.4 |
Note: Overall
dolphin encounter rates (sightings per 100km of survey effort) from all four
surveys are conducted in January 2015 on primary lines only as well as both
primary lines and secondary lines in Northeast and Northwest Lantau
The average group size of
Chinese White Dolphins in January 2015 was 4.18 individuals per group, which
was slightly higher than the ones in previous months of dolphin monitoring. Five (5) of the eleven (11) dolphin
groups were composed of five to eight (5-8) dolphins during the monitoring
period. Detailed results of dolphin monitoring in this reporting month are presented in Appendix K.
Daily 250 m marine
mammal exclusion zone monitoring was undertaken during the period of marine
works activities being undertaken. No Passive Acoustic Monitoring (PAM) was
carried out as there was no marine works carried out outside the daylight hours
in this reporting month. No
sighting of Indo-Pacific humpback dolphin Sousa
chinensis (i.e. Chinese White Dolphin) were
recorded in January 2015 during the exclusion zone monitoring.
Table 2.14 Specific
Observations Identified during the Weekly Site Inspections in this Reporting
Month
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
8 January
2015 |
Pier B2 ¡P
A generator was not placed on decoupling pad
properly Pier D6. ¡P
The updated dumping permit was not displayed. ¡P
A power pack was not placed on decoupling pad
properly. ¡P
The door of an operating air compressor was not
closed. ¡P
Some refuse was found on sea nearby platform. Barge M027
(next to pier E13) ¡P
A chemical container was not placed in drip trip. Pier E12 ¡P
A part of gutter
was not installed properly. |
Pier B2 and
D6 ¡P
Generators or power packs should be placed on
decoupling properly. ¡P
The updated dumping permit should be displayed. ¡P
Door of operating machine on marine platform should
be closed. ¡P
The contractor should clean up the site and
surrounding area regularly to keep tidy and litter free. Barge M027
(next to pier E13) ¡P
Chemical container should be placed in drip tray. Pier E12 ¡P
Gutter on platform should be installed properly. |
14 January
2015 |
Pak Mong ¡P
Stagnant water was accumulated in a drip tray. Slope B/C9 ¡P
Refuse was accumulated in the drainage. Site Access
5D ¡P
Wheel washing facility was incomplete. |
Pak Mong ¡P
Drip tray should have enough capacity to avoid
overflowing. Slope B/C9 ¡P
Drainage should be cleaned up regularly to avoid
blockage. Site Access
5D ¡P
The contractor was reminded to ensure waste water
from wheel washing will be treated before discharge. |
21 January
2015 |
Barge Chang
Sheung 307 (near platform E4) ¡P
A chemical container was not placed in drip tray. Pier A1 ¡P
A drip tray for generator was not plugged. |
Barge Chang
Sheung 307 (near platform E4) ¡P
Chemical container should be placed in drip tray. Pier A1 ¡P
Drip tray should be plugged properly. |
29 January
2015 |
Pier E13 AB ¡P
A drip tray for generator was not plugged. Seafront ¡P
Some chemical containers on pontoon were not placed
in drip tray. Pier D14 ¡P
The ground was unpaved and dry. |
Pier E13 AB
and Seafront ¡P
Chemical containers and generators should be placed
in plugged drip tray. Pier D14 ¡P
The contractor was reminded to implement the watering
programme for effective dust suppression. |
The Contractor
has rectified all of the observations identified during environmental site
inspections in the reporting month.
The Contractor
has submitted application form for registration as chemical waste producer
under the Contract. Sufficient
numbers of receptacles were available for general refuse collection and
sorting.
Wastes
generated during this reporting period include mainly construction wastes
(inert and non-inert), imported fill, recyclable materials and marine sediment
(Categories L & M). Reference
has been made to the waste flow table prepared by the Contractor (Appendix M).
The quantities of different types of wastes are summarized in Table 2.15.
Table 2.15 Quantities
of Different Waste Generated in the Reporting Period
Month/Year |
Inert C&D Materials (a)
(m3) |
Imported Fill (m3) |
Inert Construction Waste
Re-used (m3) |
Non-inert Construction Waste (b)
(kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
Category L |
Category M (Mp
& Mf) |
|||||||
January 2015 |
12,474 |
115 |
990 |
132,170 |
91 |
0 |
178 |
487 |
Notes: |
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber, felled trees and
others. |
The Contractor
was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials
and wastes. The Contractor was also
reminded to properly maintain the site tidiness and dispose of the wastes
accumulated on site regularly and properly.
For chemical
waste containers, the Contractor was reminded to treat properly and store temporarily
in designated chemical waste storage area on site in accordance with the Code
of Practice on the Packaging, Labelling and Storage of Chemical Wastes.
The status of
environmental licensing and permit is summarized in Table 2.16 below.
Table 2.16 Summary
of Environmental Licensing and Permit Status
License/
Permit |
License
or Permit No. |
Date of Issue |
Date of Expiry |
License/
Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/C |
10 Dec 2014 |
N/A |
HyD |
Tuen Mun- Chek Lap Kok Link |
Construction Dust Notification |
361571 |
5 Jul 2013 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17 Jul 2013 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong
Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Chemical Waste Registration |
5213-951-G2380-17 |
12 Jun 2014 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Construction Waste Disposal Account |
7017735 |
10 Jul 2013 |
N/A |
GCL |
- |
Construction Waste Disposal Account |
7019470 |
3 Mar 2014 |
N/A |
GCL |
Vessel CHIT Account |
Waste Water Discharge License |
WT00019017-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for land portion |
Construction
Noise Permit |
Nil |
N/A |
N/A |
GCL |
For Piling Works |
Construction
Noise Permit for night works and works in general holidays |
GW-RW0640-14 |
28 Aug 2014 |
27 Feb 2015 |
GCL |
General works at WA5 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS1032-14 |
25 Sep 2014 |
28 Mar 2015 |
GCL |
For Load unload at NLH near Viaduct D |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0078-15 |
28 Jan 2015 |
29 Jul 2015 |
GCL |
For Plant mobilization using tractor |
Construction
Noise Permit for night works and works in general holidays |
GW-RS1225-14 |
31 Oct 2014 |
2 May 2015 |
GCL |
For Broad Permit |
Construction
Noise Permit for night works and works in general holidays |
GW-RS1383-14 |
15 Dec 2014 |
28 Feb 2015 |
GCL |
TTA Case 060-12 Ch.1.0-4.2 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS1386-14 |
15 Dec 2014 |
15 Mar 2015 |
GCL |
TTA Case 009 Ch.2.3E-4.2E |
Construction
Noise Permit for night works and works in general holidays |
GW-RS1403-14 |
15 Dec 2014 |
28 Feb 2015 |
GCL |
TTA Case 050 Series Airport Rd to NLH Ch.5.3 |
Marine
Dumping Permit |
EP/MD/15-186 |
1 Jan 2015 |
31 Jan2015 |
GCL |
For dumping Type I (Dedicated Site) and Type II
sediment |
Marine
Dumping Permit |
EP/MD/15-203 |
28 Jan 2015 |
27 Jul 2015 |
GCL |
For dumping Type I sediment |
No complaint, notification
of summons and prosecution was received in the reporting period.
Statistics on
complaints, notifications of summons, successful prosecutions are summarized in
Appendix N.
Marine
Works
¡P Construction
of Pile caps at Viaducts B & E;
¡P Marine
piling platform installation for Viaducts A, B, C, D & E;
¡P Marine Piling at Viaducts
B, C, D & E; and
¡P Additional
marine ground investigation (GI) and laboratory testing.
Land-based
Works
¡P Construction
of pile cap superstructure of Viaduct B;
¡P Channel
re-construction at Area 1;
¡P Land
Piling at Viaducts B, C & D;
¡P Pre-drilling
works at Viaduct A;
¡P Construction
of pile cap at Viaducts B & D;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys; and
¡P Slope
work of Slopes 9SE-B/C8, 9SE-B/C9 & 9SE-B/F9.
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of February 2015 are mainly associated with dust, noise,
marine water quality, marine ecology and waste management issues.
This Fifteenth
Monthly EM&A Report presents the findings of the EM&A activities
undertaken during the period from 1 to 31 January 2015, in accordance with the
Updated EM&A Manual and the requirements of the Environmental Permit (EP-354/2009/C).
A total of
eleven (11) groups of forty-six (46) Chinese White Dolphins were sighted during
the two sets of monitoring surveys in January 2015. All sightings were made in NWL during
the two sets of surveys in January 2015, while no dolphin was sighted at all in
NEL in this month. Eight (8) of the
eleven (11) sightings were made on primary lines during on-effort search, and
none of the dolphin groups was associated with operating fishing vessel. No sighting was made in the proximity of
the Project¡¦s alignment. During this month of dolphin monitoring, no
unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Chinese White Dolphins was noticeable from
general observations.
The ET will
keep track on the construction works to confirm compliance of environmental requirements
and the proper implementation of all necessary mitigation measures.
