Executive
Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Noise Monitoring
2.3 Water Quality Monitoring
2.4 Dolphin monitoring
2.5 EM&A Site inspection
2.6 Waste Management Status
2.7 Environmental Licenses and Permits
2.8 Implementation Status of Environmental Mitigation
Measures
2.9 Summary of Exceedances of the Environmental Quality
Performance Limit
2.10 Summary of Complaints, Notification of Summons and
Successful Prosecutions
3.1 Construction Programme for the Coming Months
3.2 Key Issues for the Coming Month
3.3 Monitoring Schedule for the Coming Month
4 Conclusions and recommendations
4.1 Conclusions
List
of Appendices
Appendix
A Project Organization for Environmental Works
Appendix
B Three Month Rolling Construction Programmes
Appendix
C Implementation Schedule of Environmental Mitigation
Measures (EMIS)
Appendix
D Summary of Action and Limit Levels
Appendix
E Calibration Certificates of Monitoring Equipment
Appendix
F EM&A Monitoring Schedules
Appendix
G Impact Air Quality Monitoring Results and Graphical
Presentation
Appendix
H Meteorological Data for the Reporting Month
Appendix
I Impact Noise Monitoring Results and Graphical
Presentation
Appendix
J Impact Water Quality Monitoring Results and Graphical
Presentation
Appendix
K Impact Dolphin Monitoring Survey Results
Appendix
L Event Action Plan
Appendix
M Monthly Summary of Waste Flow Table
Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). Ramboll Environ Hong Kong Ltd. was employed by the HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A. Further
applications for variation of environmental permit (VEP), EP-354/2009/B, EP-354/2009/C
and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The southern landfall of TM-CLK Link lies alongside
the Hong Kong - Zhuhai - Macao Bridge Hong Kong Boundary Crossing Facilities (HKBCF)
where a reclamation area is constructed by Contract
No. HY/2010/02 under Environmental
Permit No. EP-353/2009/K and
EP-354/2009/D. Upon the
agreement and confirmation between the Supervising Officer Representatives and
Contractors of HY/2010/02 and HY/2012/07 in September 2015, part of
the reclamation area for southern landfall under EP-353/2009/K and
EP-354/2009/D was handed-over to Contract
No. HY/2012/07. Another part of the southern landfall area
under EP-354/2009/D was handed-over
to Contract No. HY/2012/07 after
completion of reclamation works by Contract
No. HY/2010/02 in June 2016.
The construction phase of the Contract commenced on 31
October 2013 and will be tentatively completed by 2018. The impact monitoring of the EM&A programme, including air quality, noise, water quality and
marine ecological monitoring as well as environmental site inspections,
commenced on 31 October 2013.
This is the Fortieth Monthly EM&A report
presenting the EM&A works carried out during the period from 1 to 28
February 2017 for the Southern Connection Viaduct
Section in accordance with the Updated EM&A Manual of the
TM-CLK Link Project. As informed by the Contractor, major
activities in the reporting period included:
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
A summary of monitoring and audit activities conducted
in the reporting period is listed below:
24-hour TSP Monitoring 5 sessions
1-hour TSP Monitoring 5 sessions
Noise Monitoring 5
sessions
Impact Water Quality Monitoring 12 sessions
Impact Dolphin Monitoring 2 sessions
Joint Environmental Site Inspection 5 sessions
Breaches of
Action and Limit Levels for Air Quality
No exceedance of Action and Limit Levels was recorded
for construction air quality monitoring in the reporting month.
Breaches of
Action and Limit Levels for Noise
No exceedance of Action and Limit Levels was recorded
for construction noise monitoring in the reporting month.
Breaches of
Action and Limit Levels for Water Quality
No exceedance of Action and Limit Levels was recorded
for water quality impact monitoring in the reporting period.
Impact Dolphin
Monitoring
One (1) Limit Level exceedance was
observed for the quarterly dolphin monitoring data between December 2016 and
February 2017, whilst no unacceptable impact from the construction
activities of the TM-CLKL Southern Connection Viaduct Section on Indo-Pacific
humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) was noticeable
from general observations. Due to monthly
variation in dolphin occurrence within the Study Area, it would be more
appropriate to draw conclusion on whether any impacts on dolphins have been
detected related to the construction activities of the TM-CLKL Southern
Connection Viaduct Section in the quarterly EM&A reports, in which
comparison on distribution, group size and encounter rates of dolphins between
the quarterly impact monitoring period and baseline monitoring period will be
made.
Daily marine mammal exclusion zone monitoring was
undertaken during the period of marine works under this Contract. No sighting of the Chinese White Dolphin was
recorded in February 2017 during the exclusion zone monitoring.
Environmental
Complaints, Non-compliance & Summons
There was no environmental complaint, notification of
summons or successful prosecution recorded in the reporting period.
Reporting
Change
There was no reporting change in the reporting period.
Upcoming Works for the Next Reporting Period
Works to be undertaken in the next monitoring period
of March 2017 include the following:
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
Future Key
Issues
Potential environmental impacts arising from the above
upcoming construction activities in the next reporting month of March 2017 are
mainly associated with dust, noise, marine water quality, marine ecology and
waste management issues.
According to the findings of the Northwest New Territories
(NWNT) Traffic and Infrastructure Review conducted by the Transport Department,
Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be
operating beyond capacity after 2016.
This forecast has been based on the estimated increase in cross boundary
traffic, developments in the Northwest New Territories (NWNT), and possible
developments in North Lantau, including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic
demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek
Lap Kok Link (TM-CLKL) and Tuen
Mun Western Bypass (TMWB) are proposed.
An Environmental Impact Assessment (EIA) of TM-CLKL
(the Project) was prepared in accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical
Memorandum of the Environmental Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009) for TM-CLKL was granted by
the Director of Environmental Protection (DEP) on 4 November 2009, and EP
variation (EP-354/2009/A) was issued
on 8 December 2010.
Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of TM-CLKL (“the Contract”) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). Ramboll Environ Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A.
Further applications for variation of environmental
permit (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
The southern landfall of TM-CLK Link lies alongside
the Hong Kong - Zhuhai - Macao Bridge Hong Kong Boundary Crossing Facilities
(HKBCF) where a reclamation area is constructed by Contract No. HY/2010/02
under Environmental Permit No. EP-353/2009/K and EP-354/2009/D. Upon the agreement and confirmation between
the Supervising Officer Representatives and Contractors of HY/2010/02 and HY/2012/07
in September 2015, part of the reclamation area for southern landfall under EP-353/2009/K and EP-354/2009/D was handed-over to Contract No. HY/2012/07. Another part of the southern landfall area
under EP-354/2009/D was handed-over
to Contract No. HY/2012/07 after
completion of reclamation works by Contract
No. HY/2010/02 in June 2016.
The construction phase of the Contract commenced on 31
October 2013 and will be tentatively completed by 2018. The impact monitoring phase of the EM&A programme, including air quality, noise, water quality and
marine ecological monitoring as well environmental site inspections, commenced
on 31 October 2013.

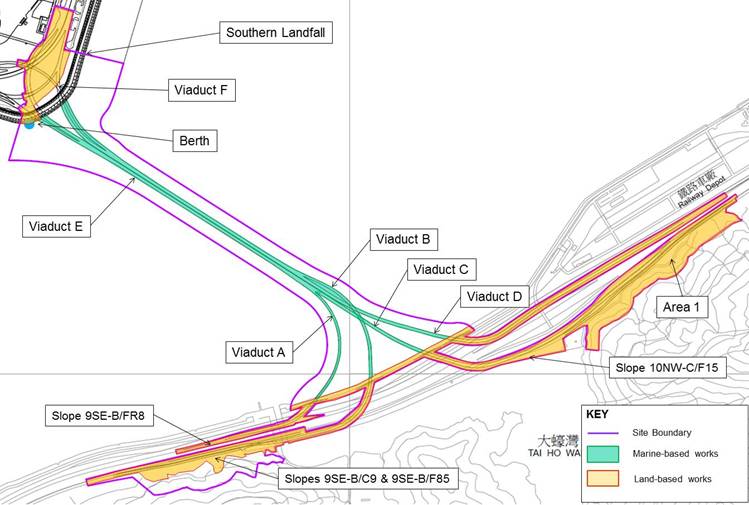

The general layout plan of the Contract components is
presented in Figures 1.1 & 1.2a to l.
This is the Fortieth Monthly EM&A Report under the
Contract No. HY/2012/07
Tuen Mun – Chek Lap Kok Link – Southern Connection
Viaduct Section. This report presents a summary of the
environmental monitoring and audit works in February 2017.
The organization structure of the Contract is shown in
Appendix A. The
key personnel contact names and contact details are summarized in Table 1.1 below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD (Highways
Department) |
Project
Coordinator |
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior
Engineer |
Steven Shum |
2762 4133 |
3188 6614 |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident
Engineer |
Kingman Chan |
3691 3950 |
3691 2899 |
ENPO / IEC (Ramboll Environ Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465
2850 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3465
2851 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
The
locations of the construction activities are shown in Figure 1.3.
The Environmental Sensitive Receivers in the vicinity of the Project are
shown in Figure 1.4.
The EM&A programme required
environmental monitoring for air quality, noise, water quality and marine
ecology as well as environmental site inspections for air quality, noise, water
quality, waste management, marine ecology and landscape and visual impacts. The EM&A requirements and related
findings for each component are summarized in the following sections.
Table 2.1 Locations of Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
Description |
Monitoring Dates |
ASR 9 |
MTR Depot |
On the
ground nearby MTR Depot Entrance |
2, 8, 14, 20
and 23 February 2017 |
ASR 8A |
Area 4 |
On ground at
the works area, Area 4 |
2, 8, 14, 20
and 23 February 2017 |
High Volume Samplers (HVSs)
were used for carried out 1-hour and 24-hour TSP monitoring on 2,
8, 14, 20 and 23 February 2017 at ASR8A and ASR9 in
accordance with the requirements of the Updated EM&A Manual. The TSP monitoring stations are illustrated
in Figure 2.1 and
detailed in Table 2.1. Wind anemometer was deployed at Area 4 for
logging wind speed and wind direction. Copies
of the calibration certificates for the equipment are presented in Appendix E. Details of the deployed equipment are given
in Table 2.2.
Table 2.2 Air Quality Monitoring Equipment
Equipment |
Brand and Model |
High
Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind
Sensor |
Global
Water (Wind Speed Sensor: WE550; Wind Direction Sensor: WE570) |
Wind
Anemometer for calibration |
Lutron
(Model No. AM-4201) |
Table 2.3 Summary of 1-hour TSP Monitoring Results in the Reporting
Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
73 |
45-147 |
394 |
500 |
ASR
9 |
86 |
46-147 |
393 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in the Reporting
Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
56 |
47-62 |
178 |
260 |
ASR
9 |
60 |
54-68 |
178 |
260 |
All 1-hour and 24-hour TSP results were below
the Action and Limit Levels at all monitoring locations in the reporting
period. No action is thus required to be
undertaken in accordance with the Event Action Plan presented in Appendix L.
Meteorological information collected at ASR8A including wind speed and wind
direction is provided in Appendix H.
Noise monitoring was performed on 2, 8, 14, 20 and 23
February 2017 using sound level meter at the designated monitoring station
NSR1A (Figure 2.2; Table 2.5) in accordance with the
requirements stipulated in the Updated EM&A Manual. Acoustic calibrator was deployed to check the
sound level meters at a known sound pressure level. Details of the deployed equipment are provided
in Table 2.6. Copies of the calibration certificates for
the equipment are presented in Appendix E.
Table 2.5 Location of Impact Noise Monitoring Station
Monitoring Station |
Location |
Description |
Parameter |
Frequency and Duration |
Monitoring Dates |
NSR 1A |
Pak Mong Village Pavilion |
On the
ground at the village entrance |
30-minute
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. |
At least
once per week |
2, 8, 14, 20
and 23 February 2017 |
Table 2.6 Noise Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic Calibrator |
Rion
NC-73 |
Table 2.7 Summary of Construction Noise Monitoring Results in the
Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
NSR
1A |
62 |
61-63 |
75 |
Table 2.8 Locations of Impact Water Quality Monitoring Stations and its
Corresponding Monitoring Requirements
Station ID |
Type |
Coordinates |
*Parameters,
unit |
Frequency |
Depth |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact Station (Close to HKBCF construction site) |
813273 |
818850 |
Temperature(°C)
pH (pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
Dissolved Oxygen
(DO) (mg/L and % of saturation) · Suspended Solid (SS) (mg/L) |
Impact monitoring: 3 days per
week, at mid-flood and mid-ebb tides during the construction period of the
Contract |
3 water depths:
1m below sea
surface, mid-depth and 1m above sea bed. If the water depth is
less than 3m, mid-depth sampling only.
If water depth less than 6m, mid-depth may be omitted |
IS(Mf)16 |
Impact
Station (Close to HKBCF construction site) |
814328 |
819497 |
|||
IS8 |
Impact
Station (Close to HKBCF construction site) |
814251 |
818412 |
|||
SR4 |
Sensitive
receiver (Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive
receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|||
*Notes: |
Table 2.9 Water Quality Monitoring Equipment
Equipment |
Brand and Model |
DO and Salinity |
YSI Pro2030 |
Turbidity meter |
HACH Model 2100Q |
pH meter
|
HANNA HI9125 |
Positioning Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
Neither Action nor Limit Levels exceedances was
recorded at all monitoring stations for impact water quality monitoring in the
reporting month. No action is thus
required to be undertaken in accordance with the Event Action Plan presented in Appendix L.
Table 2.10 Dolphin Monitoring Equipment
Equipment |
Model |
|
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for
Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and reticules 65 foot single engine motor vessel with viewing platform 4.5m above
water level |
|
Table 2.11 Impact Dolphin Monitoring Line Transect
Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
815456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805475 |
815913 |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805477 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
819435 |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
819771 |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
820220 |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
820466 |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
820880 |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
820872 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
|
|
|
|
12 |
End
Point |
815542 |
824882 |
|
|
|
|
The Action and Limit levels of dolphin impact
monitoring are shown in Appendix D. The Event and Action plan is presented in Appendix L.
A total of 288.25 km of survey effort was collected,
with 65.0% of the total survey effort being conducted under favourable weather
conditions (i.e. Beaufort Sea State 3 or below with good visibility) during the
surveys in February 2017. Among the two
areas, 111.41 km and 176.84 km of survey effort were collected from NEL and NWL
survey areas, respectively. The total
survey effort conducted on primary and secondary lines were 207.74 km and 80.51
km, respectively. The survey efforts are
summarized in Appendix K.
Seven (7) groups of 25 Chinese White Dolphins were sighted during the two sets of monitoring surveys in
February 2017. All seven (7) dolphin sightings were made in
NWL, while none was sighted in NEL.
During the surveys in February 2017, five of the seven sightings were
made during on-effort search, while four of the five on-effort sightings were
made on primary lines. None of the
dolphin groups was associated with operating fishing vessel and none of the
dolphin groups were sighted in the proximity of the Project’s alignment. The distribution of dolphin sighting during
the reporting month is shown in Figure 2.5.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable
conditions (Beaufort 3 or below) in February 2017 are shown in Tables 2.12 & 2.13.
Table 2.12 Individual Survey Event Encounter Rates
|
|
Encounter rate (STG) (no. of
on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI) (no. of
dolphins from all on-effort sightings per 100 km of survey effort) |
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: Feb 7th / 9th |
0.0 |
0.0 |
Set 2: Feb 16th / 21st |
0.0 |
0.0 |
|
NWL |
Set 1: Feb 7th / 9th |
0.0 |
0.0 |
Set 2: Feb 16th / 21st |
9.0 |
42.7 |
|
Note: Dolphin Encounter Rates are deduced from
the two sets of surveys ( two surveys in each set) in February 2017 in
Northeast (NEL) and Northwest Lantau (NWL) |
Table 2.13 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
||
Primary
Lines Only |
Both Primary and Secondary Lines |
Primary
Lines Only |
Both Primary and Secondary Lines |
|
Northeast
Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest
Lantau |
5.4 |
3.9 |
25.7 |
18.8 |
Note: Overall dolphin encounter rates (sightings per
100 km of survey effort) from all four surveys are conducted in February 2017
on primary lines only as well as both primary lines and secondary lines in
Northeast and Northwest Lantau
One (1) Limit Level exceedance was observed
for the quarterly dolphin monitoring data between December 2016 and February
2017, whilst no unacceptable impact from the construction
activities of the TM-CLKL Southern Connection Viaduct Section on Indo-Pacific
humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) was noticeable
from general observations. Due to
monthly variation in dolphin occurrence within the Study Area, it would be more
appropriate to draw conclusion on whether any impacts on dolphins have been
detected related to the construction activities of the TM-CLKL Southern
Connection Viaduct Section in the quarterly EM&A reports, in which
comparison on distribution, group size and encounter rates of dolphins between
the quarterly impact monitoring period and baseline monitoring period will be
made.
Daily 250 m marine mammal exclusion zone
monitoring was undertaken during the period of daytime marine works
activities. No sighting of Chinese White
Dolphin was recorded in February 2017 during the exclusion zone monitoring.
Passive Acoustic Monitoring (PAM) had
been decommissioned as no marine piling works was carried out outside the
daylight hours since September 2015.
Site
inspections were carried out on a weekly basis to monitor the implementation of
proper environmental pollution control and mitigation measures under the
Contract. In the reporting month, five
(5) site inspections were carried out on 2, 7, 15, 24 and 28 February 2017.
Key
observations during the site inspections are summarized in Table 2.14.
Table 2.14 Specific Observations Identified during
the Weekly Site Inspections in this Reporting Month
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
02 February
2017 |
Viaduct D
(D13) Chemical container was
not placed in drip tray. Accumulated general
refuse was observed at site. Viaduct D
(D18) Chemical container was
not placed in drip tray. Ramp D
Better housekeeping should be maintained.
Oil leakage was observed
nearby excavator. |
Viaduct D
(D13) The Contractor was reminded to
remove the chemical containers and placed them in drip tray. The
Contractor was reminded to clear the general refuse. Viaduct D
(D18)
The Contractor was reminded to remove the
chemical containers and placed them in drip tray. Ramp D
The Contractor was
reminded to keep better housekeeping at site.
The Contractor was
reminded to clear oil leakage. |
07 February
2017 |
Southern
Landfall (Portion A) NRMM label should be displayed properly on drill
rig. Chemical container was
not placed in drip tray Oil leakage was observed nearby power pack. |
Southern
Landfall (Portion A) The Contractor was reminded to
display NRMM label properly on drill rig. The Contractor was reminded to
remove the chemical containers and placed them in drip tray. The Contractor was reminded to
clear oil leakage. |
15 February
2017 |
Viaduct B
(B16) Environmental
Permit (EP) should be displayed at site or area nearby sensitive receiver. Viaduct B
(B17) Watering
was not maintained on unpaved area. Ramp B NRMM label should be displayed properly on
excavator. Oil leakage was observed nearby excavator. Drip tray was observed not properly plugged. |
Viaduct B
(B16) The
Contractor was reminded to display Environmental Permit (EP) at site or area
nearby sensitive receiver. Viaduct B
(B17) The
Contractor was reminded to maintain watering on unpaved area. Ramp B The Contractor was reminded to clealy display NRMM label on excavator. The Contractor was reminded to clear oil leakage. The Contractor was reminded to properly plug the
drip tray. |
24 February
2017 |
Viaduct B (Deck Pier B1) NRMM label should be displayed on the generator. Stagnant water was observed in the drip tray near
air compressor. Southern Landfall (Portion A) Flow direction should be indicated on the pipe. |
Viaduct B (Deck Pier B1) The Contractor was reminded to display NRMM label
on the generator. The Contractor was reminded to clear stagnant
water in the drip tray near air compressor. Southern Landfall (Portion A) The Contractor was reminded to provide indication
of flow direction on the pipe. |
28 February
2017 |
Viaduct E (E7) Chemicals were not placed
in drip tray. General refuse was
observed at site. Viaduct E (E12)
Absorption pad should be
provided nearby the drip tray of the generator. |
Viaduct E (E7) The Contractor was
reminded to place chemicals in drip tray. The Contractor was
reminded to clear general refuse. Viaduct E (E12)
The Contractor was
reminded to provide absorption pad nearby the drip tray of the generator. |
The Contractor has rectified all of the observations identified
during environmental site inspections in the reporting month.
The Contractor has submitted application form for
registration as chemical waste producer under the Contract. Sufficient numbers of receptacles were
available for general refuse collection and sorting.
Wastes generated during this reporting period include
mainly construction wastes (inert and non-inert) and recyclable materials. Reference has been made to the waste flow
table prepared by the Contractor (Appendix M). The quantities of different types of wastes
are summarized in Table 2.15.
Table 2.15 Quantities of Different Waste Generated in the Reporting Period
Month/Year |
Inert C&D Materials (a) (m3) |
Imported Fill (m3) |
Inert Construction Waste Re-used (m3) |
Non-inert Construction Waste (b) (kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
Category L |
Category M (Mp & Mf) |
|||||||
February
2017 |
4,869 |
0 |
166 |
127,720 |
91 |
0 |
0 |
0 |
Notes: |
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and materials
disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber, felled trees
and others. |
The Contractor was advised to properly maintain on
site C&D materials and waste collection, sorting and recording system,
dispose of C&D materials and wastes at designated ground and maximize
reuse/ recycle of C&D materials and wastes.
The Contractor was also reminded to properly maintain the site tidiness
and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was
reminded to treat properly and store temporarily in designated chemical waste
storage area on site in accordance with the Code
of Practice on the Packaging, Labelling and Storage of Chemical Wastes.
The status of environmental licensing and permit is
summarized in Table 2.16 below.
Table 2.16 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/D |
13 March 2015 |
N/A |
HyD |
Tuen Mun- Chek Lap Kok Link |
Environmental Permit |
EP-353/2009/K |
11 April 2016 |
N/A |
HyD |
Hong Kong Boundary Crossing Facilities |
Construction Dust Notification |
361571 |
5 Jul 2013 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17 Jul 2013 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract No. HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract No. HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov 2013 |
N/A |
GCL |
Chemical waste produced in Contract No. HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Chemical Waste Registration |
5213-951-G2380-17 |
12 Jun 2014 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Construction Waste Disposal Account |
7017735 |
10 Jul 2013 |
N/A |
GCL |
- |
Construction
Waste Disposal Account |
7019470 |
3 Mar 2014 |
N/A |
GCL |
Vessel
CHIT Account |
Waste Water Discharge License |
WT00019017-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for land portion |
Construction Noise Permit
for night works and works in general holidays |
GW-RW0708-16 |
20
Dec 2016 |
18
Jun 2017 |
GCL |
General works at WA5 |
Construction Noise Permit for night
works and works in general holidays Construction Noise Permit
for night works and works in general holidays |
GW-RS1045-16 GW-RS1309-16 |
14 Oct 2016 20 Dec 2016 |
13 Apr 2017 19 Jun 2017 |
GCL GCL |
For Broad Permit Broad Permit for Whole Site Areas |
Construction Noise Permit
for night works and works in general holidays |
GW-RS1159-16 |
24 Nov 2016 |
28 Feb 2017 |
GCL |
Broad Permit for Segment Launching
at Land Portion |
Construction Noise Permit
for night works and works in general holidays |
GW-RS1044-16 |
14 Oct 2016 |
13 Apr 2017 |
GCL
|
Pre-casted pile cap shell
installation at E8-E13 |
Construction Noise Permit
for night works and works in general holidays |
GW-RS0082-17 |
15
Feb 2017 |
31
Mar 2017 |
GCL |
Water Pipe
Works at Tung Chung |
Marine Dumping Permit |
EP-MD-17-168 |
01 Feb 2017 |
28 Feb 2017 |
GCL |
For dumping Type I (Dedicated Site)
and Type II sediment |
Marine Dumping Permit |
EP-MD-17-153 |
01 Jan 2017 |
30 Jun 2017 |
GCL |
For
dumping Type I sediment |
In response to the site audit findings, the
Contractors carried out corrective actions.
A summary of the Implementation Schedule of
Environmental Mitigation Measures (EMIS) is presented in Appendix C. The necessary mitigation measures were
implemented properly for this Contract.
The landscape and visual (L&V) mitigation measures
were also monitored on weekly basis in the reporting period. The monitoring status is summarized in Appendix C.
Results for water quality, 1-hour TSP, 24-hour TSP and
construction noise monitoring complied with the Action/ Limit levels in the
reporting period.
There was no environmental complaint, notification of
summons or successful prosecution recorded in the reporting period.
Statistics on complaints, notifications of summons, successful
prosecutions are summarized in Appendix N.
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
Potential environmental impacts arising from the above
upcoming construction activities in the next reporting month of March 2017 are
mainly associated with dust, noise, marine water quality, marine ecology and
waste management issues.
This Fortieth Monthly EM&A Report presents the
findings of the EM&A activities undertaken during the period from 1 to 28 February
2017 in accordance with the Updated EM&A Manual and the requirements of the Environmental Permits (EP-354/2009/D
and EP-353/2009/K).
Seven (7) groups of 25 Chinese White Dolphins were sighted during the two sets of monitoring surveys in
February 2017. One
(1) Limit Level exceedance was observed for the quarterly dolphin monitoring
data between December 2016 and February 2017, whilst no
unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Indo-Pacific humpback dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was noticeable from general observations.
Environmental site inspection was carried out four (4) times in February
2017. Recommendations on remedial
actions were given to the Contractor for the deficiencies identified during the
site audits.
There was no environmental complaint, notification of
summons or successful prosecution recorded in the reporting period.
The ET will keep track on the construction works to
confirm compliance of environmental requirements and the proper implementation
of all necessary mitigation measures.
