Executive Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
1.5 Summary of EM&A Programme Requirements
2.1 Air Quality
2.2 Noise Monitoring
2.3 Water Quality Monitoring
2.4 Dolphin Monitoring
2.5 EM&A Site Inspection
2.6 Waste Management Status
2.7 Environmental Licenses and Permits
2.8 Implementation Status of Environmental Mitigation Measures
2.9 Summary of Exceedances of the Environmental Quality Performance Limit
2.10 Summary of Complaints, Notification of Summons and Successful Prosecutions
3 Comparison of EM&A Results with EIA Predictions and Baseline Monitoring Results
3.1 Air Quality Monitoring
3.2 Noise Impact Monitoring
3.3 Water Quality Monitoring
3.4 Marine Ecology
3.5 Waste Management
3.6 Summary of Monitoring Methodology and Effectiveness
3.7 Summary of Mitigation Measures
4.1 Key Issues for the coming period
5 Conclusion and Recommendations
List of Appendices
Appendix A Project Organization for Environmental Works
Appendix B Implementation Schedule of Environmental Mitigation Measures (EMIS)
Appendix C Summary of Action and Limit Levels
Appendix D Post-Construction Water Quality Monitoring Results in Graphical Presentation
Appendix E Event Action Plan
Appendix F Summary of Waste Flow Table
Under Contract No. HY/2012/07, Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Southern Connection Viaduct Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET). Ramboll Hong Kong Ltd. was employed by the HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of environmental permit (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
The southern landfall of TM-CLK Link lies alongside the Hong Kong - Zhuhai - Macao Bridge Hong Kong Boundary Crossing Facilities (HKBCF) where a reclamation area is constructed by Contract No. HY/2010/02 under Environmental Permit No. EP-353/2009/K and EP-354/2009/D. Upon the agreement and confirmation between the Supervising Officer Representatives and Contractors of HY/2010/02 and HY/2012/07 in September 2015, part of the reclamation area for southern landfall under EP-353/2009/K and EP-354/2009/D was handed-over to Contract No. HY/2012/07. Another part of the southern landfall area under EP-354/2009/D was handed-over to Contract No. HY/2012/07 after completion of reclamation works by Contract No. HY/2010/02 in June 2016.
The construction phase of the Contract commenced on 31 October 2013. The impact monitoring of the EM&A programme, including air quality, noise, water quality and marine ecological monitoring as well as environmental site inspections, commenced on 31 October 2013.
This is the Seventh Annual EM&A Report presenting the EM&A works carried out during the period from 1 November 2019 to 16 March 2020 for the Southern Connection Viaduct Section in accordance with the Updated EM&A Manual of the TM-CLK Link Project. As informed by the Contractor, there were no major works undertaken in the reporting period.
A summary of monitoring and audit activities conducted in the reporting period is listed below:
Post-Construction Water quality monitoring 12 sessions
Dolphin monitoring 8 sessions
Joint Environmental site inspection ([1]) 18 sessions
Breaches of Action and Limit Levels for Air Quality
No air quality monitoring was scheduled in the reporting period. Notification of temporary suspension of air quality monitoring has been approved by EPD on 28 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
Breaches of Action and Limit Levels for Noise
No construction noise monitoring was scheduled in the reporting period. Notification of temporary suspension of noise monitoring has been approved by EPD on 28 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
Breaches of Action and Limit Levels for Water Quality
No water quality impact monitoring was scheduled in the reporting period. Notification of temporary suspension of water quality monitoring has been approved by EPD on 30 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
Impact Dolphin Monitoring
Two (2) Limit Level exceedances for both NEL and NWL regions were recorded between November 2019 and February 2020. No unacceptable impact from the construction activities of the TM-CLKL Southern Connection Viaduct Section on Indo-Pacific humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) was noticeable from general observations during the dolphin monitoring in this reporting period.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
No marine works were undertaken since July 2019, therefore, daily 250 m marine mammal exclusion zone monitoring was not undertaken since July 2019. No Passive Acoustic Monitoring (PAM) was implemented as the marine piling works were not carried out outside the daylight hours in this reporting period.
Environmental Complaints, Non-compliance & Summons
There was no environmental complaints, notification of summons or successful prosecution recorded in the reporting period.
Reporting Change
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
Future Key Issues
According to the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be operating beyond capacity after 2016. This forecast has been based on the estimated increase in cross boundary traffic, developments in the Northwest New Territories (NWNT), and possible developments in North Lantau, including the Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.
An Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report (EIAO Register Number: AEIAR-146/2009), an Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4 November 2009, and EP variation (EP-354/2009/A) was issued on 8 December 2010.
Under Contract No. HY/2012/07, Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Southern Connection Viaduct Section of TM-CLKL (“the Contract”) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET). Ramboll Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of environmental permit (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
The southern landfall of TM-CLK Link lies alongside the Hong Kong - Zhuhai - Macao Bridge Hong Kong Boundary Crossing Facilities (HKBCF) where a reclamation area is constructed by Contract No. HY/2010/02 under Environmental Permit No. EP-353/2009/K and EP-354/2009/D. Upon the agreement and confirmation between the Supervising Officer Representatives and Contractors of HY/2010/02 and HY/2012/07 in September 2015, part of the reclamation area for southern landfall under EP-353/2009/K and EP-354/2009/D was handed-over to Contract No. HY/2012/07. Another part of the southern landfall area under EP-354/2009/D was handed-over to Contract No. HY/2012/07 after completion of reclamation works by Contract No. HY/2010/02 in June 2016.
The construction phase of the Contract commenced on 31 October 2013. The impact monitoring phase of the EM&A programme, including air quality, noise, water quality and marine ecological monitoring as well environmental site inspections, commenced on 31 October 2013.
The general layout plan of the Contract components is presented in Figures 1.1 & 1.2a to l.
This is the Seventh Annual EM&A Report under the Contract No. HY/2012/07 Tuen Mun – Chek Lap Kok Link – Southern Connection Viaduct Section. This report presents a summary of the environmental monitoring and audit works from 1 November 2019 to 16 March 2020.
The organization structure of the Contract is shown in Appendix A. The key personnel contact names and contact details are summarized in Table 1.1 below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD (Highways Department) |
Project Coordinator |
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior Engineer |
Steven Shum
|
2762 4133 |
3188 6614 |
SOR (AECOM Asia Company Limited)
|
Chief Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident Engineer
|
Chan Wah Fu |
2293 6434 |
3691 2899 |
|
|
|
|
|
ENPO / IEC (Ramboll Hong Kong Ltd.) |
ENPO Leader
|
Y.H. Hui |
3465 2850 |
3465 2899 |
IEC
|
Dr. F.C. Tsang |
3465 2851 |
3465 2899 |
|
Environmental Officer
|
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour Complaint Hotline
|
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Dr. Jasmine Ng |
2271 3311 |
2723 5660 |
As informed by the Contractor, there were no major works undertaken in the reporting period.
The Environmental Sensitive Receivers in the vicinity of the Project are shown in Figure 1.3.
The environmental mitigation measures implementation schedule is presented in Appendix B.
The EM&A programme required environmental monitoring for air quality, noise, water quality and marine ecology as well as environmental site inspections for air quality, noise, water quality, waste management, marine ecology and landscape and visual impacts. The EM&A requirements and related findings for each component are described in the following sections, which include:
· Monitoring parameters;
· Action and Limit levels for all environmental parameters;
· Event Action Plan;
· Tested environmental impact hypotheses;
· Environmental mitigation measures, as recommended in the approved EIA Report; and
· Environmental requirement in contract documents.
The EM&A programme required environmental monitoring for air quality, noise, water quality and marine ecology as well as environmental site inspections for air quality, noise, water quality, waste management, marine ecology and landscape and visual impacts. The EM&A requirements and related findings for each component are summarized in the following sections.
No air quality monitoring was undertaken in the reporting period. Notification of temporary suspension of air quality monitoring has been approved by EPD on 28 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
No noise monitoring was undertaken in the reporting period. Notification of temporary suspension of noise monitoring has been approved by EPD on 28 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
No water quality impact monitoring was undertaken in the reporting period. Notification of temporary suspension of water quality monitoring has been approved by EPD on 30 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
According to the Updated EM&A Manual, a post-construction water quality monitoring shall be carried out upon completion of all marine-based construction activities. Post-construction water quality monitoring was undertaken three days per week for at least 4 weeks in accordance with the Updated EM&A Manual. The proposal for post-construction water quality monitoring was approved by EPD on 19 November 2019. The post-construction water quality monitoring commenced on 27 November 2019 and completed on 23 December 2019.
Details of monitoring stations are provided in Figure 2.1 and Table 2.1.
Table 2.1 Locations of Water Quality Monitoring Stations and the Corresponding Monitoring Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Depth |
Frequency |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact Station (Close to HKBCF construction site)
|
813273 |
818850 |
Temperature(°C) pH(pH unit) Turbidity (NTU) Water depth (m) Salinity (ppt) Dissolved Oxygen (DO) (mg/L and % of saturation) · Suspended Solid (SS) (mg/L) |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed. If the water depth is less than 3m, mid-depth sampling only. If water depth less than 6m, mid-depth may be omitted. |
Post-construction monitoring: 3 days per week, at mid-flood and mid-ebb tides for 4 weeks. |
IS(Mf)16 |
Impact Station (Close to HKBCF construction site)
|
814328 |
819497 |
|||
IS8(N) |
Impact Station(Close to HKBCF construction site)
|
814413 |
818570 |
|||
SR4(N2) |
Sensitive receiver (Tai Ho)
|
815688 |
817996 |
|||
SR4a |
Sensitive receiver
|
815247 |
818067 |
|||
CS(Mf)3(N)
|
Control Station
|
808814 |
822355 |
|||
CS(Mf)5 |
Control Station |
817990 |
821129 |
|||
Notes: In addition to the parameters presented monitoring location/position, time, water depth, sampling depth, tidal stages, weather conditions and any special phenomena or works underway nearby were also recorded. Water Quality Monitoring Station CS(Mf)3 was relocated to CS(Mf)3(N) since 2 May 2017. Water Quality Monitoring Station SR4 was relocated to SR4(N) since 2 March 2018. Water Quality Monitoring Station SR4(N) was relocated to SR4(N2) since 12 June 2019. Water Quality Monitoring Station IS8 was relocated to IS8(N) since 12 June 2019. |
Details of the equipment deployed in water quality monitoring are provided in Table 2.2.
Table 2.2 Water Quality Monitoring Equipment
Equipment |
Brand and Model |
Multi-parameters (Dissolved Oxygen, Salinity, Turbidity, Temperature, pH) |
YSI ProDSS / YSI 6920 V2
|
Positioning Equipment |
Furuno GP-170 |
Water Depth Detector |
Lowrance Mark 5x / Garmin Striker 4 |
Water Sampler |
WildCo Vertical Alpha Bottles 1120-2.2L /1120-3.2L Aquatic Research Instrument Vertical/Horizontal Point Water Sampler 2.2L / 3.0L |
The schedules for water quality monitoring in the reporting period are provided in the Seventy-third to Seventy-fourth Monthly EM&A Reports.
In this reporting period, a total of 12 monitoring events were undertaken. Post-construction water quality monitoring was conducted at all designated monitoring stations in the reporting period. The detailed post-construction water quality monitoring data are presented graphically in Appendix D and was reported in the Seventy-third to Seventy-fourth Monthly EM&A Reports.
Impact dolphin monitoring is required to be conducted by a qualified dolphin specialist team to evaluate whether there have been any effects on the Indo-Pacific humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) from the Contract. In order to fulfil the EM&A requirements and make good use of available resources, the impact line transect dolphin monitoring data collected by HyD’s Contract No. HY/2012/08 TMCLKL Northern Connection Sub-Sea Tunnel Section on monthly basis is adopted to avoid duplicates of survey effort between November 2019 and February 2020.
Responsibility for the implementation of dolphin monitoring was changed from Contract No. HY/2011/03 HZMB HKLR Section between Scenic Hill and HKBCF to Contract No. HY/2012/08 TMCLKL Northern Connection Sub-Sea Tunnel Section since October 2019. The on-going impact line transect dolphin monitoring data collected by HyD’s Contract No. HY/2012/08 TMCLKL Northern Connection Sub-Sea Tunnel Section on the monthly basis is adopted since October 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
Table 2.3 summarizes the equipment used for the impact dolphin monitoring.
Table 2.3 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning System (GPS)
Camera
Laser Binoculars
Marine Binocular
Vessel for Monitoring
|
Garmin 18X-PC Geo One Phottix
Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens
Infinitor LRF 1000
Bushell 7 x 50 marine binocular with compass and reticules
65 foot single engine motor vessel with viewing platform 4.5m above water level |
The dolphin monitoring covered all transect lines in Northeast Lantau (NEL) and the Northwest Lantau (NWL) survey areas twice per month throughout the entire construction period. The monitoring data were compatible with, and should be made available for, long-term studies of small cetacean ecology in Hong Kong. In order to provide a suitable long-term dataset for comparison, identical methodology and line transects employed in baseline dolphin monitoring was followed in the impact dolphin monitoring.
The impact dolphin monitoring was carried out in the NEL and NWL along the line transect as depicted in Figure 2.2. The co-ordinates of all transect lines are shown in Table 2.4 ([2]) below.
Table 2.4 Impact Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start Point |
804671 |
815456 |
13 |
Start Point |
816506 |
819480 |
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
2 |
Start Point |
805476 |
820800 |
14 |
Start Point |
817537 |
820220 |
2 |
End Point |
805476 |
826654 |
14 |
End Point |
817537 |
824613 |
3 |
Start Point |
806464 |
821150 |
15 |
Start Point |
818568 |
820735 |
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
4 |
Start Point |
807518 |
821500 |
16 |
Start Point |
819532 |
821420 |
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
5 |
Start Point |
808504 |
821850 |
17 |
Start Point |
820451 |
822125 |
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
6 |
Start Point |
809490 |
822150 |
18 |
Start Point |
821504 |
822371 |
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
7 |
Start Point |
810499 |
822000* |
19 |
Start Point |
822513 |
823268 |
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
8 |
Start Point |
811508 |
821123 |
20 |
Start Point |
823477 |
823402 |
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
9 |
Start Point |
812516 |
821303 |
21 |
Start Point |
805476 |
827081 |
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
10 |
Start Point |
813525 |
821176 |
22 |
Start Point |
806464 |
824033 |
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
11 |
Start Point |
814556 |
818853 |
23 |
Start Point |
814559 |
821739 |
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
12 |
Start Point |
815542 |
818807 |
24 |
Start Point |
805476 |
815900 |
12 |
End Point |
815542 |
824882 |
24 |
End Point |
805476 |
819100 |
The Action and Limit levels of dolphin impact monitoring are shown in Appendix C. The Event Action Plan is presented in Appendix E.
The dolphin monitoring schedules for the reporting period are provided in the Seventy-third to Seventy-sixth Monthly EM&A Reports.
In this reporting period, a total of 8 monitoring events were undertaken. The detailed dolphin monitoring data was reported in the Seventy-third to Seventy-sixth Monthly EM&A Reports.
Two (2) Limit Level exceedances for both NEL and NWL regions were recorded between November 2019 and February 2020. In this reporting period, no unacceptable impact from the activities of this Contract on Chinese White Dolphins was noticeable from general observations.
No marine works were undertaken since July 2019, therefore, daily 250 m marine mammal exclusion zone monitoring was not undertaken since July 2019.
Passive Acoustic Monitoring (PAM) was not undertaken in this reporting period as no marine piling works was carried out outside the daylight hours since September 2015.
Site inspections were carried out on weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. Eighteen (18) site inspections were carried out in the reporting period. Key observations were summarized in the section of EM&A Site Inspection in the Seventy-third to Seventy-seventh Monthly EM&A Reports. The Contractor has rectified all of the observations identified during environmental site inspections in the reporting period.
The Contractor had submitted application form for registration as chemical waste producer under the Contract. Sufficient numbers of receptacles were available for general refuse collection and sorting.
Wastes generated during this reporting period include mainly construction wastes (inert and non-inert), recyclable materials and chemical waste. Reference has been made to the waste flow table prepared by the Contractor (Appendix F). The quantities of different types of wastes are summarized in Table 2.5.
Table 2.5 Quantities of Different Waste Generated in the Reporting Period
Month/ Year |
Inert Construction Waste (a) (m3) |
Imported Fill (m3) |
Inert Construction Waste Re-used (m3) |
Non-inert Construction Waste (b) (kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|||
Category L |
Category M (Mp & Mf) |
Category H |
||||||||
Nov 2019 |
0 |
0 |
0 |
19,670 |
0 |
0 |
0 |
0 |
0 |
|
Dec 2019 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
|
Jan 2020 |
0 |
0 |
0 |
12,260 |
0 |
0 |
0 |
0 |
0 |
|
Feb 2020 |
48 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
|
Mar 2020 |
38 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
0 |
|
Total |
86 |
0 |
0 |
31,930 |
0 |
0 |
0 |
0 |
0 |
|
Notes: |
||||||||||
(a) Inert construction wastes include hard rock and large broken concrete, and materials disposed as public fill. (b) Non-inert construction wastes include general refuse disposed at landfill. (c) Recyclable materials include metals, paper, cardboard, plastics, timber and others. |
||||||||||
The Contractor was advised to properly maintain on site C&D materials and waste collection, sorting and recording system, dispose of C&D materials and wastes at designated ground and maximize reuse/ recycle of C&D materials and wastes. The Contractor was also reminded to properly maintain the site tidiness and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was reminded to treat properly and store temporarily in designated chemical waste storage area on site in accordance with the Code of Practice on the Packaging, Labelling and Storage of Chemical Wastes.
The status of environmental licensing and permit is summarized in Table 2.6 below.
Table 2.6 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental Permit |
EP-353/2009/K |
11-Apr-16 |
N/A |
HyD |
Hong Kong Boundary Crossing Facilities |
Environmental Permit |
EP-354/2009/D |
13-Mar-15 |
N/A |
HyD |
Tuen Mun- Chek Lap Kok Link |
Chemical Waste Registration |
5213-951-G2380-17 |
12-Jun-14 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Chemical Waste Registration |
5213-961-G2380-13 |
10-Oct-13 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10-Oct-13 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
04-Nov-13 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Construction Dust Notification |
361571 |
05-Jul-13 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17-Jul-13 |
N/A |
GCL |
For Area 23 |
Construction Waste Disposal Account |
7017735 |
10-Jul-13 |
N/A |
GCL |
- |
Construction Waste Disposal Account |
7019470 |
03-Mar-14 |
N/A |
GCL |
Vessel CHIT Account |
Construction Noise Permit for night works and works in general holidays |
GW-RW0266-19 |
21-Jun-19 |
13-Dec-19 |
GCL |
General works at WA5 |
Construction Noise Permit for night works and works in general holidays |
GW-RW0592-19 |
18-Dec-19 |
13-Jun-20 |
GCL |
General works at WA5 |
Construction Noise Permit for night works and works in general holidays |
GW-RS0507-19 |
13-Jun-19 |
11-Dec-19 |
GCL |
Broad Permit for Whole Site Areas |
Construction Noise Permit for night works and works in general holidays |
GW-RS1108-19 |
12-Dec-19 |
11-Jun-20 |
GCL |
Broad Permit for Whole Site Areas |
Construction Noise Permit for night works and works in general holidays |
GW-RS0977-19 |
7-Nov-19 |
16-Dec-19 |
GCL |
Defect Repairing at under-bridge of Viaduct A, B, C and D |
Construction Noise Permit for night works and works in general holidays |
GW-RS1214-19 |
16-Jan-20 |
14-Feb-20 |
GCL |
Defect Repairing at under-bridge of Viaduct B and C |
Construction Noise Permit for night works and works in general holidays |
GW-RS0153-20 |
19-Mar-20 |
31-Mar-20 |
GCL |
Defect Repairing at under-bridge of Viaduct B and C |
Construction Noise Permit for night works and works in general holidays |
GW-RS1067-19 |
2-Dec-19 |
31-Dec-19 |
GCL |
Resurfacing Works at Pak Mong |
A summary of the Environmental Mitigation and Enhancement Measure Implementation Schedules (EMIS) is presented in Appendix B. The necessary mitigation measures were implemented properly for this Contract.
No air quality and noise impact monitoring was conducted in the reporting period.
Post-construction water quality monitoring was completed on 23 December 2019.
Two (2) Limit Level exceedances for both NEL and NWL regions were recorded for impact dolphin monitoring for both NEL and NWL regions. No unacceptable impact from the construction activities of the TM-CLKL Southern Connection Viaduct Section on Chinese White Dolphins was noticeable from general observations during the dolphin monitoring in this reporting period. Detailed investigation reports were presented in Appendix J of Twenty-fourth to Twenty-fifth Quarterly EM&A Reports.
The Environmental Complaint Handling Procedure is provided in Figure 2.3.
There was no environmental complaints, notification of summons or successful prosecution received in the reporting period.
Statistics on complaints, notifications of summons, successful prosecutions are summarized in Appendix G.
The EM&A results in the reporting period are compared to the predictions from EIA Report and baseline monitoring result in order to review the validity of EIA predictions.
No air quality monitoring was undertaken in the reporting period. Notification of temporary suspension of air quality monitoring has been approved by EPD on 28 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
No noise monitoring was undertaken in the reporting period. Notification of temporary suspension of noise monitoring has been approved by EPD on 28 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
No water quality impact monitoring was scheduled in the reporting period. Notification of temporary suspension of water quality monitoring has been approved by EPD on 30 August 2019.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
According to the baseline results in the Appendix F of the approved EIA Report, the dolphin groups were largely sighted near waters around Lung Kwu Chau and Sha Chau. There was no dolphin sighted along the alignment of this Contract.
In this reporting period, a total of 8 monitoring events were undertaken. The detailed dolphin monitoring data was reported in the Seventy-third to Seventy-fourth Monthly EM&A Reports.
Two (2) Limit Level exceedances for both NEL and NWL regions were recorded between November 2019 and February 2020. In this reporting period, no unacceptable impact from the activities of this Contract on Chinese White Dolphins was noticeable from general observations.
In general, wastes generated from the construction activities including C&D materials (inert and non-inert), chemical wastes, marine sediment and recyclable materials. The summary of waste generation amount is presented in Table 2.5.
Waste monitoring and audit programme has been undertaken during this reporting period. Wastes arising from this Project have been managed in accordance with the recommendations in the EIA Report, the EM&A Manual, the Waste Management Plan and other relevant statutory requirements.
The requirements for construction waste management have been reviewed and were considered as adequate. No change to the requirements was considered to be necessary.
The EM&A monitoring programme has been reviewed and was considered effective and adequate to cater for the nature of works in progress. No further change to the monitoring programme was considered to be necessary.
The mitigation measures stipulated in the Updated EM&A Manual were undertaken by the Contractor in the reporting period. The mitigation measures were reviewed and considered effective.

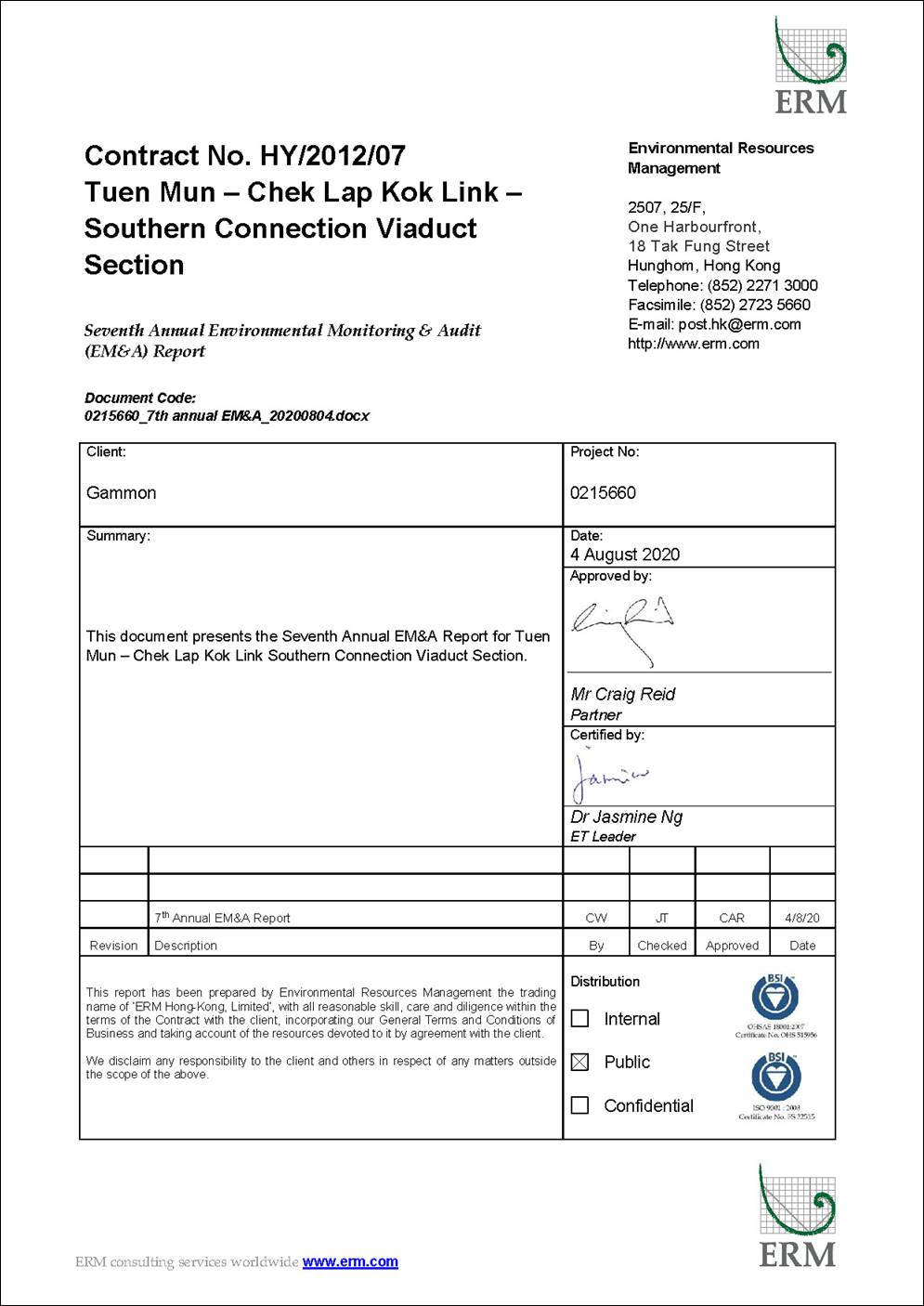

This Seventh Annual EM&A Report presents findings of the EM&A activities undertaken during the period from 1 November 2019 to 16 March 2020, in accordance with the Updated EM&A Manual and the requirements of the Environmental Permits (EP-354/2009/D and EP-353/2009/K).
No Air quality (1-hour TSP and 24-hour TSP) and noise monitoring were carried out in the reporting period.
Post-construction water quality monitoring (DO, turbidity and SS) and dolphin monitoring were carried out in the reporting period.
Two (2) Limit Level exceedances for both NEL and NWL regions were recorded between November 2019 and February 2020, whilst no unacceptable impact from the activities of this Contract on Chinese White Dolphins was noticeable from the general observations.
Environmental site inspection was carried out eighteen (18) times in the reporting period. Recommendations on remedial actions were given to the Contractor for the deficiencies identified during the site audits.
There was no environmental complaints, notification of summons or successful prosecution received during the reporting period.
The review of monitoring data suggested that the construction works under this Contract have proceeded in an environmentally acceptable manner in this reporting period. In general, the monitoring results were in line with EIA predictions.
The monitoring programme has been reviewed and was considered as adequate to cater for the nature of works in progress.
Termination proposal for construction EM&A programme was approved by EPD on 16 March 2020. The construction phase EM&A programme of the Contract has been terminated since 16 March 2020.
