Under Contract No. HY/2012/08,
Dragages ¡V Bouygues Joint Venture (DBJV) is
commissioned by the Highways Department (HyD) to
undertake the design and construction of the Northern Connection Sub-sea Tunnel
Section of the Tuen Mun ¡V Chek Lap Kok Link Project (TM-CLK
Link Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET) in accordance with Environmental
Permit No. EP-354/2009/A. ENVIRON Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO).
Another application for variation of environmental
permit (VEP) (EP-354/2009/B) was
granted on 28 January 2014.
The
construction phase of the Project under the EP-354/2009/A
and the subsequent VEP (EP-354/2009/B)
commenced on 1 November 2013 and will tentatively be completed by the end of
2018. The impact monitoring of the EM&A
programme, including air quality, water quality, marine
ecological monitoring and environmental site inspections, were commenced on 1
November 2013.
This
is the fourth monthly EM&A report presenting the EM&A works carried out
during the period from 1 to 28 February 2014 for the Contract No. HY/2012/08 Northern
Connection Sub-sea Tunnel Section (the ¡§Project¡¨) in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, major activities in the reporting period included:
Marine-based Works
¡P Dredging;
¡P Vertical
Seawall construction;
¡P Sloping
Seawall construction;
¡P Temporary
pontoon installation at River Trade Terminal (RTT); and
¡P Marine
Sheet Piling for Box Culvert extension.
Land-based Works
¡P WA
18 Site office construction;
¡P CLP
Substation structure works; and
¡P CLP Substation E&M works.
A summary of
monitoring and audit activities conducted in the reporting period is listed
below:
24-hour TSP Monitoring 6
sessions
1-hour TSP Monitoring 6
sessions
Impact Water
Quality Monitoring 12
sessions
Impact Dolphin
Monitoring 2
sessions
Joint
Environmental Site Inspection 4
sessions
Daily marine mammal exclusion zone monitoring was undertaken during the
period of dredging works. One sighting
of the Indo-Pacific humpback dolphin Sousa
chinensis was recorded on 20th February
2014 during the exclusion zone monitoring.
The dolphin group of three was sighted within the 250 m marine mammal
exclusion zone from a dredging barge sighting platform by the marine mammal
observer. The marine dredging work
was subsequently suspended until the
observer has confirmed that the area is continuously clear of dolphins for a
period of 30 minutes.
Summary of
Breaches of Action/Limit Levels
Breaches of Action and Limit Levels for Air Quality
Two Action Level
exceedances for 1-hr TSP while no exceedance
for 24-hr TSP in air quality monitoring were recorded during the reporting
month. The Project works were unlikely
to be the major cause of the recorded exceedances upon
further investigation.
Breaches of Action and Limit Levels for Water Quality
No exceedances were recorded during the reporting month.
Dolphin Monitoring
Whilst one
Action Level exceedance was observed for the
quarterly dolphin monitoring data between December 2013 and February 2014, no unacceptable
impact from the construction activities of the TM-CLKL Northern Connection
Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from general
observations during the dolphin monitoring in this reporting month. Due
to monthly variation in dolphin occurrence within the study area, it would be
more appropriate to draw conclusion on whether any unacceptable impacts on dolphins have been detected
related to the construction activities of the TM-CLKL Northern Connection
Sub-sea Tunnel Section in the quarterly EM&A reports, where comparison on
distribution, group size and encounter rates of dolphins between the quarterly
impact monitoring period and baseline monitoring period will be made.
Environmental
Complaints, Non-compliance & Summons
No
non-compliance with EIA recommendations, EP conditions and other requirements associated with
the construction of this Contract was recorded in this reporting period.
No
environmental complaint was received in this reporting period.
No
environmental summons was received in this reporting period.
Reporting
Change
There was no
reporting change required in the reporting period.
Upcoming Works for the Next Reporting Period
Works to be
undertaken in the next monitoring period of March 2014 include the following:
Marine-based Works
¡P Dredging;
¡P Reclamation;
¡P Vertical
Seawall construction;
¡P Sloping
Seawall construction;
¡P Marine
Sheet Piling for Box Culvert extension; and
¡P Predrilling for Box culvert Foundation.
Land-based Works
¡P AECOM
site office construction;
¡P CLP
Substation Footing & underground utilities works; and
¡P CLP
Substation Superstructure.
Future Key
Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of March 2014 are expected to be mainly associated
with dust, marine water quality, marine ecology and waste management.
According to
the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure
Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau
Highway would be operating beyond capacity after 2016. This forecast has been based on the
estimated increase in cross boundary traffic, developments in the Northwest New
Territories (NWNT), and possible developments in North Lantau,
including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong ¡V Zhuhai ¡V Macao Bridge (HZMB). In order to cope with the anticipated
traffic demand, two new road sections between NWNT and North Lantau ¡V Tuen Mun
¡V Chek Lap Kok Link
(TM-CLKL) and Tuen Mun
Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The
EIA Report was submitted under the Environmental Impact Assessment Ordinance
(EIAO) in August 2009. Subsequent
to the approval of the EIA Report (EIAO Register Number AEIAR-145/2009), an
Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of
Environmental Protection (DEP) on 4 November 2009, and EP variation (VEP)
(EP-354/2009A) was issued on 8 December 2010. Another application for VEP
(EP-354/2009/B) was granted on 28 January 2014.
Under
Contract No. HY/2012/08,
Dragages ¡V Bouygues Joint Venture (DBJV) is
commissioned by the Highways Department (HyD) to
undertake the design and construction of the Northern Connection Sub-sea Tunnel
Section of TM-CLKL (¡§the Contract¡¨) while AECOM Asia
Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM)
has been appointed as the Environmental Team (ET) in accordance with Environmental
Permit No. EP-354/2009/A and VEP (EP-354/2009/B). ENVIRON
Hong Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO).

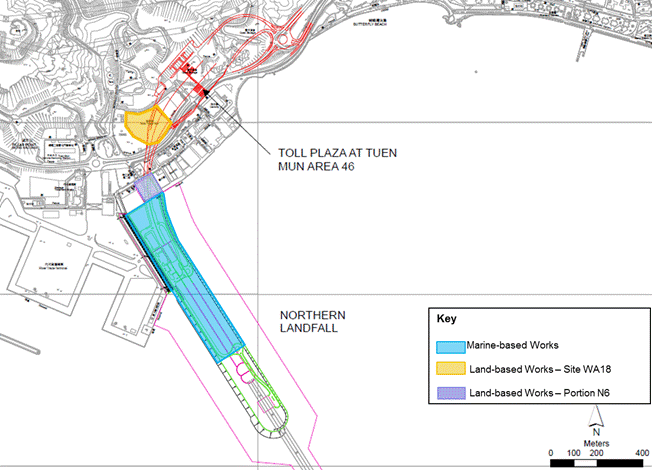

Layout of the
Contract components is presented in Figure 1.1.
The
organization structure of the Contract is shown in Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Edwin
Ching Andrew
Westmoreland |
2450
3111 2450
3511 |
2450
3099 2450
3099 |
ENPO / IEC (ENVIRON
Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465 2888 |
3465 2899 |
IEC |
Tony Cheng |
3465 2888 |
3465 2899 |
|
Contractor (Dragages ¡V
Bouygues Joint Venture) |
Environmental
Manager |
C.F. Kwong |
2293
7322 |
2670
2798 |
Environmental
Officer 24hour
complaint hotline |
Bryan Lee Rachel Lam |
2293
7323 2293
7342 |
2670
2798 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Marine-based Works
¡P Dredging;
¡P Vertical
Seawall construction;
¡P Sloping
Seawall construction;
¡P Temporary
pontoon installation at RTT; and
¡P Marine
Sheet Piling for Box Culvert extension.
Land-based Works
¡P WA
18 Site office construction;
¡P CLP
Substation structure works; and
¡P CLP
Substation E&M works.
Figure 1.2 Locations
of Construction Activities ¡V February 2014
|
The EM&A programme required environmental monitoring for air quality,
water quality and marine ecology as well as environmental site inspections for
air quality, noise, water quality, waste management, marine ecology and
landscape and visual impacts. The
EM&A requirements and related findings for each component are summarized in
the following sections
In accordance
with the Updated EM&A Manual, impact 1-hour TSP monitoring was conducted
three (3) times every six (6) days and impact 24-hour TSP monitoring was
carried out once every six (6) days when the highest dust impact was expected.
High volume
samplers (HVSs) were used to carry out the 1-hour and 24-hour TSP monitoring on
5, 8, 12, 18, 24 and 28 February 2014 at the five (5) air quality monitoring
stations in accordance with the requirements stipulated in the Updated EM&A
Manual (Figure 2.1; Table 2.1).
Wind anemometer was installed at
the rooftop of ASR5 for logging wind speed and wind direction. Details of the equipment deployed are provided
in Table 2.2. Copies of the calibration certificates
for the equipment are presented in Appendix E.
Table 2.1 Locations
of Impact Air Quality Monitoring Stations
Monitoring
Station |
Monitoring
Dates |
Location |
Description |
Parameters & Frequency |
ASR1 |
5,
8, 12, 18, 24 and 28 February 2014 |
Tuen Mun Fireboat Station |
Office |
1-hour Total Suspended Particulates (1-hour
TSP, µg/m3), 3 times per day every 6 days
24-hour Total Suspended Particulates
(24-hour TSP, µg/m3), daily for 24-hour every 6 days |
ASR5 |
|
Pillar
Point Fire Station |
Office |
|
AQMS1 |
|
Previous
River Trade Golf |
Bare
ground |
|
ASR6 |
|
Butterfly
Beach Laundry |
Office |
|
ASR10 |
|
Butterfly
Beach Park |
Recreational
uses |
Table 2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP)
High Volume Sampler (Model No. TE-5170) |
Wind Anemometer |
MetPak, WindSonic |
The Action and
Limit Levels of the air quality monitoring is provided in Appendix D. The Event and Action plan is presented
in Appendix K.
The schedule
for air quality monitoring in February 2014 is provided in Appendix F.
The
monitoring results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4, respectively. Detailed
impact air quality monitoring results and graphical presentations are presented
in Appendix G.
Table 2.3 Summary
of 1-hour TSP Monitoring Results in this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR 1 |
151 |
56
- 305 |
331 |
500 |
ASR 5 |
168 |
60
- 308 |
340 |
500 |
AQMS1 |
149 |
63
- 339 |
335 |
500 |
ASR6 |
153 |
56
- 361 |
338 |
500 |
ASR10 |
110 |
46
- 228 |
337 |
500 |
Table 2.4 Summary
of 24-hour TSP Monitoring Results in this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR 1 |
62 |
32
- 97 |
213 |
260 |
ASR 5 |
79 |
39
- 135 |
238 |
260 |
AQMS1 |
62 |
40
- 97 |
213 |
260 |
ASR6 |
56 |
38
- 85 |
238 |
260 |
ASR10 |
49 |
34
- 70 |
214 |
260 |
The major dust
sources in the reporting period include construction activities under the
Contract as well as nearby traffic emissions.
A total of six
monitoring events were undertaken in which two Action Level exceedances
of 1-hr TSP and no exceedance of 24-hr TSP were recorded
in this reporting month.
Meteorological
information collected at the ASR5, including wind speed and wind direction, is provided
in Appendix H.
Meteorological information recorded by the wind anemometer between 4 and
14 February 2014 is not available due to power failure.
In accordance
with the Updated EM&A Manual, impact water quality monitoring was carried
out three days per week during the construction period at nine (9) water
quality monitoring stations (Figure 2.2; Table 2.5).
Table 2.5 Locations
of Water Quality Monitoring Stations and the Corresponding Monitoring
Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Depth |
Frequency |
|
|
|
Easting |
Northing |
|
|
|
IS12 |
Impact
Station |
813218 |
823681 |
Temperature(¢XC)
pH(pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) ¡P
SS (mg/L) |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed.
If the water depth is less than 3m, mid-depth sampling only. If water depth less than 6m, mid-depth
may be omitted. |
Impact monitoring: 3 days per week, at mid-flood
and mid-ebb tides during the construction period of the Contract. |
IS13 |
Impact Station |
813667 |
824325 |
|||
IS14 |
Impact Station |
812592 |
824172 |
|||
IS15 |
Impact Station |
813356 |
825008 |
|||
CS4 |
Control /
Far Field Station |
810025 |
824004 |
|||
CS6 |
Control /
Far Field Station |
817028 |
823992 |
|||
SR8 |
Sensitive
receiver (Gazettal beaches in Tuen Mun) |
816306 |
825715 |
|||
SR9 |
Sensitive
receiver |
813601 |
825858 |
|||
SR10A |
Sensitive
receiver |
823741 |
823495 |
|||
*Notes: In addition to the parameters presented monitoring location/position,
time, water depth, sampling depth, tidal stages, weather conditions and any
special phenomena or works underway nearby were also recorded. |
Table 2.6 summarises the equipment
used in the impact water quality monitoring programme. Copies
of the calibration certificates are attached in Appendix E.
Table 2.6 Water
Quality Monitoring Equipment
Equipment |
Model |
Qty. |
Water Sampler |
Kahlsico Water-Bottle Model 135DW 150 |
4 |
Multi-parameter Water Quality System |
YSI 6820-C-M/YSI 6920 |
6 |
Dissolved Oxygen Meter |
YSI Pro 2030 |
1 |
pH Meter |
HANNA HI 8314 |
1 |
Turbidity Meter |
HACH 2100Q |
1 |
Monitoring Position Equipment |
¡§Magellan¡¨ Handheld GPS Model eXplorist GC |
4 |
DGPS Koden KGP913MK2 (1) |
1 |
The Action and Limit levels of water quality impact
monitoring are shown in Appendix D. The Event and Action plan is presented
in Appendix K.
The schedule
for water quality monitoring in February 2014 is provided in Appendix F.
During this
reporting period, marine dredging activities were undertaken at Portions N-A
and N-B. A closed grab dredger was
used and silt curtains (cage-type and single floating type) were deployed
during dredging works. The level of
dredging activities was within the working rate described in the EP and the approved
EIA Report. It is useful to note
that heavy marine traffic (not associated with the Project) was commonly
observed nearby the Project site and its vicinity.
Impact water
quality monitoring was conducted at all designated monitoring stations in the
reporting month. Detailed impact water
quality monitoring results are presented in Appendix I.
A total of twelve
monitoring events were undertaken in which no exceedances
was recorded.
Impact dolphin
monitoring is required to be conducted by a qualified dolphin specialist team
to evaluate whether there have been any effects on the dolphins. In order to fulfil the EM&A
requirements and make good use of available resources, the on-going impact line
transect dolphin monitoring data collected by HyD¡¦s Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong
Kong Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing
Facilities on the monthly basis is adopted to avoid duplicates of survey
effort.
Table 2.7 summarises the equipment
used for the impact dolphin monitoring.
Table 2.7 Dolphin
Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and
reticules 65 foot single
engine motor vessel with viewing platform 4.5m above water level |
|
|
Dolphin
monitoring should cover all transect lines in Northeast Lantau
(NEL) and the Northwest Lantau (NWL) survey areas
twice per month throughout the entire construction period. The monitoring data should be compatible
with, and should be made available for, long-term studies of small cetacean
ecology in Hong Kong. In order to
provide a suitable long-term dataset for comparison, identical methodology and
line transects employed in baseline dolphin monitoring was followed in the
impact dolphin monitoring.
The impact
dolphin monitoring was carried out in the NEL and NWL along the line transect
as depicted in Figure 2.3. The co-ordinates of all transect lines
are shown in Table 2.8 below.
Table 2.8 Impact
Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start Point |
804671 |
814577 |
13 |
Start Point |
816506 |
819480 |
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
2 |
Start Point |
805475 |
815457 |
14 |
Start Point |
817537 |
820220 |
2 |
End Point |
805477 |
826654 |
14 |
End Point |
817537 |
824613 |
3 |
Start Point |
806464 |
819435 |
15 |
Start Point |
818568 |
820735 |
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
4 |
Start Point |
807518 |
819771 |
16 |
Start Point |
819532 |
821420 |
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
5 |
Start Point |
808504 |
820220 |
17 |
Start Point |
820451 |
822125 |
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
6 |
Start Point |
809490 |
820466 |
18 |
Start Point |
821504 |
822371 |
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
7 |
Start Point |
810499 |
820690 |
19 |
Start Point |
822513 |
823268 |
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
8 |
Start Point |
811508 |
820847 |
20 |
Start Point |
823477 |
823402 |
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
9 |
Start Point |
812516 |
820892 |
21 |
Start Point |
805476 |
827081 |
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
10 |
Start Point |
813525 |
820872 |
22 |
Start Point |
806464 |
824033 |
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
11 |
Start Point |
814556 |
818449 |
23 |
Start Point |
814559 |
821739 |
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
12 |
Start Point |
815542 |
818807 |
|
|
|
|
12 |
End Point |
815542 |
824882 |
|
|
|
|
The Action and
Limit levels of dolphin impact monitoring are shown in Appendix D. The Event and Action plan is presented
in Appendix K.
Dolphin
monitoring was carried out on 6, 12, 14 and 20 February 2014. The dolphin monitoring schedule for the
reporting month is shown in Appendix F.
A total of 297.84
km of survey effort was collected, with 97.9% of the total survey effort being
conducted under favourable weather conditions (ie Beaufort Sea State 3 or below with good visibility) in February
2014. Amongst the two areas, 116.12
km and 181.72 km of survey effort were collected from NEL and NWL survey areas,
respectively. The total survey
effort conducted on primary and secondary lines were 211.78 km and 86.06 km,
respectively. The survey efforts are
summarized in Appendix J.
A total of 11 groups of 36 Chinese
White Dolphin sightings were recorded
during the two sets
of surveys in February 2014. All
except one sighting were made in NWL during the two sets of surveys in February,
with another group of four animals being sighted in NEL. All sightings were made on primary lines
during on-effort search, and only one of the dolphin groups was associated with
an operating fishing vessel.
Despite
the lone sighting made just adjacent to the River Trade Terminal on 6 February
2014, none of the 11 sightings was made in the proximity of this Project. The distribution of dolphin sightings
during the reporting month is shown in Figure 2.4.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable
conditions (Beaufort 3 or below with good visibility) in February 2014 with the
results present in Tables 2.9 and 2.10.
Table 2.9 Individual
Survey Event Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: Feb
6th/12th |
0.0 |
0.0 |
Set 2: Feb
14th/20th |
0.0 |
0.0 |
|
NWL |
Set 1: Feb
6th/12th |
7.4 |
17.9 |
Set 2: Feb
14th/20rd |
6.2 |
29.5 |
Note:
Dolphin Encounter Rates
are deduced from the Two Sets of Surveys (Two Surveys in Each Set) in February 2014
in Northeast (NEL) and Northwest Lantau (NWL)
Table 2.10 Monthly
Average Encounter Rates
|
Encounter rate (STG)
(no. of on-effort dolphin sightings per
100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per 100 km of survey
effort) |
||
Primary Lines Only |
Both Primary and Secondary Lines |
Primary Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
6.8 |
5.1 |
23.5 |
17.7 |
Note: Overall dolphin encounter rates (sightings per
100km of survey effort) from all four surveys are conducted in February 2014 on
primary lines only as well as both primary lines and secondary lines in
Northeast and Northwest Lantau.
The average
group size of Chinese White Dolphins in February 2014 was 3.27 individuals per
group. Most dolphin groups were
composed of only 1 - 4 animals with only two larger groups of seven animals being
sighted.
Whilst one
Action Level exceedance was observed for the
quarterly dolphin monitoring data between December 2013 and February 2014, no
unacceptable impact from the construction activities of the TM-CLKL Northern
Connection Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from
general observations during the dolphin monitoring in this reporting month. The observed exceedance
will be further investigated in the First
Quarterly EM&A Report for November 2013 to February 2014.
Due to monthly
variation in dolphin occurrence within the survey area, it would be more
appropriate to draw conclusion on whether any unacceptable impacts on dolphins
have been detected related to the construction activities of this Project in
the quarterly EM&A reports, where comparison on distribution, group size
and encounter rates of dolphins between the quarterly impact monitoring period
and baseline monitoring period will be made.
Daily 250 m marine
mammal exclusion zone monitoring was undertaken during the period of dredging
activities under this Contract. One sighting of the Indo-Pacific humpback dolphin Sousa chinensis
was recorded on 20 February 2014 during the exclusion zone monitoring. The dolphin group of three was sighted
within the 250 m marine mammal exclusion zone from a dredging barge sighting
platform by the marine mammal observer.
The marine dredging work was subsequently suspended until the observer has confirmed that the
area is continuously clear of dolphin for a period of 30 minutes. The Dolphin Intrusion Report is presented in
Appendix
J[JY1] .
Site
inspections were carried out on a weekly basis to monitor the implementation of
proper environmental pollution control and mitigation measures under the
Contract. In the reporting month, four
(4) site inspections were carried out on 5, 11, 19 and 26 February 2014.
Key observations
during the site inspections are described below:
¡P
Stockpile
not in use should be fully covered. (Portion N6)
¡P
No adverse observation was identified in the reporting
month.
¡P
Excess
sandy materials should be cleaned from the decks and exposed fittings of the
barge. (Crown Asia 11)
Daily 250 m marine
mammal exclusion zone monitoring was implemented during the period of dredging
activities under this Contract. One sighting of the Indo-Pacific humpback dolphin Sousa chinensis
was recorded on 20 February 2014 during the exclusion zone monitoring. The dolphin group of three was sighted
within the 250m marine mammal exclusion zone from a dredging barge sighting
platform by the marine mammal observer.
The marine dredging work was subsequently suspended until the observer has confirmed that the
area is continuously clear of dolphin for a period of 30 minutes.
¡P Drip
tray should be provided to the oil drum to avoid chemical spillage. (Barge -
Tai Hip 2)
¡P Chemical
labels should be provided to the oil drum and the drip tray for the winch
should be maintained regularly to avoid oil spillage. (Barge - Tai Hip 2)
¡P Drip
tray for the oil gun should be regularly maintained and the oil gun should be
properly stored while not in use. (Dredging Barge - Crown Asia 1)
¡P Chemical
containers should be properly stored in the drip tray. (Dredging Barge - Crown
Asia 1)
¡P Sheet
piling driving machine should be maintained regularly and the oil stain should
be cleared as chemical waste. (Barge - Sun Leung Kee
13)
¡P No
adverse observation was identified in the reporting month.
¡P
No adverse observation was identified in the reporting
month.
The Contractor
has rectified all of the observations as identified during environmental site
inspection in the reporting month.
The Contractor
had submitted application form for registration as chemical waste producer under
the Contract. Sufficient numbers of
receptacles were available for general refuse collection and sorting.
As
advised by the Contractor, no inert C&D Materials are disposed of as public
fill; 20 kg of chemical waste was recycled in the reporting period. 18,500 m3 of Category L marine
sediment and 24,500 m3 of Category M marine sediment are generated
and disposed of at designated sites.
Monthly summary of waste flow table is detailed in Appendix M.
The Contractor
was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials
and wastes. The Contractor was
reminded to properly maintain the site tidiness and dispose of the wastes
accumulated on site regularly and properly.
The Contractor
was reminded that chemical waste containers should be properly treated and
stored temporarily in designated chemical waste storage area on site in
accordance with the Code of Practice on the Packaging, Labelling and Storage of
Chemical Wastes.
The status of
environmental licensing and permit is summarized in Table 2.11 below.
Table 2.11 Summary
of Environmental Licensing and Permit Status
Statutory Reference |
License/
Permit |
License
or Permit No. |
Date
of Issue |
Date
of Expiry |
License/ Permit Holder |
Remarks |
EIAO |
Environmental Permit |
EP-354/2009/B |
28 January 2014 |
Throughout the Contract |
HyD |
Application for VEP on 20 January 2014 to replace EP-354/2009/A |
NCO |
Construction Dust Notification |
363510 |
19 Aug 2013 |
Throughout the Contract |
DBJV |
- |
WDO |
Chemical Waste Registration |
5213-422-D2516-01 |
10 Sep 2013 |
Throughout the Contract |
DBJV |
- |
WDO |
Construction Waste Disposal Account |
7018108 |
19 Aug 2013 |
Throughout the Contract |
DBJV |
Waste disposal in Contract HY/2012/08 |
WPCO |
Waste Water Discharge License |
WT00017707-2013 |
18 Nov 2013 |
30 Nov 2018 |
DBJV |
Discharge of Construction Runoff |
NCO |
Construction Noise Permit |
GW-RW0035-13 |
27 Jan 2014 |
26 Jul 2014 |
DBJV |
For Dredging and Reclamation Works,
superseded by GW-RW0095-14 on 10 Feb 2014 |
NCO |
Construction Noise Permit |
GW-RW0095-14 |
10 Feb 2014 |
9 Aug 2014 |
DBJV |
For Dredging and Reclamation Works |
NCO |
Construction Noise Permit |
GW-RW0822-13 |
14 Nov 2013 |
10 May 2014 |
DBJV |
For works in site WA18 |
NCO |
Construction Noise Permit |
GW-RS0814-13 |
15 Nov 2013 |
10 May 2014 |
DBJV |
For works in site WA23 |
NCO |
Construction Noise Permit |
GW-RW0029-14 |
27 Jan 2014 |
26 Jul 2014 |
DBJV |
For Portion N6, superseded by GW-RW0077-14 on 17 Feb 2014 |
NCO |
Construction Noise Permit |
GW-RW0077-14 |
17 Feb 2014 |
16 Aug 2014 |
DBJV |
For Portion N6 |
DASO |
Marine Dumping Permit |
EP/MD/14-072 |
1 Nov 2013 |
30 Apr 2014 |
DBJV |
For Type 1 |
DASO |
Marine Dumping Permit |
EP/MD/14-124 |
1 Feb 2014 |
28 Feb 2014 |
DBJV |
For Type 1 (Dedicated site) and Type
2 |
In response to
the site audit findings, the Contractors carried out corrective actions.
A summary of
the Implementation Schedule of Environmental Mitigation Measures (EMIS) is
presented in Appendix C. The necessary mitigation measures relevant
to this Contract were implemented properly.
No exceedances were recorded for water quality monitoring
during the reporting month. Two Action
level exceedances of 1-hr TSP and no exceedances of 24-hr TSP for air quality were recorded
during the reporting month. Further
to the investigation, the recorded exceedances for
air quality monitoring were considered to be sporadic event from the cumulative
anthropogenic activities (eg traffic emissions from
Lung Mun Road and River Trade Terminal) in this area
of Hong Kong, thus the Project works were unlikely to be the major cause of the
recorded exceedances. The investigation findings are detailed
in Appendix L.
One Action
Level exceedance was recorded for the quarterly
dolphin monitoring data between December 2013 and February 2014. The observed exceedance
will be further investigated in the First
Quarterly EM&A Report for November 2013 to February 2014.
Cumulative
statistics are provided in Appendix L.
The
Environmental Complaint Handling Procedure is provided in Figure 2.5.
No complaints,
notification of summons and prosecution were received in the reporting period.
Statistics on
complaints, notifications of summons and successful prosecutions are summarized
in Appendix L.
As informed by
the Contractor, the major works for the Project in March 2014 will be:
¡P Dredging;
¡P Reclamation;
¡P Vertical
Seawall construction;
¡P Sloping
Seawall construction;
¡P Marine
Sheet Piling for Box Culvert extension; and,
¡P Predrilling for Box culvert Foundation.
Land-based Works
¡P
AECOM site office construction;
¡P
CLP Substation Footing & underground utilities
works; and
¡P
CLP
Substation Superstructure.
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of March 2014 are mainly associated with dust,
marine water quality, marine ecology and waste management issues.
The tentative
schedule for environmental monitoring in March 2014 is provided in Appendix F.
This Fourth
Monthly EM&A Report presents the findings of the EM&A activities
undertaken during the period from 1 to 28 February 2014, in accordance with the
Updated EM&A Manual and the requirements of EP-354/2009/B.
Air quality
(including 1-hour TSP and 24-hour TSP), water quality and dolphin monitoring were
carried out in this reporting month.
Two (2) Action Level exceedances of 1-hr TSP and
no exceedances of 24-hr TSP for air quality
monitoring were recorded in the reporting month. No exceedances for water quality monitoring was recorded in the reporting
month. Investigation findings
suggested that the Project works were not the major cause of the recorded exceedances for air quality monitoring. Nevertheless, the Contractor was
reminded to ensure all dust mitigation measures are implemented at the
construction site and the proper deployment of silt curtains during the period
of marine works under this Contract.
A total of 11 groups of 36 Chinese
White Dolphin sightings were recorded
during the two sets
of surveys in February 2014. All
except one sighting were made in NWL during the two sets of surveys in February,
with another group of four animals being sighted in NEL. All sightings were made on primary lines
during on-effort search, and only one of the dolphin groups was associated with
an operating fishing vessel. Whilst
one Action Level exceedance was observed for the
quarterly dolphin monitoring data between December 2013 and February 2014, no unacceptable
impact from the construction activities of the TM-CLKL Northern Connection
Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from general
observations during the dolphin monitoring in this reporting month.
Environmental
site inspection was carried out four (4) times in February 2014. Recommendations on remedial actions were
given to the Contractor for the deficiencies identified during the site audits.
According to
the environmental site inspections performed in the reporting month, the
following recommendations were provided:
Temporary
stockpiles at the works area should be properly covered by tarpaulin when
piling is completed.
Regular water
spraying should be applied to ground breaking works and dust generating area.
Measures
should be undertaken by the Contractor to avoid residual sandy materials
leaving from at the edge of loading area which may lead to surface runoff in
the vicinity.
The Contractor
should avoid sandy materials from entering the drainage area.
The Contractor
should ensure that the dredging is undertaken properly to avoid spillage
outside the cage-type silt curtain in the dredging site of barge Crown Asia 1
and GD2.
The Contractor
should install drip tray stopper and clear water stagnant in the drip
tray.
The Contractor
should proper label the oil drums.
The Contractor
should clear oil stain on the barge.
Drip tray
should be provided by the Contractor for the chemical containers
[JY1]Please insert the report in appendix J
