table of Contents
Executive
Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Dolphin Monitoring
2.3 EM&A Site Inspection
2.4 Waste Management Status
2.5 Environmental Licenses and
Permits
2.6 Implementation Status of
Environmental Mitigation Measures
2.7 Summary of Exceedances of the
Environmental Quality Performance Limit
2.8 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Activities for
the Coming Month
3.2 Key Issues for the Coming Month
3.3 Monitoring Schedule for the
Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
Under Contract No. HY/2012/08, Dragages – Bouygues Joint Venture (DBJV) is commissioned by
the Highways Department (HyD) to undertake the design
and construction of the Northern Connection Sub-sea Tunnel Section of the Tuen Mun – Chek
Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET) in accordance with Environmental
Permit No. EP-354/2009/A. Ramboll Hong Kong
Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO). Subsequent applications for variation
of environmental permits (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
The construction phase of the
Project commenced on 1 November 2013 and will tentatively be completed by the
end of 2018. The impact monitoring of
the EM&A programme, including air quality, water
quality, marine ecological monitoring and environmental site inspections, were
commenced on 1 November 2013.
This is the Fifty-first Monthly
EM&A report presenting the EM&A works carried out during the period
from 1 to 31 January 2018 for the Contract
No. HY/2012/08 Northern
Connection Sub-sea Tunnel Section (the “Project”) in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, major activities in the reporting period included:
Land-based
Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Cross Passage Construction by Pipe Jackin
– TBM Tunnel;
·
Corbel & OVHD Construction – TBM Tunnel;
·
Parapet wall Installation – TBM Tunnel;
·
Excavation of Sub-sea Tunnel – TBM tunnel;
·
Bulk Excavation – Portion S-A;
·
CSM treatment, Jet Grouting works and D-wall
Construction; and
·
Ground Freezing Works – Portion S-A
There was no
dredging, reclamation or marine sheet piling works in open waters during this
reporting period.
A summary of monitoring and audit
activities conducted in the reporting period is listed below:
24-hour TSP Monitoring 11 sessions
1-hour TSP Monitoring 11 sessions
Impact Dolphin Monitoring 2 sessions
Joint Environmental Site
Inspection 5 sessions
Implementation
of Marine Mammal Exclusion Zone
There was
no dredging, reclamation or marine sheet piling works in open waters during
this reporting period. Thus, Passive Acoustic Monitoring (PAM) and the
day-time monitoring of Dolphin Exclusion Zone (DEZ) by dolphin observers were
not in effect during the reporting period.
Summary of
Breaches of Action/Limit Levels
Breaches
of Action and Limit Levels for Air Quality
One (1) Action Level of 1-hour
TSP was recorded on 13 January 2017.
Three (3) Action Level exceedances of 1-hour TSP were recorded on 16 January 2018. Two (2) Action Level exceedance of 1-hour TSP
was recorded on 22 January 2018.
Investigation reports are provided in Appendix K.
Breaches
of Action and Limit Levels for Dolphin Monitoring
Due to monthly variation in dolphin occurrence within the
survey area, it would be more appropriate to draw conclusion on whether any
unacceptable impacts on dolphins have been detected in relation to the construction
activities of this Project in the quarterly EM&A reports, where comparison
on distribution, group size and encounter rates of dolphins between the
quarterly impact monitoring period and baseline monitoring period will be made.
Summary of
Marine Travel Route record
No non-compliance with EIA
recommendations,
EP conditions and other requirements associated with the marine travel route
record of this Contract was recorded in January 2018.
Environmental
Complaints, Non-compliance & Summons
No non-compliance with EIA
recommendations,
EP conditions and other requirements associated with the construction of this
Contract was recorded in this reporting period.
One (1) environmental complaint case regarding air, noise
and light pollution at River Trade Terminal was referred by IEC on 30 January
2018. The complaint investigation report
is provided in Appendix K.
No environmental summons was
received in this reporting period.
Reporting
Change
There was no reporting change
required in the reporting period.
Upcoming Works for the Next Reporting Month
Works to be undertaken in the
next monitoring period of February 2018 include the following:
Land-based
Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Excavation of Sub-sea Tunnel – TBM tunnel;
·
Corbel Construction – TBM Tunnel;
·
Bulk Excavation – Portion S-A;
·
TBM Excavation – Portion S-A;
·
CSM treatment, Jet Grouting works and D-wall
Construction; and
·
Ground Freezing Works – Portion S-A
Marine-based
Works
·
Seawall Modificaton Works –
Portion S-A
Future Key
Issues
Potential environmental impacts arising
from the above upcoming construction activities in the next reporting month of
February 2018 are mainly associated with dust, marine water quality, marine
ecology and waste management issues.
According
to the findings of the Northwest New Territories (NWNT) Traffic and
Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be
operating beyond capacity after 2016.
This forecast has been based on the estimated increase in cross boundary
traffic, developments in the Northwest New Territories (NWNT), and possible
developments in North Lantau, including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic
demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek
Lap Kok Link (TM-CLKL) and Tuen
Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental
Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (VEP) (EP-354/2009/A) was issued on 8 December
2010. Subsequent applications for
variation of environmental permits (VEPs), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D,
were granted on 28 January 2014, 10 December 2014 and 13 March 2015,
respectively.
Under
Contract No. HY/2012/08, Dragages – Bouygues Joint Venture (DBJV) is commissioned by
the Highways Department (HyD) to undertake the design
and construction of the Northern Connection Sub-sea Tunnel Section of TM-CLKL
while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET). Ramboll Hong
Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO).
Layout
of the Contract components is presented in Figure 1.1.
The
organization structure of the Contract is shown in Appendix A. The key
personnel contact names and contact details are summarized in Table 1.1 below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways
Department |
Engr
22/HZMB |
Chow Man
Lung, Andrew |
2762 4110 |
2762 4110 |
SOR (AECOM Asia
Company Limited) |
Chief Resident
Engineer |
Roger Man Andrew
Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
ENPO / IEC (Ramboll Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465
2850 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3465
2851 |
3465 2899 |
|
Contractor (Dragages – Bouygues Joint Venture) |
Environmental
Officer |
Bryan Lee |
2293 7323 |
2293 7499 |
|
24-hour
complaint hotline |
Rachel Lam |
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Table 1.2 Summary of Construction Activities Undertaken during the
Reporting Period
Construction Activities Undertaken |
Land-based Works |
·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Cross Passage Construction by Pipe Jackin – TBM Tunnel; ·
Corbel & OVHD Construction – TBM Tunnel; ·
Parapet wall Installation – TBM Tunnel; ·
Excavation of Sub-sea Tunnel – TBM tunnel; ·
Bulk Excavation – Portion S-A; ·
CSM treatment, Jet Grouting works and D-wall
Construction; and ·
Ground Freezing Works – Portion S-A |

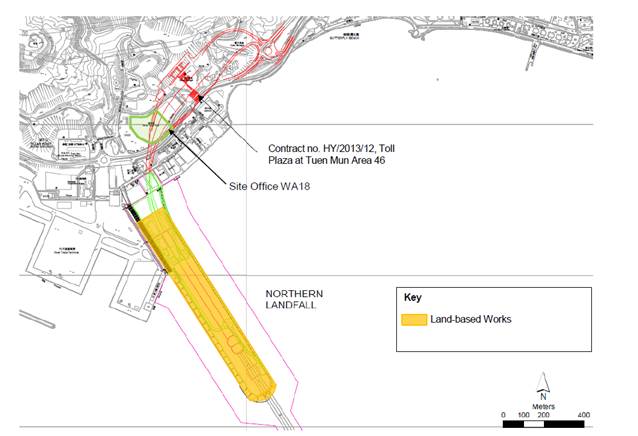

Figure 1.2 Locations of Construction Activities – January 2018
|
The
EM&A programme required environmental monitoring
for air quality, water quality and marine ecology as well as environmental site
inspections for air quality, noise, water quality, waste management, marine
ecology and landscape and visual impacts.
The EM&A requirements and related findings for each component are
summarized in the following sections
In
accordance with the Updated EM&A Manual and the Enhanced TSP Monitoring
Plan, impact 1-hour TSP monitoring was conducted three (3) times every six (6)
days and impact 24-hour TSP monitoring was carried out once every six (6) days
when the highest dust impact was expected.
1-hr and 24-hr TSP monitoring frequency was increased to three times per
day every three days and daily every three days, respectively, as excavation
works for launching shaft commenced on 24 October 2014.
High
volume samplers (HVSs) were used to carry out the 1-hour and 24-hour TSP
monitoring on 1, 4, 7, 10, 13, 16, 19, 22, 25, 28 and 31 January 2018 at the
five (5) air quality monitoring stations in accordance with the requirements
stipulated in the Updated EM&A Manual (Figure 2.1; Table 2.1). Wind meter was installed at the rooftop of
ASR5 for logging wind speed and wind direction.
Details of the equipment deployed are provided in Table 2.2. Copies of the
calibration certificates for the equipment are presented in Appendix E.
Table
2.1 Locations of Impact Air Quality
Monitoring Stations and Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Dates |
Location |
Description |
Parameters
& Frequency |
ASR1 |
1,
4, 7, 10, 13, 16, 19, 22, 25, 28 and 31 January 2018 |
Tuen Mun Fireboat Station |
Office |
TSP monitoring
1-hour Total
Suspended Particulates (1-hour TSP, µg/m3), 3 times in every 6
days
24-hour Total
Suspended Particulates (24-hour TSP, µg/m3), daily for 24-hour in
every 6 days Enhanced TSP monitoring (commenced on 24 October 2014)
1-hour Total
Suspended Particulates (1-hour TSP, µg/m3), 3 times in every 3
days
24-hour Total
Suspended Particulates (24-hour TSP, µg/m3), daily for 24-hour in
every 3 days |
ASR5 |
|
Pillar
Point Fire Station |
Office |
|
AQMS1 |
|
Previous
River Trade Golf |
Bare
ground |
|
ASR6 |
|
Butterfly
Beach Laundry |
Office |
|
ASR10 |
|
Butterfly
Beach Park |
Recreational
uses |
Table 2.2 Air
Quality Monitoring
Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended Particulate
(TSP) High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model: Vantage Pro 2 (S/N: AS160104014) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The
Action and Limit Levels of the air quality monitoring is provided in Appendix D. The
Event and Action plan is presented in Appendix J.
The
schedule for air quality monitoring in January 2018 is provided in Appendix F.
The
monitoring results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4, respectively. Detailed
impact air quality monitoring results and graphical presentations are presented
in Appendix G.
Table 2.3 Summary of 1-hour TSP Monitoring Results in this Reporting
Period
Station |
Average
(µg/m3) |
Range (µg/m3) |
Action
Level (µg/m3) |
Limit
Level (µg/m3) |
ASR1 |
120 |
13 - 262 |
331 |
500 |
ASR5 |
183 |
13 - 396 |
340 |
500 |
AQMS1 |
120 |
14 - 324 |
335 |
500 |
ASR6 |
124 |
13 - 322 |
338 |
500 |
ASR10 |
107 |
13 - 307 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in this Reporting
Period
Station |
Average
(µg/m3) |
Range (µg/m3) |
Action
Level (µg/m3) |
Limit
Level (µg/m3) |
ASR1 |
83 |
21 - 147 |
213 |
260 |
ASR5 |
108 |
23 - 197 |
238 |
260 |
AQMS1 |
72 |
16 – 154 |
213 |
260 |
ASR6 |
86 |
21 - 178 |
238 |
260 |
ASR10 |
65 |
22 - 135 |
214 |
260 |
The
weather condition during the monitoring period varied from sunny to
cloudy. The major dust sources in the reporting
period included construction activities under the Contract as well as nearby
traffic emissions.
A
total of 11 1-hour TSP and 24-hour TSP monitoring were undertaken in which six
(6) Action Level of 1-hour TSP were recorded in this reporting month.
Meteorological
information collected at the ASR5, including wind speed and wind direction, is
provided in Appendix H.
Seawall
Enhancement Works at Northern Landfall has been completed completed
on 31 December 2017. Notification of
suspension of water quality monitoring has been issued to EPD on 1 February
2018 and is in process.
Impact
dolphin monitoring is required to be conducted by a qualified dolphin
specialist team to evaluate whether there have been any effects on the
dolphins. In order to fulfil the
EM&A requirements and make good use of available resources, the on-going
impact line transect dolphin monitoring data collected by HyD’s
Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong Kong
Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing
Facilities on the monthly basis is adopted to avoid duplicates of survey
effort.
Table 2.5 summarises
the equipment used for the impact dolphin monitoring.
Table 2.5 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning System
(GPS) |
Garmin 18X-PC Geo One Phottix |
Camera |
Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens |
Laser Binocular |
Infinitor LRF 1000 |
Marine Binocular |
Bushell 7 x 50 marine binocular with compass and reticules |
Vessel for Monitoring |
65 foot single engine motor vessel with viewing platform 4.5m above
water level |
Dolphin
monitoring should cover all transect lines in Northeast Lantau (NEL) and the Northwest
Lantau (NWL) survey areas twice per month throughout the entire construction
period. The monitoring data should be
compatible with, and should be made available for, long-term studies of small
cetacean ecology in Hong Kong. In order
to provide a suitable long-term dataset for comparison, identical methodology
and line transects employed in baseline dolphin monitoring was followed in the
impact dolphin monitoring.
The
impact dolphin monitoring was carried out in the NEL and NWL along the line
transect as depicted in Figure 2.2. The co-ordinates of all transect lines are
shown in Table 2.6 below.
Table 2.6 Impact Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
815456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805476 |
820800* |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805476 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
821150* |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
821500* |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
821850* |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
822150* |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
822000* |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
821176 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
12 |
End
Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
The
Action and Limit levels of impact dolphin monitoring are shown in Appendix D. The
Event and Action plan is presented in Appendix J.
Dolphin
monitoring was carried out on 2, 8, 16 and 25 of January 2018. The dolphin monitoring schedule for the
reporting month is shown in Appendix F.
A
total of 265.94 km of survey effort was collected, with
84.2% of the total survey effort being conducted under favourable
weather conditions (i.e. Beaufort Sea State 3 or below with good visibility) in
January 2018. Among the two areas,
100.20 km and 165.74 km of survey effort were collected from NEL and NWL survey
areas, respectively. The total survey
effort conducted on primary and secondary lines were 195.15 km and 70.79 km
respectively. The survey efforts are
summarized in Appendix I.
Five
groups of 20 Chinese White Dolphins sightings were recorded during the two sets
of surveys in January 2018. All dolphin sightings
were made in NWL, while none was sighted in NEL. All dolphin sightings were made during
on-effort search and were made on primary lines. One of the dolphin groups were associated
with an operating purse-seiner.
No
dolphin sighting was made in the proximity of the TM-CLKL alignment. The
distribution of dolphin sightings during the reporting month is shown in Figure 2.3.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable
conditions (Beaufort 3 or below) in January 2018 with the results present in Tables 2.7 and 2.8.
Table 2.7 Individual Survey Event Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: January 2nd
/ 8th |
0.0 |
0.0 |
Set 2: January
16th / 25th |
0.0 |
0.0 |
|
NWL |
Set 1: January 2nd
/ 8th |
5.7 |
45.4 |
Set 2: January
16th / 25th |
3.4 |
3.4 |
Note: Dolphin Encounter Rates are deduced from the Two Sets of Surveys (Two
Surveys in Each Set) in January 2018 in Northeast (NEL) and
Northwest Lantau (NWL)
Table 2.8 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100
km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
||
Primary
Lines Only |
Both Primary and Secondary Lines |
Primary
Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
4.3 |
3.2 |
19.2 |
14.3 |
Note: Overall dolphin encounter
rates (sightings per 100 km of survey effort) from all four surveys are
conducted in January 2018 on primary lines only as well
as both primary lines and secondary lines in Northeast and Northwest Lantau.
Due to monthly variation in
dolphin occurrence within the survey area, it would be more appropriate to draw
conclusion on whether any unacceptable impacts on dolphins have been detected
in relation to the construction activities of this Project in the quarterly
EM&A reports, where comparison on distribution, group size and encounter
rates of dolphins between the quarterly impact monitoring period and baseline
monitoring period will be made.
There was no dredging, reclamation or marine
sheet piling works in open waters during this reporting period. Thus,
Passive Acoustic Monitoring (PAM) and the day-time monitoring of Dolphin Exclusion
Zone (DEZ) by dolphin observers were not in effect during the reporting period.
Site
inspections were carried out on a weekly basis to monitor the implementation of
proper environmental pollution control and mitigation measures under the
Contract. In the reporting month, five
(5) site inspections were carried out on 3, 10, 17, 24 and 31 January 2018.
Key
observations and recommendations during the site inspections in this reporting
period are summarized in Table 2.9.
Table 2.9 Specific Observations and Recommendations during the Weekly
Site Inspection in this Reporting Month
Inspection Date |
Observations |
Recommendations/ Remarks |
3 January
2018 |
Works
Area – Portion S-A Accumulated
waste in the skip should be removed. |
Works
Area – Portion S-A The
Contractor was reminded to remove the accumulated waste in the skip. |
10
January 2018 |
Works
Area –Portion S-A Drip
tray and proper chemical label should be provided for the chemical container. Trapped
water in the drip tray should be removed. Works
Area –Portion N-A Trapped
water should be pumped off to wastewater treatment facilities. The
slope of the surcharge should be covered entirely by tarpaulin sheets. |
Works
Area –Portion S-A The
Contractor was reminded to provide drip tray and proper chemical label for
the chemical container. The
Contractor was reminded to remove trapped water in the drip tray. Works
Area –Portion N-A The
Contractor was reminded to pump off the trapped water to wastewater treatment
facilities. The
Contractor was reminded to cover the slope of the surcharge by tarpaulin
sheets entirely. |
17 January
2018 |
Works
Area – TBM tunnel Drip
tray and proper chemical label should be provided for the chemical container. Works
Area - Portion S-C Trapped
water in the drip tray should be removed. Trapped
water in the drip tray should be removed. |
Works
Area – TBM tunnel The
Contractor was reminded to provide drip tray and proper chemical label for
the chemical container. Works
Area - Portion S-C The
Contractor was reminded to remove trapped water in the drip tray. The
Contractor was reminded to remove trapped water in the drip tray. |
24
January 2018 |
Works
Area – Portion N-C Chemical
container should be placed in proper storage area. Drip
tray and proper chemical label should be provided for the chemical container. Works
Area - Portion S-B Drip
tray should be provided for the chemical container. |
Works
Area – Portion N-C The
Contractor was reminded to place the chemical container in proper storage
area. The
Contractor was reminded to provide drip tray and proper chemical label for
the chemical container. Works
Area - Portion S-B The
Contractor was reminded to provide drip tray for the chemical container. |
31
January 2018 |
Works
Area – Portion N-C Accumulated
general refuse in the skip should be removed. Works
Area - Portion N-A Surcharge
stockpiles should be entirely covered with tarpaulin sheets. Works
Area - Portion S-B Cement
bags should be entirely covered with tarpaulin sheets. |
Works
Area – Portion N-C The
Contractor was reminded to remove the accumulated general refuse in the skip. Works
Area - Portion N-A The
Contractor was reminded to cover the surcharge stockpiles entirely with
tarpaulin sheets. Works
Area - Portion S-B The
Contractor was reminded to cover the cement bags entirely with tarpaulin
sheets. |
The
Contractor has rectified all of the observations as identified during
environmental site inspections in the reporting month.
The
Contractor had submitted application form for registration as chemical waste
producer under the Contract. Sufficient
numbers of receptacles were available for general refuse collection and
sorting.
Wastes
generated during this reporting period included mainly construction wastes
(inert and non-inert) and marine sediment.
Reference has been made to the waste flow table prepared by the
Contractor (Appendix L). The quantities of different types of wastes
are summarized in Table 2.10.
Table 2.10 Quantities of Different Waste Generated in the Reporting Month
Month/Year |
Inert Construction Waste (a)
(tonnes) |
Inert Construction Waste
Re-used (tonnes) |
Non-inert Construction Waste (b)
(tonnes) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
||
Category L |
Category M (Mp
& Mf) |
|||||||
January 2018 |
7,165 |
0 |
272 |
200 |
2800 |
0 |
11,357 |
|
Notes: |
|
|||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
|
|||||||
The
Contractor was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials
and wastes. The Contractor was also
reminded to properly maintain the site tidiness and dispose of the wastes accumulated
on site regularly and properly.
For
chemical waste containers, the Contractor was reminded to treat properly and
store temporarily in designated chemical waste storage area on site in
accordance with the Code of Practice on the Packaging, Labelling and Storage of
Chemical Wastes.
The
status of environmental licensing and permit is summarized in Table 2.11 below.
Table 2.11 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental
Permit |
EP-354/2009/D |
13
March 2015 |
Throughout
the Contract |
HyD |
Application for VEP on 3 March 2015 to supersede
EP-354/2009/C |
Construction
Dust Notification |
363510 |
19
August 2013 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Construction
Dust Notification |
403620 |
10 June 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Chemical
Waste Registration |
5213-422-D2516-02 |
18 January 2017 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Chemical
Waste Registration |
5213-951-D2591-01 |
25 May 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Construction
Waste Disposal Account |
7018108 |
28
August 2013 |
Throughout
the Contract |
DBJV |
Waste disposal in Contract No. HY/2012/08 |
Waste
Water Discharge License |
WT00017707-2013 |
18
November 2013 |
30
November 2018 |
DBJV |
For site WA18 |
Waste
Water Discharge License |
WT00019248-2014 |
5
June 2014 |
30
June 2019 |
DBJV |
For site Portion N6 and Reclamation Area E |
Waste
Water Discharge License |
WT00025944-2016 |
15 December 2016 |
31 December 2021 |
DBJV |
Southern Landfall |
Marine
Dumping Permit |
EP/MD/18-118 |
21 January 2018 |
20 February 2018 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Construction
Noise Permit |
GW-RW0538-17 |
16 October 2017 |
15 April 2018 |
DBJV |
For
Urmston Road in front of Pillar Point |
Construction
Noise Permit |
GW-RW0641-17 |
16 December 2017 |
6 December 2018 |
DBJV |
WA23
@ Tsing Yi |
Construction Noise Permit |
PP-RS0026-17 |
1 December 2017 |
29 March 2018 |
DBJV |
Southern Landfall (Percussive Piling) |
Construction Noise Permit |
GW-RS0878-17 |
11 October 2017 |
2 April 2018 |
DBJV |
Southern Landfall |
Notes: |
|||||
HyD
= Highways Department DBJV
= Dragages – Bouygues Joint Venture VEP
= Variation of Environmental Permit |
In
response to the site audit findings, the Contractors carried out all corrective
actions.
A summary
of the Implementation Schedule of Environmental Mitigation Measures (EMIS) is
presented in Appendix C. The
necessary mitigation measures relevant to this Contract were implemented
properly.
One
(1) Action Level exceedance of 1-hour TSP was recorded on 13 January 2017. Three (3) Action Level exceedances of 1-hour
TSP were recorded on 16 January 2018.
Two (2) Action Level exceedance of 1-hour TSP was recorded on 22 January
2018.
Cumulative
statistics are provided in Appendix K.
The
Environmental Complaint Handling Procedure is provided in Figure 2.4.
One (1) environmental complaint
case regarding air, noise and light pollution at River Trade Terminal was
referred by IEC on 30 January 2018. The
complaint investigation report is provided in Appendix K.
No
environmental summons was received in this reporting period.
Statistics
on complaints, notifications of summons and successful prosecutions are
summarized in Appendix K.
As
informed by the Contractor, the major works for the Project in February 2018
are summarized in Table 3.1.
Table
3.1 Construction Works to Be Undertaken in the Coming Month
Works to be undertaken |
Land-based
Works ·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Excavation of Sub-sea Tunnel – TBM tunnel; ·
Corbel Construction – TBM Tunnel; ·
Bulk Excavation – Portion S-A; ·
TBM Excavation – Portion S-A; ·
CSM treatment, Jet Grouting works and D-wall
Construction; and ·
Ground Freezing Works – Portion S-A Marine-based
Works ·
Seawall Modificaton Works
– Portion S-A |
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of February 2018 are mainly associated with dust,
marine ecology, water quality and waste management issues.
The
tentative schedule for environmental monitoring in February 2018 is
provided in Appendix F.
This
Fifty-first Monthly EM&A Report presents the findings
of the EM&A activities undertaken during the period from 1 to 31 January
2018, in accordance with the Updated EM&A Manual and the requirements of
EP-354/2009/D.
Air
quality (including 1-hour TSP and 24-hour TSP), water quality and dolphin
monitoring were carried out in this reporting month.
One
(1) Action Level of 1-hour TSP was recorded on 13 January 2017. Three (3) Action Level exceedances of 1-hour
TSP were recorded on 16 January 2018.
Two (2) Action Level exceedance of 1-hour TSP was recorded on 22 January
2018.
Five
groups of 20 Chinese White Dolphins sightings were recorded during the two sets
of surveys in January 2018. All dolphin
sightings were made in NWL, while none was sighted in NEL. All dolphin sightings were made during on-effort
search and were made on primary lines.
One of the dolphin groups were associated with an operating
purse-seiner.
Environmental
site inspection was carried out five (5) times in January 2018. Remedial actions recommended for the
deficiencies identified during the site audits were properly implemented by the
Contractor.
No
non-compliance event was recorded during the reporting period.
One
(1) environmental complaint case regarding air, noise and light pollution at
River Trade Terminal was referred by IEC on 30 January 2018. The complaint investigation report is
provided in Appendix K.
No
environmental summons was received in this reporting period.
The
ET will keep track on the construction works to confirm compliance of
environmental requirements and the proper implementation of all necessary

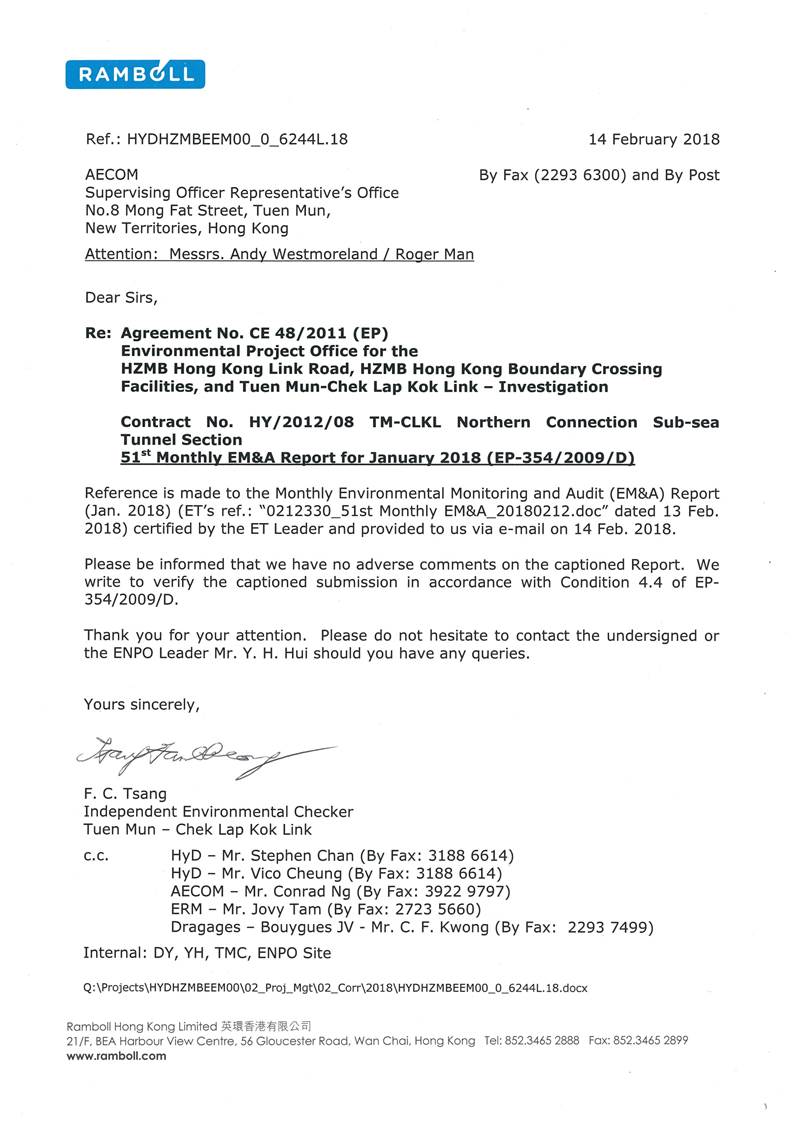

mitigation measures.
