table of Contents
Executive
Summary
1.1 Background
1.2 Scope
of Report
1.3 Organization
Structure
1.4 Summary
of Construction Works
2.1 Air
quality
2.2 Dolphin
Monitoring
2.3 EM&A
Site Inspection
2.4 Waste
Management Status
2.5 Environmental
Licenses and Permits
2.6 Implementation
Status of Environmental Mitigation Measures
2.7 Summary
of Exceedances of the Environmental Quality Performance Limit
2.8 Summary
of Complaints, Notification of Summons and Successful Prosecutions
3.1 Construction
Activities for the Coming Month
3.2 Key
Issues for the Coming Month
3.3 Monitoring
Schedule for the Coming Month
4 Conclusions and
recommendations
4.1 Conclusions
Under
Contract No. HY/2012/08, Dragages –
Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD)
to undertake the design and construction of the Northern Connection Sub-sea
Tunnel Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link
Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising
Officer. For implementation of the
environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong
Kong, Limited (ERM) has been appointed as the Environmental Team (ET) in
accordance with Environmental Permit No.
EP-354/2009/A. Ramboll Hong Kong Ltd. was employed by HyD as
them Independent Environmental Checker (IEC) and Environmental Project Office
(ENPO). Subsequent applications for
variation of environmental permits (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
The construction
phase of the Project commenced on 1 November 2013 and will tentatively be completed
by the end of 2018. The impact
monitoring of the EM&A programme, including air quality, water quality, marine
ecological monitoring and environmental site inspections, were commenced on 1
November 2013.
This is the Fifty-third
Monthly EM&A report presenting the EM&A works carried out during the
period from 1 to 31 March 2018 for the Contract
No. HY/2012/08 Northern
Connection Sub-sea Tunnel Section (the “Project”) in accordance
with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, major activities in the reporting period included:
Land-based Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Cross Passage Construction by Pipe Jacking – TBM
Tunnel;
·
Corbel & OVHD Construction – TBM Tunnel;
·
Parapet wall Installation – TBM Tunnel;
·
Bulk Excavation – Portion S-A;
·
CSM treatment, Jet Grouting works and D-wall
Construction; and
·
Ground Freezing Works – Portion S-A
There was no
dredging, reclamation or marine sheet piling works in open waters during this
reporting period.
A summary of
monitoring and audit activities conducted in the reporting period is listed
below:
24-hour TSP Monitoring 10 sessions
1-hour TSP Monitoring 10 sessions
Impact Dolphin Monitoring 2 sessions
Joint
Environmental Site Inspection 4 sessions
Implementation of Marine Mammal Exclusion Zone
There was no dredging, reclamation or marine sheet piling works in
open waters during this reporting period. Thus, Passive Acoustic
Monitoring (PAM) and the day-time monitoring of Dolphin Exclusion Zone (DEZ) by
dolphin observers were not in effect during the reporting period.
Summary of
Breaches of Action/Limit Levels
Breaches of Action and Limit Levels for Air Quality
One (1) Action
Level exceedance of 1-hour TSP was recorded on 2 March 2018. One (1) Action Level exceedance of 1-hour TSP
was recorded on 20 March 2018. Investigation
reports are provided in Appendix
K.
Breaches of Action and Limit Levels for Dolphin
Monitoring .
Due to monthly variation in dolphin
occurrence within the survey area, it would be more appropriate to draw
conclusion on whether any unacceptable impacts on dolphins have been detected
in relation to the construction activities of this Project in the quarterly
EM&A reports, where comparison on distribution, group size and encounter
rates of dolphins between the quarterly impact monitoring period and baseline
monitoring period will be made.
Summary of
Marine Travel Route record
No non-compliance with EIA
recommendations,
EP conditions and other requirements associated with the marine travel route
record of this Contract was recorded in March 2018.
Environmental
Complaints, Non-compliance & Summons
No non-compliance with EIA
recommendations,
EP conditions and other requirements associated with the construction of this Contract
was recorded in this reporting period.
No environmental complaint was received
in this reporting period.
No environmental
summons was received in this reporting period.
Reporting Change
There was no
reporting change required in the reporting period.
Upcoming Works
for the Next Reporting Month
Works to be
undertaken in the next monitoring period of April 2018 include the following:
Land-based Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Excavation of Sub-sea Tunnel – TBM tunnel;
·
Corbel Construction – TBM Tunnel;
·
Bulk Excavation – Portion S-A;
·
TBM Excavation – Portion S-A;
·
CSM treatment, Jet Grouting works and D-wall
Construction; and
·
Ground Freezing Works – Portion S-A
Marine-based
Works
·
Seawall Modificaton Works – Portion S-A
Future Key Issue
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of April 2018 are mainly associated with dust, marine
water quality, marine ecology and waste management issues.
According to the
findings of the Northwest New Territories (NWNT) Traffic and Infrastructure
Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau
Link and North Lantau Highway would be operating beyond capacity after 2016. This forecast has been based on the estimated
increase in cross boundary traffic, developments in the Northwest New
Territories (NWNT), and possible developments in North Lantau, including the
Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong –
Zhuhai – Macao Bridge (HZMB). In order
to cope with the anticipated traffic demand, two new road sections between NWNT
and North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western
Bypass (TMWB) are proposed.
An Environmental
Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in accordance
with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental Impact Assessment Process
(EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (VEP) (EP-354/2009/A) was issued on 8 December
2010. Subsequent applications for
variation of environmental permits (VEPs), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were
granted on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
Under
Contract No. HY/2012/08, Dragages –
Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD)
to undertake the design and construction of the Northern Connection Sub-sea
Tunnel Section of TM-CLKL while AECOM Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme under the Contract,
ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET). Ramboll Hong Kong Ltd. was
employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO).
Layout
of the Contract components is presented in Figure 1.1.
The organization
structure of the Contract is shown in Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways Department |
Engr 22/HZMB |
Chow Man Lung, Andrew |
2762 4110 |
2762 4110 |
SOR (AECOM Asia Company Limited) |
Chief Resident Engineer |
Roger Man Andrew Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
ENPO / IEC (Ramboll Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465
2850 |
3465 2899 |
IEC |
Dr. F.C. Tsang |
3465
2851 |
3465 2899 |
|
Contractor (Dragages – Bouygues
Joint Venture) |
Environmental Officer |
Bryan Lee |
2293 7323 |
2293 7499 |
|
24-hour complaint hotline |
Rachel Lam |
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Table 1.2 Summary of Construction Activities Undertaken during the
Reporting Period
Construction
Activities Undertaken |
Land-based
Works |
·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Cross Passage Construction by Pipe Jacking – TBM
Tunnel; ·
Corbel & OVHD Construction – TBM Tunnel; ·
Parapet wall Installation – TBM Tunnel; ·
Bulk Excavation – Portion S-A; ·
CSM treatment, Jet Grouting works and D-wall
Construction; and ·
Ground Freezing Works – Portion S-A |

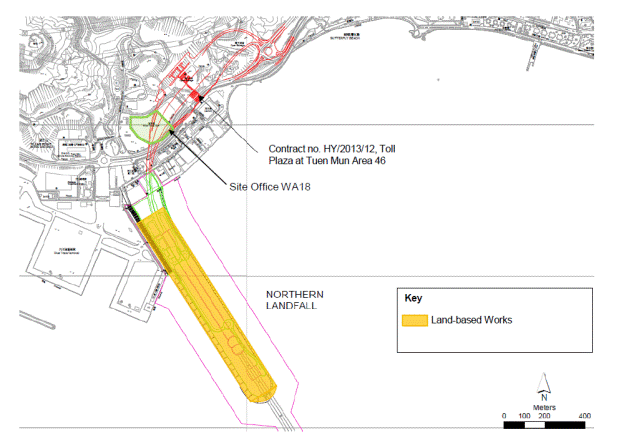

Figure 1.2 Locations of Construction Activities – March
2018
|
The EM&A
programme required environmental monitoring for air quality, water quality and
marine ecology as well as environmental site inspections for air quality, noise,
water quality, waste management, marine ecology and landscape and visual impacts.
The EM&A requirements and related
findings for each component are summarized in the following sections
In accordance
with the Updated EM&A Manual and the Enhanced TSP Monitoring Plan, impact
1-hour TSP monitoring was conducted three (3) times every six (6) days and impact
24-hour TSP monitoring was carried out once every six (6) days when the highest
dust impact was expected. 1-hr and 24-hr
TSP monitoring frequency was increased to three times per day every three days
and daily every three days, respectively, as excavation works for launching
shaft commenced on 24 October 2014.
High volume
samplers (HVSs) were used to carry out the 1-hour and 24-hour TSP monitoring on
2, 5, 8, 11, 14, 17, 20, 23, 26 and 29 March 2018 at the five (5) air quality
monitoring stations in accordance with the requirements stipulated in the
Updated EM&A Manual (Figure 2.1; Table 2.1).
Wind meter was installed at the rooftop
of ASR5 for logging wind speed and wind direction. Details of the equipment deployed are
provided in Table 2.2. Copies of the calibration certificates for the
equipment are presented in Appendix E.
Table
2.1 Locations of Impact Air Quality Monitoring Stations and
Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Dates |
Location |
Description |
Parameters
& Frequency |
ASR1 |
2, 5, 8, 11,
14, 17, 20, 23, 26 and 29 March 2018 |
Tuen Mun
Fireboat Station |
Office |
TSP monitoring
1-hour Total Suspended Particulates (1-hour
TSP, µg/m3), 3 times in every 6 days
24-hour Total Suspended Particulates
(24-hour TSP, µg/m3), daily for 24-hour in every 6 days Enhanced TSP monitoring
(commenced on 24 October 2014)
1-hour Total Suspended Particulates (1-hour
TSP, µg/m3), 3 times in every 3 days
24-hour Total Suspended Particulates
(24-hour TSP, µg/m3), daily for 24-hour in every 3 days |
ASR5 |
|
Pillar Point
Fire Station |
Office |
|
AQMS1 |
|
Previous River
Trade Golf |
Bare ground |
|
ASR6 |
|
Butterfly
Beach Laundry |
Office |
|
ASR10 |
|
Butterfly
Beach Park |
Recreational
uses |
Table 2.2 Air Quality
Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total
Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model: Vantage Pro 2 (S/N: AS160104014) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The Action and
Limit Levels of the air quality monitoring is provided in Appendix D. The Event and Action plan is presented in Appendix J.
The schedule for
air quality monitoring in March 2018 is provided in Appendix F.
The monitoring
results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4,
respectively. Detailed impact air
quality monitoring results and graphical presentations are presented in Appendix G.
Table 2.3 Summary of 1-hour TSP Monitoring Results in this Reporting
Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level
(µg/m3) |
Limit Level
(µg/m3) |
ASR1 |
155 |
63 – 460 |
331 |
500 |
ASR5 |
171 |
81 - 289 |
340 |
500 |
AQMS1 |
98 |
22 - 172 |
335 |
500 |
ASR6 |
111 |
33 - 295 |
338 |
500 |
ASR10 |
70 |
28 - 190 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in this Reporting
Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level
(µg/m3) |
Limit Level
(µg/m3) |
ASR1 |
106 |
83 - 153 |
213 |
260 |
ASR5 |
109 |
65 - 142 |
238 |
260 |
AQMS1 |
70 |
49 - 93 |
213 |
260 |
ASR6 |
80 |
56 - 120 |
238 |
260 |
ASR10 |
58 |
39 - 100 |
214 |
260 |
The weather
condition during the monitoring period varied from sunny to cloudy. The major dust sources in the reporting
period included construction activities under the Contract as well as nearby
traffic emissions.
A total of 10 1-hour
TSP and 24-hour TSP monitoring were undertaken in which two (2) Action Level exceedances
of 1-hour TSP were recorded in this reporting month.
Meteorological
information collected at the ASR5, including wind speed and wind direction, is provided
in Appendix H.
Seawall
Enhancement Works at Northern Landfall has been completed on 31 December
2017. Notification of suspension of
water quality monitoring has been approved by EPD on 2 March 2018. Water Quality Monitoring will resume after
the commencement of Seawall Modification Works at Southern Landfall in April
2018 tentatively.
Impact dolphin
monitoring is required to be conducted by a qualified dolphin specialist team
to evaluate whether there have been any effects on the dolphins. In order to fulfil the EM&A requirements
and make good use of available resources, the on-going impact line transect
dolphin monitoring data collected by HyD’s Contract
No. HY/2011/03 Hong Kong-Zhuhai-Macao
Bridge. Hong Kong Link Road - Section between Scenic Hill and Hong Kong
Boundary Crossing Facilities on the monthly basis is adopted to avoid
duplicates of survey effort.
Table 2.5 summarises the equipment used for the impact dolphin
monitoring.
Table 2.5 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) |
Garmin 18X-PC Geo One Phottix |
Camera |
Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens |
Laser
Binocular |
Infinitor LRF 1000 |
Marine
Binocular |
Bushell 7 x 50 marine binocular with compass and reticules |
Vessel
for Monitoring |
65 foot single
engine motor vessel with viewing platform 4.5m above water level |
Dolphin
monitoring should cover all transect lines in Northeast Lantau (NEL) and the
Northwest Lantau (NWL) survey areas twice per month throughout the entire
construction period. The monitoring data
should be compatible with, and should be made available for, long-term studies
of small cetacean ecology in Hong Kong. In
order to provide a suitable long-term dataset for comparison, identical
methodology and line transects employed in baseline dolphin monitoring was
followed in the impact dolphin monitoring.
The impact
dolphin monitoring was carried out in the NEL and NWL along the line transect
as depicted in Figure 2.2. The co-ordinates of all transect lines are
shown in Table 2.6 below.
Table 2.6 Impact Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
815456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805476 |
820800* |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805476 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
821150* |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
821500* |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
821850* |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
822150* |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
822000* |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
821176 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
12 |
End
Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
The Action and Limit
levels of impact dolphin monitoring are shown in Appendix D. The Event and Action plan is presented in Appendix J.
Dolphin
monitoring was carried out on 8, 12, 20 and 23 of March 2018. The dolphin monitoring schedule for the
reporting month is shown in Appendix F.
Six groups of 26
Chinese White Dolphins sightings were recorded during the two sets of surveys
in March 2018. All dolphin sightings were
made in NWL, while none was sighted in NEL. All dolphin sightings were made during
on-effort search and all were made on primary lines. None of the dolphin groups were associated with
any operating fishing vessel.
No
dolphin sighting was made in the proximity of the TM-CLKL alignment. The distribution
of dolphin sightings during the reporting month is shown in Figure 2.3.
Encounter rates
of Chinese White Dolphins are deduced from the survey effort and on-effort
sighting data made under favourable conditions (Beaufort 3 or below) in March 2018
with the results present in Tables 2.7 and 2.8.
Table 2.7 Individual Survey Event Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: March 8th /
12th |
0.0 |
0.0 |
Set 2: March 20th
/ 23rd |
0.0 |
0.0 |
|
NWL |
Set 1: March 8th /
12th |
1.7 |
5.2 |
Set 2: March 20th
/ 23rd |
12.3 |
56.7 |
Note: Dolphin Encounter Rates are deduced from the Two Sets of Surveys (Two
Surveys in Each Set) in March 2018 in Northeast (NEL) and Northwest Lantau
(NWL)
Table 2.8 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100
km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
||
Primary
Lines Only |
Both Primary and Secondary Lines |
Primary
Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
6.1 |
4.6 |
26.4 |
19.8 |
Note: Overall dolphin encounter
rates (sightings per 100 km of survey effort) from all four surveys are
conducted in March 2018 on primary lines only as well as both primary
lines and secondary lines in Northeast and Northwest Lantau.
Due to monthly variation in dolphin
occurrence within the survey area, it would be more appropriate to draw
conclusion on whether any unacceptable impacts on dolphins have been detected
in relation to the construction activities of this Project in the quarterly
EM&A reports, where comparison on distribution, group size and encounter
rates of dolphins between the quarterly impact monitoring period and baseline
monitoring period will be made.
There was no dredging, reclamation or marine sheet piling works in
open waters during this reporting period. Thus, Passive Acoustic
Monitoring (PAM) and the day-time monitoring of Dolphin Exclusion Zone (DEZ) by
dolphin observers were not in effect during the reporting period.
Site inspections
were carried out on a weekly basis to monitor the implementation of proper
environmental pollution control and mitigation measures under the Contract. In the reporting month, four (4) site
inspections were carried out on 7, 14, 21 and 28 March 2018.
Key observations
and recommendations during the site inspections in this reporting period are
summarized in Table 2.9.
Table 2.9 Specific Observations and Recommendations during the Weekly
Site Inspection in this Reporting Month
Inspection
Date |
Observations |
Recommendations/
Remarks |
7 March 2018 |
Works Area – Portion
N-C Accumulated
waste in the waste container should be removed. Drip tray should
be provided for the oil drum. Cement bags should
be covered with tarpaulin sheeting. Works Area – Portion
S-A U-channel
should be installed for collection of rainwater. Reminder from
SOR Works Area – Portion
S-A The tip of
excavator should be mounted with noise absorbent. |
Works Area – Portion
N-C The Contractor
was reminded to remove the accumulated waste in the waste container. The Contractor
was reminded to provide drip tray for the oil drum. The Contractor
was reminded to cover the cement bags with tarpaulin sheeting. Works Area – Portion
S-A The Contractor
was reminded to install U-channel for collection of rainwater. Reminder from
SOR Works Area – Portion
S-A The Contractor
was reminded to mount the tip of excavator with noise absorbent. |
14 March 2018 |
Works Area – TBM
tunnel Drip tray
should be provided for the chemical containers. Cement bags
should be covered with tarpaulin sheeting. Works Area –Portion
S-B Cement bags
should be covered with tarpaulin sheeting. Drip tray
should be provided for the chemical containers. Drip tray
should be provided for the chemical containers. |
Works Area – TBM
tunnel The Contractor
was reminded to provide drip tray for the chemical containers. The Contractor
was reminded to cover the cement bags with tarpaulin sheeting. Works Area –Portion
S-B The Contractor
was reminded to cover the cement bags with tarpaulin sheeting. The Contractor
was reminded to provide drip tray for the chemical containers. The Contractor
was reminded to provide drip tray for the chemical containers. |
21 March 2018 |
Works Area – Portion
N-C Drip tray
should be provided for the chemical containers. Cement bags
should be covered with tarpaulin sheeting. Works Area - Portion
N-A Drip tray
should be provided for the chemical containers. Works Area -
Portion S-A The top and 3
sides of the grout mixer should be enclosed with impervious sheeting. Drip tray
should be provided for the oil drums. |
Works Area – Portion
N-C The Contractor
was reminded to provide drip tray for the chemical containers. The Contractor
was reminded to cover the cement bags with tarpaulin sheeting. Works Area - Portion
N-A The Contractor
was reminded to provide drip tray for the chemical containers. Works Area -
Portion S-A The Contractor
was reminded to enclose the top and 3 sides of the grout mixer with
impervious sheeting. The Contractor
was reminded to provide drip tray for the oil drums. |
28 March 2018 |
Works Area -
Portion N-C Drip tray
should be provided for the chemical containers. Works Area -
Portion N-A Dusty material
should be covered with tarpaulin sheets. Proper NRMM
label should be displayed. Works Area -
Portion S-C The cement
bags should be covered with impervious sheeting. Works Area -
Portion S-B Drip tray
should be provided for the chemical containers. Drip tray
should be provided for the chemical containers. The chemical
should be stored properly.. |
Works Area -
Portion N-C The Contractor
was reminded to provide drip tray for the chemical containers. Works Area -
Portion N-A The Contractor
was reminded to cover the dusty mateiral with tarpaulin sheetings. The Contractor
was reminded to display proper NRMM label. Works Area -
Portion S-C The Contractor
was reminded to cover the cement bags with impervious sheeting. Works Area -
Portion S-B The Contractor
was reminded to provide drip tray for the chemical containers. The Contractor
was reminded to provide drip tray for the chemical containers. The Contractor
was reminded to store the chemical properly. |
The Contractor
has rectified all of the observations as identified during environmental site
inspections in the reporting month.
The Contractor
had submitted application form for registration as chemical waste producer under
the Contract. Sufficient numbers of
receptacles were available for general refuse collection and sorting.
Wastes generated
during this reporting period included mainly construction wastes (inert and
non-inert), chemical wastes and marine sediment. Reference has been made to the waste flow
table prepared by the Contractor (Appendix L). The quantities of different types of wastes
are summarized in Table 2.10.
Table 2.10 Quantities of Different Waste Generated in the Reporting Month
Month/Year |
Inert Construction Waste (a) (tonnes) |
Inert Construction Waste Re-used (tonnes) |
Non-inert Construction Waste (b) (tonnes) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
||
Category L |
Category M (Mp & Mf) |
|||||||
March 2018 |
66,457 |
62,247 |
459 |
229,360 |
2,000 |
0 |
6,195 |
|
Notes: |
|
|||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
|
|||||||
The Contractor was
advised to properly maintain on site C&D materials and waste collection,
sorting and recording system, dispose of C&D materials and wastes at
designated ground and maximize reuse/ recycle of C&D materials and
wastes. The Contractor was also reminded
to properly maintain the site tidiness and dispose of the wastes accumulated on
site regularly and properly.
For chemical
waste containers, the Contractor was reminded to treat properly and store
temporarily in designated chemical waste storage area on site in accordance
with the Code of Practice on the Packaging, Labelling and Storage of Chemical
Wastes.
The status of
environmental licensing and permit is summarized in Table 2.11 below.
Table 2.11 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/
Permit Holder |
Remarks |
Environmental
Permit |
EP-354/2009/D |
13
March 2015 |
Throughout
the Contract |
HyD |
Application
for VEP on 3 March 2015 to supersede EP-354/2009/C |
Construction
Dust Notification |
363510 |
19
August 2013 |
Throughout
the Contract |
DBJV |
Northern
Landfall |
Construction
Dust Notification |
403620 |
10
June 2016 |
Throughout
the Contract |
DBJV |
Southern
Landfall |
Chemical
Waste Registration |
5213-422-D2516-02 |
18
January 2017 |
Throughout
the Contract |
DBJV |
Northern
Landfall |
Chemical
Waste Registration |
5213-951-D2591-01 |
25
May 2016 |
Throughout
the Contract |
DBJV |
Southern
Landfall |
Construction
Waste Disposal Account |
7018108 |
28
August 2013 |
Throughout
the Contract |
DBJV |
Waste
disposal in Contract No. HY/2012/08 |
Waste
Water Discharge License |
WT00017707-2013 |
18
November 2013 |
30
November 2018 |
DBJV |
For
site WA18 |
Waste
Water Discharge License |
WT00019248-2014 |
5
June 2014 |
30
June 2019 |
DBJV |
For
site Portion N6 and Reclamation Area E |
Waste
Water Discharge License |
WT00025944-2016 |
15
December 2016 |
31
December 2021 |
DBJV |
Southern
Landfall |
Marine
Dumping Permit |
EP/MD/18-125 |
21
February 2018 |
20
March 2018 |
DBJV |
Type
1 (Dedicated site) and Type 2 (Confined Marine Disposal) |
Marine
Dumping Permit |
EP/MD/18-133 |
22
March 2018 |
21
April 2018 |
DBJV |
Type
1 (Dedicated site) and Type 2 (Confined Marine Disposal) |
Construction
Noise Permit |
GW-RW0538-17 |
16
October 2017 |
15
April 2018 |
DBJV |
For
Urmston Road in front of Pillar Point |
Construction
Noise Permit |
GW-RW0641-17 |
16
December 2017 |
6
December 2018 |
DBJV |
WA23
@ Tsing Yi |
Construction
Noise Permit |
PP-RS0026-17 |
1
December 2017 |
29
March 2018 |
DBJV |
Southern
Landfall (Percussive Piling) |
Construction
Noise Permit |
GW-RS0878-17 |
11
October 2017 |
2
April 2018 |
DBJV |
Southern
Landfall |
Construction
Noise Permit |
GW-RW0060-18 |
20
February 2018 |
19
August 2018 |
DBJV |
WA23
@ Tsing Yi |
Construction
Noise Permit |
GW-RS0027-18 |
22
January 2018 |
14
July 2018 |
DBJV |
Southern
Landfall |
Notes: |
|||||
HyD
= Highways Department DBJV
= Dragages – Bouygues Joint Venture VEP
= Variation of Environmental Permit |
In response to
the site audit findings, the Contractors carried out all corrective actions.
A summary of the
Implementation Schedule of Environmental Mitigation Measures (EMIS) is
presented in Appendix C. The
necessary mitigation measures relevant to this Contract were implemented
properly.
One (1) Action
Level exceedance of 1-hour TSP was recorded on 2 March 2018. One (1) Action Level exceedance of 1-hour TSP
was recorded on 20 March 2018. Investigation
reports are provided in Appendix
K.
Cumulative
statistics are provided in Appendix K.
The
Environmental Complaint Handling Procedure is provided in Figure 2.4.
No environmental complaint was received
in this reporting period.
No environmental
summons was received in this reporting period.
Statistics on
complaints, notifications of summons and successful prosecutions are summarized
in Appendix K.
As informed by
the Contractor, the major works for the Project in April 2018 are summarized in
Table 3.1.
Table
3.1 Construction Works to Be Undertaken in the Coming Month
Works
to be undertaken |
Land-based
Works ·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Excavation of Sub-sea Tunnel – TBM tunnel; ·
Corbel Construction – TBM Tunnel; ·
Bulk Excavation – Portion S-A; ·
TBM Excavation – Portion S-A; ·
CSM treatment, Jet Grouting works and D-wall
Construction; and ·
Ground Freezing Works – Portion S-A Marine-based
Works ·
Seawall Modificaton Works – Portion S-A |
Potential
environmental impacts arising from the above upcoming construction activities in
the next reporting month of April 2018 are mainly associated with dust, marine
ecology, water quality and waste management issues.
The tentative
schedule for environmental monitoring in April 2018 is provided in Appendix F.
This Fifty-third Monthly EM&A Report presents the findings of the EM&A
activities undertaken during the period from 1 to 31 March 2018, in accordance
with the Updated EM&A Manual and the requirements of EP-354/2009/D.
Air quality
(including 1-hour TSP and 24-hour TSP) and dolphin monitoring were carried out
in this reporting month.
One (1) Action
Level exceedance of 1-hour TSP was recorded on 2 March 2018. One (1) Action Level exceedance of 1-hour TSP
was recorded on 20 March 2018. Investigation
reports are provided in Appendix
K.
Six groups of 26
Chinese White Dolphins sightings were recorded during the two sets of surveys
in March 2018. All dolphin sightings were
made in NWL, while none was sighted in NEL.
All dolphin sightings were made during on-effort search and all were
made on primary lines. None of the
dolphin groups were associated with any operating fishing vessel.
Environmental
site inspection was carried out four (4) times in March 2018. Remedial actions recommended for the
deficiencies identified during the site audits were properly implemented by the
Contractor.
No
non-compliance event was recorded during the reporting period.
No environmental complaint was received
in this reporting period.
No environmental
summons was received in this reporting period.
The ET will keep
track on the construction works to confirm compliance of environmental
requirements and the proper implementation of all necessary mitigation
measures.
