Under Contract No. HY/2012/08,
Dragages – Bouygues Joint Venture (DBJV) is
commissioned by the Highways Department (HyD) to
undertake the design and construction of the Northern Connection Sub-sea Tunnel
Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK
Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation of the environmental monitoring
and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET) in accordance with Environmental Permit No.
EP-354/2009/A. Ramboll Hong Kong Ltd. was employed by HyD as
the Independent Environmental Checker (IEC) and Environmental Project Office
(ENPO). Subsequent
applications for variation of environmental permits (VEP), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were granted
on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
The construction phase of the Contract commenced on 1
November 2013 and will tentatively be completed in 2021.
The impact monitoring of the EM&A programme,
including air quality, water quality, marine ecological monitoring and
environmental site inspections, were commenced on 1
November 2013.
This is the Eighty-sixth Monthly EM&A report
presenting the EM&A works carried out during the period from 1 to 31 December 2020 for the Contract No.
HY/2012/08 Northern Connection Sub-sea Tunnel Section
(the “Contract”) in
accordance with the Updated EM&A Manual of the TM-CLK Link Contract. As informed by the
Contractor, major activities in the reporting period included:
Land-based Works
·
Installation of green
roof system & chain fence - South Ventiliation
Building;
·
Defect works for
reinstatement at Box culvert – Northern Landfall; and
·
Demolition of CLP
substation
A summary of monitoring and audit activities conducted in
the reporting period is listed below:
24-hour TSP
Monitoring
5 sessions
1-hour TSP
Monitoring
5 sessions
Operational Phase Water Quality Monitoring 1 session
Operational Phase Dolphin
Monitoring 2
sessions
Joint Environmental Site Inspection
4 sessions
Implementation of Marine Mammal Exclusion Zone
No marine works were undertaken
during the reporting period, therefore, daily 250 m
marine mammal exclusion zone monitoring was not undertaken during the reporting
period.
Summary of Breaches of Action/Limit Levels
Breaches of Action and Limit Levels for Air Quality
One (1) Action Level exceedances of 1-hour TSP was
recorded in the air quality monitoring during this reporting month. No
Action Level exceendace of 24-hour TSP was recorded.
Environmental Complaints, Non-compliance & Summons
No
non-compliance with EIA recommendations, EP conditions and other
requirements associated with the construction of this Contract was recorded in
this reporting period.
No environmental complaint was received in this reporting period.
No environmental summons was received
in this reporting period.
Reporting Change
There was no
reporting change in the reporting period.
Upcoming Works for the Next Reporting Month
Works to be undertaken in the
next monitoring period of January 2021 include the following:
Land-based Works
·
Demolition of CLP
substation
Future Key Issue
Potential environmental impacts
arising from the above upcoming construction activities in the next reporting
month of January 2021 are mainly associated with dust and waste
management issues.
According to the findings of the
Northwest New Territories (NWNT) Traffic and Infrastructure Review conducted by
the Transport Department, Tuen Mun
Road, Ting Kau Bridge, Lantau Link and North Lantau
Highway would be operating beyond capacity after 2016. This forecast has been based on the estimated increase in cross boundary
traffic, developments in the Northwest New Territories (NWNT), and possible
developments in North Lantau, including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In
order to cope with the anticipated traffic demand, two new road sections
between NWNT and North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.
An Environmental Impact Assessment
(EIA) of TM-CLKL (the Project) was prepared in accordance with the EIA Study
Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental
Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the Environmental Impact Assessment
Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA
Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of
Environmental Protection (DEP) on 4 November 2009, and EP variation
(VEP) (EP-354/2009/A) was issued on 8 December 2010. Subsequent
applications for variation of environmental permits (VEPs), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were granted
on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
Under
Contract No. HY/2012/08, Dragages – Bouygues
Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Northern Connection Sub-sea Tunnel Section of TM-CLKL while AECOM Asia Company Limited was
appointed by HyD as the Supervising Officer.
For implementation of the environmental monitoring and audit
(EM&A) programme under the Contract, ERM-Hong
Kong, Limited (ERM) has been appointed as the Environmental Team (ET).
Ramboll Hong Kong Ltd.
was employed by HyD as the Independent Environmental
Checker (IEC) and Environmental Project Office (ENPO).
Layout
of the Contract components is presented in Figure 1.1.
The organization structure of the
Contract is shown in Appendix A. The
key personnel contact names and contact details are
summarized in Table 1.1 below.
Table
1.1 Contact Information of Key
Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways Department |
Engr 24/SD |
Ken T.M. Cheng |
2762 4062 |
3188 6614 |
SOR (AECOM Asia Company Limited) |
Chief Resident Engineer |
Roger Man |
2293 6388 |
2293 6300 |
ENPO / IEC (Ramboll Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465 2850 |
3465 2899 |
IEC |
Manson Yeung |
9700 6767 |
3465 2899 |
|
|
|
|
|
|
Contractor (Dragages
– Bouygues Joint Venture) |
Deputy Environmental Manager |
Bryan Lee |
2293 7323 |
2293 7499 |
|
24-hour hotline |
|
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jasmine Ng |
2271 3311 |
2723 5660 |
|
|
|
|
|
|
Table 1.2 Summary of
Construction Activities Undertaken during the Reporting Period
Construction Activities Undertaken |
Land-based Works |
· Installation of green roof system
& chain fence - South Ventiliation Building; · Defect works for reinstatement at
Box culvert – Northern Landfall; and · Demolition of CLP substation |
Figure

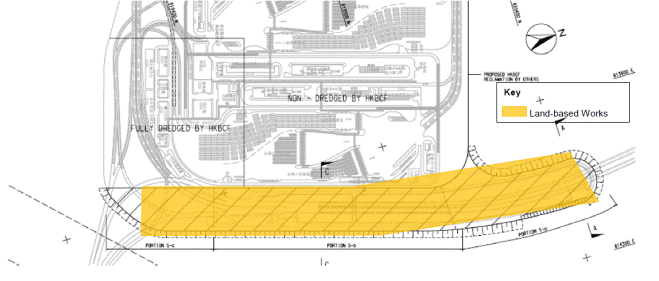

1.2 Locations of Construction Activities – December 2020
|
The EM&A programme
required environmental monitoring for air quality, water quality and marine
ecology as well as environmental site inspections for air quality, noise, water
quality, waste management, marine ecology and landscape and visual impacts.
The EM&A requirements and related findings for each component are summarized in the following sections
In accordance with the Updated
EM&A Manual and the Enhanced TSP Monitoring Plan, impact 1-hour TSP
monitoring was conducted three (3) times every six (6) days and impact 24-hour
TSP monitoring was carried out once every six (6) days when the highest dust
impact was expected. 1-hr and 24-hr TSP monitoring frequency was increased to three times per day every three days and
daily every three days, respectively, as excavation works for launching shaft
commenced on 24 October 2014.
Excavation works for lauching shaft were completed and notification of change on
air quality monitoring frequency was submitted to EPD
on 14 September 2020. 1-hr and 24-hr TSP monitoring frequency was changed to three times per day every six days and daily
every six days, respectively, since 14 September 2020.
High volume samplers (HVSs) were used to carry out the 1-hour and
24-hour TSP monitoring on 4, 10, 16, 22 and 28 December 2020 at the five
(5) air quality monitoring stations in accordance with the requirements
stipulated in the Updated EM&A Manual (Figure 2.1; Table 2.1). Wind meter was installed
at the rooftop of ASR5 for logging wind speed and wind direction. Details
of the equipment deployed are provided in Table 2.2.
Copies of the calibration certificates for the equipment are presented in Appendix E.
Table
2.1 Locations of Impact Air
Quality Monitoring Stations and Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Dates |
Location |
Description |
Parameters & Frequency |
ASR1 |
4, 10, 16, 22 and 28 December 2020 |
Tuen Mun
Fireboat Station |
Office |
TSP monitoring 1-hour Total Suspended
Particulates (1-hour TSP, µg/m3), 3 times in every 6 days 24-hour Total Suspended
Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 6
days Enhanced TSP monitoring (commenced on 24 October 2014) 1-hour Total Suspended
Particulates (1-hour TSP, µg/m3), 3 times in every 3 days 24-hour Total Suspended
Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 3
days |
ASR5 |
|
Pillar Point Fire Station |
Office |
|
AQMS1 |
|
Previous River Trade Golf |
Bare ground |
|
ASR6 |
|
Butterfly Beach Laundry |
Office |
|
ASR10 |
|
Butterfly Beach Park |
Recreational uses |
Table 2.2 Air Quality
Monitoring Equipment
Equipment |
Brand
and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total
Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model:
Vantage Pro 2 (S/N: AS160104014) |
Wind Anemometer for
calibration |
Lutron (Model No.
AM-4201) |
The Action and Limit Levels of the air
quality monitoring is provided in Appendix D. The
Event and Action plan is presented in Appendix K.
The schedule for air quality
monitoring in December 2020 is provided in Appendix F.
The monitoring results for 1-hour TSP
and 24-hour TSP are summarized in Tables 2.3
and 2.4, respectively. Detailed impact air quality monitoring
results and graphical presentations are presented in Appendix G.
Table
2.3 Summary of 1-hour TSP
Monitoring Results in this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
139 |
79 - 233 |
331 |
500 |
ASR5 |
193 |
94 - 348 |
340 |
500 |
AQMS1 |
109 |
48 - 140 |
335 |
500 |
ASR6 |
146 |
81 - 229 |
338 |
500 |
ASR10 |
97 |
39 - 200 |
337 |
500 |
Table 2.4 Summary of
24-hour TSP Monitoring Results in this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
112 |
93 - 147 |
213 |
260 |
ASR5 |
114 |
80 - 166 |
238 |
260 |
AQMS1 |
83 |
53 - 102 |
213 |
260 |
ASR6 |
113 |
97 - 130 |
238 |
260 |
ASR10 |
78 |
63 - 94 |
214 |
260 |
The weather condition during the
monitoring period varied from sunny to hazy. The major dust sources in
the reporting period included construction activities under the Contract as
well as nearby traffic emissions and renovation works undertaken by other
contract.
A total of 5 1-hour TSP and 24-hour TSP monitoring
were undertaken in this reporting month. One (1) Action
Level exceedances of 1-hour TSP was recorded in
the air quality monitoring during this reporting month.
Meteorological information collected
at the ASR5, including wind speed and wind direction, is provided in Appendix H.
According
to the Updated EM&A Manual, a
operational phase water quality monitoring shall be performed monthly during
the first year of Project operation at all designated monitoring stations
including control stations. The operation phase water quality monitoring shall be ceased after the first year of operation of the
Project subject to the first year review. Operational phase water quality monitoring commenced in June
2020. Locations of water quality monitoring stations presented in Figure 2.2 and
in Table 2.5.
Table
2.5 Locations of Operational
Phase Water Quality Monitoring Stations and the Corresponding Monitoring
Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Depth |
Frequency |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)11 |
Impact Station (Close to HKBCF construction site) |
813562 |
820716 |
Temperature(°C) pH(pH unit) Turbidity (NTU) Water depth (m) Salinity (ppt) DO (mg/L and % of saturation) · SS
(mg/L) |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed. If
the water depth is less than 3m, mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted. |
Monthly at each station, at
mid-flood and mid-ebb tides during the construction period of the Contract. |
SR4(N2) |
Sensitive receiver (Tai Ho Inlet) |
814688 |
817996 |
|||
CS2(A) |
Control
Station |
805232 |
818606 |
|||
CS(Mf)5 |
Control Station |
817990 |
821129 |
|
|
|
*Notes: In addition to the parameters presented monitoring
location/position, time, water depth, sampling depth, tidal stages, weather conditions
and any special phenomena or works underway nearby were
also recorded. With reference to the EM&A Report under Contract
No. HY/2011/03, water quality monitoring station SR3 was relocated to SR3(N) since 1 September 2017. With reference to the EM&A Report under Contract
No. HY/2011/03, water quality monitoring station SR4 was relocated to SR4(N) since 1 January 2018. With reference to the EM&A Report under Contract
No. HY/2011/03, water quality monitoring station SR4(N)
was relocated to SR4(N2) since 21 August 2019. With reference to the EM&A Report under Contract
No. HY/2011/03, water quality monitoring station CS2 was relocated to CS2(A) since 23 August 2017. |
Table 2.6 summarizes the equipment used in the operational
phase water quality monitoring programme.
Copies of the calibration certificates are attached in
Appendix E.
Table
2.6 Water Quality Monitoring Equipment
Equipment |
Model |
Multi-Parameters |
YSI ProDss 17H105557; YSI
6920 V2 0001C6A7 |
Positioning
Equipment |
Furuno GP-170 |
Water Depth Detector |
Lowrance Mark 5x / Garmin Striker
4 |
The schedule for operational phase water
quality monitoring in December
2020 is provided in Appendix F.
One
monitoring event for operational phase water quality monitoring was conducted
at all designated monitoring stations in the reporting month.
Operational phase water quality monitoring results are provided in Appendix
J.
Operational Phase dolphin monitoring is required to be conducted by a qualified dolphin
specialist team to evaluate whether there have been any effects on the
dolphins. In order to fulfil the EM&A requirements and make good use
of available resources, Contract No. HY/2012/08 has taken over the
responsibility for implementation of dolphin monitoring from HZMB HKLR Contract
No. HY/2011/03 since October 2019.
Table 2.7 summarises the equipment used for the
operational phase dolphin monitoring.
Table 2.7 Dolphin
Monitoring Equipment
Equipment |
Model |
Global
Positioning System (GPS) |
Garmin 18X-PC Geo
One Phottix |
Camera |
Nikon
D90 300m 2.8D fixed focus Nikon
D90 20-300m zoom lens |
Laser Binocular |
Infinitor LRF 1000 |
Marine Binocular |
Bushell 7 x 50 marine binocular
with compass and reticules |
Vessel for Monitoring |
65 foot single engine motor vessel with viewing
platform 4.5m above water level |
Dolphin monitoring should cover all
transect lines in Northeast Lantau (NEL) and the Northwest Lantau (NWL) survey
areas twice per month throughout the entire construction period and operational
phase. The monitoring data should be compatible with, and should be made available for, long-term studies of small
cetacean ecology in Hong Kong. In order to provide a suitable long-term
dataset for comparison, identical methodology and line transects
employed in baseline dolphin monitoring was followed in the impact dolphin
monitoring and operational phase dolphin monitoring.
The operational phase dolphin
monitoring was carried out in the NEL and NWL along
the line transect as depicted in Figure 2.3.
The co-ordinates of all transect lines are shown in Table 2.8 below.
Table
2.8 Operational Phase Dolphin
Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
|||
1 |
Start Point |
804671 |
815456 |
13 |
Start Point |
816506 |
819480 |
|
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
|
2 |
Start Point |
805476 |
820800* |
14 |
Start Point |
817537 |
820220 |
|
2 |
End Point |
805476 |
826654 |
14 |
End Point |
817537 |
824613 |
|
3 |
Start Point |
806464 |
821150* |
15 |
Start Point |
818568 |
820735 |
|
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
|
4 |
Start Point |
807518 |
821500* |
16 |
Start Point |
819532 |
821420 |
|
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
|
5 |
Start Point |
808504 |
821850* |
17 |
Start Point |
820451 |
822125 |
|
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
|
6 |
Start Point |
809490 |
822150* |
18 |
Start Point |
821504 |
822371 |
|
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
|
7 |
Start Point |
810499 |
822000* |
19 |
Start Point |
822513 |
823268 |
|
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
|
8 |
Start Point |
811508 |
821123 |
20 |
Start Point |
823477 |
823402 |
|
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
|
9 |
Start Point |
812516 |
821303 |
21 |
Start Point |
805476 |
827081 |
|
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
|
10 |
Start Point |
813525 |
821176 |
22 |
Start Point |
806464 |
824033 |
|
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
|
11 |
Start Point |
814556 |
818853 |
23 |
Start Point |
814559 |
821739 |
|
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
|
12 |
Start Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
|
12 |
End Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
|
Dolphin monitoring was
carried out on 1, 3, 8, and 10 December 2020. The dolphin monitoring schedule for the reporting month is shown
in Appendix F.
A single group of two Chinese White Dolphins was sighted in the two sets of surveys in December 2020. The dolphin
sighting was made in NWL, while none was sighted in
NEL. The dolphin sighting was made during
on-effort search and was made on secondary lines. The dolphin was
not associated with any operating fishing vessel.
No
dolphin sighting was made in the proximity of the
TM-CLKL alignment. The distribution of dolphin sightings during the
reporting month is shown in Figure 2.4.
The
southern end of transect line no. 8 was not travelled on 1 and 8 December
2020 during the dolphin monitoring due to the presence of construction
boats along the transect line. Part of the transect line was not
travelled due to safety concerns.
Encounter rates of Chinese White
Dolphins are deduced from the survey effort and on-effort sighting data made
under favourable conditions (Beaufort 3 or below) in December
2020 with the results present in Tables 2.9 and 2.10.
Table 2.9 Individual
Survey Event Encounter Rates
|
Encounter rate
(STG) (no. of on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate
(ANI) (no. of dolphins from all on-effort sightings
per 100 km of survey effort) |
|
Primary Lines
Only |
Primary Lines
Only |
||
NEL |
Set 1: December
1st / 3rd |
0.0 |
0.0 |
Set 2: December
8th / 10th |
0.0 |
0.0 |
|
NWL |
Set 1:
December 1st / 3rd |
0.0 |
0.0 |
Set 2:
December 8th / 10th |
0.0 |
0.0 |
Note:
Dolphin Encounter Rates are
deduced from the Two Sets of Surveys (Two Surveys in Each Set
) in December 2020 in Northeast (NEL) and Northwest Lantau
(NWL)
Table
2.10 Monthly Average Encounter Rates
|
Encounter rate
(STG) (no. of on-effort dolphin
sightings per 100 km of survey effort) |
Encounter rate
(ANI) (no.
of dolphins from all on-effort sightings per 100 km of survey effort) |
||
Primary
Lines Only |
Both Primary
and Secondary Lines |
Primary
Lines Only |
Both Primary
and Secondary Lines |
|
Northeast
Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest
Lantau |
0.0 |
0.7 |
0.0 |
1.4 |
Note:
Overall dolphin encounter rates (sightings per 100 km of survey effort) from
all four surveys are conducted in December 2020 on primary lines only as well as both
primary lines and secondary lines in Northeast and Northwest Lantau.
According to the EM&A Manual,
Operational Phase Monitoring on dolphin monitoring shall be undertaken based
upon the frequency of forty-eight, one-day survey events at a
frequency of 2 per month over a period of 24 months following cessation of the
construction. The
schedule for operational phase monitoring on dolphin monitoring in Decemeber 2020 is provided
in Appendix F.
No marine
works were undertaken during the reporting period,
therefore, daily 250 m marine mammal exclusion zone monitoring was not
undertaken during the reporting period.
Site inspections were
carried out on a weekly basis to monitor the implementation of proper
environmental pollution control and mitigation measures under the Contract.
In the reporting month, four (4) site inspections were
carried out on 9, 16, 23 and 28 December
2020.
Key observations and recommendations
during the site inspections in this reporting period are
summarized in Table 2.11.
Table
2.11 Specific Observations and
Recommendations during the Weekly Site Inspection in this Reporting Month
Inspection Date |
Observations |
Recommendations/ Remarks |
9 Decmeber 2020 |
Northern Landfall (CLP Substation) Nil. |
Northern Landfall (CLP Substation) Nil. |
16 December 2020 |
South Ventilation Building carpark
(southern landfall) NRMM label on the generator was
faded. Chemical containers were observed not placed in drip tray. Over 20 bags of cement bag were observed without proper cover. |
South Ventilation Building carpark
(southern landfall) The Contractor was
reminded to replace the NRMM label on the generator. The Contractor was
reminded to place chemical containers in drip tray. The Contractor was reminded to cover the cement bag with tarpaulin sheet
to avoid windblow dust. |
23 December 2020 |
Storage area (Northern landfall) Chemical containers were observed not placed in drip tray. |
Storage area (Northern landfall) The Contractor was reminded to place chemical containers in drip tray. |
28 December 2020 |
CLP Substation Chemical container was observed not placed in the drip tray. Northern Landfall (Zone C) Chemical containers were observed not placed in drip tray. |
CLP Substation The Contractor was
reminded to place chemical container in drip tray. Northern Landfall (Zone C) The Contractor was reminded to place chemical container in drip tray. |
|
|
|
|
|
|
The Contractor has rectified all of
the observations as identified during environmental site inspections in the
reporting month.
The Contractor had submitted
application form for registration as chemical waste producer under the
Contract. Sufficient numbers of receptacles were available for general
refuse collection and sorting.
Wastes generated during this reporting
period included mainly construction wastes (inert and non-inert).
Reference has been made to the waste flow table
prepared by the Contractor (Appendix M). The quantities of different types of
wastes are summarized in Table 2.12.
Table
2.10 Quantities of Different Waste Generated in
the Reporting Month
Month/Year |
Inert Construction Waste (a)
(tonnes) |
Inert Construction Waste Re-used (tonnes) |
Non-inert Construction Waste (b)
(tonnes) |
Recyclable Materials (c)
(kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|||
Category L |
Category M (Mp
& Mf) |
Mixed (L+M) |
|||||||
December 2020 |
554 |
0 |
173 |
0 |
0 |
0 |
0 |
0 |
|
Notes: |
|
||||||||
(a) Inert construction wastes include
hard rock and large broken concrete, and materials disposed as public fill. (b) Non-inert construction wastes
include general refuse disposed at landfill. (c) Recyclable materials include metals,
paper, cardboard, plastics, timber and others. |
|
||||||||
The Contractor was advised to properly
maintain on site C&D materials and waste collection, sorting and recording
system, dispose of C&D materials and wastes at
designated ground and maximize reuse/ recycle of C&D materials and
wastes. The Contractor was also reminded to
properly maintain the site tidiness and dispose of the wastes accumulated on
site regularly and properly.
For chemical waste containers, the
Contractor was reminded to treat properly and store
temporarily in designated chemical waste storage area on site in accordance
with the Code of Practice on the Packaging, Labelling and Storage of Chemical
Wastes.
The status of environmental licensing
and permit is summarized in Table 2.13 below.
Table 2.13 Summary of Environmental
Licensing and Permit Status
License/
Permit |
License or
Permit No. |
Date of
Issue |
Date of
Expiry |
License/ Permit Holder |
Remarks |
Environmental
Permit |
EP-354/2009/D |
13 March
2015 |
Throughout
the Contract |
HyD |
Application for VEP on 3 March 2015 to supersede
EP-354/2009/C |
Construction
Dust Notification |
435068 |
27 June 2018 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Construction
Dust Notification |
435505 |
12 July 2018 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Chemical
Waste Registration |
5213-422-D2516-02 |
18 January 2017 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Chemical
Waste Registration |
5213-951-D2591-01 |
25 May 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Construction
Waste Disposal Account |
7018108 |
28 August
2013 |
Throughout
the Contract |
DBJV |
Waste disposal in Contract No. HY/2012/08 |
Waste Water
Discharge License |
WT00031435-2018 |
2 August 2018 |
31 August 2023 |
DBJV |
Southern Landfall |
Waste Water
Discharge License |
WT00034060-2019 |
25 July 2019 |
30 June 2024 |
DBJV |
Northern Landfall (4 Discharge Point) |
Notes: |
|||||
HyD
= Highways Department DBJV = Dragages – Bouygues Joint Venture VEP =
Variation of Environmental Permit
|
In response to the site audit
findings, the Contractors carried out all corrective actions.
A summary of the Implementation
Schedule of Environmental Mitigation Measures (EMIS) is
presented in Appendix
C. The necessary mitigation measures relevant to this Contract were implemented properly.
One (1) Action Level exceedances of 1-hour TSP was recorded in the air quality monitoring during
this reporting month. No exceedance of 24-hour TSP Monitoring was recorded.
Cumulative statistics are provided in Appendix L.
The Environmental Complaint Handling
Procedure is provided in Figure
2.5.
No
environmental complaint was received in this reporting
period.
No environmental summons was received in this reporting period.
Statistics on complaints,
notifications of summons and successful prosecutions are
summarized in Appendix
L.
As informed by the Contractor, the
major works for the Contract in January 2021 are
summarized in Table 3.1.
Table
3.1 Construction Works to Be Undertaken in the Coming Month
Works to be undertaken |
Land-based Works Demolition of CLP
substation · |
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of January 2021 are mainly associated
with dust and waste management issues.
The tentative schedule for
environmental monitoring in January 2021 is provided in Appendix F.
This
Eighty-sixth Monthly
EM&A Report presents the findings of the EM&A activities undertaken
during the period from 1 to 31 December 2020, in accordance with the
Updated EM&A Manual and the requirements of EP-354/2009/D.
Air
quality (including 1-hour TSP and 24-hour TSP), operational phase water quality
monitoring and operational phase dolphin
monitoring were carried out in this reporting month.
One (1) Action Level exceedances of 1-hour TSP was recorded in the air quality monitoring during
this reporting month. No exceedance of 24-hour TSP Monitoring was recorded.
A single group of two Chinese White Dolphins was sighted in the two sets of surveys in December 2020. The dolphin
sighting was made in NWL, while none was sighted in
NEL. The dolphin sighting was made during
on-effort search and was made on secondary lines. The dolphin was
not associated with any operating fishing vessel.
Environmental
site inspection was carried out four (4)
times in December 2020.
Remedial actions recommended for the deficiencies identified during the
site audits were properly implemented by the
Contractor.
No non-compliance event was
recorded during the reporting period.
No
environmental complaint was received in this reporting
period.
No environmental summons was received in this reporting period.
The
ET will keep track on the construction works to confirm compliance of
environmental requirements and the proper implementation of all necessary
mitigation measures.
