table of Contents

                        EXecutive Summary

1                      Introduction

1.1                   Background

1.2                   Scope of Report

1.3                   Organization Structure

1.4                   Summary of Construction Works

2                      EM&A Results

2.1                   Air quality

2.2                   Water Quality Monitoring

2.3                   Dolphin Monitoring

2.4                   Post Translocation Coral Monitoring

2.5                   EM&A Site Inspection

2.6                   Waste Management Status

2.7                   Environmental Licenses and Permits

2.8                   Implementation Status of Environmental Mitigation Measures

2.9                   Summary of Exceedances of the Environmental Quality Performance Limit

2.10                 Summary of Complaints, Notification of Summons and Successful Prosecutions

3                      Future Key Issues

3.1                   Construction Activities for the Coming Quarter

3.2                   Key Issues for the Coming Quarter

3.3                   Monitoring Schedule for the Coming Quarter

4                      Conclusions





Appendix A

Project Organization

Appendix B

Three Months Programme

Appendix C

Environmental Mitigation And Enhancement Measure Implementation Schedules (EMIS)

Appendix D

Action And Limit Levels

Appendix E

Monitoring Schedule

Appendix F

Air Quality Monitoring Results

Appendix G

Water Quality Monitoring Results

Appendix H

Impact Dolphin Monitoring

Appendix I

Event And Action Plan

Appendix J

Cumulative Statistics On Exceedance And Complaint

Appendix K

Waste Flow Table





Executive Summary

Under Contract No. HY/2012/08, Dragages ¡V Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Northern Connection Sub-sea Tunnel Section of the Tuen Mun ¡V Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer.  For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET) in accordance with Environmental Permit No. EP-354/2009/A.  ENVIRON Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO).  Another application for variation of environmental permit (VEP) (EP-354/2009/B) was granted on 28 January 2014.

The construction phase of the Project commenced on 1 November 2013 and will tentatively be completed by the end of 2018.  The impact monitoring of the EM&A programme, including air quality, water quality, marine ecological monitoring and environmental site inspections, were commenced on 1 November 2013.

This is the Second Quarterly EM&A report presenting the EM&A works carried out during the period from 1 March 2014 to 31 May 2014 for the Contract No. HY/2012/08 Northern Connection Sub-sea Tunnel Section (the ¡§Project¡¨) in accordance with the Updated EM&A Manual of the TM-CLK Link Project.  As informed by the Contractor, the major activities in the reporting quarter included:

Marine-based Works

¡P      Dredging at Portion N-C

¡P      Reclamation Filling at Portion N-A

¡P      Construction of Vertical Seawall and Sloping Seawall at Portion N-B

¡P      Marine Sheet Piling for Box Culvert extension at Portion N-A


Land-based Works

Site WA 18

¡P      Site office structural works

Portion N6

¡P      CLP Substation structure works

¡P      CLP Substation E&M works

¡P      Bored Piling

¡P      Pile Cap Construction

Reclamation Area ¡V Portion N-A

¡P      Construction of temporary access

¡P      Diaphragm Wall Construction

A summary of monitoring and audit activities conducted in the reporting period is listed below:

24-hour TSP Monitoring                       16 sessions

1-hour TSP Monitoring                                   16 sessions

Impact Water Quality Monitoring                   39 sessions

Impact Dolphin Monitoring                             6 sessions

Joint Environmental Site Inspection     13 sessions

Daily marine mammal exclusion zone monitoring was undertaken during the period of dredging works.  No sighting of the Indo-Pacific humpback dolphin Sousa chinensis was observed during the exclusion zone monitoring.


Summary of Breaches of Action/Limit Levels

Breaches of Action and Limit Levels for Air Quality

Three Action Level and no Limit Level exceedances for 1-hr TSP; no Action Level or Limit Level exceedances for 24-hr TSP were recorded from the air quality monitoring in this reporting period.  The exceedances were considered to be due to the sporadic events from cumulative anthropogenic activities in this area of Hong Kong.

Breaches of Action and Limit Levels for Water Quality

One Action Level and one Limit Level exceedances for depth-averaged suspended solids (SS) were recorded in this reporting period.  The exceedances were considered to be the increased input of turbid water from the Pearl River due to heavy rainfall.

Dolphin Monitoring

Whilst two Action Level exceedances were observed for the quarterly dolphin monitoring data between March 2014 and May 2014, no unacceptable impact from the construction activities of the TM-CLKL Northern Connection Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from general observations during the dolphin monitoring in this reporting quarter.  The exceedances are considered to be the natural variation of Chinese White Dolphin ranging pattern.

Environmental Complaints, Non-compliance & Summons

No non-compliance with EIA recommendations, EP conditions and other requirements associated with the construction of this Contract was recorded in this reporting period.

One potential complaint/ enquiry case was notified by the Contractor on 25 April 2014.  The investigation findings showed that the case was considered not related to the works under this Contract and is thus invalid.

No environmental summons was received in this reporting period.

Reporting Change

There was no reporting change required in the reporting period.


Upcoming Works for the Next Reporting Period

Works to be undertaken in the coming quarterly period include the following:

Marine-based works

¡P      Dredging

¡P      Reclamation Filling

¡P      Vertical seawall construction

¡P      Sloping seawall construction

¡P      Marine sheet piling for box culvert extension

¡P      Predrilling for box culvert foundation

Land-based works

Portion N6

¡P      CLP substation utilities works

¡P      Bored Piling

Reclamation Area ¡V Portion N-A

¡P      Diaphragm Wall Construction

¡P      Construction of temporary access; and,

¡P      Pile Cap Construction

Future Key Issues

Potential environmental impacts arising from the above upcoming construction activities in the coming quarterly period are expected to be mainly associated with dust, marine water quality, marine ecology and waste management.


1                                             Introduction

1.1                                      Background

According to the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be operating beyond capacity after 2016.  This forecast has been based on the estimated increase in cross boundary traffic, developments in the Northwest New Territories (NWNT), and possible developments in North Lantau, including the Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong ¡V Zhuhai ¡V Macao Bridge (HZMB).  In order to cope with the anticipated traffic demand, two new road sections between NWNT and North Lantau ¡V Tuen Mun ¡V Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.

An Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental Impact Assessment Process (EIAO-TM).  The EIA Report was submitted under the Environmental Impact Assessment Ordinance (EIAO) in August 2009.  Subsequent to the approval of the EIA Report (EIAO Register Number AEIAR-145/2009), an Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4 November 2009, and EP variation (VEP) (EP-354/2009A) was issued on 8 December 2010.  Another application for VEP (EP-354/2009/B) was granted on 28 January 2014.

Under Contract No. HY/2012/08, Dragages ¡V Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Northern Connection Sub-sea Tunnel Section of TM-CLKL while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer.  For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET) in accordance with Environmental Permit No. EP-354/2009/A.  ENVIRON Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO).

Layout of the Contract components is presented in Figure 1.1.

The construction phase of the Contract commenced on 1 November 2013 and will tentatively be completed by 2018.  The impact monitoring phase of the EM&A programme, including air quality, water quality, marine ecological monitoring and environmental site inspections, were commenced on 1 November 2013.

1.2                                      Scope of Report

This is the Second Quarterly EM&A Report under the Contract No. HY/2012/08 Tuen Mun ¡V Chek Lap Kok Link ¡V Northern Connection Sub-sea Tunnel Section.  This report presents a summary of the environmental monitoring and audit works from 1 March 2014 to 31 May 2014.

1.3                                      Organization Structure

The organization structure of the Contract is shown in Appendix A.  The key personnel contact names and contact details are summarized in Table 1.1 below.

Table 1.1        Contact Information of Key Personnel

Party

Position

Name

Telephone

Fax

Highways Department



Engr 16/HZMB

Kenneth Lee

2762 4996

3188 6614

SOR

(AECOM Asia Company Limited)



Chief Resident Engineer

Edwin Ching



Andrew Westmoreland



2450 3111



2450 3511

2450 3099



2450 3099

ENPO / IEC

(ENVIRON Hong Kong Ltd.)

ENPO Leader



Y.H. Hui

3465 2888

3465 2899

IEC



F. C. Tsang

3465 2828

3465 2899

Contractor

(Dragages ¡V Bouygues Joint Venture)

Environmental Manager



C.F. Kwong

2293 7322

2670 2798

Environmental Officer



24-hour complaint hotline



Bryan Lee





Rachel Lam

2293 7323





2293 7342

2670 2798

ET (ERM-HK)

ET Leader

Jovy Tam

2271 3113

2723 5660

1.4                                      Summary of Construction Works

The construction phase of this Contract was commenced on 1 November 2013.  The three-month rolling construction programme is shown in Appendix B.

With reference to DBJV¡¦s information, details of major construction works carried out in this reporting period are summarized in Table 1.2.

The general layout plan of the site showing the detailed works areas is shown in Figure 1.2.  The Environmental Sensitive Receivers in the vicinity of the Project are shown in Figure 1.3.

The implementation schedule of environmental mitigation measures is presented in Appendix C.

Table 1.2        Summary of Construction Activities Undertaken during the Reporting Period

Construction Activities Undertaken

Marine-based Works

¡P         Dredging at Portion N-C

¡P         Reclamation Filling at Portion N-A

¡P         Construction of Vertical Seawall and Sloping Seawall at Portion N-B

¡P         Marine Sheet Piling for Box Culvert extension at Portion N-A

Land-based Works

Site WA 18

¡P         Site office structural works

Portion N6

¡P         CLP Substation structure works

¡P         CLP Substation E&M works

¡P         Bored Piling

¡P         Pile Cap Construction

Reclamation Area ¡V Portion N-A

¡P         Construction of temporary access

¡P         Diaphragm Wall Construction




Figure 1.2       Locations of Construction Activities ¡V March 2014 to May 2014

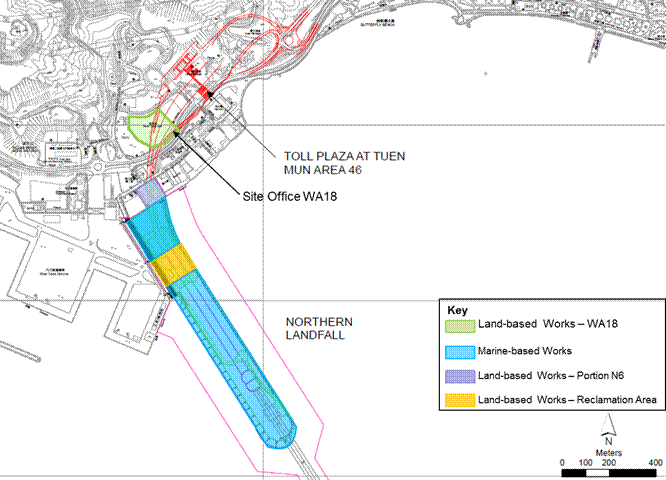

  1. Tuen Mun ¡V Land-based and Marine-based Works Area





2                                             EM&A Results

The EM&A programme required environmental monitoring for air quality, water quality and marine ecology as well as environmental site inspections for air quality, noise, water quality, waste management, marine ecology and landscape and visual impacts.  The EM&A requirements and related findings for each component are summarized in the following sections

2.1                                      Air quality

As per the requirements under Condition 2.4 of EP-354/2009/A and EP-354/2009/B, the Enhanced TSP Monitoring Plan has been prepared under Contract No. HY/2012/08.  Details of the monitoring plan are presented in the Enhanced TSP Monitoring Plan ([1]).

2.1.1                               Monitoring Requirements and Equipment

In accordance with the Updated EM&A Manual and the Enhanced TSP Monitoring Plan, impact 1-hour TSP monitoring was conducted three (3) times in every six (6) days and impact 24-hour TSP monitoring was carried out once in every six (6) days when the highest dust impact was expected.

High volume samplers (HVSs) were used to carry out the 1-hour and 24-hour TSP monitoring in the reporting quarter at the five (5) air quality monitoring stations in accordance with the requirements stipulated in the Updated EM&A Manual (Figure 2.1; Table 2.1).  Wind anemometer was installed at the rooftop of ASR5 for logging wind speed and wind direction.  Details of the equipment deployed are provided in Table 2.2.


Table 2.1        Locations of Impact Air Quality Monitoring Stations and Monitoring Dates in this Reporting Period

Monitoring Station

Location

Description

Parameters & Frequency

Monitoring Dates

ASR1

Tuen Mun Fireboat Station

Office

Ÿ  1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3 times per day in every 6 days

Ÿ  24-hour Total Suspended Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 6 days

6, 12, 18, 24 and 28 March 2014;

3, 9, 15, 18, 24 and 30 April 2014;

5, 10, 16, 22 and 28 May 2014





ASR5

Pillar Point Fire Station

Office

AQMS1

Previous River Trade Golf

Bare ground

ASR6

Butterfly Beach Laundry

Office

ASR10

Butterfly Beach Park

Recreational uses

Table 2.2        Air Quality Monitoring Equipment

Equipment

Brand and Model

High Volume Sampler
(1-hour TSP and 24-hour TSP)

Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170)



Wind Meter

MetPak (Model: MetPak II (S/N: 13130002)

Wind Anemometer for calibration

Lutron (Model No. AM-4201)

2.1.2                               Action & Limit Levels

The Action and Limit Levels of the air quality monitoring is provided in Appendix D.  The Event and Action plan is presented in Appendix I.

2.1.3                               Monitoring Schedule for the Reporting Quarter

The schedules for air quality monitoring in the reporting quarter are provided in Appendix E.

2.1.4                               Results and Observations

Impact air quality monitoring was conducted at all designated monitoring stations in the reporting period under favourable weather conditions.  The major dust sources in the reporting period include construction activities under the Contract as well as nearby traffic emissions.

The monitoring results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4, respectively.  Monitoring results are presented graphically in Appendix F [JY1] and detailed impact air quality monitoring data were reported in the Fifth to Seventh Monthly EM&A Report.

Table 2.3        Summary of 1-hour TSP Monitoring Results in this Reporting Period

Month/Year

Station

Average (µg/m3)

Range (µg/m3)

Action Level  (µg/m3)

Limit Level  (µg/m3)

March 2014 to May 2014

ASR 1

160

62 ¡V 391

331

500

ASR 5

192

82 ¡V 402

340

500

AQMS1

144

56 ¡V 299

335

500

ASR6

145

52 ¡V 318

338

500

ASR10

120

59 ¡V 381

337

500

Table 2.4        Summary of 24-hour TSP Monitoring Results in this Reporting Period

Month/Year

Station

Average (µg/m3)

Range (µg/m3)

Action Level  (µg/m3)

Limit Level  (µg/m3)

March 2014 to May 2014

ASR 1

90

46 ¡V 135

213

260

ASR 5

93

55 ¡V 119

238

260

AQMS1

75

43 ¡V 129

213

260

ASR6

74

44 ¡V 107

238

260

ASR10

69

40 ¡V 108

214

260

In this reporting period, a total of sixteen monitoring events were undertaken in which three Action Level exceedances and no Limit Level exceedances for 1-hr TSP; no Action Level exceedances or Limit Level exceedances for 24-hr TSP were recorded.  Summary of Exceedances for Air Quality Impact Monitoring in this Reporting Quarter is detailed in Table 2.15.

2.2                                      Water Quality Monitoring

The baseline water quality monitoring undertaken by the Hong Kong ¡V Zhuhai ¡V Macao Bridge Hong Kong Projects (HKZMB) between 6 and 31 October 2011 has included all monitoring stations for the Project.   Thus, the baseline monitoring results and Action/Limit Levels presented in HKZMB Baseline Monitoring Report ([2]) are adopted for this Project.

2.2.1                               Monitoring Requirements & Equipment

In accordance with the Updated EM&A Manual, impact water quality monitoring was carried out three days per week during the construction period at nine (9) water quality monitoring stations (Figure 2.2; Table 2.5).

Table 2.5        Locations of Water Quality Monitoring Stations and the Corresponding Monitoring Requirements

Station ID

Type

Coordinates

*Parameters, unit

Depth

Frequency





Easting

Northing







IS12

Impact Station

813218

823681

Ÿ Temperature(¢XC)

Ÿ pH(pH unit)

Ÿ Turbidity (NTU)

Ÿ Water depth (m)

Ÿ Salinity (ppt)

Ÿ DO (mg/L and % of

saturation)

¡P    SS (mg/L)

3 water depths: 1m

below sea surface,

mid-depth and 1m

above sea bed.  If the water depth is less than 3m, mid-depth sampling only.  If water depth less than 6m, mid-depth may be omitted.





Impact monitoring: 3 days per week, at mid-flood and mid-ebb tides during the construction period of the Contract.

IS13

Impact Station

813667

824325

IS14

Impact Station

812592

824172

IS15

Impact Station

813356

825008

CS4

Control / Far Field Station

810025

824004

CS6

Control / Far Field Station

817028

823992

SR8

Sensitive receiver (Gazettal beaches in Tuen Mun)

816306

825715

SR9

Sensitive receiver
(Butterfly Beach)

813601

825858

SR10A

Sensitive receiver
(Ma Wan FCZ)

823741

823495

*Notes:

In addition to the parameters presented monitoring location/position, time, water depth, sampling depth, tidal stages, weather conditions and any special phenomena or works underway nearby were also recorded.

Table 2.6 summarizes the equipment used in the impact water quality monitoring programme.


Table 2.6        Water Quality Monitoring Equipment

Equipment

Model

Qty.

Water Sampler

Kahlsico Water-Bottle Model 135DW 150

1

Dissolved Oxygen Meter

YSI Pro 2030

1

pH Meter

HANNA HI 8314

1

Turbidity Meter

HACH 2100Q

1

Monitoring Position Equipment

¡§Magellan¡¨ Handheld GPS Model eXplorist GC

4

DGPS Koden KGP913MK2 (1)

1

2.2.2                               Action & Limit Levels

The Action and Limit Levels of the water quality monitoring is provided in Appendix D.  The Event and Action plan is presented in Appendix I.

2.2.3                               Monitoring Schedule for the Reporting Period

The schedules for water quality monitoring in the reporting period are provided in Appendix E.

2.2.4                               Results and Observations

During this reporting period, major marine dredging activities included dredging at Portions N-B and N-C and reclamation filling at Portion N-A.  A closed grab dredger was used and silt curtains (cage-type and single floating type) were deployed during dredging works in accordance with the EP.  The level of dredging activities was within the working rate described in the EP and the approved EIA Report.  In addition, reclamation filling was undertaken between the 200 m of leading seawalls using filling materials specified in the EP and the approved EIA Report with a single layer silt curtain being deployed as a precautionary measure to reduce dispersion of suspended solids.  It is useful to note that heavy marine traffic (not associated with the Project) was commonly observed nearby the Project site and its vicinity.

Impact water quality monitoring was conducted at all designated monitoring stations in the reporting period under favourable weather conditions.  Monitoring results are presented graphically in Appendix G and detailed impact water quality monitoring data were reported in the Fifth to Seventh Monthly EM&A Report.

In this reporting period, a total of thirty-nine monitoring events were undertaken in which one Action Level exceedance and one Limit Level exceedances for depth-averaged SS were recorded.  Summary of Exceedances for Water Quality Impact Monitoring in this Reporting Quarter is detailed in Table 2.17.

2.3                                      Dolphin Monitoring

2.3.1                               Monitoring Requirements

Impact dolphin monitoring is required to be conducted by a qualified dolphin specialist team to evaluate whether there have been any effects on the dolphins.  In order to fulfil the EM&A requirements and make good use of available resources, the on-going impact line transect dolphin monitoring data collected by HyD¡¦s Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong Kong Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing Facilities on the monthly basis is adopted to avoid duplicates of survey effort.

2.3.2                               Monitoring Equipment

Table 2.7 summarises the equipment used for the impact dolphin monitoring.

Table 2.7        Dolphin Monitoring Equipment

Equipment

Model

Global Positioning System (GPS)



Camera



Laser Binoculars

Marine Binocular

Vessel for Monitoring



Garmin 18X-PC

Geo One Phottix

Nikon D90 300m 2.8D fixed focus

Nikon D90 20-300m zoom lens

Infinitor LRF 1000

Bushell 7 x 50 marine binocular with compass and reticules

65 foot single engine motor vessel with viewing platform 4.5m above water level







2.3.3                               Monitoring Parameter, Frequencies & Duration

Dolphin monitoring should cover all transect lines in Northeast Lantau (NEL) and the Northwest Lantau (NWL) survey areas twice per month throughout the entire construction period.  The monitoring data should be compatible with, and should be made available for, long-term studies of small cetacean ecology in Hong Kong.  In order to provide a suitable long-term dataset for comparison, identical methodology and line transects employed in baseline dolphin monitoring was followed in the impact dolphin monitoring.

2.3.4                               Monitoring Location

The impact dolphin monitoring was carried out in the NEL and NWL along the line transect as depicted in Figure 2.3.  The co-ordinates of all transect lines are shown in Table 2.8 below.


Table 2.8        Impact Dolphin Monitoring Line Transect Co-ordinates

Line No.

Easting

Northing

Line No.

Easting

Northing

1

Start Point

804671

814577

13

Start Point

816506

819480

1

End Point

804671

831404

13

End Point

816506

824859

2

Start Point

805475

815457

14

Start Point

817537

820220

2

End Point

805477

826654

14

End Point

817537

824613

3

Start Point

806464

819435

15

Start Point

818568

820735

3

End Point

806464

822911

15

End Point

818568

824433

4

Start Point

807518

819771

16

Start Point

819532

821420

4

End Point

807518

829230

16

End Point

819532

824209

5

Start Point

808504

820220

17

Start Point

820451

822125

5

End Point

808504

828602

17

End Point

820451

823671

6

Start Point

809490

820466

18

Start Point

821504

822371

6

End Point

809490

825352

18

End Point

821504

823761

7

Start Point

810499

820690

19

Start Point

822513

823268

7

End Point

810499

824613

19

End Point

822513

824321

8

Start Point

811508

820847

20

Start Point

823477

823402

8

End Point

811508

824254

20

End Point

823477

824613

9

Start Point

812516

820892

21

Start Point

805476

827081

9

End Point

812516

824254

21

End Point

805476

830562

10

Start Point

813525

820872

22

Start Point

806464

824033

10

End Point

813525

824657

22

End Point

806464

829598

11

Start Point

814556

818449

23

Start Point

814559

821739

11

End Point

814556

820992

23

End Point

814559

824768

12

Start Point

815542

818807









12

End Point

815542

824882









2.3.5                               Action & Limit Levels

The Action and Limit levels of dolphin impact monitoring are shown in Appendix D.  The Event and Action plan is presented in Appendix I.


2.3.6                               Monitoring Schedule for the Reporting Period

The dolphin monitoring schedules for the reporting period are shown in Appendix E.

2.3.7                               Results & Observations

A total of 891.87 km of survey effort was collected, with 87.4% of the total survey effort being conducted under favourable weather conditions (ie Beaufort Sea State 3 or below with good visibility) in this reporting quarter.  Amongst the two areas, 350.40 km and 541.47 km of survey effort were collected from NEL and NWL survey areas, respectively.  The total survey effort conducted on primary and secondary lines were 642.67 km and 249.20 km, respectively.  The survey efforts are summarized in Appendix H.

A total of 31 groups of 103 Chinese White Dolphin sightings were recorded during the six sets of surveys in this reporting quarter.  All except one sighting were made during on-effort search.  Twenty-five on-effort sightings were made on primary lines, while five other on-effort sightings were made on secondary lines.  During this reporting quarter, all dolphin groups were sighted in NWL, while none was sighted in NEL.

For the detailed comparison of dolphin occurrence and usage of NEL and NWL survey area between the impact phase and baseline phase monitoring, only the quarterly data of March 2014 to May 2014 from the impact phase monitoring was used in the present report to tally with the three-month period of baseline monitoring (September 2011 to November 2011).

As the baseline monitoring period was in the autumn season (September 2011 to November 2011) while the present monitoring period was in the spring season (March 2014 to May 2014), a direct comparison in dolphin distribution between the two quarterly periods of spring months in 2013 and 2014 was also made to avoid the potential bias in seasonal variation.[JY2]

Between the two spring periods, none of the dolphin sightings was made in NEL in spring 2014, while there were two sightings made in spring 2013.  Moreover, more dolphin sightings were made in the middle portion of North Lantau waters and to the west of the airport platform in spring 2013 than in spring 2014.

Encounter rates of Chinese White Dolphins are deduced from the survey effort and on-effort sighting data made under favourable conditions (Beaufort 3 or below with good visibility) in the reporting quarter with the results and comparison with baseline results present in Tables 2.9 and 2.10.


Table 2.9        Individual Survey Event Encounter Rates



Encounter rate (STG)     (no. of on-effort dolphin sightings per 100 km of survey effort)

Encounter rate (ANI)            (no. of dolphins from all on-effort sightings per 100 km of survey effort)

Primary Lines Only

Primary Lines Only

NEL

Set 1: Mar 5th/11th

0.0

0.0

Set 2: Mar 17th/25th

0.0

0.0

Set 3: Apr 4th/14th

0.0

0.0

Set 4: Apr 16th/24th

0.0

0.0

Set 5: May 2nd/19th

0.0

0.0

Set 6: May21st/26th

0.0

0.0

NWL

Set 1: Mar 5th/11th

6.43

23.57

Set 2: Mar 17th/25th

13.15

24.83

Set 3: Apr 4th/14th

4.89

26.88

Set 4: Apr 16th/24th

4.94

11.54

Set 5: May 2nd/19th

5.47

18.24

Set 6: May21st/26th

4.18

9.75

Note: Dolphin Encounter Rates are deduced from the Two Sets of Surveys (Two Surveys in Each Set) in the reporting quarter in Northeast (NEL) and Northwest Lantau (NWL)

Table 2.10      Monthly Average Encounter Rates



Encounter rate (STG)

(no. of on-effort dolphin sightings per 100 km of survey effort)

Encounter rate (ANI)            (no. of dolphins from all on-effort sightings per 100 km of survey effort)

March 2014 ¡V May 2014

September 2011 ¡V November 2011

March 2014 ¡V May 2014[JY3]

September 2011 ¡V November 2011

Northeast Lantau

0.0

6.00 ¡Ó 5.05

0.0

22.19 ¡Ó 26.81

Northwest Lantau

6.51 ¡Ó 3.34

9.85 ¡Ó 5.85

19.14 ¡Ó 7.19

44.66 ¡Ó 29.85

Note: Encounter rates deduced from the baseline monitoring period have been recalculated based only on survey effort and on-effort sighting data made along the primary transect lines under favourable conditions.

Table d 4.6

nd limit levels of dolphin impact monitoring are shown in Table

Group size of Chinese White Dolphins ranged from 1 - 13 individuals per group in North Lantau region during March 2014 to May 2014.  The average dolphin group sizes from these three months were compared with the ones deduced from the baseline period in September to November 2011, as shown in Table 2.11.




Table 2.11      Average Dolphin Group Size



Average Dolphin Group Size

March 2014 ¡V May 2014

September 2011 ¡V November 2011

Overall

3.32 ¡Ó 2.87

3.72 ¡Ó 3.13

Northeast Lantau

0.0

3.18 ¡Ó 2.16

Northwest Lantau

3.32 ¡Ó 2.87

3.92 ¡Ó 3.40

During this reporting quarter of dolphin monitoring, no unacceptable impact from the construction activities of this Contract was recorded from the general observations.

Although the dolphins infrequently occurred along the alignment of TM-CLKL Northern Connection Sub-Sea Tunnel Section in the past and during the baseline monitoring period, it is apparent that dolphin usage has been significantly reduced in NEL.

It is critical to monitor the dolphin usage in North Lantau region in the upcoming quarters to determine whether the dolphins are continuously affected by the various construction activities in relation to the HZMB-related works, and whether suitable mitigation measure can be applied to revert the situation.

2.3.8                               Marine Mammal Exclusion Zone Monitoring

Daily 250 m marine mammal exclusion zone monitoring was undertaken during the period of dredging activities under this Contract.  No sighting of the Indo-Pacific humpback dolphin (i.e. Chinese White Dolphin) Sousa chinensis was recorded during the exclusion zone monitoring.

2.4                                      Post Translocation Coral Monitoring

The second quarterly Coral Post-Translocation Monitoring was conducted on 16 April 2014 and the results were provided in the Second Quarterly Post-Translocation Coral Monitoring Report.  The findings indicated that the Action or Limit Levels for coral monitoring were not exceeded as increase in percentage of partial mortality was not detected for both the tagged translocated and natural coral colonies when comparing to the pre-translocation dataset.

2.5                                      EM&A Site Inspection

Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract.  Thirteen (13) site inspections were carried out in the reporting quarter on 4, 11, 19 and 26 March; 1, 8, 16, 22 and 30 April; 7, 13, 21, 27 May 2014.

Key observations during the site inspections in this reporting period are summarized in Table 2.12.

Table 2.12      Specific Observations and Recommendations during the Weekly Site Inspection in this Reporting Period

Inspection Date

Environmental Observations

Recommendations/ Remarks

4 March 2014

Barge ¡V GD2

¡P         Sediment outflow was observed outside the cage-type silt curtain. Cage-type silt curtain should be maintained regularly.

¡P         Acoustic decoupling measures should be placed underneath all generators.

Barge ¡V GD2

¡P         The Contractor was reminded to regularly maintain the cage-type silt curtain to prevent sediment out flow.

¡P         The Contractor was reminded to check for all generators if the acoustic decoupling measures have been placed underneath all generators.

Barge ¡V Wing Go

¡P         Excess sandy materials should be regularly cleaned from decks and exposed fittings of the barge.

Works Area - WA23

¡P         Sandy materials should be regularly cleared to avoid runoff.

Barge ¡V Wing Go

¡P         The Contractor was reminded to regularly clear excess sandy materials from decks and exposed fittings of the barge.

Works Area - WA23

¡P         The Contractor was reminded to clear the sandy materials more often to avoid runoff.

11 March 2014

Barge ¡V GD12 and GD2

Barge ¡V GD12 and GD2

¡P         Acoustic decoupling measures should be placed underneath all generators.

¡P         The Contractor was reminded to place the proper isolation material underneath all generators.

Barge ¡V GD2

Barge ¡V GD2

¡P         Oily water and surface runoff was observed on the deck.

¡P         Cage-type silt curtain should be maintained regularly throughout the dredging works.

¡P         The Contractor was reminded to clean up the oily water as chemical waste immediately and to check for oil spill regularly.

¡P         The Contractor was reminded to fix the cage-type silt curtain before dredging works commence.

19 March 2014

Barge ¡V CA11 and GD2

¡P         Excess material should be regularly cleaned from decks and the side of the barge.

¡P         Cage-type silt curtain should be maintained regularly throughout the dredging works.

Works Area - Portion N6

¡P         C&D waste material sorting area should be set up properly.

Barge ¡V CA11 and GD2

¡P         The Contractor was reminded to do regular cleaning of excess material on the side decks of the barge.

¡P         The Contractor was reminded to perform regular maintanence on the cage-type silt curtain.

Works Area - Portion N6

¡P         The Contractor was reminded to set up a proper C&D waste material sorting area.

26 March 2014

Marine Works Area - Portion N-A and N-B

¡P         The Contractor was reminded to tie the floating type silt curtain.

Works Area - Portion N6

¡P         Stagnant water should be cleared.

¡P         Water spraying should be applied during ground breaking works to control dust.

Marine Works Area - Portion N-A and N-B

¡P         The Contractor was reminded to regularly check and maintain the floating type silt curtain.

Works Area - Portion N6

¡P         The Contractor was reminded to clear the stagnant water.

¡P         The Contractor was reminded to apply water spraying during ground breaking works and provide adequate water spraying throughout the day to avoid dust generation.

1 April 2014

Barge ¡V Tai Hip 2

¡P         Chemical containers on the barge was observed without drip tray.

¡P         Oil spillage was observed in the water adjacent to the barge.

Works Area - Portion N6

¡P         Bunds should be provided to avoid sediment runoff into the sea.



Barge ¡V Tai Hip 2

¡P         The Contractor was reminded to provide drip tray for the chemical containers to avoid chemical spillage.

¡P         The Contractor was reminded to clean up the oil spill as chemical waste.

Works Area - Portion N6

¡P         The Contractor was reminded to provide bunds.

8 April 2014

Barge ¡V GBFC

¡P         Chemical containers and oil drum on the barge were observed without drip tray.

Reclamation Area ¡V Zone E

¡P         Sandy materials were observed on the seawall block next to the barge.

Barge ¡V Leader F53

¡P         Acoustic decoupling measures should be placed underneath all generators.

Barge ¡V GBFC

¡P         The Contractor was reminded to provide drip tray for chemical containers and oil drum on the barge.

Reclamation Area ¡V Zone E

¡P         The Contractor was reminded to regularly clear the sandy materials on the seawall block.

Barge ¡V Leader F53

¡P         The Contractor was reminded to check all generators for acoustic decoupling measures on newly arrived vessels.

16 April 2014

Reclamation Area ¡V Zone E

¡P         Drip tray should be provided to the chemical containers.

Reclamation Area ¡V Zone E

¡P         The Contractor was reminded to provide drip tray for the chemical containers.

22 April 2014

Barge ¡V CA1

¡P         Acoustic decoupling measures should be properly installed underneath the generator.

Barge ¡V Wing Ko

¡P         Excess materials were observed on the deck of the barge and on top of seawall blocks.

Works Area - Portion N6

¡P         Excess materials were observed on the edge of the site area.

Barge ¡V CA1

¡P         The Contractor was reminded to check all the generators for proper implementation of acoustic decoupling measures.

Barge ¡V Wing Ko

¡P         Excess materials should be cleared regularly on the deck of the barge and on top of seawall blocks.

Works Area - Portion N6

¡P         Excess materials should be cleared regularly on the edge of the site area to avoid runoff.

30 April 2014

Works Area - Portion N6

¡P         Silty water was observed near the drilling machine.

¡P         Excess materials were observed on the edge of the site area.

Works Area - Portion N6

¡P         The Contractor was reminded to clear the silty water.

¡P         The Contractor was reminded to clear the excess materials to avoid runoff.

7 May 2014

Barge ¡V CA1

¡P         Cage-type silt curtain should be properly installed.

¡P         Sediment flow was observed behind hopper barge.

Works Area - Portion N6

¡P         Drip tray should be provided to the chemical containers.

Barge ¡V CA1

¡P         The Contractor was reminded to properly install the cage-type silt curtain before dredging commences.

¡P         The Contractor was reminded to maintain the silt curtain behind hopper barge.

Works Area - Portion N6

¡P         The Contractor was reminded to provide drip tray to the chemical containers.

13 May 2014

Reclamation Area - Portion N-A

¡P         Drip tray should be provided for the generator once in use.

Marine Works Area - Portion N-A

¡P         Muddy plume was observed near the seawall.

Reclamation Area - Portion N-A

¡P         The Contractor was reminded to provide drip tray for the generator.

Marine Works Area - Portion N-A

¡P         The Contractor was reminded to provide a layer of geotextile next to the seawall to prevent muddy plume.

21 May 2014

Reclamation Area - Portion N-A

¡P         Silt curtain should be maintained regularly.

¡P         Mechanical equipment should be covered during rainstorm to avoid chemical spillage.

Reclamation Area - Portion N-A

¡P         The Contractor was reminded to properly tie the silt curtain.

¡P         The Contractor was reminded to cover the mechanical equipment during rainstorm.

27 May 2014

Works Area ¡V Portion N6

¡P         Water inside drip tray should be cleared.

Reclamation Area - Portion N-A

¡P         EP should be displayed at the site entrance.

Works Area ¡V Portion N6

¡P         The Contractor was reminded to regularly check the capacity of drip trays.

Reclamation Area - Portion N-A

¡P         The Contractor was reminded to display EP at the site entrance.


The Contractor has rectified all of the observations as identified during environmental site inspections in the reporting quarter.

2.6                                      Waste Management Status

The Contractor had submitted application form for registration as chemical waste producer under the Contract.  Sufficient numbers of receptacles were available for general refuse collection and sorting.

Wastes generated during this reporting period include mainly construction wastes (inert and non-inert), imported fill, recyclable materials, and marine sediments.  Reference has been made to the waste flow table prepared by the Contractor (Appendix K).  The quantities of different types of wastes are summarized in Table 2.13.

Table 2.13      Quantities of Different Waste Generated in the Reporting Period

Month/Year

Inert Construction Waste (a) (tonnes)

Imported Fill (tonnes)

Inert Construction Waste Re-used

(tonnes)

Non-inert Construction Waste (b) (tonnes)

Recyclable Materials (c)  (kg)

Chemical Wastes (kg)

Marine Sediment (m3)

Category L

Category M

March 2014

105

516,400

0

36

0

0

37,300

40,450

April 2014

22

467,867

0

26

160

0

28,600

15,400

May 2014

1,016

516,368

0

42

0

0

18,700

29,150

Total

1,143

1,500,635[JY4]

0

104

160

0

84,600

85,000

Notes:

(a)   Inert construction wastes include hard rock and large broken concrete, and materials disposed as public fill.

(b)   Non-inert construction wastes include general refuse disposed at landfill.

(c)    Recyclable materials include metals, paper, cardboard, plastics, timber and others.



The Contractor was advised to properly maintain on site C&D materials and waste collection, sorting and recording system, dispose of C&D materials and wastes at designated ground and maximize reuse/ recycle of C&D materials and wastes.  The Contractor was also reminded to properly maintain the site tidiness and dispose of the wastes accumulated on site regularly and properly.

For chemical waste containers, the Contractor was reminded to treat properly and store temporarily in designated chemical waste storage area on site in accordance with the Code of Practice on the Packaging, Labelling and Storage of Chemical Wastes.

2.7                                      Environmental Licenses and Permits

The status of environmental licensing and permit is summarized in Table 2.14 below.


Table 2.14      Summary of Environmental Licensing and Permit Status

License/ Permit

License or Permit No.

Date of Issue

Date of Expiry

License/ Permit Holder

Remarks

Environmental Permit

EP-354/2009/B

28 January 2014

Throughout the Contract

HyD

Application for VEP on 20 January 2014 to replace EP-354/2009/A

Construction Dust Notification

363510

19 August 2013

Throughout the Contract

DBJV

-

Chemical Waste Registration

5213-422-D2516-01

10 September 2013

Throughout the Contract

DBJV

-

Construction Waste Disposal Account

7018108

19 August 2013

Throughout the Contract

DBJV

Waste disposal in Contract HY/2012/08

Waste Water Discharge License

WT00017707-2013

18 November 2013

30 November 2018

DBJV

For works in site WA18

Waste Water Discharge License

WT00018433-2014

6 March 2014

31 March 2019

DBJV

For works in site Portion N6

Construction Noise Permit

GW-RW0223-14

29 March 2014

28 September 2014

DBJV

For works in site Portion N6

Construction Noise Permit

GW-RW0691-13

15 October 2013

14 April 2014

DBJV

For Dredging and Reclamation Works

Construction Noise Permit

GW-RW0095-14

10 February 2014

9 August 2014

DBJV

For Dredging and Reclamation Works

Construction Noise Permit

GW-RW0234-14

29 March 2014

28 September 2014

DBJV

For Dredging and Reclamation Works

Construction Noise Permit

GW-RW0822-13

14 November 2013

10 May 2014

DBJV

For works in site WA18

Construction Noise Permit

GW-RS0814-13

15 November 2013

10 May 2014

DBJV

For works in site WA23

Construction Noise Permit

GW-RS0362-14

11 May 2014

10 November 2014

DBJV

For works in site WA23

Construction Noise Permit

GW-RW0077-14

17 February 2014

16 August 2014

DBJV

For Portion N6

Marine Dumping Permit

EP/MD/14-072

1 November 2013

30 April 2014

DBJV

For Type 1

Marine Dumping Permit

EP/MD/14-140

1 March 2014

31 March 2014

DBJV

For Type 1 (dedicated site) and Type 2

Marine Dumping Permit

EP/MD/14-072

3 April 2014

30 April 2014

DBJV

For Type 1 (dedicated site) and Type 2

Marine Dumping Permit

EP/MD/15-007

1 May 2014

31 May 2014

DBJV

For Type 1 (dedicated site) and Type 2

Notes:











HyD = Highways Department

DBJV = Dragages ¡V Bouygues Joint Venture

VEP = Variation of Environmental Permit

2.8                                      Implementation Status of Environmental Mitigation Measures

In response to the site audit findings, the Contractors carried out all corrective actions.

A summary of the Implementation Schedule of Environmental Mitigation Measures (EMIS) is presented in Appendix C.  The necessary mitigation measures relevant to this Contract were implemented properly.

2.9                                      Summary of Exceedances of the Environmental Quality Performance Limit

For air quality impact monitoring, a total of sixteen monitoring events were undertaken in which three Action Level exceedances and no Limit Level exceedances for 1-hr TSP; no Action Level exceedances or Limit Level exceedances for 24-hr TSP were recorded. (Table 2.15).  Upon further investigation, the recorded exceedances in air quality monitoring were considered to be sporadic events of cumulative anthropogenic activities in this area of Hong Kong.  Detailed investigation findings were presented in Appendix L of the Fifth to Sixth Monthly EM&A Report.

Table 2.15      Summary of Exceedances for Air Quality Impact Monitoring in this Reporting Quarter

Station

Exceedance Level

1-hr TSP

24-hr TSP

Number of Exceedances

1-hr TSP

24-hr TSP

AQMS1

Action Level

-

-

0

0

Limit Level

-

-

0

0

ASR1

Action Level

2014-03-24

-

1

0

Limit Level

-

-

0

0

ASR5

Action Level

2014-03-24

-

1

0

Limit Level

-

-

0

0

ASR6

Action Level

-

-

0

0

Limit Level

-

-

0

0

ASR10

Action Level

2014-04-03

-

1

0

Limit Level

-

-

0

0

Total number of Action level Exceedances:

3

0

Total number of Limit level Exceedances:

0

0



For marine water quality impact monitoring, a total of thirty-nine monitoring events were undertaken in which one Action Level exceedance and one Limit Level exceedances for depth-averaged SS were recorded (Table 2.17).   The exceedances were considered to be the increased input of turbid water from the Pearl River due to heavy rainfall upon further investigation.  Detailed investigation findings are presented in Appendix L of the Fifth Monthly EM&A Report.  In addition, the construction impact on depth-averaged SS was assessed to compare the quarterly mean values of depth-averaged SS with the relevant ambient mean values.  Results showed that the quarterly mean values of depth-averaged SS at all monitoring stations are well below the ambient mean values (Table 2.16), thus no further action is required in accordance with the Updated EM&A Manual.

Table 2.16      Comparison between Quarterly Mean and Ambient Mean Values of Depth-averaged Suspended Solids

Station

Baseline Mean

Ambient Mean (a)

Quarterly Mean (March 2014 to May 2014)

Mid-ebb

Mid-flood

Mid-ebb

Mid-flood

Mid-ebb

Mid-flood

CS4

10.2

9.0

13.3

11.7

4.3

4.2

CS6

10.9

11.7

14.1

15.2

4.2

4.3

IS12

9.2

9.5

12.0

12.3

4.6

5.0

IS13

10.0

10.5

13.0

13.7

4.4

4.5

IS14

10.4

9.7

13.5

12.6

4.4

4.8

IS15

9.6

11.0

12.5

14.2

4.3

4.6

SR10A

10.3

10.2

13.3

13.3

4.3

4.6

SR8

10.1

11.3

13.1

14.7

4.2

4.4

SR9

8.8

9.9

11.4

12.8

4.4

4.4

Grand Total

10.0

10.3

13.0

13.4

4.3

4.5

Notes:

(a) Ambient mean value is defined as a 30% increase of the baseline mean value






Table 2.17      Summary of Exceedances for Marine Water Quality Impact Monitoring in this Reporting Quarter

Station

Exceedance Level (a)

DO (Surface and Middle)

DO (Bottom)

Turbidity (depth-averaged)

SS (depth-averaged)

Mid-ebb

Mid-flood

Mid-ebb

Mid-flood

Mid-ebb

Mid-flood

Mid-ebb

Mid-flood

CS4

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

-

CS6

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

-

IS12

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

2014-03-31

IS13

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

-

IS14

AL

-

-

-

-

-

-

-

2014-03-31

LL

-

-

-

-

-

-

-

-

IS15

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

-

SR8

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

-

SR9

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

-

SR10

AL

-

-

-

-

-

-

-

-

LL

-

-

-

-

-

-

-

-

Total AL Exceedances:

0

0

0

0

0

0

0

1

Total LL Exceedances:

0

0

0

0

0

0

0

1

Notes:

(a) AL = Action Level; LL = Limit Level



Two Action Level exccedances of impact dolphin monitoring were recorded in this reporting quarter.  Following the review of monitoring data and marine works details in accordance with the procedures stipulated in the Event and Action Plan of the Updated EM&A Manual, the recorded exceedances were considered to be due to natural variation of dolphin ranging pattern.  Detailed investigation findings are presented in Appendix J.

Cumulative statistics are provided in Appendix J.

2.10                                   Summary of Complaints, Notification of Summons and Successful Prosecutions

The Environmental Complaint Handling Procedure is provided in Figure 2.4.

No non-compliance event was recorded during the reporting period.

One potential complaint/ enquiry case was notified by the Contractor on 25 April 2014.  The investigation findings showed that the case was considered not related to the works under this Contract and is thus invalid.  Detailed investigation findings are provided in Appendix L of the Seventh EM&A Monthly Report.

No summons/ prosecution was received during the reporting period.

Statistics on complaints, notifications of summons and successful prosecutions are summarized in Appendix J.





3                                             Future Key Issues

3.1                                      Construction Activities for the Coming Quarter

As informed by the Contractor, the major works for the Project in the coming quarter are summarized in Table 3.1.

Table 3.1        Construction Works to Be Undertaken in the Coming Quarter

Works to be undertaken

Marine-based Works

¡P         Dredging

¡P         Reclamation Filling

¡P         Vertical Seawall construction

¡P         Sloping Seawall construction

¡P         Marine Sheet Piling for Box Culvert extension

¡P         Predrilling for Box culvert Foundation

Land-based Works

Works Area - Portion N6

¡P         CLP Substation utilities works

¡P         Bored Piling

Reclamation Area ¡V Portion N-A

¡P         Construction of temporary access

¡P         Pile Cap Construction

¡P         Diaphragm Wall Construction



3.2                                      Key Issues for the Coming Quarter

Potential environmental impacts arising from the above upcoming construction activities are mainly associated with dust, marine water quality, marine ecology and waste management issues.

3.3                                      Monitoring Schedule for the Coming Quarter

Impact monitoring for air quality, marine water quality and marine ecology (include dolphin monitoring and post-translocation coral monitoring) are scheduled to continue for the next reporting period.

The monitoring programme has been reviewed and was considered as adequate to cater for the nature of works in progress.  Change to the monitoring programme was thus not considered to be necessary at this stage.  The monitoring programme will be evaluated as appropriate in the next reporting period.





4                                             Conclusions

This Second Quarterly EM&A Report presents the findings of the EM&A activities undertaken during the period from 1 March 2014 to 31 May 2014, in accordance with the Updated EM&A Manual and the requirements of EP-354/2009/B.

Air quality (including 1-hour TSP and 24-hour TSP), marine water quality and dolphin monitoring were carried out in the reporting period.  Three Action Level and no Limit Level exceedances for 1-hr TSP, and no Action Level or Limit Level exceedances for 24-hr TSP were recorded during the reporting period.  One Action Level and one Limit Level exceedances for depth-averaged SS were recorded in marine water quality impact monitoring during the reporting period.  The review of monitoring data suggested that no unacceptable impact was resulting from the construction activities under this Contract in the reporting period.  Nevertheless, the Contractor was reminded to ensure that all dust mitigation measures are provided at the construction sites and the proper deployment of cage-type silt curtains at the dredging site.

A total of 31 groups of 103 Chinese White Dolphin sightings were recorded during the six sets of surveys from March 2014 to May 2014.  Whilst two Action Level exceedances were recorded for the quarterly dolphin monitoring data between March and May 2014, no unacceptable impact from the construction activities of the TM-CLKL Northern Connection Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from general observations. Although the dolphins infrequently occurred along the alignment of TM-CLKL Northern Connection Sub-Sea Tunnel Section in the past and during the baseline monitoring period, it is apparent that dolphin usage has been significantly reduced in NEL.  It is critical to monitor the dolphin usage in North Lantau region in the upcoming quarters, to determine whether the dolphins are continuously affected by the various construction activities in relation to the construction works of the Contract, and whether suitable mitigation measure can be applied to improve the situation.

Thirteen weekly environmental site inspections were carried out in the reporting period.  Recommendations on remedial actions provided for the deficiencies identified during the site audits were properly implemented by the Contractor.  No non-compliance event was recorded during the reporting period.

One potential complaint/ enquiry case was notified by the Contractor on 25 April 2014.  The investigation findings showed that the case was considered not related to the works under this Contract and is thus invalid.

No summons/ prosecution was received during the reporting period.

The monitoring programme has been reviewed and was considered as adequate to cater for the nature of works in progress.  Change to the monitoring programme was thus not recommended at this stage.  The monitoring programme will be evaluated as appropriate in the next reporting period.  The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.






([1])        ERM (2013) Enhanced TSP Monitoring Plan.  Submitted on 28 October 2013 and subsequently approved by EPD on 1 November 2013.

([2])       Agreement No. CE 35/2011 (EP) Baseline Environmental Monitoring for Hong Kong - Zhuhai - Macao Bridge Hong Kong Projects - Investigation.  Baseline Environmental Monitoring Report (Version C).  Submitted on 8 March 2012 and subsequently approved by EPD.


 [JY1]The figure number need to revise to G1 to F1..etc

 [JY2]I think we shall include the results in section3.2.6 of Samuel¡¦s report?

 [JY3]The date period is not correct, pleae check

 [JY4]Update this too if necessary
