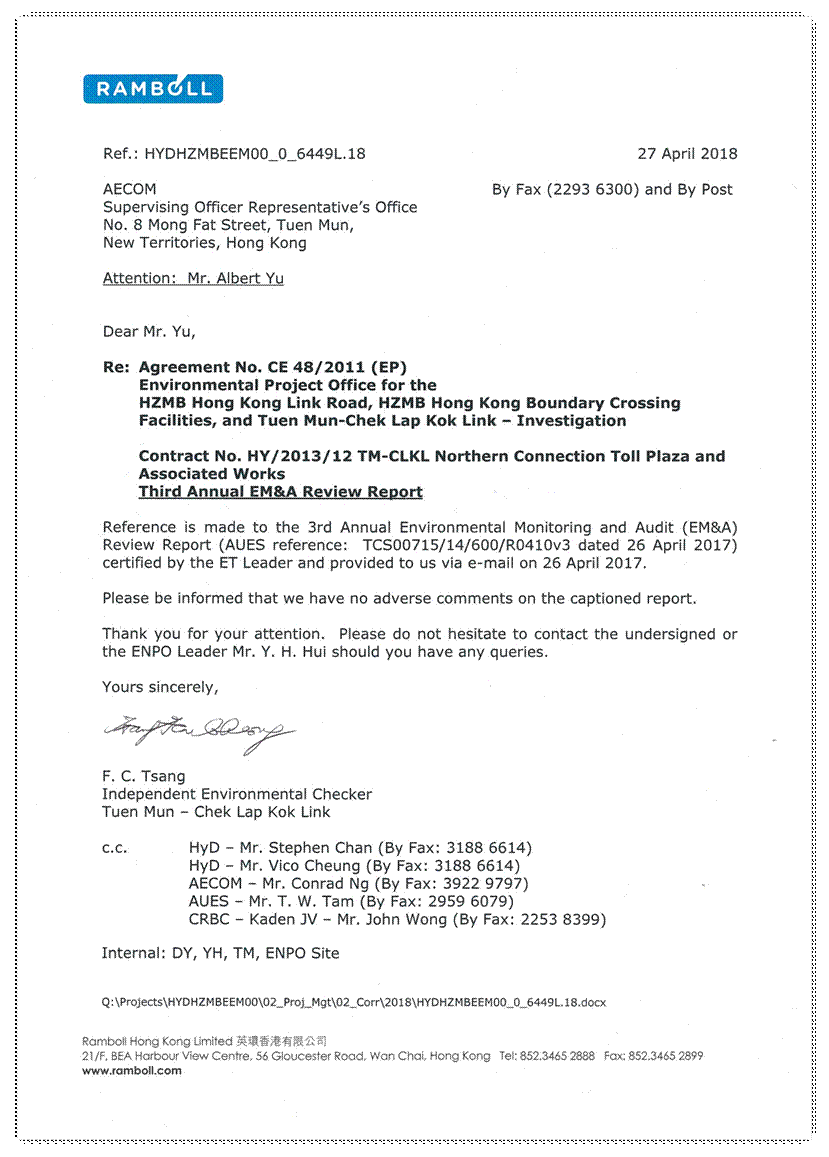

AUES Job No.: TCS00715/14 |
|
|
||
|
|
|
|
|
||
|
|
Tuen Mun - Chek Lap Kok Link Contract No. HY/2013/12 ¡V Northern Connection Toll Plaza and Associated Works |
|
|
||
|
|
|
|
|
||
|
|
3rd Annual Environmental
Monitoring and Audit (EM&A) Review Report ¡V November 2016 to October 2017 |
|
|
||
|
|
|
|
|
||
|
|
Prepared
For CRBC
and Kaden Joint Venture |
|
|
||
Date |
Reference No. |
Prepared By |
Certified By |
26 April 2018 |
TCS00715/14/600/R0410v3 |
Ben Tam (Environmental Consultant) |
T.W. Tam (Environmental Team Leader) |
EXECUTIVE
SUMMARY
ES01
In August 2014, CRBC-Kaden Joint Venture (hereafter ¡§CRBC-Kaden JV¡¨)
has been awarded the Contract No. HY/2013/12 -Northern Connection Toll Plaza and Tunnel Section of the Tuen Mun ¡V Chek
Lap Kok Link
(hereinafter called ¡§the Contract¡¨) by the Highways Department (HyD). The
construction phase of the Contract was
commenced on 23 October 2014.
ES02
Before the Contract commencement, the baseline
air quality monitoring was carried out by the ET of HY/2012/08 from 16th to 31st October 2013. A set of Action and Limit Levels (A/L
Levels) of air quality performance criteria was proposed by ET of HY/2012/08 which has been verified by IEC and endorsed by EPD. The Action and Limit Levels of the air
quality adopted for the Contract is shown in Table
ES-01.
Table ES-01 Action and Limit Levels of
Air Quality Monitoring
Monitoring
Station |
24-hour TSP, (mg /m3) |
1-hour TSP, (mg/m3) |
||
Action Level |
Limit Level |
Action Level |
Limit Level |
|
ASR1 |
213 |
260 |
331 |
500 |
ASR5 |
238 |
260 |
340 |
500 |
AQMS1 |
213 |
260 |
335 |
500 |
ASR6 |
238 |
260 |
338 |
500 |
ASR10 |
214 |
260 |
337 |
500 |
ES03
In September 2013, baseline
survey for Pitcher Plant has been conducted within the project area by a
suitably qualified ecologist. In
mid-September 2014, Contract HY/2013/12 has also conducted a one-off survey to
confirm the number of existing Pitcher Plant. For cultural heritage, a condition survey
for the grave was conducted on 23 September 2014. The Baseline Monitoring
Report for the Contract was submitted on 7 October 2014 for IEC¡¦s verification
and
25 November 2014 for EPD¡¦s endorsement.
ES04
This is the 3rd Annual EM&A Review Report for the ¡§Tuen Mun - Chek Lap Kok Link - Northern
Connection Toll Plaza and Associated Works¡¨ under Environmental Permit No. EP-354/2009/D (hereinafter ¡¥¡¥the EP¡¦¡¦), covering the period from 1 November 2016 to 31 October 2017 (hereinafter ¡§Reporting
Period¡¨).
Summary of EM&A activities for the Reporting Period
ES05
In the Reporting Period,
the EM&A activities is summarized in Table ES-02.
Table ES-02 Summary EM&A Activities
Undertaken in the Reporting Period
Environmental
Aspect |
Environmental
Monitoring Parameters / Inspection |
Sub-total Occasions |
Total |
|||
1st
Quarter |
2nd
Quarter |
3rd
Quarter |
4th
Quarter |
|||
Air Quality |
1-hour TSP |
465 |
450 |
450 |
450 |
1815 |
24-hour TSP |
155 |
150 |
150 |
145 |
600 |
|
Cultural heritage inspection |
Grave G1 |
13 |
13 |
13 |
14 |
53 |
Landfill Gas
Monitoring |
Oxygen; Methane & Carbon Dioxide |
73 days |
72 days |
75 days |
75 days |
295 days |
Landscape
&Visual |
Landscape
& Visual Monitoring |
13 |
13 |
13 |
13 |
52 |
Joint Site
Inspection / Audit |
IEC, ET, the Contractor and RE joint site Environmental Inspection and Auditing |
13 |
13 |
13 |
14 |
53 |
Breach
of Action and Limit (A/L) Levels
ES06
In according with the air quality measurement
results by the ET of Contract HY/2012/08 total 14 Action Level and 1 Limit Level exceedances of 1-hour TSP were recorded; 1 Action Level exceedance of 24-hour
TSP was recorded in the Reporting Period.
ES07
For landfill gas
monitoring, the concentration of all parameters were detected within the
acceptable levels. Moreover, no noise
complaint was received in the Reporting Period. Table ES-03 is summarized breach of
environmental performance criteria.
Table ES-03 Action
and Limit (A/L) Levels Breach Summarized in the Reporting Period
Environmental Aspect |
Monitoring Parameters |
Action Level |
Limit Level |
Event & Action |
||
NOE Issued |
Investigation |
Corrective Actions |
||||
Air
Quality |
1-hour
TSP |
14 |
1 |
7 |
7 |
0 |
24-hour
TSP |
1 |
0 |
1 |
1 |
0 |
|
Landfill
Gas Monitoring |
Oxygen |
0 |
0 |
0 |
0 |
0 |
Methane |
0 |
0 |
0 |
0 |
0 |
|
Carbon
Dioxide |
0 |
0 |
0 |
0 |
0 |
Environmental
Complaint
ES08
In the first three quarter
of Reporting Period, no environmental complaints were received by either the RE
or ENPO or HyD or the Main Contractor. However, two (2) environmental complaint were received in the fourth quarter of Reporting
Period. The complaint received
on 29 September 2017 regarding construction dust issue
at Lung Mun Road, Tuen Mun. The complaint received on 24 October
2017 regarding light nuisance created by Tuen Mun - Chek Lap Kok Link Project during mid-night. The statistics of environmental complaint is listed in Table ES-04.
Table ES-04 Statistical
Summary of Environmental Complaints
Reporting Period |
Complaint Nature |
Total Registered |
|||
Water Quality |
Construction Dust |
Construction Noise |
Others |
||
1 November 2016 ¡V 31
October 2017 |
NA |
29 September 2017 |
NA |
24 October 2017 |
2 |
ES09
Complaint investigations were conducted by the ET and the
corresponding investigation reports for the complaint were submitted to relevant parties. Based on investigation results, the
contractor has enhanced the management to
comply the Contract requirements.
Notification of Summons and Successful Prosecutions
ES10
No environmental summons or successful
prosecutions were recorded in the Reporting Period.
ES11
For past twelve
months, total 53 occasions joint
site inspection were carried out by the RE, IEC, ET and the Contractor. For
joint site inspections, no non-compliance was observed. However, 91
observations/reminders were recorded within
the past twelve months.
ES12
During each occasion of site inspection,
Pitcher Plants of ecology and grave of culture heritage were also to inspect and audit.
ES13
Construction dust
emission would be a key environmental issue during construction work of the Contract
at dry season. Dust mitigation
measures such as watering at least 12 times per day on all exposed soil within
the Project site and associated work areas in Tuen Mun area throughout the
construction period should be implemented in accordance with the EP
requirement.
ES14
Muddy water or other
water pollutants from sites surface flow to public area should be avoided. Water quality mitigation measures to
prevent surface runoff to impact public areas should be fully implemented.
Table of Contents
1 Introduction 1
1.1 Contract
Background 1
1.2 Report
Structure 1
2 Contract Organization and Construction progress and Environmental Submissions 2
2.1 Contract
Organization 2
2.2 Construction
Progress 2
2.3 Summary of Environmental Submissions 2
3 Summary of Impact Monitoring Requirements Under the Contract 4
3.1 General 4
3.2 Air
Quality Monitoring Parameters 4
3.3 Monitoring
Location 4
3.4 Monitoring Frequency 4
3.5 Derivation
of Action/Limit (A/L) Levels 5
3.6 Other
Environmental Aspects 5
4 Air Quality Monitoring 8
4.1 General 8
4.2 Air
Quality Monitoring Results in Reporting Period 8
4.3 Summary
of Action and Limit (A/L) Levels Exceedance (non-compliance) 8
4.4 Air
Quality Exceedance Investigation 9
5 Ecology Monitoring 10
5.1 General 10
5.2 Pitcher
Plants Inspection 10
6 CULTURAL HERITAGE 11
6.1 General 11
6.2 Grave
Inspection 11
7 LandscAPe and Visual 12
7.1 General 12
7.2 Landscape
and Visual Inspection 12
8 Landfill Gas Hazard Monitoring 13
8.1 General 13
8.2 Landfill
Gas Monitoring Result 13
9 Waste Management 15
9.1 General
Waste Management 15
9.2 Records
of Waste Quantities 15
10 Inspection and Auditing 16
10.1 Site
Inspection 16
11 Environmental Complaint and Non-compliance 17
11.1 Environmental
Complaint, Summons and Prosecution 17
11.2 Summary
record of all complaints, action and working procedures 17
12 Implementation Status of Mitigation Measures 19
12.1 General
Requirements 19
13 Conclusions and Recommendations 20
13.1 Conclusions 20
13.2 Recommendations 20
List
of TABLES
Table 2-1 Status of
Environmental Licenses and Permits of the Contract
Table 3-1 Designated Air
Quality Monitoring Stations under the Contract
Table 3-2 Enhanced TSP
Monitoring Plan ¡V Construction Phase
Table 3-3 TSP Action and
Limit Levels for Impact Air Quality Monitoring
Table 3-4 Actions in the
Event of Landfill Gas being Detected in Excavation / Confined Area
Table 4-1 Summary of Air
Quality Monitoring Exceedance
Table 8-1 Landfill Gas
Monitoring Zone
Table 8-2 Summary of
Landfill Gas Measurement Results in this Annual for TD1 & LMR
Table 9-1 Summary of
Quantities of Inert C&D Materials
Table 9-2 Summary of
Quantities of C&D Wastes
Table 10-1 Summary of
Reminders/Observations of Site Inspection for the Annual
Table 11-1 Statistical Summary of
Environmental Exceedance
Table 11-2 Statistical Summary of
Environmental Complaints
Table 11-3 Statistical Summary of
Environmental Summons
Table 11-4 Statistical Summary of
Environmental Prosecution
Table 12-1 Environmental Mitigation
Measures
List of Appendices
Appendix A Project
Layout Plan
Appendix B Layout Plan of the Contract
Appendix C Organization
of the Contract
Appendix D Master Construction Program
Appendix E Monitoring
Locations for the Contract
Appendix F Event
and Action Plan
Appendix G Graphical
Plots
Appendix H Environmental
Mitigation Measures Implementation Schedule (EMMIS)
1.1.1
CRBC-Kaden Joint Venture (hereafter
¡§CRBC-Kaden JV¡¨) is commissioned by the Highways Department (HyD) as the Main Contractor of the Contract No. HY/2013/12 ¡V Northern Connection Toll Plaza and
Tunnel Section ((hereafter ¡§the Contract¡¨) and this Contract is part of the Tuen Mun ¡V Chek
Lap Kok Link (TM-CLK Link Project). TM-CLK Link Project is a Designated
Project under the latest Environmental Permit number VEP-354/2009D issued on 13 March 2015. The layout
Plan of the Project and the Contract are showed in Appendix A and Appendix B respectively.
1.1.2
The works of the
Contract mainly include:-
a.
construction of an approximately 5.4 hectares
toll plaza and an associated footbridge;
b.
construction of associated carriageways
including approximately 0.74 kilometre land viaducts,
and an approximately 230 metres vehicular underpass
to connect the toll plaza and the roundabout at Lung Mun Road/Lung Fu Road;
c.
site formation for the construction of the
toll plaza, including associated slope works and natural terrain hazard
mitigation measures;
d.
modification and realignment of the existing
Lung Mun Road and Lung Fu Road; and
e.
associated
waterworks, drainage, sewerage and landscaping works, etc..
1.1.3
AECOM Asia Company Limited as the Resident
Engineer (RE) and Ramboll Environ Hong Kong Limited as the
Independent Environmental Checker (IEC) and Environmental Project Office (ENPO)
were employed by the HyD. For implementation of the environmental
monitoring and audit (EM&A) programme under the Contract, CRBC-Kaden JV has
appointed Action-United Environmental Services & Consulting (AUES) as the
Environmental Team (ET) to responsible relevant environmental monitoring work.
1.1.4
Construction phase of the Contract was commenced on 23
October 2014. This is the
Secomd (3rd) Annual EM&A Review Report to
summarize the monitoring results and inspection findings with the Contractor
performance from 1 November 2016 to 31 October 2017 (hereinafter ¡§Reporting Period¡¨) for the past twelve months.
1.2.1
The Annual Environmental Monitoring and Audit
(EM&A) Review Report is structured into the following sections:-
Section 1 Introduction
Section 2 Contract
Organization and Construction Progress and Environmental Submissions
Section 3 Summary
of Impact Monitoring Requirements under the Contract
Section 4 Air
Quality Monitoring
Section 5 Ecology
Monitoring
Section 6 Cultural
Heritage
Section 7 Landscape
and Visual
Section 8 Landfill
gas hazard Monitoring
Section 9 Waste
Management
Section 10 Inspection and Auditing
Section 11 Environmental Complaint and Non-Compliance
Section 12 Implementation
Status of Mitigation Measures
Section 13 Conclusions
and Recommendations
2.1.1
The Contract organization and contact details
of key personnel are shown in Appendix C.
2.2.1
In the Reporting Period, the major
construction activity conducted under the Contract is summarized in below. Moreover, the master construction
program of the Contract is enclosed in Appendix D.
Instrumentation and Monitoring
Site Formation ¡V Earthwork on Slope D and E;
surface drainage on slope C, D & E and Portion H
Toll Plaza Decking TD1, TD2
Toll Plaza Footbridge
Retaining Structure RW_B, RW_F and RW_F
Bridge G1, G2,Bridge H1 by Form Traveller
Toll Collector Subway & Associated Works
Sewer Culvert at FC1 and FC2
Road and Drainage Works +11mPD, +19mPD and
Portion H
Sewer culvert by hand shield method at FC1 and FC2
Waterproofing and lining at Vehicular
Underpass
Toll Booth Canopy
Road and Drainage Works at Portion J and Lung
Mun Road
2.3.1
In according to the EP, the required
documents have submitted to EPD for retention which listed in below:
Monitoring Plan on construction dust
(submission refer to Contract HY/2012/08)
Landscape and Visual Plan (not yet endorsed by EPD)
Waste Management Plan (endorsed by the EPD on 16 March 2015)
Baseline Monitoring Report (not yet endorsed
by EPD)
2.3.2
Summary of
the relevant permits, licenses, and/or notifications on environmental
protection as obtained by the Contract in the past twelve months is presented
in Table 2-1.
Table 2-1 Status of Environmental
Licenses and Permits of the Contract
Type of Permit/
License |
Reference/ License No. |
Date of Issue |
Date of Expiry |
|
1 |
Air pollution Control (Construction Dust) Regulation |
377719 |
06-08-2014 |
N/A |
2 |
Chemical Waste Producer Registration -
Waste Producers Number |
5117422C389301 |
03-09-2014 |
N/A |
3 |
Variation of
Effluent Discharge License |
WT00023973-2016 |
14-03-16 |
30-09-2019 |
4 |
Waste Disposal Regulation - Billing Account
for Disposal of Construction Waste |
7020460 |
01-08-2014 |
N/A |
5 |
CNP for Multiple Task |
GW-RW0520-16 |
05-05-2016 |
04-11-2016 |
GW-RW0619-16 |
05-11-2016 |
04-05-2017 |
||
GW-RW0230-17 |
08-05-2017 |
04-11-2017 |
||
6 |
CNP for MH5 |
GW-RW0563-16 |
18-05-2016 |
17-11-2016 |
GW-RW0650-16 |
18-11-2016 |
17-05-2017 |
||
GW-RW0242-17 |
22-05-2017 |
17-11-2017 |
||
7 |
CNP for Tunnel |
GW-RW0582-16 |
23-05-2016 |
22-11-2016 |
GW-RW0653-16 |
23-11-2016 |
22-05-2017 |
||
GW-RW0243-17 |
23-05-2017 |
22-11-2017 |
||
8 |
CNP for falsework
erection |
GW-RW0472-16 |
22-08-2016 |
21-12-2016 |
GW-RW0724-16 |
28-12-2016 |
16-03-2017 |
||
GW-RW0117-17 |
09-03-2017 |
16-06-2017 |
||
GW-RW0205-17 |
25-04-2017 |
25-11-2017 |
||
9 |
CNP for Portion H Roundabout |
GW-RW0704-16 |
06-12-2016 |
21-02-2017 |
GW-RW0049-17 |
14-02-2017 |
18-08-2017 |
||
GW-RW0242-17 |
22-05-2017 |
17-11-2017 |
||
10 |
CNP for Road Paving Works |
GW-RW0211-17 |
25-04-2017 |
01-11-2017 |
Note:
CNP is Control Noise Permit
3.1.1
In view of the
construction works under the Contract, the major construction activities are
land-based. In accordance with the
Project EM&A Manual requirements, environmental aspect monitoring should be
conducted including air quality, ecological (Pitcher plant), cultural heritage
and site inspections during construction period. In addition, landscape
and visual (L&V) monitoring, landfill gas monitoring and audit of the
contractor¡¦s implementation of the construction noise and land-based water
quality pollution control measures are also required for the Contract.
3.1.2
A summary of construction phase EM&A
requirements are presented in the
sub-sections below.
3.2.1
The construction phase air quality monitoring
shall cover the following parameters:
•
1-hour TSP; and
•
24-hour TSP
3.3.1
The air quality monitoring stations for impact monitoring are listed in Table 3.1 and illustrated in Appendix
E.
Table 3-1 Designated
Air Quality Monitoring Stations under the Contract
ID |
Location |
Air monitoring station Description |
ASR1 |
Tuen Mun Fireboat Station |
EM&A Manual |
ASR5 |
Pillar Point Fire Station |
EM&A Manual |
AQMS1 |
Previous River Trade Golf |
Enhanced TSP Level under EP
condition 2.4 |
ASR6 |
Butterfly Beach Laundry |
Enhanced TSP Level under EP
condition 2.4 |
ASR10 |
Butterfly Beach Park |
Enhanced TSP Level under EP
condition 2.4 |
General Requirement
3.4.1
For regular impact monitoring, the sampling frequency of at least once
in every six days shall be strictly observed at five of the designated
monitoring stations for 24-hr TSP monitoring. For 1-hr TSP monitoring, the sampling
frequency of at least three times in every six days should be undertaken at
five locations when the highest dust impact occurs. The stations to be monitored should be
selected based on the prevailing wind direction and their proximity to the
active construction works.
Special Requirement
3.4.2
As per Condition 2.4 of
the EP of TM-CLKL, an enhanced monitoring plan on TSP level at Tuen Mun (¡§the
Enhanced TSP Monitoring Plan¡¨) is required to be submitted to the DEP for
approval at least 1 month before the commencement of construction of the Project.
Details of the Enhanced TSP
Monitoring Plan under Contract No. HY/2012/08 could be found from the project
website. The
air quality monitoring work under this Contract will follow the monitoring
requirement of enhanced TSP monitoring under the project.
3.4.3
The air quality
monitoring requirements for the Contract is shown in Table 3-2.
Table 3-2 Enhanced TSP Monitoring Plan ¡V
Construction Phase
Condition |
Monitoring
Parameter |
Monitoring
Location |
Frequency |
Monitoring Requirement |
General |
1-hour TSP |
ASR1, ASR5, AQMS1, ASR6, ASR10 |
3 times per day every six days |
Throughout the Northern Connection, toll plaza and tunnel buildings
construction works |
24-hour TSP |
ASR1, ASR5, AQMS1, ASR6, ASR10 |
Daily every six days |
||
Special |
1-hour TSP |
ASR1, ASR5, AQMS1, ASR6, ASR10 |
3 times per day every three days |
Northern Connection During excavation works for launching shaft, excavation work for Cut and
Cover Tunnel and Cut and Cover Tunnel Construction Toll Plaza During excavation, slope works, construction of road and superstructures
and wind erosion from open sites and stockpiling areas Tunnel Buildings During excavation, foundation works, construction of superstructures and
wind erosion from open sites and stockpiling areas |
24-hour TSP |
ASR1, ASR5, AQMS1, ASR6, ASR10 |
Daily every three days |
3.5.1
The baseline monitoring
results formed the basis for determining the air quality criteria for the
impact monitoring. The ET shall compare the impact monitoring results with air
quality criteria set up for 24-hour TSP and 1-hour TSP. Based on results of the approved
Baseline Monitoring Report of HyD Contract
HY/2012/08, the proposed Action and Limit Levels are shown in Tables
3-3.
Table
3-3 TSP
Action and Limit Levels for Impact Air Quality Monitoring
Air Quality Monitoring Stations |
24-hour TSP (£gg/m3) |
1-hour TSP (£gg/m3) |
||
Action Level |
Limit Level |
Action Level |
Limit Level |
|
ASR1 |
213 |
260 |
331 |
500 |
ASR5 |
238 |
260 |
340 |
500 |
AQMS1 |
213 |
260 |
335 |
500 |
ASR6 |
238 |
260 |
338 |
500 |
ASR10 |
214 |
260 |
337 |
500 |
3.5.2
Should non-compliance of the environmental
quality criteria occurs, remedial actions will be triggered according to the
Event and Action Plan which presented in Appendix F.
Noise
3.6.1
The TM-CLKL EIA study
concluded that no existing noise sensitive receiver (NSR) was identified within
the Study Area at Tuen Mun.
Therefore, no planned NSR designated at the Project sites of Tuen Mun. Based upon this, no noise monitoring is
necessary for construction phase under the Contract.
3.6.2
Regular site inspections
and audits will be carried out during the construction phase in order to
confirm compliance with the regulatory requirements and conformity of the
Contractor with regard to noise control and contract conditions.
Water Quality
3.6.3
No marine works will be
undertaken under the Contract.
Based upon this, no water quality monitoring is necessary for
construction phase.
Ecology
3.6.4
Since the Works of the Contract
would not generate marine ecological impact, no dolphin monitoring under
the Contract was conducted.
3.6.5
During construction phase, the ET will
perform Pitcher Plants inspection at least once every week to report the growth
condition (only undertaken at Establish
period) and protection measures.
Landscape and Visual
3.6.6
According to EIA recommendation,
site inspection and audit
shall be required to be undertaken in the operation stage. Measures
to mitigate landscape
and visual impacts during construction should be checked and monitored by a
Registered Landscape Architect to ensure compliance with the intended aims of
the mitigation measures in accordance with the EM&A
Manual.
Cultural Heritage
3.6.7
Grave G1 of heritage resources is situated near the proposed
toll plaza in Tuen Mun. Site inspections should be
undertaken at least once per week throughout the construction period to ensure
compliance with the intended aims of recommended mitigation measures.
Monitoring and
Measurement of Landfill Gas
3.6.8
During EIA study,
landfill gas hazards are likely to be generated from the Pillar Point Valley (PPV)
Landfill. Hence, regular landfill gas monitoring is recommended during
construction of the proposed toll plaza. Safety Officer or an approved and
appropriated qualified person should be carried out the monitoring works to
make sure the area free of landfill gas before any man enters in the area.
3.6.9
Depending on the results of the measurements, actions
required will vary and should be set down by the Safety Officer or other appropriately
qualified person. As a minimum these should encompass those actions specified
as follow:
Table 3-4 Actions in the Event of Landfill Gas
being Detected in Excavation / Confined Area
Parameter |
Measurement |
Action |
Oxygen |
<
19% |
-
Ventilate to restore oxygen to > 19% |
<
18% |
- Stop work - Evacuate personnel /
prohibit entry -
Increase ventilation to restore to > 19% |
|
Methane |
> 10% LEL (> 0.5%
v/v) |
- Prohibit hot work - Ventilate to restore
methane to < 10% LEL |
> 20% LEL (>1%
v/v) |
- Stop work - Evacuate personnel /
prohibit entry -
Increase ventilation to restore to < 10% |
|
Carbon Dioxide |
>
0.5% |
-
Ventilate to restore oxygen to < 0.5% |
>
1.5% |
- Stop work - Evacuate personnel /
prohibit entry -
Increase ventilation to restore to < 0.5% |
4.1.1
According
to the Updated EM&A Manual and the Enhanced Total Suspended Particulates
(TSP) Monitoring Plan, the air quality impact monitoring was conducted at the
five air quality monitoring stations during the Reporting Period by the ET of
Contract HY/2012/08. Sharing of impact air quality monitoring
data between HY/2012/08 and HY/2013/12 is agreed by all relevant parties. Therefore the Contract is not required
to conduct its own dust monitoring exercise until the Contract HY/2012/08 is
ended.
4.2.1
In the Reporting Period, total 1,815 of 1-hr TSP measurements and 600 events of 24-hours TSP monitoring at five proposed locations
were carried out by the ET of Contract HY/2012/08. Detailed air quality monitoring results
and statistical analysis of the trends of air quality data during the Reporting
Period can be referred to the Monthly EM&A Reports (from November 2016 to October 2017) and the Fourth Annual EM&A Review Report (November 2016 to October 2017) prepared
by the ET of Contract HY/2012/08.
4.3.1
According to the air quality monitoring
result provided by Contract HY/2012/08, 3 Action Level exceedances of 1-hour
TSP were recorded at ASR5, ASR6 & ASR10 on 29 July 2017; 1 Action Level exceedances of 1-hour TSP was recorded at ASR1 on 22 August
2017; 3 Action Level and 1 Limit Level exceedances of 1-hour TSP was recorded
at ASR1 (2 Action and 1 Limit) and ASR5 (1 Action) on 12 September 2017; 1
Action Level exceedance of 1-hour TSP was recorded at AQMS1 on 18 September
2017 and 2 Action Level exceedances of 1-hour TSP was recorded at ASR5 on 27 September
2017; 2 Action Level exceedances of 1-hour TSP and 1 Action Level exceedances
of 24-hour TSP was recorded at ASR1 on 21 October 2017; 2 Action Level
exceedances of 1-hour TSP was recorded at ASR5 and ASR6 on 27 October 2017. Notification on Exceedances (NOEs) were issued after receiving
the monitoring result from the Contract HY/2012/08. The summary of air quality exceedance is
shown in Table 4-1.
Table 4-1 Summary
of Air Quality Monitoring Exceedance
Date of Exceedance |
Monitoring Station |
Air Quality
Parameter |
Result |
Exceed |
29 July 2017 |
ASR5 |
1Hr TSP |
370 µg/m3 |
Action Level |
29 July 2017 |
ASR6 |
1Hr TSP |
401 µg/m3 |
Action Level |
29 July 2017 |
ASR10 |
1Hr TSP |
475 µg/m3 |
Action Level |
22 August 2017 |
ASR1 |
1Hr TSP |
360 µg/m3 |
Action Level |
12 September
2017 |
ASR1 |
1Hr TSP |
332 µg/m3 |
Action Level |
12 September
2017 |
ASR1 |
1Hr TSP |
545 µg/m3 |
Limit Level |
12 September
2017 |
ASR1 |
1Hr TSP |
413 µg/m3 |
Action Level |
12 September
2017 |
ASR5 |
1Hr TSP |
367 µg/m3 |
Action Level |
18 September
2017 |
AQMS1 |
1Hr TSP |
473 µg/m3 |
Action Level |
27 September
2017 |
ASR5 |
1Hr TSP |
355 µg/m3 |
Action Level |
27 September
2017 |
ASR5 |
1Hr TSP |
456 µg/m3 |
Action Level |
21 October 2017 |
ASR1 |
1Hr TSP |
372 µg/m3 |
Action Level |
21 October 2017 |
ASR1 |
1Hr TSP |
439 µg/m3 |
Action Level |
27 October 2017 |
ASR5 |
1Hr TSP |
368 µg/m3 |
Action Level |
27 October 2017 |
ASR6 |
1Hr TSP |
388 µg/m3 |
Action Level |
21 October 2017 |
ASR1 |
24Hr TSP |
220 µg/m3 |
Action Level |
4.4.1
Investigation for the 1-hour and 24-hour TSP exceedance was undertaken upon received the monitoring results by the ET.
4.4.2
For the exceednances in the reporting period,
the investigation reports were submitted to all relevant parties and concluded
that those exceedances are unlikely related to the Contract work and no
corrective action was required accordingly. The detailed investigation reports and findings can
be referred to the Monthly EM&A
Reports of the contract.
5.1.1
According to the EM&A Manual
requirements, regularly inspection for Pitcher Plants at least once every week to report it growth and protection
measure situation shall be conducted
during construction period.
5.1.2
Total 181 pitcher plants
were transplanted to final receptor site and the rest of the Pitcher Plant
individuals (certified dead by the specialist) were not transplanted and were
treated as general refuse. All the transplantation of pitcher plant from the
nursery site to final receptor site was completed on 10th September
2015.
5.2.1
A total 53 occasions of inspection were carried out by the Contractor and ET during
the Reporting Period.
5.2.2
Establishment period for the pitcher plants was completed
at the end of September 2016, the join site completion of Establishment period
visit with AFCD was undertaken on 23 September 2016 and the final pitcher
plants report was submitted to AFCD on early December
2016. Therefore after 23 September 2016, only the integrity of the protection
fence was checked to fulfil the EIA requirement. During each inspection, the protection
mitigation measures were
checking at the final receptor area to make sure no site activities was
undertaken inside the protection zone. Besides, no construction activities were observed to be carried
out at the surrounding of the final receptor area. The condition of chain link fence is
good and no repair or maintenance is required.
5.2.3
No matters the completion of establish period, the
Contractor should properly maintain the fencing along the receptor area to
avoid disturbance to the pitcher plants under the EIA requirement.
6.1.1
According to the EM&A Manual requirements,
regular inspection for heritage resource Grave G1 shall be audited by the ET at
least once every week to ensure recommended mitigation measures implemented
during construction period. The aim
of the survey is prevention of any possible damage to the grave and to ensure
that proposed mitigation measures are implemented. The broad scope of the audit
will involve supervision of the following:
Non-contact effects of
the engineering works, such as vibration from pneumatic drills which could cause
damage, such as foundation or wall cracks and loosening of tiles or fixtures;
and
Contact between the historic
structures and equipment and materials associated with the engineering works.
6.1.2
Specifically, the
monitoring programme will entail the following tasks:
The extent of the agreed
works areas should be regularly checked during the construction phase to ensure
the buffer is being maintained; and
Ensure no stockpiling or
equipment storage is affecting the structure.
6.1.3
In the event of non-compliance
the responsibilities of the relevant parties is detailed in the Event/ Action Plan
in Appendix F.
6.2.1
In this Reporting Period, there are total 53 occasions to carry out the Grave G1 inspection. During site inspection, buffer zone was observed
between the working area and the Grave and no construction
material or equipment was stored nearby the Grave.
6.2.2
Since construction works
very close to buffer zone of the Grave G1, cultural heritage mitigation measures and protection measures as provided by the Contractor, therefore has fully
implemented in accordance with EM&A Manual requirements
7.1.1
According to EM&A
Manual requirements, monitoring of Contractor¡¦s operations during construction
period to report on Contractor¡¦s compliance should be carried out on weekly
basis. Measure to mitigate landscape and
visual impact during construction should be checked and monitored by a
Registered Landscape Architect to ensure compliance with the intended aims of
the mitigation measures. Moreover, the progress
of the engineering works shall be regularly reviewed on site to identify the
earliest practical opportunities for the landscape works to be undertaken.
7.2.1
In this Reporting Period, Registered Landscape
Architect with the Contractor had undertaken a total of 52 occasions of inspection.
7.2.2
During the Reporting
Period, most of the landscape works such as planting was not yet commenced, but some transplanting works was commenced on 22 May 2017. Existing trees
on boundary of the project area were properly protected and no damage of the
existing trees were record in this Reporting Period.
Felled trees during construction were collected by a licensed collector for
recycling. The detailed inspection checklists can
be referred to
relevant Monthly EM&A Reports of the Contract.
8.1.1
During EIA study,
landfill gas hazards are likely to be generated
from the Pillar Point Valley (PPV) Landfill. Hence, regular landfill
gas monitoring is recommended during construction of the proposed toll plaza.
8.1.2
During construction, a
Safety Officer should be appointed to carry out the monitoring works. The
monitoring frequency and areas to be monitored should be set down prior to
commencement of ground-works either by the Safety Officer or an approved and appropriated
qualified person. The routine monitoring should be carried out in all excavations,
manholes, chambers, relocation of monitoring wells and any other confined
spaces that may have been created. All measurements in excavations should be
made with the extended monitoring tube located not more than 10 mm from the exposed
ground surface. Monitoring should be performed properly to make sure that the
area is free of landfill gas before any man enters in the area.
8.1.3
For excavations deeper
than 1m, measurements should be carried out:
at the ground surface
before excavation commences;
immediately before any
worker enters the excavation;
at the beginning of each
working day for the entire period the excavation remains open; and
periodically through the working day
whilst workers are in the excavation.
8.1.4
For excavations between
300mm and 1m deep, measurements should be carried out:
directly after the
excavation has been completed; and
periodically whilst the
excavation remains open
8.1.5
For excavations less
than 300mm deep, monitoring may be omitted, at the discretion of the Safety
Officer or other appropriately qualified person.
8.1.6
To ensure the accuracy
of the monitoring data, zeroing of the gas analyser
shall be undertaken at the start of each day¡¦s monitoring. As part of the QA/QC, calibration of the
gas analyser shall be conducted at least once every
two weeks according to the specification of the manufacturer¡¦s operation
manual.
8.1.7
The landfill
consultation zone was divided into 6 monitoring zones. The landfill gas
monitoring zones are summarized in Table 8-1 and the layout plan for the
monitoring zone is illustrated in Appendix E.
Table
8-1 Landfill
Gas Monitoring Zone
ID |
Location |
Excavation >300mm deep undertaken in this reporting period |
TD1 |
TD1, Retaining Wall A, Grave
G1 and Subway |
Yes |
RW-B |
Retaining Wall B |
No |
RW-F |
Retaining Wall F |
No |
S&U |
Slope and Underpass |
No |
BW |
Bridge Works (G2,
H1) |
No |
LMR |
Lung Mun
Road |
Yes (Till 21 August 2017) |
8.2.1
In the past twelve months, landfill gas
monitoring was conducted at monitoring zone TD1 & LMR between November 2016 and October 2017. For the monitoring zone LMR, the excavation works was temporary
completed on 21 August 2017, therefore the landfill gas monitoring at LMR was
suspended after 21 August 2017. A BIOGAS
5000 gas analyser was used for the landfill gas
monitoring.
8.2.2
There were total 295 monitoring days carried out by the Safety Officer or an approved and
qualified persons. Landfill gas measurement results in the
past twelve months are summarized in Table 8-2. Moreover, graphical plot are attached in
Appendix G.
Table 8-2 Summary of Landfill
Gas Measurement Results in this Annual for TD1 & LMR
Para. |
Action Level |
Limit Level |
In
Period |
Detectable
at TD1 |
Detectable at LMR |
||
Min |
Max |
Min |
Max |
||||
Methane |
>10% LEL (>0.5% v/v) |
>20% LEL (>1% v/v) |
Nov 2016 to Jan 2017 |
0.1% |
0.1% |
0.1% |
0.1% |
Feb 2017 to Apr 2017 |
0.1% |
0.1% |
0.1% |
0.1% |
|||
May 2017 to Jul 2017 |
0.1% |
0.1% |
0.1% |
0.1% |
|||
Aug 2017 to Oct 2017 |
0.1% |
0.1% |
0.1% |
0.1% |
|||
Oxygen |
<19% |
<18% |
Nov 2016 to Jan 2017 |
21.0% |
21.1% |
21.0% |
21.1% |
Feb 2017 to Apr 2017 |
21.0% |
21.1% |
21.0% |
21.1% |
|||
May 2017 to Jul 2017 |
21.0% |
21.1% |
21.0% |
21.1% |
|||
Aug 2017 to Oct 2017 |
19.2% |
21.1% |
20.1% |
21.1% |
|||
Carbon Dioxide |
>0.5% |
>1.5% |
Nov 2016 to Jan 2017 |
0.1% |
0.2% |
0.1% |
0.2% |
Feb 2017 to Apr 2017 |
0.1% |
0.2% |
0.1% |
0.2% |
|||
May 2017 to Jul 2017 |
0.1% |
0.2% |
0.1% |
0.2% |
|||
Aug 2017 to Oct 2017 |
0.1% |
0.2% |
0.1% |
0.2% |
8.2.3
The measurement results shown that slightly
methane concentration was detected and all oxygen concentration was measured
between 19.2% and 21.1% and Carbon Dioxide was between 0.1 % and 0.2 %. No corrective action was required
accordingly.
9.1.1
Waste management was carried out by an
on-site Environmental Officer or an Environmental Supervisor from time to time.
The effective management of waste arisings during the
construction phase will be monitored through the site audit programme. The aims
of the waste audit are:
l to ensure
the waste arising from the works are handled, stored, collected, transferred
and disposed of in an environmentally acceptable manner; and
l to encourage the reuse and recycling of material.
9.1.2
In addition to the site inspections, the ET
shall review the documentation procedures prepared by the Waste Coordinator
once a week to ensure proper records are being maintained and procedures undertaken
in accordance with the Waste Management Plan.
9.2.1
All types of waste arising from the
construction work are classified into the following:
l Construction
& Demolition (C&D) Material;
l Chemical
Waste;
l General
Refuse; and
l Excavated
Soil.
9.2.2
In the past twelve months, total quantities
of waste disposal are summarized in Tables 9-1 and 9-2.
Table 9-1 Summary of
Quantities of Inert C&D Materials
Type of Waste |
Quantity |
Total |
Disposal
Location |
|||
Nov 2016 ¡V Jan 2017 |
Feb 2017 ¡V Apr
2017 |
May 2017 ¡V Jul
2017 |
Aug 2017 ¡V Oct 2017 |
|||
Reused in this
Contract (Inert) (`000m3) |
17.291 |
5.473 |
4.839 |
2.889 |
30.492 |
- |
Reused in other Projects (Inert) (`000m3) |
32.067 |
30.748 |
15.663 |
2.596 |
81.074 |
• TM-CLKL
C2 HY/2012/08 • Lam Tei
Quarry • Eco Park K.wah Recycle Facilities • Lung Kwu
Tan Tailor Recycled Aggregates • Laintang BCP |
Disposal as Public
Fill (Inert) (`000m3) |
3.031 |
7.078 |
2.250 |
3.149 |
15.508 |
Tuen Mum Area 38 |
Table 9-2 Summary
of Quantities of C&D Wastes
Type of Waste |
Quantity |
Total |
Disposal Location |
|||
Nov 2016 ¡V Jan 2017 |
Feb 2017 ¡V Apr
2017 |
May 2017 ¡V Jul
2017 |
Aug 2017 ¡V Oct 2017 |
|||
Recycled Metal
(`000kg) |
0 |
0 |
0 |
0 |
0 |
- |
Recycled
Paper / Cardboard Packing (`000kg) |
0 |
0 |
0 |
0 |
0 |
- |
Recycled
Plastic (`000kg) |
0 |
0 |
0 |
0 |
0 |
- |
Chemical
Wastes (`000kg) |
0.030 |
0 |
0 |
0 |
0.030 |
Licensed collector |
General
Refuses (`000m3) |
0.511 |
0.570 |
0.592 |
0.594 |
2.267 |
WENT |
9.2.3
Whenever possible, materials were reused
on-site as far as practicable.
10.1.1
According to the approved EM&A Manual,
the environmental site inspection shall be formulation by ET Leader. Weekly environmental site inspections
should carry out to confirm the environmental performance.
Findings / Deficiencies During
Reporting Period
10.1.2
In the past twelve months, total 53 events of joint site inspection to evaluate site environmental
performance has been carried out by the RE, ET and the Contractor. Moreover, IEC or ENPO
attended total 12 occasion¡¦s joint site inspection. The quantity of reminders/observations is summarized in Table 10-1.
Table
10-1 Summary
of Reminders/Observations of Site Inspection for the Annual
Reporting Period |
Date of site inspection |
Nos. of findings / reminders |
|
November 2016 |
1st, 8th, 15th, 22nd and 29th November 2016 |
10 |
Completed |
December 2016 |
6th, 13th, 20th and 28th December 2016 |
5 |
Completed |
January 2017 |
3rd, 10th, 17th and 24th January 2017 |
8 |
Completed |
February 2017 |
2nd, 7th, 14th, 21st and 28th February 2017 |
5 |
Completed |
March 2017 |
7th, 14th, 21st and 28th March 2017 |
7 |
Completed |
April 2017 |
3rd, 11th, 18th and 25th April 2017 |
8 |
Completed |
May 2017 |
4th, 9th, 16th, 23rd and 31st May 2017 |
7 |
Completed |
June 2017 |
6th, 14th, 20th and 27th June 2017 |
6 |
Completed |
July 2017 |
4th, 11th, 18th and 25th July 2017 |
11 |
Completed |
August 2017 |
1st, 8th, 15th, 22nd and 29th August 2017 |
3 |
Completed |
September 2017 |
5th, 12th, 19th and 27th September 2017 |
9 |
Completed |
October 2017 |
3rd, 10th, 17th, 24th and 31st October 2017 |
12 |
Completed |
10.1.3
In the past twelve months, there are no non-compliance recorded, however, 91 observations/ reminders were recorded
during the site inspections. The minor deficiencies found in the weekly
site inspections were in general rectified within the specified deadlines. The environmental performance of the
Project was therefore considered satisfactory.
11.1.1
For the Contract, no summons and prosecution
was received in the Reporting Period. However, there are two environmental complaints and 16 exceedances of action / limit levels recorded during the
Reporting Period. The statistical
summary table of environmental exceedance, complaint, summons and prosecution is
presented in Tables 11-1, 11-2, 11-3 and 11-4.
Table 11-1 Statistical Summary of
Environmental Exceedance
Reporting Period |
Environmental
Aspect |
Exceedance
Statistics |
||
Action |
Limit |
|||
1 November 2016 ¡V 31 October 2017 |
Air Quality |
1-hour TSP |
14 |
1 |
24-hour TSP |
1 |
0 |
||
Landfill Gas |
Methane |
0 |
0 |
|
Oxygen |
0 |
0 |
||
Carbon Dioxide |
0 |
0 |
Table 11-2 Statistical Summary of
Environmental Complaints
Reporting Period |
Complaint Nature |
Total Registered |
|||
Water Quality |
Construction Dust |
Construction Noise |
Others |
||
1 November 2016 ¡V 31
October 2017 |
NA |
29 September 2017 |
NA |
24 October 2017 |
2 |
Table 11-3 Statistical Summary of
Environmental Summons
Reporting Period |
Environmental
Summons Statistics |
|||
Cumulative |
Complaint Nature |
|||
Air |
Noise |
Water |
||
1 November 2016 ¡V 31 October 2017 |
0 |
NA |
NA |
NA |
Table 11-4 Statistical Summary of Environmental
Prosecution
Reporting Period |
Environmental
Prosecution Statistics |
|||
Cumulative |
Complaint Nature |
|||
Air |
Noise |
Water |
||
1 November 2016 ¡V 31 October 2017 |
0 |
NA |
NA |
NA |
11.2.1
During the complaint investigation work, the
Contractor was co-operated with the ET in providing all the necessary
information and assistance for completion of the investigation. Investigation
reports for the complaints have completed by the ET and submitted to all
relevant parties and they are summarized in below.
Complaint received on 29 September 2017:
A complaint was received from the EPD on 29 September 2017. The complainant complained that no water
spraying for road works to cause construction dust emission at Lung Mun Road across from warehouse near Tuen
Mun River Trade Terminal. After the investigation it
was concluded that the complaint was project related, the improvement works for
dust mitigation had been completed by contractor. The detailed investigation report
can be referred to the Monthly EM&A Reports (October 2017) of the contract.
Complaint received on 25 October 2017:
A complaint was received from the EPD on 24 October 2017 by District Councillor Mr. YAN Siu-nam. The District Councillor
represents the resident who living at Tuen Mun Ferry Pier area to complain that light nuisance created
by Tuen Mun - Chek Lap Kok Link Project during
mid-night to cause serious impact for their rest. Also, the complainant query
the schedule for the construction works and the mitigation measures to avoid
light nuisance affect to the resident. After the investigation it was concluded
that the complaint was not project related. The detailed investigation report
can be referred to the Monthly EM&A Reports (November 2017) of the
contract.
Inspection Checklist for Vulnerable to
Contaminated Water Discharge
11.2.2
Following the complaint about discharge of
milky water to Bufferfuly Beach on 2 September 2015, the Contractor proposed to carry out
daily inspection of wastewater treatment facilities, concerned discharge
points, drainage inlets and outlets during typhoon or wet season.
11.2.3
In addition, specific inspections would also
be conducted before and after adverse weather to ensure necessary remedial
works would be carried out timely. Should incidental contaminated water
discharge be found at the inlet of the associated drainage system, a specific
inspection of the relevant drainage pipes would be conducted for traces of
deposit, and follow up actions would be taken when necessary.
11.2.4
The daily inspection for vulnerable to contaminated water discharge was
conducted by the Contractor between 1 to 30 November 2016 and 11 April to 31 October 2017. As
requested by the EPD, the associated inspection checklist should be presented
in the respective Monthly EM&A Report.
12.1.1
The environmental mitigation measures that
recommended in the Environmental Mitigation Measures Implementation Schedule (EMMIS) in the
Project EM&A Manual covered the issues of Air Quality, Cultural Heritage, Ecology, Landfill Gas Hazard, Landscape & Visual,
Noise, Water and Waste and they are presented in Appendix H.
12.1.2
In the past twelve months, environmental
mitigation measures generally implemented by the Contract are listed in Table
12-1.
Table 12-1 Environmental Mitigation
Measures
Issues |
Environmental Mitigation Measures |
Air Quality |
¡P Maintain damp / wet surface
on access road ¡P Keep slow speed in the sites ¡P All vehicles must use wheel
washing facility before off site ¡P Sprayed water during rock
breaking works ¡P During transportation by truck, materials loaded lower
than the side and tail boards, and covered before transport ¡P Compacted all soil stockpiles ¡P Part of the exposed slopes covered geotextile net |
Cultural Heritage |
¡P Set a buffer zone between the working area
and the Grave ¡P All construction materials and equipment store far from
the Grave ¡P Inspection the Grave to ensure provision mitigation
measures effective |
Ecology |
¡P
Wire fencing provided
for temporary protect Pitcher Plants ¡P
Undertake weekly
inspection of Pitcher Plants |
Landfill Gas Hazard |
¡P
Landfill Gas
measurement undertake during trench excavation |
Water Quality |
¡P Temporary drainage system
provide for surface runoff prevent discharge to public area ¡P Wastewater to be treated by
sedimentation tank before discharge. |
Noise |
¡P No
operation of powered mechanical equipment is allowed during restricted hours
from 19:00 to 07:00 on the following day and whole day during Sunday and
public holiday without construction noise permit (CNP) ¡P Keep good maintenance of
plants ¡P The noisy plants or works provide
mobile noise barriers ¡P Shut down the plants when
not in use |
Waste and Chemical
Management |
¡P On-site sorting prior to
disposal ¡P Follow requirements and
procedures of the ¡§Trip-ticket System¡¨ ¡P
Predict required quantity of concrete accurately ¡P Collect the unused fresh concrete at designated
locations in the sites for subsequent disposal |
General |
¡P The site was generally kept
tidy and clean. |
13.1.1
This is 3rd Annual EM&A Review Report
presenting the monitoring results and inspection findings for the Reporting Period from 1 November 2016 to 31 October 2017.
13.1.2
In the Reporting Period, total 14 Action Level and 1 Limit Level exceedances of 1-hour TSP were recorded; 1 Action Level exceedance of 24-hour
TSP was recorded.
13.1.3
In this Reporting Period, no noise complaint was received by RE, the Contractor, ENPO or HyD. No Action Level exceedances were triggered and no NOE or the associated corrective actions were therefore issued.
13.1.4
Site inspection for landscape and visual was
conducted on weekly basis by the Landscape Architect to ensure the compliance
of the intended aims of the mitigation measures. Most of the landscape works
such as planting was not yet commenced.
13.1.5
Landfill gas monitoring was conducted at TD1 & LMR between
November 2016 and October 2017 by the
Safety Officer. The monitoring
results shown no exceedances were triggered.
13.1.6
No notifications of
summons or successful prosecution were received during the Reporting
Period. However, one complaint about the air quality issue and
one complaint about the night-time light nuisance were received during the
Reporting Period. Investigations were conducted and the
follow-up actions corresponding to the mitigation measures recommended were
undertaken by the Contractor to resolve the environmental deficiencies
13.1.7
Joint site
inspection by the RE, ET and CRBC-Kaden JV was carried in accordance with the EM&A Manual. Moreover, the IEC
attended a total of 12 joint site
inspections during the Reporting Period. No
non-compliance was recorded during the site inspection but total 91 observations/reminders were recorded
in the past twelve months. All the deficiencies
were rectified before next site inspection
date.
13.1.8
A total 53 occasions of Pitcher Plant inspection were carried out by the Contractor
and ET during the Reporting Period
at the final receptor site. Establishment period for the
pitcher plants was completed at the end of September 2016, the join site
completion of Establishment period visit with AFCD was undertaken on 23
September 2016 and the final pitcher plants report was submitted to AFCD on early December 2016. Therefore after 23 September 2016, only the
integrity of the protection fence was checked to fulfil the EIA requirement.
During each inspection, the protection mitigation measures were checking at the final receptor area to
make sure no site activities was undertaken inside the protection zone. Besides, no construction
activities were observed to be carried out at the surrounding of the final
receptor area. The condition of
chain link fence is good and no repair or maintenance is required.
13.1.9
For cultural heritage in the past twelve months,
the buffer zone between the working area
and the Grave was observed and no construction material or equipment was stored
nearby.
13.2.1
The construction phase
monitoring programme ensured that any environmental impact to the receivers
would be readily detected and timely actions could be taken to rectify any
non-compliance. Assessment and
analysis of monitoring results collected demonstrated the environmental
acceptability of the Project. The
regular site inspection and waste audit ensured that all the mitigation
measures on waste management were effectively implemented.
13.2.2
The EM&A programme
effectively monitored the environmental impacts from the construction phase of
the Project and no particular recommendation was advised for the improvement of
the programme.
13.2.3
It is considered that
the environmental acceptability of the Contract in the past twelve months was satisfactory and acceptable.
