Executive Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
1.5 Summary of EM&A Programme Requirements
2.1 Air quality
2.2 Landfill Gas Hazard Monitoring
2.3 EM&A Site Inspection
2.4 Waste Management Status
2.5 Environmental Licenses and Permits
2.6 Implementation Status of Environmental Mitigation Measures
2.7 Summary of Exceedances of the Environmental Quality Performance Limit
2.8 Summary of Complaints, Notification of Summons and Successful Prosecutions
3 Comparison of EM&A Results with EIA Predictions and Baseline Monitoring Results
3.1 Air Quality Monitoring
3.2 Landfill Gas Hazard Monitoring
3.3 Waste Management
3.4 Summary of Monitoring Methodology and Effectiveness
3.5 Summary of Mitigation Measures
4.1 Key Issues for the coming period
5 Conclusions and recommendations
5.1 Conclusions
List of Appendices
Appendix A Project Organization for Environmental Works
Appendix B Implementation Schedule of Environmental Mitigation Measures (EMIS)
Appendix C Summary of Action and Limit Levels
Appendix E Landfill Gas Monitoring Graphical Presentation
Appendix F Summary of Waste Flow Table
Under Contract No. HY/2017/10, Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake Northern Connection Tunnel Buildings, Electrical and Mechanical Works of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM Asia Company Limited was appointed by HyD as the Engineer. For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET) in accordance with Environmental Permit No. EP-354/2009/A. Ramboll Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO). Subsequent applications for variation of environmental permits (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
The construction phase of the Contract commenced on 7 June 2018 and will tentatively be completed by 2021. The impact monitoring of the EM&A programme, including air quality and environmental site inspections, were commenced on 7 June 2018.
This is the First Annual EM&A Report presenting the EM&A works carried out during the period from 1 June 2018 to 31 May 2019 for the Contract No. HY/2017/10 Northern Connection Tunnel Buildings, Electrical and Mechanical Works (the “Contract”) in accordance with the Updated EM&A Manual of the TM-CLK Link Project. As informed by the Contractor, major activities in the reporting period included:
Land-based Works
· Site preparation works, Bar bending, Timber formwork, Concreting, Electrical and Mechanical Works and Architectural Builder’s Work and Finishes at Toll Control Building;
· Bar bending and Timber formwork, Architectural, Builder’s Work and Finishing, Electrical and Mechanical Works at Ventilation Plant Room;
· ER’s and the Contractor’s site offices erection at WA18;
· Additional land ground investigation (GI), Socket H-pilling, Excavation and Building Structure at Administration Building, Trial pits and laboratory testing;
· Electrical and Mechanical Works at North Ventilation Building;
· Additional land ground investigation (GI), Socket H-pilling, Excavation and Building Structure at Maintenance Depot, Trial pits and laboratory testing;
· Pre-drilling, Socket H-piling, Excavation and Building Structure at Customs & Excise Department Building;
· Trial pits, Pre-drilling, Socket H-piling, Excavation and Building Structure at Fire Service Department Building;
· Electrical and Mechanical Works and Architectural Builders’ Works and Finishes at Kiosk N2;
· Electrical and Mechanical Works and Architectural Builder's Work and Finishes at Underpass at C3 area;
· Electrical and Mechanical Works at the Tunnel; and
· Excavation and Building Structure at Satellite Control Building.
A summary of monitoring and audit activities conducted in the reporting period is listed below ([1]):
24-hour TSP Monitoring 117 sessions
1-hour TSP Monitoring 117 sessions
Landfill Gas Hazard Monitoring 65 days
Joint Environmental Site Inspection 52 sessions
Summary of Breaches of Action/Limit Levels
Breaches of Action and Limit Levels for Air Quality
Twenty-five (25) Action Level and two (2) Limit Level exceedances of 1-hour TSP and two (2) Action Level exceedance of 24-hour TSP were recorded by the Environmental Team of Contract No. HY/2012/08 during the reporting period. No Limit Level exceedance of 24-hour TSP was recorded.
Breaches of Action and Limit Levels for Landfill Gas Hazard Monitoring
No exceedance of Action and Limit Level exceedance was recorded for landfill gas hazard monitoring in the reporting period.
Environmental Complaints, Non-compliance & Summons
There was one (1) environmental complaint received from EPD in the reporting period. No notification of summons or successful prosecution was received in the reporting period.
Reporting Change
There was no reporting change in the reporting period.
Future Key Issues
Potential environmental impacts arising from the upcoming construction activities are mainly associated with dust, waste management and landfill gas monitoring issues.
According to the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be operating beyond capacity after 2016. This forecast has been based on the estimated increase in cross boundary traffic, developments in the Northwest New Territories (NWNT), and possible developments in North Lantau, including the Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.
An Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report (EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4 November 2009, and EP variation (VEP) (EP-354/2009/A) was issued on 8 December 2010. Subsequent applications for variation of environmental permits (VEPs), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
Under Contract No. HY/2017/10, Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the Northern Connection Tunnel Buildings, Electrical and Mechanical Works of TM-CLKL while AECOM Asia Company Limited was appointed by HyD as the Engineer. For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET). Ramboll Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO).
The construction phase of the Contract commenced on 7 June 2018 and will be tentatively completed by 2021. The impact monitoring phase of the EM&A programme, including air quality and environmental site inspections, commenced on 7 June 2018.
The general layout plan of the Contract components is presented in Figures 1.1 & 1.2a to c.
The organization structure of the Contract is shown in Appendix A. The key personnel contact names and contact details are summarized in Table 1.1 below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD (Highways Department) |
Project Coordinator |
Joseph Lee |
2762 4958 |
3188 6614 |
|
Senior Engineer |
Cheng Pan
|
2762 3383 |
3188 6614 |
ER (AECOM Asia Company Limited)
|
Principle Resident Engineer |
S. W. Fok |
2293 6200 |
2293 6300 |
|
Resident Engineer
|
Desmond Fung |
2293 6200 |
2293 6300 |
ENPO / IEC (Ramboll Hong Kong Ltd.) |
ENPO Leader
|
Y.H. Hui |
3465 2850 |
3465 2899 |
IEC
|
Dr. F.C. Tsang |
3465 2851 |
3465 2899 |
|
Contractor (Gammon Construction Limited) |
Site Agent
|
Kenneth Tai |
9039 4723 |
- |
Environmental Officer |
Max Poon |
9103 6303 |
- |
|
|
|
|
|
|
ET (ERM-HK) |
ET Leader |
Dr. Jasmine Ng |
2271 3311 |
2723 5660 |
As informed by the Contractor, details of the major works carried out in this reporting period are listed below:
Land-based Works
· Site preparation works, Bar bending, Timber formwork, Concreting, Electrical and Mechanical Works and Architectural Builder’s Work and Finishes at Toll Control Building;
· Bar bending and Timber formwork, Architectural, Builder’s Work and Finishing, Electrical and Mechanical Works at Ventilation Plant Room;
· ER’s and the Contractor’s site offices erection at WA18;
· Additional land ground investigation (GI), Socket H-pilling, Excavation and Building Structure at Administration Building, Trial pits and laboratory testing;
· Electrical and Mechanical Works at North Ventilation Building;
· Additional land ground investigation (GI), Socket H-pilling, Excavation and Building Structure at Maintenance Depot, Trial pits and laboratory testing;
· Pre-drilling, Socket H-piling, Excavation and Building Structure at Customs & Excise Department Building;
· Trial pits, Pre-drilling, Socket H-piling, Excavation and Building Structure at Fire Service Department Building;
· Electrical and Mechanical Works and Architectural Builders’ Works and Finishes at Kiosk N2;
· Electrical and Mechanical Works and Architectural Builder's Work and Finishes at Underpass at C3 area;
· Electrical and Mechanical Works at the Tunnel; and
· Excavation and Building Structure at Satellite Control Building.
The locations of the construction activities are shown in Figure 1.3. The Environmental Sensitive Receivers in the vicinity of the Contract are shown in Figure 1.4.

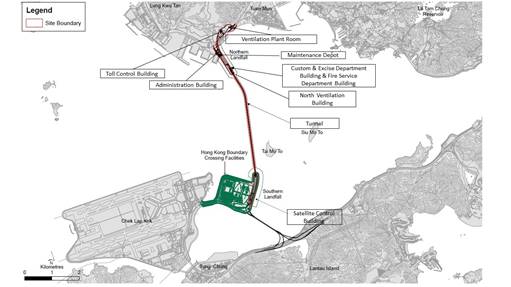

Figure 1.3 Locations of Major Construction Activities in the Reporting Period
The EM&A programme required environmental monitoring for air quality and environmental site inspections for air quality, waste management and landscape and visual impacts. The EM&A requirements and related findings for each component are described in the following sections, which include:
· Monitoring parameters;
· Action and Limit levels for all environmental parameters;
· Event Action Plan;
· Tested environmental impact hypotheses;
· Environmental mitigation measures, as recommended in the approved EIA Report; and
· Environmental requirement in contract documents.
The EM&A programme required environmental monitoring for air quality and environmental site inspections for air quality, waste management and landscape and visual impacts. The EM&A requirements and related findings for each component are summarized in the following sections
In accordance with the Updated EM&A Manual and the Enhanced TSP Monitoring Plan, impact 1-hour TSP monitoring was conducted three (3) times every six (6) days and impact 24-hour TSP monitoring was carried out once every six (6) days when the highest dust impact was expected. 1-hr and 24-hr TSP monitoring frequency was increased to three times per day every three days and daily every three days, respectively, as excavation works for launching shaft under Contract No. HY/2012/08 Tuen Mun-Chek Lap Kok Link – Northern Connection Sub-sea Tunnel Section commenced on 24 October 2014.
Results of air quality monitoring were adopted from the published EM&A data of Contract No. HY/2012/08 Tuen Mun-Chek Lap Kok Link – Northern Connection Sub-sea Tunnel Section ([2]).
The locations of the monitoring stations overlapped with Contract No. HY/2012/08 are shown in Figure 2.1 and presented in Table 2.1.
Table 2.1 Locations of Impact Air Quality Monitoring Stations and its Corresponding Monitoring Requirements
Monitoring Station |
Monitoring Period |
Location |
Description |
Parameters & Frequency |
ASR1 |
From 1 June 2018 to 31 May 2019 |
Tuen Mun Fireboat Station
|
Office |
TSP monitoring 1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3 times in every 6 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 6 days Enhanced TSP monitoring (commenced on 24 October 2014 under Contract No. HY/2012/08) 1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3 times in every 3 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 3 days |
ASR5 |
|
Pillar Point Fire Station
|
Office |
|
AQMS1 |
|
Previous River Trade Golf
|
Bare ground |
|
ASR6 |
|
Butterfly Beach Laundry
|
Office |
|
ASR10 |
|
Butterfly Beach Park |
Recreational uses |
Twenty-five (25) Action Level and two (2) Limit Level exceedances of 1-hour TSP and two (2) Action Level exceedance of 24-hour TSP were recorded by the Environmental Team of Contract No. HY/2012/08 during the reporting period. The exceedances were considered not related to this Contract upon further investigation and the investigation reports were presented in Appendix G of the Third to Seventh and Ninth Monthly EM&A Reports and Appendix J of the Eighth, Tenth and Twelfth Monthly EM&A Reports. No action is required to be undertaken in accordance with the Event Action Plan as presented in Appendix D.
In accordance with the Updated EM&A Manual of the TM-CLK Link Project, landfill gas hazard monitoring should be perform to ensure that the works area at Pillar Point Valley (PPV) Landfill is free of landfill gas during any excavations works. A total of 65 days of landfill gas hazard monitoring was conducted during the reporting period.
The schedules for landfill gas hazard monitoring were provided in the Eighth, Tenth to Twelfth Monthly EM&A Reports.
Results for landfill gas hazard monitoring are summarized in Table 2.2 and the monitoring results were presented graphycally in Appendix E.
No exceedance of Action and Limit Levels for methane, oxygen and carbon dioxide was recorded in the reporting period.
Table 2.2 Summary of Landfill Gas Hazard Monitoring Results in the Reporting Period
|
|
Average (%) |
Range (%) |
Action / Limit Level (%) |
January 2019, March – May 2019 |
Methane |
0 |
0 |
10/20 |
Oxygen |
20.8 |
20.7-20.9 |
19/18 |
|
Carbon Dioxide |
0.07 |
0.07-0.08 |
0.5/1.5 |
Site inspections were carried out on weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract. Fifty-two (52) site inspections were carried out in the reporting period. Key observations were summarized in the section of EM&A Site Inspection in the First to Twelfth Monthly EM&A Reports. The Contractor has rectified all of the observations identified during environmental site inspections in the reporting period.
The Contractor had submitted application form for registration as chemical waste producer under the Contract. Sufficient numbers of receptacles were available for general refuse collection and sorting.
Wastes generated during this reporting period included mainly construction wastes (inert and non-inert). Reference has been made to the waste flow table prepared by the Contractor (Appendix F). The quantities of different types of wastes are summarized in Table 2.3.
Table 2.3 Quantities of Different Waste Generated in the Reporting Period
Month/Year |
Inert C&D Materials (a) (m3) |
Inert Construction Waste Re-used (m3) |
Non-inert Construction Waste (b) (kg) |
Imported Fill (m3) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
||
|
||||||||
June 2018 |
2085 |
0 |
3,750 |
0 |
0 |
|
0 |
|
July 2018 |
830 |
0 |
15,190 |
0 |
0 |
|
0 |
|
August 2018 |
825 |
0 |
103,420 |
0 |
0 |
|
0 |
|
September 2018 |
205 |
0 |
22,150 |
0 |
0 |
|
0 |
|
October 2018 |
720 |
0 |
26,280 |
0 |
63 |
|
0 |
|
November 2018 |
3660 |
10 |
26,530 |
0 |
0 |
|
0 |
|
December 2018 |
7,592 |
602 |
33,280 |
0 |
0 |
|
0 |
|
January 2019 |
2,089 |
150 |
74,680 |
0 |
42 |
|
0 |
|
February 2019 |
2,474 |
345 |
67,230 |
0 |
49 |
|
0 |
|
March 2019 |
79 |
0 |
73,690 |
0 |
0 |
|
0 |
|
April 2019 |
13 |
0 |
56,730 |
0 |
0 |
|
0 |
|
May 2019 |
0 |
0 |
62,240 |
0 |
0 |
|
0 |
|
|
Notes: |
|||||||
|
(a) Inert construction wastes include hard rock and large broken concrete disposed as public fill. (b) Non-inert construction wastes include general refuse disposed at landfill. (c) Recyclable materials include metals, paper, cardboard, plastics, timber and others. |
The Contractor was advised to properly maintain on site C&D materials and waste collection, sorting and recording system, dispose of C&D materials and wastes at designated ground and maximize reuse/ recycle of C&D materials and wastes. The Contractor was also reminded to properly maintain the site tidiness and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was reminded to treat properly and store temporarily in designated chemical waste storage area on site in accordance with the Code of Practice on the Packaging, Labelling and Storage of Chemical Wastes.
The status of environmental licensing and permit is summarized in Table 2.4 below.
Table 2.4 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
|||||
Environmental Permit |
EP-354/2009/D |
13 March 2015 |
N/A |
HyD |
Tuen Mun- Chek Lap Kok Link |
|||||
APCO Construction Dust Notification |
433493 |
14 May 2018 |
N/A |
GCL |
For Tuen Mun working area |
|||||
Construction Waste Billing Account |
7030836 |
15 May 2018 |
N/A |
GCL |
N/A |
|||||
Chemical Waste Producer Registration |
5213-422-G2827-01 |
13 June 2018 |
N/A |
GCL |
N/A |
|||||
Discharge License under WPCO for Buildings at C2 area |
WT00031783-2018 |
22 October 2018 |
31 October 2023 |
GCL |
Sampling Frequency: Bimonthly |
|||||
Discharge License under WPCO for Buildings at C3 area |
WT00032062-2018 |
30 October 2018 |
31 October 2023 |
GCL |
Sampling Frequency: Quarterly |
|||||
Construction Noise Permit |
GW-RW0262-18 |
9 July 2018 |
9 January 2019 |
GCL |
For Toll Control Building, Administration Building and WA18 |
|||||
Construction Noise Permit |
GW-RW0384-18 |
14 September 2018 |
6 March 2019 |
GCL |
For Toll Control Building, Administration Building, Maintenance Depot and WA18 |
|||||
Construction Noise Permit |
GW-RW0451-18 |
2 November 2018 |
25 April 2019 |
GCL |
For Toll Control Building, Administration Building, Maintenance Depot and WA18 |
|||||
Construction Noise Permit |
GW-RW0560-18 |
28 December 2018 |
18 June 2019 |
GCL |
For Toll Control Building, Administration Building, Maintenance Depot and WA18 |
|||||
Construction Noise Permit |
GW-RW0037-19 |
28 January 2019 |
23 July 2019 |
GCL |
For Toll Control Building, Administration Building, Maintenance Depot and WA18 |
|||||
Construction Noise Permit |
GW-RW0135-19 |
27 March 2019 |
30 September 2019 |
GCL |
For Toll Control Building, Administration Building, Maintenance Depot, FSD, C&ED, Bouundary Wall and WA18 |
|||||
Construction Noise Permit |
GW-RS0202-19 |
4 March 2019 |
3 September 2019 |
GCL |
For Kiosk S2 |
|||||
Construction Noise Permit |
GW-RS0340-19 |
18 April 2019 |
17 October 2019 |
GCL |
For Kiosk S2 |
|
||||
In response to the site audit findings, the Contractors carried out all corrective actions.
A summary of the Implementation Schedule of Environmental Mitigation Measures (EMIS) is presented in Appendix B. The necessary mitigation measures relevant to this Contract were implemented properly.
Twenty-five (25) Action Level and two (2) Limit Level exceedances of 1-hour TSP and two (2) Action Level exceedance of 24-hour TSP were recorded by the Environmental Team of Contract No. HY/2012/08 during the reporting period. The exceedances were considered not related to this Contract upon further investigation and the investigation reports were presented in Appendix G of the Third to Seventh and Ninth Monthly EM&A Reports and Appendix J of the Eighth, Tenth and Twelfth Monthly EM&A Reports. No action is required to be undertaken in accordance with the Event Action Plan as presented in Appendix D.
No exceedance of Action and Limit Levels for methane, oxygen and carbon dioxide was recorded landfill gas hazard monitoring in the reporting period.
Cumulative statistics are provided in Appendix G.
The Environmental Complaint Handling Procedure is provided in Figure 2.2.
There were one (1) complaint received from EPD. Upon investigation, there were no adequate evidences to conclude that the complaint cases were related to this Contract and the investigation report was presented in Appendix J of the Twelfth EM&A Report.
No notification of summons or successful prosecution was received in the reporting period.
The EM&A results in the reporting period are compared to the predictions from EIA Report and baseline monitoring result for the sake of reviewing the validity of EIA predictions.
Land based construction activities were conducted during the reporting period. At the same time, monitoring on air quality, landfill gas hazard monitoring and waste were undertaken per plan.
Based on the findings presented in TM-CLKL EIA study, the major sources of dust nuisance arising from the Northern Connection are related to excavation, wind erosion from reclaimed areas, open sites and stockpiling areas. Therefore, during these construction activities, the TSP monitoring frequency will be increased at all air quality monitoring stations such that any deteriorating air quality can be readily detected and timely action taken to rectify the situation. Comparison of EIA prediction, average baseline monitoring and average impact monitoring results of TSP is presented in Table 3.1.
Results of air quality monitoring were adopted from the published EM&A data of Contract No. HY/2012/08 Tuen Mun-Chek Lap Kok Link – Northern Connection Sub-sea Tunnel Section ([5]).
Table 3.1 Comparison of Impacts on Air Quality (in μg/m³) between EIA Prediction and Impact Monitoring Period
Station |
EIA Predicted Maximum |
Maximum Impact Monitoring |
Average Impact Monitoring |
Maximum Baseline Monitoring |
Average Baseline Monitoring |
ASR1 (1-hour) |
195 |
584 |
137 |
182 |
125 |
ASR1 (24-hour) |
148 |
237 |
83 |
173 |
128 |
ASR5 (1-hour) |
235 |
425 |
159 |
211 |
138 |
ASR5 (24-hour) |
133 |
196 |
93 |
249 |
167 |
AQMS1 (1-hour) |
N/A |
311 |
97 |
196 |
131 |
AQMS1 (24-hour) |
N/A |
127 |
57 |
211 |
127 |
AQMS2/ASR6 (1-hour) |
226 |
478 |
117 |
226 |
135 |
AQMS2/ASR6 (24-hour) |
153 |
191 |
70 |
221 |
166 |
ASR10 (1-hour) |
189 |
242 |
75 |
215 |
134 |
ASR10 (24-hour) |
112 |
146 |
51 |
181 |
129 |
Notes: Maximun baseline monitoring and average baseline monitoring were adopted from the published EM&A report of Contract No. HY/2012/08 Tuen Mun-Chek Lap Kok Link – Northern Connection Sub-sea Tunnel Section.
|
In accordance with the Updated EM&A Manual of the TM-CLK Link Project, landfill gas hazard monitoring should be perform to ensure that the works area at Pillar Point Valley (PPV) Landfill is free of landfill gas during any excavations works. A total of 65 days of landfill gas hazard monitoring was conducted during the reporting period.
No exceedance of Action and Limit Levels for methane, oxygen and carbon dioxide was recorded in the reporting period.
For wastes generated from the construction activities include C&D materials (inert and non-inert), chemical wastes and recyclable materials, the wastes generated were in line with the EIA predictions. The wastes were disposed of in accordance with the recommendations of the EIA.
The EM&A monitoring programme has been reviewed and was considered effective and adequate to cater for the nature of works in progress. No change to the monitoring programme was considered to be necessary.
The EM&A programme will be evaluated as appropriate in the next reporting period and improvements in the EM&A programme will be recommended if deemed necessary.
The mitigation measures stipulated in the Updated EM&A Manual were undertaken by the Contractor in the reporting period. The mitigation measures were reviewed and considered effective. No addition or change on mitigation measures was considered to be necessary.
Potential environmental impacts arising from the upcoming construction activities are mainly associated with dust, waste management and landfill gas monitoring issue.
This First Annual EM&A Report presents the findings of the EM&A activities undertaken during the period from 1 June 2018 to 31 May 2019, in accordance with the Updated EM&A Manual and the requirements of EP-354/2009/D.
Air quality (including 1-hour TSP and 24-hour TSP) was carried out in this reporting period.
Twenty-five (25) Action Level and two (2) Limit Level exceedances of 1-hour TSP and two (2) Action Level exceedance of 24-hour TSP were recorded by the Environmental Team of Contract No. HY/2012/08 during the reporting period. No Limit Level exceedance of 24-hour TSP was recorded. The exceedances were considered not related to this Contract upon further investigation and the investigation reports were presented in Appendix G of the Third to Seventh and Ninth Monthly EM&A Reports and Appendix J of the Eighth, Tenth and Twelfth Monthly EM&A Reports. No action is required to be undertaken in accordance with the Event Action Plan as presented in Appendix D.
No exceedance of Action and Limit Levels for methane, oxygen and carbon dioxide was recorded during landfill gas hazard monitoring in the reporting period.
Environmental site inspection was carried out fifty-two (52) times in the reporting period. Remedial actions recommended for the deficiencies identified during the site audits were properly implemented by the Contractor.
There was one (1) environmental complaint received from EPD in the reporting period. Upon investigation, there were no adequate evidences to conclude that the complaint cases were related to this Contract and the investigation report was presented in Appendix J of the Twelfth EM&A Report.
There was no notification of summons or successful prosecution recorded in the reporting period.
The ET will keep track on the construction
works to confirm compliance of environmental requirements and the proper
implementation of all necessary mitigation measures.
([1])
ET justification on the Contract Specific
Environmental Monitoring and Audit activities under this Contract was submitted
to ENPO on 11 September 2018
([2]) Published
EM&A data for impact air quality monitoring by Contract No. HY/2012/08
are available at: http://www.hzmbenpo.com/
([4])
Published EM&A data for impact water quality monitoring by Contract No.
HY/2012/08 are available at: http://www.hzmbenpo.com/
