Contents
1......... INTRODUCTION. 2
2......... Project
dESCRIPTION. 6
3......... Project
oRGANISATION. 8
4......... ENVIRONMENTAL
SUBMISSION. 8
5......... AIR QUALITY. 10
6......... NOISE. 20
7......... Sediment
Quality. 24
8......... Waste
management. 25
9......... Water quality. 28
10........ ECOLOGY. 42
11........ fISHERY. 48
12
CulturAL
Heritage. 53
13
Hazard
to life. 53
14
Landscape
& Visual Impact. 55
15
Site
Environmental Audit. 59
16
REPORTING.. 61
Figures
Figure
1
Location of Project Site
Figure
2
Air Quality and Noise Monitoring Stations
Figure
3
Water Quality Monitoring Station
Figure
4
Mitigation Measures of Coastal Protection Area Shoreline
Appendices
Appendix
A
Tentative Construction Works Programme, Detailed
Works Areas and Construction Works Sequence and Reclamation Layout and
Plan
Appendix B
Environmental Mitigation Measures
Implementation Schedule (EMIS)
Appendix
C Project Organisation
for Environmental Works
Appendix
D Sample Data Record Sheet for
Monitoring
Appendix
E Typical Arrangement of Silt
Curtains During Stone Column Installation
Appendix
F Sample Template for the Interim
Notifications
1
INTRODUCTION
1.1
Background
1.1.1
N.A. (Not relevant to the Hong Kong Boundary Crossing
Facilities – Reclamation Works)
Hong Kong Link Road
1.1.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
1.1.3
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
1.1.4
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
Hong King Boundary Crossing Facility
1.1.5
Contract No. HY/2010/02 – Hong
Kong-Zhuhai-Macao Bridge Hong Kong Boundary Crossing
Facilities – Reclamation Work (here below, known as “the Project”) mainly
comprises of about 130-hectare reclamation at the northeast
of the Hong Kong International Airport
of an area of about 130-hectare for
the construction of an artificial island for the development of the Hong Kong
Boundary Crossing Facilities (HKBCF), and about 19-hectare for the southern
landfall of the Tuen Mun - Chek Lap Kok Link (TMCLKL).
1.1.6
Subsequent to EIA Study Brief of
TMCLKL being prepared and based upon the proposed schemes for the Hong Kong-Zhuhai-Macao Bridge (HZMB) and HKBCF, it was decided to
integrate the TMCLKL southern landfall reclamation with the HKBCF
reclamation. It was considered that this arrangement would also provide a
cost-effective connection between the HKBCF and North Lantau.
1.1.7
The environmental
impact assessment (EIA) reports (Hong Kong
– Zhuhai – Macao Bridge Hong
Kong Boundary Crossing Facilities – EIA Report (Register No. AEIAR-145/2009)
(HKBCFEIA) and Tuen Mun – Chek Lap Kok Link – EIA Report
(Register No. AEIAR-146/2009) (TMCLKLEIA), and their environmental monitoring
and audit (EM&A) Manuals (original EM&A Manuals), for the Project were
approved by Environmental Protection Department (EPD) in
October 2009.
1.1.8
EPD subsequently
issued the Environmental Permit (EP) for HKBCF in
November 2009 (EP-353/2009) and the Variation of Environmental Permit (VEP) in
June 2010 (EP-353/2009/A), November 2010 (EP-353/2009/B),
November 2011 (EP-353/2009/C), March 2012 (EP-353/2009/D), October
2012 (EP-353/2009/E), April 2013 (EP-353/2009/F), August 2013 (EP-353/2009/G)
and January 2015 (EP-353/2009/H). Similarly, EPD issued the Environmental
Permit (EP) for TMCLKL in November 2009 (EP-354/2009) and the Variation of
Environmental Permit (VEP) in December 2010 (EP-354/2009/A), January 2014
(EP-354/2009/B), December 2014 (EP-354/2009/C) and March 2015 (EP-354/2009/D).
1.1.9
The Project is a designated project
and is governed by the current permits for the Project, i.e. the amended EPs
issued on 19 January 2015 (EP-353/2009/H) and 13 March 2015 (EP-354/2009/D)
(for TMCLKL Southern Landfall Reclamation only).
1.1.10 China Harbour Engineering
Company Limited (CHEC) was awarded by Highways Department as the Contractor to
undertake the construction work.
1.1.11 AECOM Asia Co. Ltd. (AECOM) was appointed by China Harbour Engineering Company Limited to undertake the role
of Environmental Team for the Project.

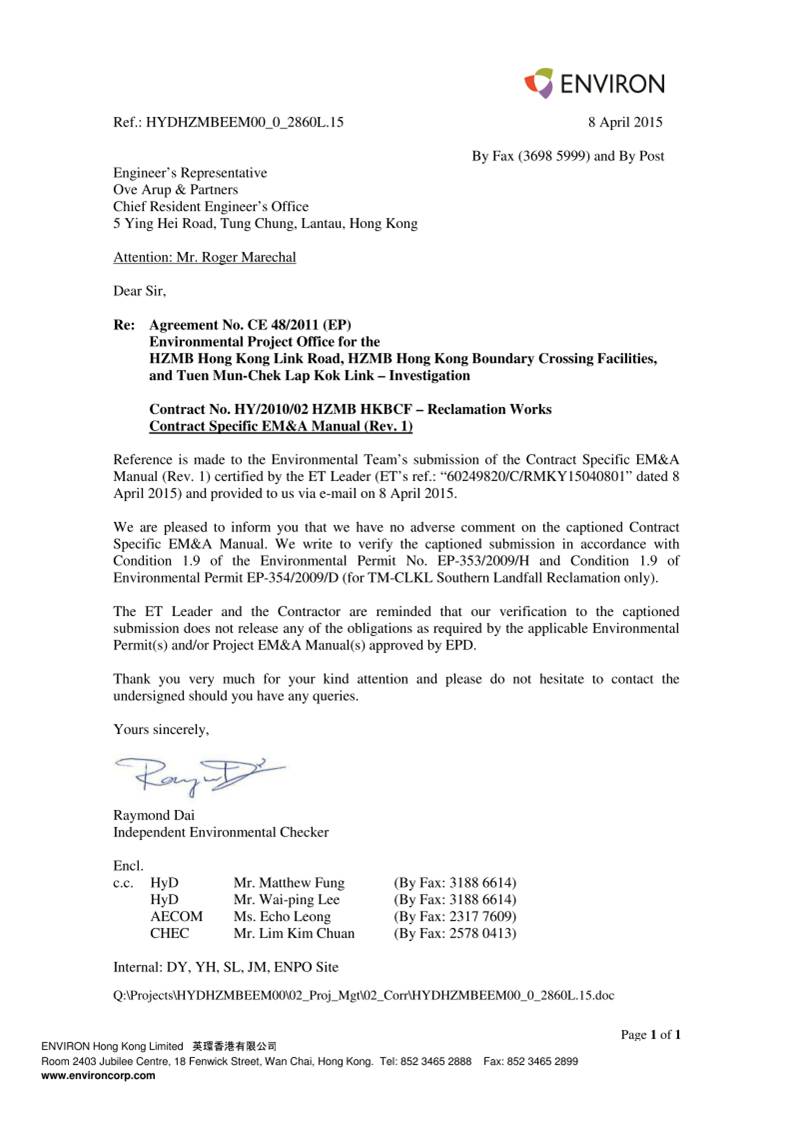

1.1.12 This Manual is submitted to fulfill the requirement
as stated in the Clause 25.30 (7) of the Particular Specification and to
include all project-relation contents from the original EM&A Manuals for
the Project. This would help to facilitate compliance with the EPs
(EP-353/2009/H and EP-354/2009/D (only for TMCLKL southern landfall
reclamation)) and for work contracts administration.
1.1.13 The Project comprises of seawall construction and
reclamation works at the northeast waters off the Airport Island to provide
land platform (about 130ha of area) for the construction of an artificial
island for the development of the boundary crossing facilities, and about
19-hectare for the southern landfall of the Tuen Mun - Chek Lap Kok Link.
1.1.14 The location of HKBCF and southern landfall reclamation
for TMCLKL is given in Figure 1.
1.2
Purposes of the Manual
1.2.1
The purposes of this Contract
Specific Environmental Monitoring and Audit (EM&A) Manual are to:
Guide the set up of an EM&A
programme to ensure compliance with the EIA recommendations;
Specify the requirements for
monitoring equipment;
Propose environmental monitoring
points, monitoring frequency etc.;
Propose Action/Limit Level; and
Propose Event/Action Plan.
1.2.2
This Contract Specific EM&A
Manual outlines the monitoring and audit programme
for the construction of the Project and provides systematic procedures for
monitoring, auditing and minimising environmental
impacts
1.2.3
Hong Kong environmental regulations
and the Hong Kong Planning Standards and Guidelines (HKPSG) was served as
environmental standards and guidelines in the preparation of this Contract
Specific EM&A Manual. In addition, this Contract Specific EM&A
Manual was prepared in accordance with the requirements stipulated in Annex 21
of the Technical Memorandum on the EIA Process (TM-EIAO) and the original
EM&A Manuals.
1.2.4
This Manual contains the following
information:
·
Responsibilities of the Contractor, the Engineer or Engineer’s
Representative (ER), Environmental Team (ET), and the Independent Environmental
Checker (IEC) under the context of EM&A;
·
Role of the Environmental Protection Office (ENPO);
·
Project organisation for the EM&A works;
·
The basis for, and description of the broad
approach underlying the EM&A programme;
·
Details of the methodologies to be adopted, including all laboratories
and analytical procedures, and details on quality assurance and quality control
programme;
·
The rationale on which the environmental
monitoring data will be evaluated and interpreted;
·
Definition of Action and Limit levels;
·
Establishment of Event and Action plans;
·
Requirements for reviewing pollution sources and working procedures
required in the event of non-compliance with the environmental criteria and
complaints; and
·
Requirements for presentation of environmental monitoring and audit data
and appropriate reporting procedures.
1.2.5
For the purpose of this manual, the
ER shall refer to the Engineer as defined in the Construction Contract, in
cases where the Engineer's powers was delegated to the ER, in accordance with
the Construction Contract. The ET leader, who shall be responsible for
and in charge of the ET, shall refer to the person
delegated the role of executing the environmental monitoring and audit
requirements.
1.2.6

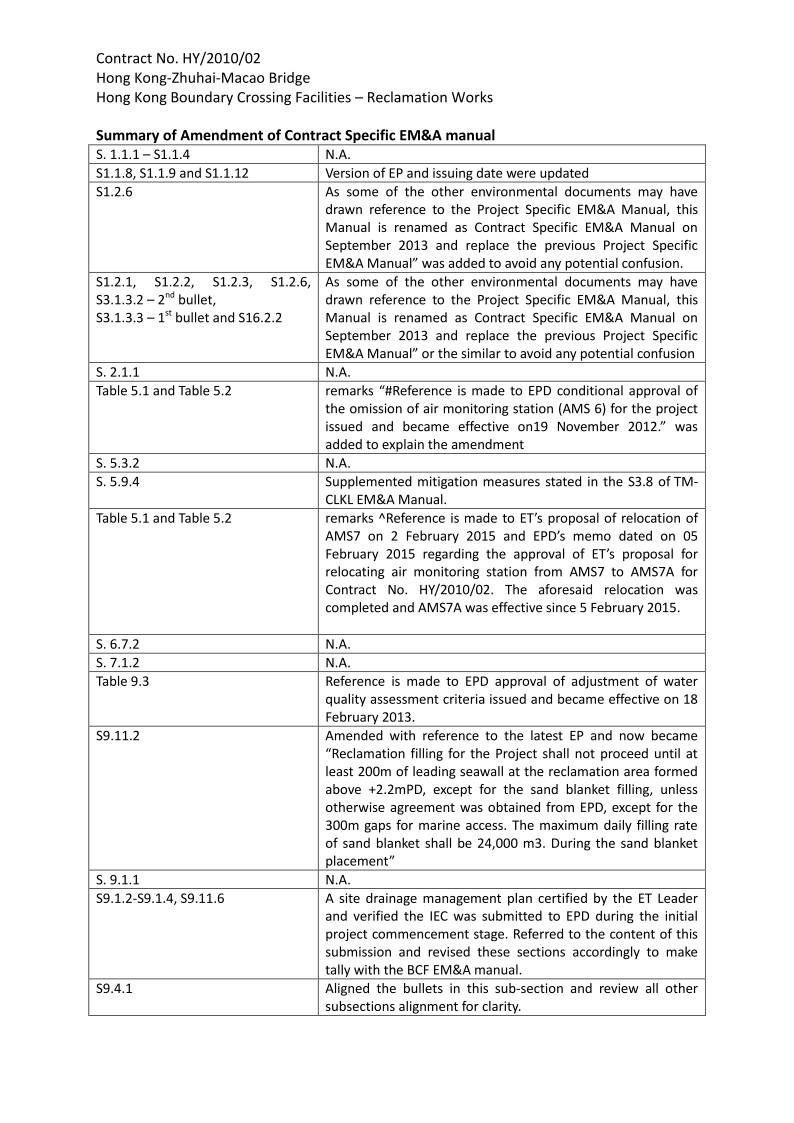

This Manual is renamed as Contract
Specific EM&A Manual on March 2014 and replace the previous Project
Specific EM&A Manual
2
PROJECT
DESCRIPTION
2.1
Project Description
Hong
Kong Link Road
2.1.1
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
Hong
Kong Boundary Crossing Facilities
2.1.2
The proposed HKBCF will comprise
the following:
i.
Reclamation
at the northeast waters off the Airport Island to provide land platform (about
130ha of area) for the development of the HKBCF,
ii.
Cargo
processing facilities including kiosks for clearance of goods vehicles, customs
inspection platform, X-ray buildings and related supporting facilities;
iii.
Passenger
related facilities including processing kiosks and examination facilities for
private cars and coaches, passengers clearance
building and halls and related supporting facilities;
iv.
Accommodation
for and facilities of the Government departments providing services in
connection with the HKBCF;
v.
(Provision
of transport and miscellaneous facilities inside the HKBCF including public
transport interchange, transport drop-off and pick-up areas, vehicle holding
areas, passenger queuing areas, road networks, footbridges, fencing, sewage and
drainage systems, water supply system, utilities, electronic system, traffic
control and information system and related supporting facilities;
vi.
Provision
of road access for connection of the HKBCF to the HZMB HKLR, the TMCLKL and the
Airport;
vii.
Reprovisioning of the affected Airport’s facilities such as the
existing FSD’s East Sea Rescue Berth; and
viii.
Provision
of other facilities for connection with the Airport such as an Automated People
Mover system to connect the Airport Terminal with the HKBCF.
2.2
Implementation Programme
2.2.1
Seawall construction and reclamation works of the
HKBCF and the southern landfall of TMCLKL will be tentatively commenced in
mid-March 2012 and will be completed by early 2016.
2.2.2
The tentative construction works programme, details of works areas and construction works
sequence and reclamation layout and plan of the Project is annexed in Appendix
A.
2.2.3
Detailed EIA assessments were
conducted and presented in the relevant EIA reports. All necessary mitigation
measures were identified and recommended in the original EM&A
Manuals. The mitigation measures which are applicable to the Project were
extracted from Environmental Mitigation Implementation Schedule in the original
EM&A Manuals and are given in Appendix B. It specifies the extent,
locations, time frame and responsibilities for the implementation of the
environmental mitigation measures identified.
2.3
Concurrent Projects During Construction Phase
2.3.1
Construction of HZMB Hong Kong Link
Road (HKLR) and TMCLKL to be commenced in Year 2012 and scheduled to open in
Year 2016 for HKLR and in Year 2017 for TMCLKL in matching the commissioning
date of HKBCF.
2.3.2
The Main Bridge of the HZMB within
the Guangdong water would also be concurrent with the construction of HKBCF and
southern landfall of TMCLKL. The tentative commissioning date is also 2016.
2.3.3
Another concurrent project during
the construction of HKBCF and southern landfall of TMCLKL is the 72 ha
reclamation for Lantau Logistics Park. This has been
considered as a concurrent project in the EIA.
1
3
Project
Organisation
3.1
Project Organisation
3.1.1
The proposed project organisation and lines of communication with respect to
environmental protection works are shown in Appendix C.
3.1.2
The leader of the ET shall be an
independent party from the Contractor and has relevant professional
qualifications, and have at least 7 years of experience in conducting EM&A
projects subject to approval of the Engineer’s Representative (ER), Independent
Environmental Checker (IEC) and EPD.
3.1.3
The responsibilities of respective
parties are:
3.1.3.1 The Contractor
· employ
an Environmental Team (ET) to undertake monitoring, laboratory analysis and
reporting of environmental monitoring and audit;
· provide
assistance to ET in carrying out monitoring and auditing;
· submit
proposals on mitigation measures in case of exceedances
of Action and Limit levels in accordance with the Event and Action Plans;
· implement
measures to reduce impact where Action and Limit levels are exceeded; and
· adhere
to the agreed procedures for carrying out complaint investigation.
3.1.3.2 Environmental Team (ET)
· set
up all the required environmental monitoring stations;
· monitor
various environmental parameters as required in the Contract Specific EM&A
Manual;
· analyse
the environmental monitoring and audit data and review the success of EM&A
programme to cost-effectively confirm the adequacy of mitigation measures
implemented and the validity of the EIA predictions and to identify any adverse
environmental impacts arising;
· carry
out site inspection to investigate and audit the Contractors' site practice,
equipment and work methodologies with respect to pollution control and
environmental mitigation, and take proactive actions to pre-empt problems;
· audit
and prepare audit reports on the environmental monitoring data and site
environmental conditions;
· report on the environmental monitoring and audit results to
the IEC, Contractor, the ER and EPD or its delegated representative;
· recommend
suitable mitigation measures to the Contractor in the case of exceedance of Action and Limit levels in accordance with
the Event and Action Plans; and
· undertake
regular on-site audits/inspections and report to the Contractor and the ER of
any potential non-compliance; and
· follow
up and close out non-compliance actions.
3.1.3.3 Engineer or Engineer’s Representative (ER)
· supervise
the Contractor’s activities and ensure that the requirements in the Contract
Specific EM&A Manual are fully complied with;
· inform
the Contractor when action is required to reduce impacts in accordance with the
Event and Action Plans;
· employ
an IEC to audit the results of the EM&A works carried out by the ET; and
· comply
with the agreed Event Contingency Plan in the event of any exceedance.
3.1.3.4 Independent Environmental Checker (IEC)
· review the EM&A works performed by the ET (at not less
than monthly intervals);
· audit
the monitoring activities and results (at not less than monthly intervals);
· report the audit results to the ER and EPD in parallel;
· review
the EM&A reports (monthly and quarterly summary reports) submitted by the
ET;
· review
the proposal on mitigation measures submitted by the Contractor in accordance
with the Event and Action Plans;
· check the mitigation measures that have been recommended in
the EIA and this Manual, and ensure they are properly implemented in a timely
manner, when necessary; and
· report
the findings of site inspections and other environmental performance reviews to
ER and EPD.
3.1.3.5 Environmental Protection Office (ENPO)
Notwithstanding
the above, given that the Tuen Mun
- Chek Lap Kok Link
(TMCLKL), HKBCF and HKLR will be constructed concurrently, an Environmental
Protection Office (ENPO) or equivalent to oversee the cumulative construction
projects in North Lantau area will be established by
the Project Proponent. The responsibility of the ENPO would be similar to
that of the IEC but should also include:
· coordinate
the monitoring and auditing works for all the on-going projects in the area in
order to identify possible sources/causes of exceedances
and recommend suitable remedial actions where appropriate;
· review
cumulative impacts including possible sources/causes of exceedance
and recommending suitable remedial actions;
·
liaise with the mainland project teams for HZMB Main Section to identify
and assess any cross-boundary cumulative impacts in order to establish suitable remedial actions
where necessary; and
· coordinate
the assessment and response to complaints/enquires from locals, green groups,
district councils or the public at large.
The exact
responsibilities and organisation of the ENPO have
been defined by the Project Proponent in accordance with the relevant
Environmental Permits.
3.1.4
Sufficient and suitably qualified
professional and technical staff shall be employed by the respective parties to
ensure full compliance with their duties and responsibilities, as required
under the EM&A programme for the duration of the
Project.
3.1.5
The ET Leader shall have at least 7
years of experience in conducting EM&A for infrastructure projects. His
qualification shall be vetted by the ER and the IEC.
4
ENVIRONMENTAL
SUBMISSION
4.1
Introduction
4.1.1
The Contractor shall prepare the Environmental
Management Plan (EMP) (including a Waste Management Plan), Construction Method
Statement and obtain approval from ER, IEC, EPD and other relevant authorities
to encompass the recommended environmental protection / mitigation measures
with respect to their latest construction methodology and programme.
4.2
Environmental
Management Plan
4.2.1
A systematic EMP shall be set up by
the Contractor to ensure effective implementation of the mitigation measures, monitoring
and remedial requirements presented in the EIA, EM&A and EMIS. The ER
and the IEC will audit the implementation status against the EMP and advise the
necessary remedial actions required. These remedial actions shall be
enforced by the ER through contractual means.
4.2.2
The EMP will require the Contractor
(together with its sub-contractors) to define in details how to implement the
recommended mitigation measures in order to achieve the environmental
performance defined in the Hong Kong environmental legislation and the EIA
documentation.
4.2.3
The review of on-site environmental
performance shall be undertaken by ER and IEC through a systematic checklist
and audit once the construction commences. The environmental performance
review programme comprises a regular assessment on
the effectiveness of the EMP. Reference should be made to ETWBTC 19 /
2005 “Environmental Management on Construction Sites” or its latest versions,
and any other relevant Technical Circulars.
4.3
Waste Management Plan
4.3.1
As part of the EMP, the Contractor
shall include a WMP for the construction of the project in accordance with the
ETWB TC(W) No. 19/2005 and submit to the ER, IEC and
EPD for approval before the commencement of the construction of the Project.
Where waste generation is unavoidable, the opportunities for recycling or
reusing should be maximised. If wastes cannot be
recycled, recommendations for appropriate disposal routes should be provided in
the WMP. A method statement for stockpiling and transportation of the
excavated materials and other construction wastes should also be included in
the WMP and approved before the commencement of construction. All
mitigation measures arising from the approved WMP shall be fully implemented.
In addition to the above, the WMP should also included
the following:
-
Waste management policy;
-
Record of generated waste;
-
Waste reduction target;
-
Waste reduction programme;
-
Role and responsibility of waste
management team;
-
Benefit of waste management;
-
Reuse, recycling an d disposal
plans;
-
Analysis of waste materials; and
-
Monitoring and action plan.
-
4.3.2
For the purpose of enhancing the
management of Construction and Demolition (C&D) materials including rock,
and minimising its generation at source, construction
would be undertaken in accordance with the Environment, Transport and Works
Bureau Technical Circular (Works) No. 33/2002 - Management of Construction and
Demolition Material Including Rock, or its latest versions. The management
measures stipulated in the Technical Circular should be incorporated into the
WMP.
4.4
Construction Method
Statement
4.4.1
In case the Contractor would like
to adopt alternative construction methods or implementation schedules, it is
required to submit details of methodology and equipment to the ER for approval
before the work commences. Any changes in construction method shall be
reflected in a revised EMP or the Contractor will be required to demonstrate
the manner in which the existing EMP should accommodate the proposed changes.
The Contractor may need to apply for a Further Environmental Permit (FEP) from
EPD before commencement of any construction activities.
5
AIR
QUALITY
5.1
Air Quality Parameters
5.1.1
Monitoring and audit of the TSP levels
shall be carried out by the ET to ensure that any deteriorating air quality
could be readily detected and timely action taken to rectify the situation.
5.1.2
One-hour and 24-hour TSP levels
should be measured to indicate the impacts of construction dust on air
quality. The 24-hour TSP levels shall be measured by following the
standard high volume sampling method as set out in the Title 40 of the Code of
Federal Regulations, Chapter 1 (Part 50), Appendix B. Upon approval of the IEC, 1-hour TSP levels
can be measured by direct reading methods which are capable of producing
comparable results as that by the high volume sampling method, to indicate
short event impacts.
5.1.3
All relevant data including
temperature, pressure, weather conditions, elapsed-time meter reading for the
start and stop of the sampler, identification and weight of the filter paper,
and any other local atmospheric factors affecting or affected by site
conditions, etc., shall be recorded down in detail. A sample data sheet
is shown in Appendix D.
5.2
Monitoring Equipment
5.2.1
High volume samplers (HVSs)
complying with the following specifications shall be used for carrying out the 1-hour
and 24-hour TSP monitoring:
a)
0.6 - 1.7 m3 per minute adjustable flow range;
b)
equipped with a timing / control device with +/- 5
minutes accuracy for 24 hours operation;
c)
installed with elapsed-time meter with +/- 2 minutes
accuracy for 24 hours operation;
d)
capable of providing a minimum exposed area of 406 cm2;
e)
flow control accuracy: +/- 2.5% deviation over 24-hour
sampling period;
f) equipped with a shelter to
protect the filter and sampler;
g) incorporated with an electronic
mass flow rate controller or other equivalent devices;
h) equipped with a flow recorder for
continuous monitoring;
i)
provided with a peaked roof inlet;
j) incorporated with a
manometer;
k)
able to hold and seal the filter paper to the sampler
housing at horizontal position;
l)
easily changeable filter; and
m)
capable of operating continuously for a 24-hour
period.
5.2.2
The ET is responsible for the provision,
installation, operation, maintenance, dismantle of the monitoring
equipment. They shall ensure that sufficient number of HVSs with an
appropriate calibration kit is available for carrying out the baseline
monitoring, regular impact monitoring and ad hoc monitoring. The HVSs
shall be equipped with an electronic mass flow controller and be calibrated
against a traceable standard at regular intervals. All the equipment,
calibration kit, filter papers, etc., shall be clearly labelled.
5.2.3
Initial calibration of dust
monitoring equipment shall be conducted upon installation and thereafter at
bi-monthly intervals. The transfer standard shall be traceable to the
internationally recognised primary standard and be
calibrated annually. The concern parties such as IEC shall properly
document the calibration data for future reference. All the data should
be converted into standard temperature and pressure condition.
5.2.4
The flow-rate of the sampler before
and after the sampling exercise with the filter in position shall be verified
to be constant and be recorded in the data sheet as mentioned in Appendix D.
5.2.5
If the ET proposes to use a direct
reading dust meter to measure 1-hour TSP levels, he shall submit sufficient
information to the IEC to prove that the instrument is capable of achieving a
comparable result to the HVS. The instrument should also be calibrated
regularly, and the 1-hour sampling shall be determined periodically by the HVS
to check the validity and accuracy of the results measured by direct reading
method.
5.2.6
Wind data monitoring equipment
shall also be provided and set up for logging wind speed and wind direction
near the dust monitoring locations. The equipment installation location
shall be proposed by the ET and agreed with the IEC. For installation and
operation of wind data monitoring equipment, the following points shall be
observed:
a)
The wind sensors should be installed 10 m above ground so that they are clear
of obstructions or turbulence caused by buildings.
b)
The wind data should be captured by a data logger. The data shall be
downloaded for analysis at least once a month.
c)
The wind data monitoring equipment should be re-calibrated at least once every
six months.
d)
Wind direction should be divided into 16 sectors of 22.5 degrees each.
5.2.7
In exceptional situations, the ET
may propose alternative methods to obtain representative wind data upon
approval from the ER and agreement from the IEC.
5.3
Laboratory Measurement
/ Analysis
5.3.1
A clean laboratory with constant
temperature and humidity control, and equipped with necessary measuring and
conditioning instruments to handle the dust samples collected, shall be available
for sample analysis, and equipment calibration and maintenance. The
laboratory should be HOKLAS accredited.
5.3.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
5.3.3
Filter paper of size 8" x
10" shall be labelled before sampling. It
shall be a clean filter paper with no pinholes, and shall be conditioned in a
humidity-controlled chamber for over 24-hours and be pre-weighed before use for
the sampling.
5.3.4
After sampling, the filter paper
loaded with dust shall be kept in a clean and tightly sealed plastic bag.
The filter paper shall then be returned to the laboratory for reconditioning in
the humidity-controlled chamber followed by accurate weighing by an electronic
balance with readout down to 0.1 mg. The balance shall be regularly
calibrated against a traceable standard.
5.3.5
All the collected samples shall be
kept in a good condition for 6 months before disposal.
5.4
Monitoring Locations
5.4.1
Figure 2 shows the locations of the proposed dust monitoring
stations. The status and locations of dust sensitive receivers may change
after issuing this manual. If such cases exist, the ET Leader shall
propose updated monitoring locations and seek approval from ER and agreement
from the IEC.
Table 5.1 Construction
Dust Monitoring Locations
ID
|
Location
|
AMS
2
|
Tung
Chung Development Pier
|
AMS
3B*
|
Site
Boundary of Site Office Area at Works Area WA2
|
AMS
6#
|
Dragonair/CNAC (Group) Building
|
AMS 7A^
|
Chu
Kong Air-Sea Union Transportation Company Limited
|
#Reference is made to ET’s
proposal of the omission of air monitoring station (AMS 6) dated on 1 November
2012 and EPD’s letter dated on 19 November 2012 regarding the conditional
approval of the proposed omission of air monitoring station (AMS 6) for
Contract No. HY/2010/02. The aforesaid omission of
Monitoring Station AMS6 was effective since 19 November 2012.
*Reference is
made to ET’s proposal of relocation of AMS3A on 24 October 2013 and EPD’s
letter dated on 06 January 2014 regarding the approval of ET’s proposal for
relocating air monitoring station from AMS3A to AMS3B for Contract No. HY/2010/02. The aforesaid relocation was completed and AMS3B
was effective since 29 Jan 14.
^Reference
is made to ET’s proposal of relocation of AMS7 on 2 February 2015 and EPD’s
memo dated on 05 February 2015 regarding the approval of ET’s proposal for
relocating air monitoring station from AMS7 to AMS7A for Contract No. HY/2010/02. The aforesaid relocation was completed and AMS7A
was effective since 5 February 2015.
5.4.2
When alternative monitoring
locations are proposed, the proposed site should, as far as practicable:
a)
be at the site boundary or such locations close to the
major dust emission source;
b)
be close to the sensitive receptors; and
c) take into account the prevailing meteorological conditions.
5.4.3
The ET shall agree with the ER in
consultation with the IEC on the position of the HVS for the installation of
the monitoring equipment. When positioning the samplers, the following
points shall be noted:
a)
a horizontal platform with appropriate support to
secure the samplers against gusty wind should be provided;
b)
no two samplers should be placed less than 2 meters
apart;
c)
the distance between the sampler and an obstacle, such
as buildings, must be at least twice the height that the obstacle protrudes
above the sampler;
d)
a minimum of 2 meters of separation from walls,
parapets and penthouses is required for rooftop samplers;
e)
a minimum of 2 meters separation from any supporting
structure, measured horizontally is required;
f)
no furnace or incinerator flue is nearby;
g)
airflow around the sampler is unrestricted;
h)
the sampler is more than 20 meters from the dripline;
i) any
wire fence and gate, to protect the sampler, should not cause any obstruction
during
monitoring;
j)
permission must be obtained to set up the samplers and
to obtain access to the monitoring stations; and
k)
a secured supply of electricity is needed to operate
the samplers.
5.4.4
The ENPO may, depending on site
conditions and monitoring results, decide whether additional monitoring
locations shall be included or any monitoring locations could be removed/relocated during any stage of the construction
phase.
5.5
Baseline Monitoring for
Fugitive Dust
5.5.1
Baseline monitoring shall be carried
out at all of the designated monitoring locations (see Table 5.1) for at least
14 consecutive days prior to the commissioning of major construction works to
obtain daily 24-hour TSP samples. The selected baseline monitoring
stations should reflect baseline conditions at the impact stations.
One-hour sampling should also be done at least 3 times per day while the
highest dust impact is expected.
5.5.2
During the baseline monitoring, there
should not be any major construction or dust generation activities in the
vicinity of the monitoring stations. Before commencing baseline
monitoring, the ET shall inform the IEC of the baseline monitoring programme such that, if required, the IEC can conduct
on-site audit to ensure accuracy of the baseline monitoring results.
5.5.3
In case the baseline monitoring
cannot be carried out at the designated monitoring locations, the ET Leader
shall carry out the monitoring at alternative locations that can effectively
represent the baseline conditions at the impact monitoring locations. The
alternative baseline monitoring locations shall be approved by the ER and
agreed with the IEC.
5.5.4
In exceptional cases, when
insufficient baseline monitoring data or questionable results are obtained, the
ET shall liaise with the IEC and EPD to agree on an appropriate set of data to
be used as a baseline reference and submit to ER for approval.
5.5.5
Ambient conditions may vary seasonally
and shall be reviewed once every three months. When the ambient
conditions have changed and a repeat of the baseline monitoring is required to
be carried out for obtaining the updated baseline levels, the monitoring should
be at times when the Contractor's activities are not generating dust, at least
in the proximity of the monitoring stations. Should change in ambient
conditions be determined, the baseline levels and, in turn, the air quality
criteria, should be revised. The revised baseline levels and air quality
criteria should be agreed with the IEC and EPD.
5.6
Impact Monitoring for
Fugitive Dust
5.6.1
The ET shall carry out impact
monitoring during the entire construction period. For regular impact
monitoring, the sampling frequency of at least once in every 6 days, shall be
strictly observed at all the monitoring stations for 24-hour TSP
monitoring. For 1-hour TSP monitoring, the sampling frequency of at least
3 times in every 6 days should be undertaken when the highest dust impact
occurs. Before commencing impact monitoring, the ET shall inform the IEC
of the impact monitoring programme such that the IEC
can conduct on-site audit to ensure accuracy of the monitoring results.
5.6.2
The specific time to start and stop
the 24-hour TSP monitoring shall be clearly defined for each location and be
strictly followed by the ET.
5.6.3
In case of non-compliance with the
air quality criteria, more frequent monitoring, as specified in the Action Plan
in the following section, shall be conducted within the specified timeframe
after the result is obtained. This additional monitoring shall be
continued until the excessive dust emission or the deterioration in air quality
is rectified, and agreed with the ER and the IEC.
5.7
Action / Limit Levels
5.7.1
The baseline monitoring results
form the basis for determining the air quality criteria for the impact
monitoring. The ET shall compare the impact monitoring results with air
quality criteria set up for 24-hour TSP and 1-hour TSP. Table 5.2 shows
the air quality criteria, namely Action and Limit levels to be used.
Table 5.2 Action
/ Limit Levels for Air Quality
Remarks:
*Action Level set out at AMS3 Ho Yu College is
adopted.
#Reference is made to EPD
conditional approval of the omission of air monitoring station (AMS 6) for the
project issued and became effective on19 November 2012.
*Reference is made to ET’s proposal of relocation of
AMS3A on 24 October 2013 and EPD’s letter dated on 06 January 2014 regarding
the approval of ET’s proposal for relocating air monitoring station from AMS3A
to AMS3B for Contract No. HY/2010/02. The aforesaid
relocation was completed and AMS3B was effective since 29 Jan 14.
^Reference
is made to ET’s proposal of relocation of AMS7 on 2 February 2015 and EPD’s
memo dated on 05 February 2015 regarding the approval of ET’s proposal for
relocating air monitoring station from AMS7 to AMS7A for Contract No. HY/2010/02. The aforesaid relocation was completed and AMS7A
was effective since 5 February 2015.
5.8
Event and Action Plan
5.8.1
Should non-compliance of the air
quality criteria occur, actions in accordance with the Action Plan in Table 5.3
shall be carried out.
Table 5.3 Event
/ Action Plan for Air Quality
EVENT
|
ACTION
|
ET
|
IEC
|
ER
|
CONTRACTOR
|
ACTION LEVEL
|
Exceedance for one sample
|
1. Identify
source, investigate the causes of exceedance and
propose remedial measures;
2. Inform
IEC and ER;
3. Repeat
measurement to confirm finding;
4. Increase
monitoring frequency to daily.
|
1. Check
monitoring data submitted by ET;
2. Check
Contractor’s working method.
|
1. Notify
Contractor.
|
1. Rectify
any unacceptable practice;
2. Amend
working methods if appropriate.
|
Exceedance for two or more consecutive samples
|
1.
Identify source;
2.
Inform IEC and ER;
3.
Advise the ER on the effectiveness of the proposed remedial measures;
4.
Repeat measurements to confirm findings;
5.
Increase monitoring frequency to daily;
6. Discuss with IEC and Contractor on remedial
actions required;
7.
If exceedance continues, arrange meeting with IEC
and ER;
8.
If exceedance stops, cease additional monitoring.
|
1. Check
monitoring data submitted by ET;
2. Check
Contractor’s working method;
3. Discuss
with ET and Contractor on possible remedial measures;
4. Advise
the ER on the effectiveness of the proposed remedial measures;
5. Supervise
Implementation of remedial measures.
|
1. Confirm
receipt of notification of failure in writing;
2. Notify
Contractor;
3.
Ensure remedial measures properly implemented.
3.
Ensure remedial measures properly implemented.
|
1.
Submit proposals for remedial to ER within 3 working days of notification;
2. Implement
the agreed proposals;
3. Amend
proposal if appropriate.
|
LIMIT LEVEL
|
Exceedance for one sample
|
1. Identify
source, investigate the causes of exceedance and
propose remedial measures;
2. Inform
ER, Contractor and EPD;
3. Repeat
measurement to confirm finding;
4. Increase
monitoring frequency to daily;
5. Assess
effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER
informed of the results.
|
1. Check
monitoring data submitted by ET;
2. Check
Contractor’s working method;
3. Discuss
with ET and Contractor on possible remedial measures;
4. Advise
the ER on the effectiveness of the proposed remedial measures;
5. Supervise
implementation of remedial measures.
|
1. Confirm
receipt of notification of failure in writing;
2. Notify
Contractor;
3. Ensure
remedial measures properly implemented.
|
1.
Take immediate action to avoid further exceedance;
2.
Submit proposals for remedial actions to IEC within 3 working days of
notification;
3. Implement
the agreed proposals;
4. Amend
proposal if appropriate.
|
Exceedance for two or more consecutive samples
|
1. Notify
IEC, ER, Contractor and EPD;
2. Identify
source;
3. Repeat
measurement to confirm findings;
4. Increase
monitoring frequency to daily;
5. Carry
out analysis of Contractor’s working procedures to determine possible
mitigation to be implemented;
6. Arrange
meeting with IEC and ER to discuss the remedial actions to be taken;
7. Assess
effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER
informed of the results;
8. If
exceedance stops, cease additional monitoring.
|
1. Discuss
amongst ER, ET, and Contractor on the potential remedial actions;
2. Review
Contractor’s remedial actions whenever necessary to assure their
effectiveness and advise the ER accordingly;
3. Supervise
the implementation of remedial measures.
|
1. Confirm
receipt of notification of failure in writing;
2. Notify
Contractor;
3. In
consultation with the IEC, agree with the Contractor on the remedial measures
to be implemented;
4. Ensure
remedial measures properly implemented;
5. If
exceedance continues, consider what portion of the
work is responsible and instruct the Contractor to stop that portion of work
until the exceedance is abated.
|
1. Take
immediate action to avoid further exceedance;
2. Submit
proposals for remedial actions to IEC within 3 working days of notification;
3. Implement
the agreed proposals;
4. Resubmit
proposals if problem still not under control;
5. Stop
the relevant portion of works as determined by the ER until the exceedance is abated.
|
5.9
Mitigation Measures
5.9.1
The EIA Report has recommended dust
control measures including 8 times of watering per day. During the
operation of the barging facilities, good site practices such as road surface paving,
dust enclosures, wheels wash facilities would be implemented to reduce the
generation of dust.
5.9.2
All the proposed mitigation
measures are summarised in the Environmental
Mitigation Measures Implementation Schedule (EMIS) in Appendix B.
5.9.3
The Contractor shall, to the
satisfaction of the Engineer, install effective dust suppression measures and
take such other measures as may be necessary to ensure that at the site
boundary and any nearby sensitive receiver, dust levels are kept to acceptable
levels.
5.9.4
Mitigation measures for southern
landfall of the Tuen Mun - Chek Lap Kok Link (TMCLKL)
5.9.4.1 The EIA report has recommended dust control and
mitigation measures. The Contractor shall be responsible for the design and
implementation of the following measures. The recommended construction dust
mitigation measures are summarised in the Air Quality
Environmental Mitigation Implementation Schedule provided in Appendix B.
(i)
all unpaved roads/exposed area shall be watered which
results in dust suppression by forming moist cohesive films among the discrete
grains of road surface material. An effective watering programme of twice daily watering with complete coverage, is estimated to reduce by 50%. This is recommended
for all areas in order to reduce dust levels to a minimum;
(ii)
watering of the construction area 8 times per day is
recommended to reduce dust emissions by 87.5% and shall be undertaken;
(iii)
The Contractor shall, to the satisfaction of the Engineer, install effective
dust suppression measures and take such other measures as may be necessary to
ensure that at the Site boundary and any nearby sensitive receiver, dust levels
are kept to acceptable levels;
(iv)
The Contractor shall not burn debris or other materials
on the works areas;
(v)
in hot, dry or windy weather, the watering programme shall maintain all exposed road surfaces and dust
sources wet;
(vi)
where breaking of oversize rock/concrete is required,
watering shall be implemented to control dust. Water spray shall be used during
the handling of fill material at the site and at active cuts, excavation and
fill sites where dust is likely to be created;
(vii)
open dropping heights for excavated materials shall be
controlled to a maximum height of 2m to minimise the
fugitive dust arising from unloading;
(viii)
during transportation by truck, materials shall not be
loaded to a level higher than the side and tail boards, and shall be dampened
or covered before transport. Materials having the potential to create
dust shall not be loaded to a level higher than the side and tail boards, and
shall be covered by a clean tarpaulin. The tarpaulin shall be properly
secured and shall extend at least 300mm over the edges of the side and tail
boards;
(ix)
no earth, mud, debris, dust and the like shall be
deposited on public roads. Wheel washing facility shall be usable prior
to any earthworks excavation activity on the site;
(x)
areas of exposed soil shall be minimised
to areas in which works have been completed shall be restored as soon as is
practicable; and
(xi)
all stockpiles of aggregate or spoil shall be enclosed
or covered and water applied in dry or windy condition.
5.9.4.2 If the above measures are not sufficient to restore
the air quality to acceptable levels upon the advice of the ET, the Contractor
shall liaise with the ET regarding other mitigation measures and consult the
IEC for their effectiveness, and then propose these measures to the ER for
approval prior to the implementation of the
measures.
6
NOISE
6.1
Noise Quality
Parameters
6.1.1
Construction noise level shall be
measured in terms of the A-weighted equivalent continuous sound pressure level
(Leq). Leq30-min shall be used as
the monitoring parameter for the time period between 0700 and 1900 hours on
normal weekdays. For all other time periods, Leq5-min shall be
employed for comparison with the Noise Control Ordinance (NCO) criteria.
6.1.2
As supplementary information for
data auditing, statistical results such as L10 and L90
shall also be obtained for reference. A sample data sheet is
shown in Appendix D.
6.2
Monitoring Equipment
6.2.1
As referred to in the Technical
Memorandum (TM) issued under the NCO, sound level meters in compliance with the
International Electrotechnical Commission
Publications 651: 1979 (Type 1) and 804: 1985 (Type 1) specifications shall be
used for carrying out the noise monitoring. Immediately prior to and
following each noise measurement, the accuracy of the sound level meter shall
be checked using an acoustic calibrator generating a known sound pressure level
at a known frequency. Measurements may be accepted as valid only if the
calibration level from before and after the noise measurement agrees to within
1.0 dB.
6.2.2
Noise measurements shall not be
made in fog, rain, wind with a steady speed exceeding 5m/s or wind with gusts
exceeding 10m/s. The wind speed shall be checked with a portable wind speed
meter capable of measuring the wind speed in m/s.
6.2.3
The ET is responsible for the
provision, installation, operation, maintenance, dismantle of the monitoring
equipment. He shall ensure that sufficient noise measuring equipment and
associated instrumentation are available for carrying out the baseline
monitoring, regular impact monitoring and ad hoc monitoring. All the
equipment and associated instrumentation shall be clearly labelled.
6.3
Monitoring Locations
6.3.1
The locations of construction noise
monitoring stations are summarised in Table 6.1 and
shown in Figure 2.
Table 6.1 Proposed
airborne construction noise monitoring locations
ID
|
Description
|
NMS2
|
Seaview
Crescent Tower 1
|
NMS3B*
|
Site
Boundary of Site Office Area at Works Area WA2
|
*Reference is
made to ET’s proposal of relocation of NMS3A on 24 October 2013 and EPD’s
letter dated on 06 January 2014 regarding the approval of ET’s proposal for
relocating noise monitoring stations from NMS3A to NMS3B for Contract No. HY/2010/02. The aforesaid relocation was completed and AMS3B
was effective since 29 Jan 2014.
6.3.2
When alternative noise monitoring
location is proposed, the monitoring location shall be chosen based on the
following criteria and the ET shall seek approval from ER and agreement from the
IEC and EPD to the proposal of alternative monitoring location:
· at locations close to the major site activities which are
likely to have noise impacts;
· close
to the most affected existing noise sensitive receivers; and
· for
monitoring locations located in the vicinity of the sensitive receivers, care
should be taken to cause minimal disturbance to the occupants during
monitoring.
6.3.3
The monitoring station shall
normally be at a point 1 m from the exterior of the sensitive receiver building
facade and be at a position 1.2m above the ground. If there is problem
with access to the normal monitoring position, an alternative position may be
chosen, and a correction to the measurements shall be made. For reference,
a correction of +3 dB(A) shall be made to the free
field measurements. The ET shall agree with the IEC on the monitoring
position and the corrections adopted. Once the positions for the
monitoring stations are chosen, the baseline monitoring and the impact
monitoring shall be carried out at the same positions.
6.3.4
The ENPO may, depending on site
conditions and monitoring results, decide whether additional monitoring
locations shall be included or any monitoring locations could be removed/relocated during any stage of the construction
phase.
6.4
Baseline Monitoring for
Construction Noise
6.4.1
The ET shall carry out baseline
noise monitoring prior to the commencement of the construction works.
There shall not be any construction activities in the vicinity of the stations
during the baseline monitoring. Continuous baseline noise monitoring for
the A-weighted levels Leq, L10
and L90 shall be carried out daily for a period of at least two
weeks in a sample period of 5 minutes or 30 minutes between 0700 and 1900, and
5 minutes between 1900 and 0700. A schedule on the baseline monitoring
shall be submitted to the ER and IEC for approval before the monitoring starts.
6.4.2
In exceptional cases, when
insufficient baseline monitoring data or questionable results are obtained, the
ET shall liaise with the IEC and EPD to agree on an appropriate set of data to
be used as a baseline reference and submit to the ER for approval.
6.5
Impact Monitoring for
Construction Noise
6.5.1
During normal construction working
hour (0700-1900 Monday to Saturday), monitoring of Leq,
30-min noise levels shall be carried out at the agreed monitoring
locations once every week in accordance with the methodology in the TM.
6.5.2
If a school exists near the
construction activity, noise monitoring shall be carried out at the monitoring
stations for the schools during the school examination periods. The ET
Leader shall liaise with the school’s personnel and the Examination Authority
to ascertain the exact dates and times of all examination periods during the
course of the contract.
6.5.3
In case of non-compliance with the
construction noise criteria, more frequent monitoring, as specified in the
Action Plan, shall be carried out. This additional monitoring shall be
continued until the recorded noise levels are rectified or proved to be
irrelevant to the construction activities.
6.5.4
A schedule on the compliance
monitoring shall be submitted to the ER and IEC for approval before the
monitoring starts.
6.6
Event and Action Plan
for Construction Noise
6.6.1 The Action and Limit levels for construction noise
are defined in Table 6.1. Should non-compliance of the criteria occur,
action in accordance with the Action Plan shall be carried out.
Table 6.2 Action and Limit Levels for Construction Noise
Note : If works are to be
carried out during restricted hours, the conditions stipulated in the
construction noise permit issued by the Noise Control Authority have to be
followed.
* Reduce to 70 dB(A) for schools and 65 dB(A)
during school examination periods.
Table 6.3
Event / Action Plan for Construction Noise
EVENT
|
ACTION
|
|
ET
|
IEC
|
ER
|
CONTRACTOR
|
|
Action Level
|
1. Notify IEC and Contractor;
2.
Identify source, investigate the causes of exceedance
and propose remedial measures;
3.
Report the results of investigation to the IEC, ER and Contractor;
4. Discuss
with the Contractor and formulate remedial measures;
5. Increase
monitoring frequency to check mitigation effectiveness.
|
1.
Review the analysed results submitted by the ET;
2.
Review the proposed remedial measures by the Contractor and advise the ER
accordingly;
3.
Supervise the implementation of remedial measures.
|
1. Confirm
receipt of notification of failure in writing;
2. Notify
Contractor;
3. Require
Contractor to propose remedial measures for the analysed noise problem;
4. Ensure
remedial measures are properly implemented.
|
1. Submit
noise mitigation proposals to IEC;
2. Implement
noise mitigation proposals.
|
|
Limit Level
|
1. Inform
IEC, ER, EPD and Contractor;
2. Identify
source;
3. Repeat
measurements to confirm findings;
4. Increase
monitoring frequency;
5. Carry
out analysis of Contractor’s working procedures to determine possible
mitigation to be implemented;
6. Inform
IEC, ER and EPD the causes and actions taken for the exceedances;
7. Assess
effectiveness of Contractor’s remedial actions and keep IEC, EPD and ER
informed of the results;
8. If
exceedance stops, cease additional monitoring.
|
1. Discuss
amongst ER, ET, and Contractor on the potential remedial actions;
2.
Review Contractors remedial actions whenever necessary to assure their
effectiveness and advise the ER accordingly;
3. Supervise
the implementation of remedial measures.
|
1. Confirm
receipt of notification of failure in writing;
2. Notify
Contractor;
3. Require
Contractor to propose remedial measures for the analysed noise problem;
4.
Ensure remedial measures properly implemented;
5. If
exceedance continues, consider what portion of the
work is responsible and instruct the Contractor to stop that portion of work
until the exceedance is abated.
|
1.
Take immediate action to avoid further exceedance;
2.
Submit proposals for remedial actions to IEC within 3 working days of
notification;
3. Implement
the agreed proposals;
4. Resubmit
proposals if problem still not under control;
5.
Stop the relevant portion of works as determined by the ER until the exceedance is abated.
|
|
6.7
Mitigation
Measures
6.7.1
The EIA Report has recommended construction
noise control measures including the use of quiet plant and temporary noise
barriers. All the proposed mitigation measures are summarised
in the EMIS in Appendix B.
6.7.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
6.7.3
Good site practices and noise
management techniques to be implemented during construction phase:
·
Use of
site hoarding;
·
Use of
movable noise barrier and full enclosure for relatively static plant;
·
Use of
“quiet” plant and working methods;
·
Sequencing
operation of construction plant equipment; and
·
Rescheduling
to avoid noise construction works during school examination.
7
Sediment
Quality
7.1
Summary
7.1.1
The sediment quality data has been
reviewed and the findings of the site investigation for sediment quality in
relation to the current study area for HKBCF and TMCLKL is summarised
in the EIA Report, there is no requirement on environmental monitoring and
audit for sediment quality.
7.1.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
8
Waste
management
8.1
General
8.1.1
The quantity and timing for the
generation of waste during the construction phase should be estimated. Measures
including the opportunity for on-site sorting, reusing excavated materials for
reclamation etc, should be devised in the construction
methodology to minimise the surplus materials to be
disposed off-site. Proper disposal of chemical waste should be via a licensed
waste collector. The records of quantities of waste generated, recycled
and disposed (locations) should be properly documented.
8.1.2
All the proposed mitigation
measures are stipulated in the EIA Report and summarized in the EMIS in
Appendix B.
8.1.3
The types and quantities of waste that
would be generated during the operational phase have been assessed. It is
anticipated there would not be any insurmountable impact during operation
phase. A trip-ticket system should be operated to monitor all movements of
chemical wastes which will be collected by a licensed collector to licensed
facility for final treatment and disposal.
8.1.4
Recommendations have been made to
ensure proper treatment and proper disposal of these wastes in the EIA Report and
summarised in the EMIS in Appendix B.
8.1.5
EM&A requirements are required
for waste management during the construction phase only and the effective
management of waste arising during the construction phase will be monitored
through the site audit programme. The aims of
the waste audit are:
·
to ensure the waste arising from
the works are handled, stored, collected, transferred and disposed of in an
environmentally acceptable manner; and
·
to encourage the reuse and recycling of
material.
8.2
Waste EM&A
Requirements
8.2.1
The Contractor shall be required to
pay attention to the environmental standard and guidelines and carry out
appropriate waste management and obtain the relevant licence/permits
for waste disposal. The ET shall ensure that the Contractor has obtained
from the appropriate authorities the necessary waste disposal permits or licences including:
·
Chemical Waste Permits/licenses
under the Waste Disposal Ordinance (Cap 354);
·
Public Dumping Licence
under the Land (Miscellaneous Provisions) Ordinance (Cap 28);
·
Marine Dumping Permit under the
Dumping at Sea Ordinance (Cap 466); and
· Effluent Discharge Licence
under the Water Pollution Control Ordinance.
8.2.2
The Contractor shall refer to the
relevant booklets issued by the DEP when applying for the licence/permit
and the ET shall refer to these booklets for auditing purposes.
8.2.3
During the site inspections and the
document review procedures, the ET shall pay special attention to the issues
relating to waste management and check whether the Contractor has followed the
relevant contract specifications and the procedures specified under the laws of
Hong Kong. In addition to the site inspections, the ET shall review the
documentation procedures prepared by the Waste Coordinator once a week to
ensure proper records are being maintained and procedures undertaken in
accordance with the Waste Management Plan.
8.2.4
The Contractor’s waste management
practices should be audited with reference to the checklist detailed in Table
8.1 below:
Table 8.1
Waste Management Checklist
Activities
|
Timing
|
Monitoring Frequency
|
If non-compliance, Action Required
|
All necessary waste disposal permits or licences
have been obtained.
|
Before the commencement of demolition works
|
Once
|
Apply for the necessary permits/ licences prior to
disposal of the waste. The ET shall ensure that corrective action has
been taken.
|
Only licensed waste hauliers are used for waste
collection.
|
Throughout the works
|
Weekly
|
The ET shall inform the ER and IEC of the
non-compliance. The ER shall instruct the Contractor to use a licensed
waste haulier. The Contractor shall temporarily suspend waste
collection of that particular waste until a licensed waste haulier is
used. Corrective action shall be undertaken within 48 hours.
|
Records of quantities of wastes generated, recycled
and disposed are properly kept. For demolition material/waste, the
number of loads for each day shall be recorded (quantity of waste can then be
estimated based on average truck load. Should landfill charging be
implemented, the receipts of the charge could be used for estimating the quantity).
|
Throughout the works
|
Weekly
|
The Contractor shall estimate the missing data based
on previous records and the activities carried out. The ET shall audit
the results and forward to the ER and IEC for approval.
|
Wastes are removed from site in a timely
manner. General refuse is collected on a daily basis.
|
Throughout the works
|
Weekly
|
The ET shall inform the ER and IEC of the
non-compliance. The ER shall instruct the Contractor to remove waste
accordingly.
|
Waste storage areas are properly cleaned and do not
cause windblown litter and dust nuisance.
|
Throughout the works
|
Weekly
|
The ET shall inform the ER and IEC of the
non-compliance. The ER shall instruct the Contractor to clean the
storage area and/or cover the waste.
|
Different types of waste are segregated in different
containers or skip to enhance recycling of material and proper disposal of
waste.
|
Throughout the works
|
Weekly
|
The ET shall inform the ER and IEC of the
non-compliance. The ER shall instruct the Contractor to provide
separate skips/ containers. The Contractor shall ensure the workers
place the waste in the appropriate containers.
|
Activities
|
Timing
|
Monitoring Frequency
|
If non-compliance, Action Required
|
Chemical wastes are stored, handled and disposed of
in accordance with the Code of Practice on the Packaging, Labellling
and Storage of Chemical Wastes, published by the EPD.
|
Throughout the works
|
Weekly
|
The ET shall inform the ER and IEC of the non-compliance.
The ER shall instruct the Contractor to rectify the problems
immediately. Warning shall be given to the Contractor if corrective
actions are not taken within 24 hrs and the Waste Control Group of the EPD
shall be identified.
|
Demolition material/waste in dump trucks are properly covered before leaving the site.
|
Throughout the works
|
Weekly
|
The ET shall inform the ER and IEC of the
non-compliance. The ER shall instruct the Contractor to comply. The
Contractor shall prevent trucks shall leaving the site until the waste are
properly covered.
|
Wastes are disposal of at licensed sites.
|
Throughout the works
|
Weekly
|
The ET shall inform the ER and IEC of the
non-compliance. The ER shall warn the Contractor and instruct the
Contractor to ensure the wastes are disposed of at the licensed sites.
Should it involve chemical waste, the Waste Control Group of EPD shall be
notified.
|
Note: ET – Environmental
Team, IEC – Independent Environmental Checker, ER – Engineer’s Representative
9
Water
quality
9.1
Introduction
9.1.1
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
9.1.2
Prior to the commencement of the construction
work, a detailed site drainage management plan should be submitted to EPD. The
plan should cover measures to minimize all potential water quality impact
arising from the surface runoffs of all the related constructions.
9.1.3
The guidelines outlined in the
Practice Note for Professional Persons (ProPECC),
Construction Site Drainage (PN 1/94) should be adopted to control construction
site runoff. Mitigation measures to minimise
water quality impacts from construction site runoff and wastewater and sewage
generated from construction activities are:
·
Provision
of site drainage systems over the entire construction site with sediment
control facilities. Regular inspection and maintenance of the site
drainage systems are required to ensure proper and efficient operation at all
times.
·
Sedimentation
tanks or package treatment systems are required to treat the large amount of
sediment-laden wastewater generated from foundation construction work, wheel
washing, site runoff. Any construction
activities that generate wastewater with high concentrations of SS should also
be collected to these facilities for proper treatment prior to disposal.
Treated wastewater can be reused for vehicle washing, dust suppression and
general cleaning. Bentonite slurry
used in bore-pile construction should be reconditioned and reused to minimise the disposal volume of the used slurry.
·
The construction programme should be properly
planned to avoid soil excavation in rainy seasons. Exposed stockpiles of
excavated soils or construction materials should be covered with tarpaulin or
impervious sheets to avoid release of pollutants into the drainage channels.
·
Sewage
generated from site toilets and canteen should be collected using a temporary
storage system. Chemical toilets should be provided at different
locations for use by the workers on site. Licensed waste collectors
should be employed for collection and disposal of the sewage. The
drainage system for collection of wastewater generated from canteen, if any,
should be equipped with grease trap capable of providing at least 20 minutes
retention during peak flow.
·
Wheel
washing facilities should be installed at all site entrances/exits.
·
An emergency plan should be developed by the contractors to deal with
accidental spillage of chemicals.
9.1.4
Upon completion of the HKLR / HKBCF
development, stormwater drainage systems
would be completed to collect stormwater generated
from the whole area including new roads. Sewage generated from the HKBCF
development would be treated on site to fulfill effluent limit for
discharge. Additional mitigation measures would not be required.
9.1.5
As identified in the EIA Reports and
the applications for variations of the EPs, key water quality issues during
construction phase will be filling works for the reclamation. Marine
water quality monitoring shall be carried out during the construction phase to
ensure that any unacceptable increase in suspended solids / turbidity and
decrease in dissolved oxygen due to filling activities could be readily
detected and timely action be taken to rectify the situation. The tentative
construction works programme, details of works areas
and construction works sequence and reclamation layout and plan of the Project
is annexed in Appendix A.
9.1.6
Dissolved oxygen (DO), turbidity
(NTU), suspended solids (SS) and other general in situ parameters shall be
monitored at all designated marine water quality monitoring stations during the
whole construction period. DO and turbidity should be measured in-situ
whereas SS should be determined by an accredited laboratory.
9.1.7
Other relevant data shall also be
recorded, including monitoring location / position, time, water depth, pH
value, salinity, temperature, tidal stages, weather conditions and any special
phenomena or work underway at the construction site. A sample data record
sheet is shown in Appendix D for reference.
9.1.8
According to the EIA report, there
is low concentration for PAH, PCB, TBT, and chlorinated pesticides.
Monitoring of these chemicals would not be required during the construction
stage.
9.1.9
The proposed water quality
monitoring schedule shall be submitted to EPD at least 2 weeks before the first
day of the monitoring month. EPD shall also be notified immediately for
any changes in schedule by fax.
9.2
Monitoring Equipment
Dissolved Oxygen and
Temperature Measuring Equipment
9.2.1
The instrument should be a portable and weatherproof dissolved oxygen (DO) measuring
instrument complete with cable and sensor, and use a DC power source. The
equipment should be capable of measuring:
·
a
DO level in the range of 0 - 20 mg/ L and 0 - 200% saturation; and
·
a temperature of 0 - 45 degree Celsius.
9.2.2
It should have a membrane electrode
with automatic temperature compensation complete with a cable.
9.2.3
Should salinity compensation not be
built-in to the DO equipment, in-situ salinity should be measured to calibrate
the DO equipment prior to each DO measurement.
Turbidity Measurement
Instrument
9.2.4
The instrument should be a portable
and weatherproof turbidity measuring instrument using a DC power source.
It should have a photoelectric sensor capable of measuring turbidity between 0
- 1000 NTU (for example, Hach model 2100P or an
approved similar instrument).
Sampler
9.2.5
A water sampler is required.
It should comprise a transparent PVC cylinder, with a capacity of not less than
2 litres, which can be effectively sealed with latex
cups at both ends. The sampler should have a positive latching system to
keep it open and prevent premature closure until released by a messenger when
the sampler is at the selected water depth (for example, Kahlsico
Water Sampler or an approved similar instrument).
Water Depth Detector
9.2.6
A portable, battery-operated echo sounder
should be used for the determination of water depth at each designated
monitoring station. This unit can either be hand held or affixed to the
bottom of the work boat, if the same vessel is to be used throughout the
monitoring programme.
Salinity
9.2.7
A portable salinometer
capable of measuring salinity in the range of 0 - 40 parts per thousand (ppt) should be provided for measuring salinity of the water
at each monitoring location.
pH
Measuring Equipment
9.2.8
A portable pH meter capable of
measuring a range between 0.0 and 14.0 shall be provided to measure pH under
the specified conditions (e.g., Orion Model 250A or an approved similar
instrument).
Sample Containers and Storage
9.2.9
Water samples for SS determinations
should be stored in high density polythene bottles with no preservative added,
packed in ice (cooled to 4°C without being frozen) and delivered to the
laboratory within 24 hours of collection and be analysed
as soon as possible after collection.
Monitoring Position Equipment
9.2.10
A hand-held or boat-fixed type
digital Differential Global Positioning System (DGPS) with way point bearing
indication and Radio Technical Commission for maritime (RTCM) Type 16 error
message ‘screen pop-up’ facilities (for real-time auto-display of error
messages and DGPS corrections from the Hong Kong Hydrographic Office), or other
equipment instrument of similar accuracy, should be provided and used during
marine water monitoring to ensure the monitoring vessel is at the correct
location before taking measurements.
Calibration of In-Situ
Instruments
9.2.11
The pH meter, DO meter and turbidimeter
shall be checked and calibrated before use. DO meter and turbidimeter shall be certified by a laboratory accredited
under HOKLAS or any other international accreditation scheme, and subsequently
re-calibrated at 3 monthly intervals throughout all stages of the water quality
monitoring. Responses of sensors and electrodes should be checked with
certified standard solutions before each use. Wet bulb calibration for a
DO meter shall be carried out before measurement at each monitoring location.
Back-up Equipment and Vessels
9.2.12
Sufficient stocks of spare parts shall be maintained for
replacements when necessary. Backup monitoring equipment shall also be
made available so that monitoring can proceed uninterrupted even when some
equipment is under maintenance, calibration, etc. For the on site calibration of field equipment, the BS127:1993,
"Guide to Field and on-site test methods for the analysis of waters"
shall be observed.
9.2.13
The Water Quality Monitoring will
involve a large number of monitoring stations and measurements should be
conducted within the prescribed tidal conditions (within ± 1.75 hour of the
predicted mid-ebb or mid-flood tides) in order to ensure the
measurement/samples are representative. A multi-probe monitoring equipment set
integrated with water sampler(s) is highly recommended to improve the
monitoring efficiency. It is, also, likely that more than one field
survey vessels will be required simultaneously to ensure the monitoring are
conducted within the acceptable monitoring windows. The ET shall also consider
the use of unattended automatic sampling/monitoring devices at fixed stations
where monitoring are required throughout the construction period. The use of
such unattended automatic devices, however, shall be subject to the approval of
the ER, IEC and EPD.
9.3
Laboratory
Measurement / Analysis
9.3.1
Duplicate samples from each
independent sampling event are required for SS measurement, which shall be
carried in a HOKLAS or other international accredited laboratory.
Sufficient water samples (of about 1L) shall be collected at the monitoring stations
for carrying out the laboratory measurement and analysis. The laboratory
determination work shall start within 24 hours after collection of the water
samples. The analysis for SS is summarized in Table 9 .1.
9.3.2
If a site laboratory is set up or a
non-HOKLAS and non-international accredited laboratory is hired for carrying
out the laboratory analysis, the laboratory equipment, analytical procedures,
and quality control shall be approved by EPD. All the analysis shall be
witnessed by the ER. The ET Leader shall provide the ER with one copy of
the relevant chapters of the “APHA Standard Methods for the Examination of
Water and Wastewater” 19th edition and any other relevant document for his
reference.
Table 9.1 Laboratory analysis for SS
Parameters
|
Instrumentation
|
Analytical Method
|
Reporting Limit
|
Detection Limit
|
Suspended Solid (SS)
|
Weighting
|
APHA 2540-D
|
0.5mg/L
|
0.5mg/L
|
9.4
Monitoring Locations
9.4.1
The water quality monitoring stations, control
stations and locations for during the construction and operation phase of HKBCF
are shown in Figure 3. The demarcation of the monitoring stations for
different projects will be further determined by the ENPO before the
commencement of the construction. The selections of these stations are
based on the following criteria:
i.
Impact stations (IS) within 250m – 500m envelope of the construction
works.
ii.
Sensitive receiver stations (SR) near to key sensitive receivers.
iii.
Control / far field stations (CS) at representative locations with less
influence by the projects. Control stations should be located, as far as
practicable, both upstream and downstream of the works area.
iv.
Stations for sensitivity test result (ST), which are located close to
the HKSAR boundary (i.e 3 sensitivity test stations).
v.
Impact stations (IS(Mf)) around the on-site Mf
deposition sites during the on-site disposal of Mf material.
9.4.2
The co-ordinates of the proposed
monitoring stations during the construction phase are listed in Table
8.2. As shown in Figure 3, the proposed locations for the sensitive
receiver monitoring stations represent the typical sensitive receivers around
the project works.
Table 9.2 Water Quality Monitoring Stations (construction
phases)
Station
|
Description
|
East
|
North
|
IS5
|
Impact Station (Close
to HKBCF construction site)
|
811579
|
817106
|
IS(Mf)6
|
Impact Station (Close
to HKBCF construction site)
|
812101
|
817873
|
IS7
|
Impact Station (Close
to HKBCF construction site)
|
812244
|
818777
|
IS8
|
Impact Station (Close
to HKBCF construction site)
|
814251
|
818412
|
IS(Mf)9
|
Impact Station (Close
to HKBCF construction site)
|
813273
|
818850
|
IS10
|
Impact Station (Close
to HKBCF construction site)
|
812577
|
820670
|
IS(Mf)11
|
Impact Station
(Close to HKBCF construction site)
|
813562
|
820716
|
IS(Mf)16
|
Impact Station (Close
to HKBCF construction site)
|
814328
|
819497
|
IS17
|
Impact Station (Close
to HKBCF construction site)
|
814539
|
820391
|
SR3
|
Sensitive receivers (San
Tau SSSI)
|
810525
|
816456
|
SR4(N)
|
Sensitive receivers
(Tai Ho)
|
814705
|
817859
|
SR5
|
Sensitive receivers
(Artificial Reef in NE Airport)
|
811489
|
820455
|
SR6
|
Sensitive receivers (Sha Chau and Lung Kwu Chau
Marine Park)
|
805837
|
821818
|
SR7
|
Sensitive receivers (Tai Mo Do)
|
814293
|
821431
|
SR10A[1]
|
Sensitive receivers (Ma
Wan FCZ) 1
|
823741
|
823495
|
SR10B(N) [1]
|
Sensitive receivers (Ma
Wan FCZ)2
|
823683
|
823187
|
CS(Mf)3
|
Control Station
|
809989
|
821117
|
CS(Mf)5
|
Control Station
|
817990
|
821129
|
CS4
|
Control Station
|
810025
|
824004
|
CS6
|
Control Station
|
817028
|
823992
|
CSA[2]
|
Control Station
|
818103
|
823064
|
Note [1]: Additional monitoring station for Ma Wan FCZ.
[2]: Additional control
monitoring station for Ma Wan FCZ.
9.4.3
Control stations are necessary to
compare the water quality from potentially impacted sites with the ambient
water quality. Control stations shall be located within the same body of water
as the impact monitoring stations but should be outside the area of influence
of the works and, as far as practicable, not affected by any other works.
If there are any changes on the monitoring location, that shall be submitted 4
weeks before commencement of baseline monitoring for EPD approval.
9.4.4
In-situ monitoring (DO,
temperature, turbidity, pH, salinity) and water sample for SS shall be taken at
3 water depths, namely, 1 m below water surface, mid-depth and 1 m above sea
bed, except where the water depth is less than 6 m, in which case the mid-depth
station may be omitted. Should the water depth be less than 3 m, only the
mid-depth station will be monitored. The status and locations of water
sensitive receivers and the marine activities may change after issuing this
Manual. If such cases exist, the ET Leader shall propose with
justification for changes to monitoring locations or other requirements of the
EM&A programme, and seek approval from the IEC
and EPD.
9.4.5
The ENPO may, depending on site
conditions and monitoring results, decides whether additional monitoring
locations shall be included or any monitoring locations could be removed /
relocated during any stage of the construction phase after getting approval
from EPD.
9.5
Baseline
Monitoring for Water Quality
9.5.1
Baseline conditions for marine
water quality shall be established and agreed with EPD prior to the
commencement of works. The purpose of the baseline monitoring is to
establish ambient conditions prior to the commencement of the works and to
demonstrate the suitability of the proposed impact and control monitoring
stations. The baseline conditions shall normally be established by measuring
the DO, temperature, turbidity, pH, salinity and SS at all designated
locations. The measurements shall be taken at all designated monitoring
stations including control stations, 3 days per week, at mid-flood (within ±
1.75 hour of the predicted time) and mid-ebb (within ± 1.75 hour of the
predicted time) tides, for at least 4 weeks prior to the commencement of marine
works.
9.5.2
Baseline monitoring programme may overlap with other reclamation
activities. The monitoring exercise should be scheduled as far as
possible to avoid concurrent dredging / backfilling activities around the
monitoring stations such that representative ambient data could be sampled.
9.5.3
Other relevant data shall also be
recorded, such as monitoring location / position, time, water depth, tidal
stages, weather conditions and any special phenomena underway near the
monitoring station. There shall not be any marine construction activities
in the vicinity of the stations during the baseline monitoring.
9.5.4
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
9.5.5
Baseline monitoring schedule shall
be faxed to EPD 2 weeks prior to the commencement of baseline monitoring.
The interval between two sets of monitoring shall not be less than 36 hours.
9.6
Efficiency of Silt
Curtain and Cage Curtain
9.6.1
The ET shall be responsible for
conducting pilot test to confirm that their silt curtain systems to be adopted
would satisfy the requirements in the EIA Report. The details for the pilot
test shall be determined by the ENPO and agreed by EPD before the commencement
of the monitoring, taking account of the Contractor’s proposed actual locations
of his initial period of filling works.
9.6.2
ET Leader shall submit the pilot
test proposal detailing the layout of silt curtains, monitoring location and
testing arrangement for IEC and EPD’s agreement before conducting the pilot
tests.
9.6.3
During the initial period of
filling works for HKBCF and southern landfall of TMCLKL, the silt-removal
efficiency of the silt-curtains shall be verified by examining the results of
water quality monitoring points. The water quality monitoring points to be
selected for the above shall be those close to the locations of the initial
period of filling work.
9.6.4
Pilot test should be carried out
during the early stage of construction to confirm whether the silt removal
efficiency of the cage type silt curtain and the floating type silt curtains
can achieve 80% and 45% silt removal efficiency for filling activities
respectively when deployed separately, and a combined reduction of 95% and 61%
when the two type of silt curtains are used jointly. Pilot test for cage type
silt curtain (with steel enclosure) should be carried out to see if the cage type
silt curtain (with steel enclosure) can achieve 80% reduction when applied
singly under current above 0.5 m/s.
9.6.5
The pilot test shall include basic
measurements such as turbidity and suspended solids as well as current speed
and direction. Where testing of cage type silt curtain (with steel enclosure)
to is to be conducted at relatively fast current, supplementary Acoustic
Doppler Current Profiler (ADCP) measurement of the plumes shall be considered
to provide a better characterization of instant suspended solids plumes.
9.6.6
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
9.6.7
Regardless of the measured
efficiency of the silt curtain system, the event and action plan shall only be based
on the monitoring results at the designed monitoring stations.
9.7
Impact Monitoring for Water Quality
Reclamation
9.7.1
Reclamation would require dredging
and filling activities during the construction. During this period, silt
curtains would be installed enclosing the whole project site to control
sediment loss. During the construction period, monitoring shall be undertaken 3
days per week, at mid-flood (within ± 1.75 hour of the predicted time) and
mid-ebb (within ± 1.75 hour of the predicted time) tides, with sampling /
measurement at the designated monitoring stations. Replicate in-situ
measurements and samples collected from each independent sampling event shall
be collected to ensure a robust statistically interpretable database. The
interval between two sets of monitoring shall not be less than 36 hours except
where there are exceedances of Action and / or Limit
levels, in which case the monitoring frequency will be increased. Two
consecutive measures of DO concentration, DO saturation, pH, salinity,
temperature, turbidity and water samples for SS will be taken in situ at 1 m
below the surface, mid-depth and 1 m above the seabed at each location.
If the water depth is less than 6 m, the mid-depth measurement may be omitted
subject to the approval of the ER. If the depth is less than 3 m, only
the mid-depth measurements need to be taken subject to the approval of the
ER. The monitoring probes shall be retrieved out of water after the first
measurement and then redeployed for the second measurement. Where the
difference in value between the first and second readings of DO or turbidity
parameters is more than 25% of the value of the first reading, the reading
shall be discarded and further readings shall be taken. For the construction
phase, the nutrients and metal parameters only have to be measured at the
locations with "Mf" during period of Mf sediment backfilling. After
the pit for Mf sediment is backfilled and capped for one month, monitoring at IS(Mf)18, IS9(Mf)19 and IS(Mf)20 locations can be stopped.
9.7.2
If the impact monitoring results
indicate that filling works have caused adverse impacts on water quality at the
monitoring stations, appropriate actions (including the lowering of production
rates for filling) should be taken and additional mitigation measures should be
implemented as necessary. Water quality monitoring frequency has to be
increased to once per day when filling is undertaken. 24-hour monitoring
of turbidity should be implemented as and when necessary. The monitoring
results should be made available to the EPD, ER and IEC within eight working
days.
Relocation
of Mf Sediment with Reclamation Area
9.7.3
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
9.7.4
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
Water
Quality Monitoring along the Water Boundary of Hong Kong and Mainland
9.7.5
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
9.8
Post-construction
Monitoring
9.8.1
Upon completion of all marine-based
construction activities, a post-project monitoring exercise on water quality
shall be carried out for 4 weeks in the same manner as the Baseline monitoring.
Replicate in-situ measurements and samples collected from each independent
sampling event shall be collected to ensure a robust statistically
interpretable database. The measurement parameters for Post-construction
monitoring shall include DO concentration and saturation, temperature,
turbidity, pH, salinity and SS. The measurement shall be taken at all
designated monitoring stations including control stations, 3 days per week, at
mid-flood (within ± 1.75 hour of the predicted time) and mid-ebb (within ± 1.75
hour of the predicted time) tides, for at least 4 weeks. Since the
southern and northern landfalls of TM-CLKL are distant from each other and
based on the tentative programme available during the
EIA stage the two landfall has different construction
time frame, the Post-construction monitoring for each landfalls may conducted
separately. The ET should review the actual implantation programme
and recommend if a separate post-construction monitoring for each landfall is
required.
9.9
Impact Operation Phase Monitoring
9.9.1
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
9.9.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
9.10
Event and Action Plan
9.10.1
The Action and Limit levels for
water quality are defined in Table 9.3. Should non-compliance of the criteria
occur, action in accordance with the Action Plan in Table 9.4 shall be carried
out.
9.10.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
Table 9.3 Action and Limit Levels for Water Quality
*
Remarks: Reference is made to EPD approval of adjustment of water quality assessment
criteria issued and became effective on 18 February 2013.
Notes: 1.
"depth-averaged" is calculated by taking the arithmetic means of
reading of all three depths.
2. For DO, non-compliance of the water
quality limits occurs when monitoring result is lower than the limits.
3. For turbidity, SS, non-compliance of
the water quality limits occurs when monitoring result is higher than the
limits.
4. All the figures given in the table are
used for reference only and the EPD may amend the figures whenever it is
considered as necessary.
5. The 1%-ile
of baseline data for dissolved oxygen
(surface and middle) and dissolved oxygen
(bottom) are 4.2mg/L and 3.6mg/L respectively.
Table 9.4
Event and Action Plan for Water Quality
Event
|
ET Leader
|
IEC
|
ER
|
Contractor
|
|
1.
Repeat in situ measurement to
confirm findings;
3.
Inform IEC, contractor and ER;
4.
Check monitoring data, all plant,
equipment and Contractor's working methods;
5. Discuss mitigation measures with IEC, ER and
Contractor;
7.
Repeat measurement on next day of exceedance to confirm findings.
|
1.
Check monitoring data submitted by ET
and Contractor’s working methods;
2.
Discuss with ET and Contractor on
possible remedial actions;
3.
Review the proposed mitigation measures
submitted by Contractor and advise the ER accordingly;
4.
Assess the effectiveness of the
implemented mitigation measures.
|
1.
Confirm receipt of notification of
non-compliance in writing;
2.
Discuss with IEC on the proposed
mitigation measures;
3.
Make agreement on mitigation measures
to be implemented;
4.
Ensure mitigation measures are properly
implemented.
|
1.
Inform the ER and confirm notification
of the non-compliance in writing;
2.
Rectify unacceptable practice;
3.
Check all plant and equipment and
consider changes of working methods;
4.
Discuss with ET and IEC on possible
remedial actions and propose mitigation measures to IEC and ER;
5.
Implement the agreed mitigation measures.
6.
Amend working methods if appropriate.
|
Action level being
exceeded by two or more consecutive sampling days
|
1.
Repeat in situ measurement to
confirm findings;
2.
Identify source(s) of impact;
3.
Inform IEC, Contractor and ER;
4.
Check monitoring data, all plant,
equipment and Contractor's working methods;
5. Discuss mitigation measures with IEC, ER and Contractor;
6.
Ensure mitigation measures are
implemented;
7.
Increase the monitoring frequency to
daily until no exceedance of Action level;
8.
Repeat measurement on next day of exceedance to confirm findings.
|
1.
Check monitoring data submitted by ET
and Contractor’s working method;
2.
Discuss with ET and Contractor on possible
remedial actions;
3.
Review the proposed mitigation measures
submitted by Contractor and advise the ER accordingly;
4.
Assess the effectiveness of the
implemented mitigation measures.
|
1.
Confirm receipt of notification of
non-compliance in writing;
2.
Discuss with IEC on the proposed
mitigation measures;
3.
Make agreement on mitigation measures
to be implemented;
4.
Ensure mitigation measures are properly
implemented;
5.
Assess the effectiveness of the implemented
mitigation measures.
|
1.
Inform the Engineer and confirm
notification of the non-compliance in writing;
2.
Rectify unacceptable practice;
3.
Check all plant and equipment and
consider changes of working methods;
4.
Discuss with ET and IEC on possible
remedial actions and propose mitigation measures to IEC and ER within 3
working days of notification;
5.
Implement the agreed mitigation
measures;
6.
Amend working methods if appropriate.
|
|
1.
Repeat in-situ measurement to
confirm findings;
2.
Identify source(s) of impact;
3.
Inform IEC, Contractor, ER and EPD;
4.
Check monitoring data, all plant,
equipment and Contractor's working methods;
5.
Discuss mitigation measures with IEC,
ER and Contractor;
7.
Increase the monitoring frequency to
daily until no exceedance of Limit level.
|
1.
Check monitoring data submitted by ET
and Contractor’s working method;
2.
Discuss with ET and Contractor on
possible remedial actions;
3.
Review the proposed mitigation measures
submitted by Contractor and advise the ER accordingly;
4.
Assess the effectiveness of the
implemented mitigation measures.
|
1.
Confirm receipt of notification of
failure in writing;
2.
Discuss with IEC, ET and Contractor on
the proposed mitigation measures;
3.
Request Contractor to critically
review the working methods;
4.
Ensure mitigation measures are properly
implemented;
5.
Assess the effectiveness of the
implemented mitigation measures.
|
1.
Inform the ER and confirm notification
of the non-compliance in writing;
2.
Rectify unacceptable practice;
3.
Check all plant and equipment and
consider changes of working methods;
4.
Submit proposal of mitigation measures
to ER within 3 working days of notification and discuss with ET, IEC and ER;
5.
Implement the agreed mitigation
measures;
6.
Amend working methods if appropriate.
|
|
1.
Repeat in-situ measurement to
confirm findings;
3.
Inform IEC, contractor, ER and EPD;
4.
Check monitoring data, all plant,
equipment and Contractor's working methods;
5.
Discuss mitigation measures with
IEC, ER and Contractor;
|
1.
Check monitoring data submitted by ET
and Contractor’s working method;
2.
Discuss with ET and Contractor on
possible remedial actions;
3.
Review the Contractor’s mitigation measures
whenever necessary to assure their effectiveness and advise the ER
accordingly.
|
1.
Confirm
receipt of notification of failure in writing;
2. Discuss with IEC,
ET and Contractor on the proposed mitigation measures;
3.
Request Contractor to critically review
the working methods;
4. Make agreement on the mitigation measures to be
implemented;
5.
Ensure mitigation measures are properly
implemented;
6.
Assess the effectiveness of the
implemented mitigation measures;
7.
Consider and instruct, if necessary,
the Contractor to slow down or to stop all or part of the construction
activities until no exceedance of Limit level.
|
1.
Inform the ER and confirm notification
of the non-compliance in writing;
2.
Take immediate action to avoid further exceedance;
3.
Rectify unacceptable practice;
4.
Check all plant and equipment and
consider changes of working methods;
5.
Submit proposal of mitigation measures
to ER within 3 working days of notification and discuss with ET, IEC and ER;
6.
Implement the agreed mitigation
measures;
7.
Resubmit proposals of mitigation
measures if problem still not under control;
8.
As directed by the Engineer, to slow down
or to stop all or part of the construction activities until no exceedance of Limit level.
|
9.11 Mitigation Measures
9.11.1
The EIA Report has assessed the
water quality impacts caused by the construction stages and recommended mitigation
measures to ensure compliance with the relevant legislative requirements. In
addition, the EP also recommended several mitigation measures on reclamation
works of the Project.
Reclamation
9.11.2
The mitigation measures on
reclamation works are summarised below:
· Floating
type perimeter silt curtains shall be installed around the HKBCF site before
the commencement of marine works. Staggered layers of silt curtain shall be
provided to prevent sediment loss at navigation accesses. The length of each
staggered layers shall be at least 200m. Appendix A shows the layout plan of perimeter silt curtains during
construction works;
· Single layer silt curtain to be
applied around the North-east airport water intake;
· The silt-curtains should be maintained in good condition to
ensure the sediment plume generated from filling be confined effectively within
the site boundary;
· The filling works shall be scheduled to spread the works evenly over a working day;
· Reclamation
filling for the Project shall not proceed until at least 200m of leading
seawall at the reclamation area formed above +2.2mPD, except for the sand
blanket filling, unless otherwise agreement was obtained from EPD, except for
the 300m gaps for marine access. The maximum daily filling rate of sand blanket
shall be 24,000 m3. During
the sand blanket placement, cage type double layer silt curtain shall be
deployed around the filling points. All underwater filling works shall
be carried out behind seawalls to avoid dispersion of suspended solids outside
the Project limit;
· Cellular
structure shall be used for seawall construction;
· A layer of geotextile
shall be placed on top of the seabed before any filling activities take place
inside the cellular structures to form the seawall;
· The conveyor belts shall be fitted with
windboards and conveyor release points shall be
covered with curtain to prevent any spillage of filling materials onto the
surrounding waters;
· Except for the filling of the
cellular structures, not more than 15% public fill shall be used for
reclamation filling below +2.5mPD during construction of the seawall;
· After the seawall is completed
except for the 300m marine access as indicated in Appendix A, not more than 30%
public fill shall be used for reclamation filling below +2.5mPD, unless
otherwise agreement from EPD was obtained;
· Upon completion of 200m leading
seawall, no more than a total of 60 filling barge trips per day shall be made
with a cumulative maximum daily filling rate of 60,000 m3 for HKBCF
and TMCLKL southern landfall reclamation during the filling operation; and
· Upon completion of the whole section
of seawall except for the 300m marine access as indicated in Appendix A, no
more than a total of 190 filling barge trips per day shall be made with a
cumulative maximum daily filling rate of 190,000 m3 for the
remaining filling operations for HKBCF and TMCLKL southern landfall
reclamation.
9.11.3
Any proposed changes in the
construction sequences and/or arrangements shall be proposed before
implementation of such changes. The proposed changes shall be certified by the
ETL and verified by the IEC as conforming to the information and requirements
contained in the EIA Report.
9.11.4
To ensure that the cumulative
maximum filling rate assumed in the EIA report shall not be exceeded, at least
one week prior to the end of each calendar month, the Permit Holder shall
submit the anticipated daily filling rate for the coming month to the ENPO for
approval. The actual maximum daily filling rate shall not exceed the approved
filling rate by ENPO. The actual maximum daily filling rate shall not exceed
the approved filling rate by ENPO.
Stone
Column Installation
9.11.5
An additional layer of silt
curtain, as shown in Appendix E, shall be installed near the active stone
column installation points. A layer of geotextile
with stone blanket on top shall be placed on the seabed prior to stone column
installation works.
Construction
Site Run-off and Wastewater and Sewage Generated from Construction Activities
9.11.6
The guidelines outlined in the
Practice Note for Professional Persons (ProPECC),
Construction Site Drainage (PN 1/94) should be adopted to control construction
site runoff. Mitigation measures to minimise
water quality impacts from construction site runoff and wastewater and sewage
generated from construction activities are:
· Sedimentation
tanks or package treatment systems are required to treat the large amount of
sediment-laden wastewater generated from foundation construction work, wheel
washing, site runoff. Any construction
activities that generate wastewater with high concentrations of SS should also
be collected to these facilities for proper treatment prior to disposal.
Treated wastewater can be reused for vehicle washing, dust suppression and
general cleaning.
· The construction programme should be properly planned to
avoid soil excavation in rainy seasons. Exposed stockpiles of excavated
soils or construction materials should be covered with tarpaulin or impervious
sheets to avoid release of pollutants into the drainage channels.
· Sewage
generated from site toilets and canteen should be collected using a temporary
storage system. Chemical toilets should be provided at different
locations for use by the workers on site. Licensed waste collectors
should be employed for collection and disposal of the sewage. The
drainage system for collection of wastewater generated from canteen, if any,
should be equipped with grease trap capable of providing at least 20 minutes
retention during peak flow.
· Wheel washing facilities should be
installed at all site entrances/exits.
· An emergency plan should be developed by the contractors to
deal with accidental spillage of chemicals.
9.11.7
Prior to the commencement of the
construction work, a detailed site drainage management plan should be submitted
to EPD. The plan should cover measures to minimize all potential water quality
impact arising from the surface runoffs of all the related constructions.
9.11.8
The EIA Report has also recommended
construction mitigation measures. All the prepared mitigation measures
are summarised in the EMIS in Appendix B.
9.12 Performance Review for Stone Column
Installation
9.12.1
The Contractor shall be responsible
for conducting performance review to confirm that the stone column installation
method to be adopted would be satisfactory. The details for the pilot test
shall be agreed by the ENPO before the commencement of the monitoring, taking
account of the Contractor’s proposed actual locations of his initial period of
stone column installation works.
9.12.2
During the initial period of stone
column installation works for HKBCF and southern landfall of TMCLKL, the
environmental performance of the installation method shall be verified by
examining the results of water quality monitoring points. The water quality
monitoring points to be selected for the above shall be those close to the
locations of the initial period of stone column installation work.
9.12.3
The pilot test shall include basic
measurements such as turbidity and suspended solids as well as current speed
and direction.
9.12.4
Regardless of the results of
performance verification, the event and action plan shall only be based on the
monitoring results at the designed monitoring stations.
10
ECOLOGY
10.1 Introduction
10.1.1
The EIA Report has assessed the
ecological impacts caused by the construction phase. Mitigation measures
have been recommended in the EIA to ensure compliance with the relevant
legislative requirements. The mitigation measures and ecological
monitoring surveys are stated in this manual in the sections below. A detailed
ecological monitoring plan with specification and detailed methodology will be
prepared prior to the baseline monitoring, and submitted to AFCD and EPD for
approval.
10.2 Ecological Mitigation Measures
and Implementations*
*Remarks -
Regular environmental briefing/training sessions should be provided to site staffs
to ensure proper implementation of relevant mitigation measures.
Marine Water
Quality
10.2.1
Low disturbance construction
method: Any significant changes in water quality or turbidity should be
avoided. This could be mitigated through construction methods.
10.2.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.2.3
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.2.4
Good Site Practices: – The
integrity and effectiveness of all silt curtains should be regularly
inspected. Effluent monitoring should be incorporated to make sure that
the discharged effluent from construction sites meets the relevant effluent
discharge guidelines. Regularly check the work site boundaries to ensure that
they are not breached and that damage does not occur to surrounding areas.
10.2.5
Strict enforcement on No-dumping –
To avoid degrading the Chinese White Dolphin habitat, restrictions prohibiting
dumping of rubbish, food, oil, or chemicals will be strictly enforced.
10.2.6
Site runoff control - For works on
land, standard site runoff control measures will be established and strictly
enforced to ensure that discharge of contaminated or silt-laden runoff into
North Lantau waters is minimised.
10.2.7
Spill response plan – In the event
of vessels operating in the works areas transporting oil or other hazardous
chemicals, an oil-spill response plan, with specific provisions for protecting
marine ecology and dolphins, will be formulated.
10.2.8
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
Terrestrial
Disturbance
10.2.9
The impact from this minor and
short-term source can be reduced by good site practice, including strictly
following the permitted works hours, using quieter machines where practicable,
and avoiding excessive lightings during night time. Regularly checking on the
work site boundaries to ensure that they are not breached and that damage does
not occur to surrounding areas.
Sedimentation
from Land-based works areas
10.2.10 Good site practices (e.g., watering to reduce dust
generation, prevention of siltation of freshwater habitats) are recommended to
be implemented. Site runoff should be desilted, to
reduce the potential for suspended sediments, organics and other contaminants
to enter existing streams and standing freshwater.
Marine Noise
and Disturbance
1) Bored piling
10.2.11 Avoidance of percussive piling – In view of its
strong potential to cause serious noise impact upon the dolphins and porpoises,
underwater percussive piling will not be adopted. Steel cells were installed
using vibratory methods.
10.2.12 N.A.
10.2.13 N.A.
2) Sheet piling
10.2.14 N.A. (Not relevant to the Hong Kong Boundary Crossing
Facilities – Reclamation Works)
10.2.15 N.A. (Not relevant to the Hong Kong Boundary Crossing
Facilities – Reclamation Works)
3) Reclamation and Works Vessels
10.2.16 Dolphin Exclusion Zone – dolphin exclusion zone of
250m radius should be implemented in the reclamation sites during the
installation of the perimeter silt curtains and any re-deployment of the
perimeter silt curtains. Prior to the start of the works, dolphin observers
shall scan the exclusion zone for at least 30 minutes at location with
unobstructed, elevated view of the area to certify the dolphin exclusion zone
is continuously clear of dolphins for a period of 30 minutes. Works will be
suspended when any Chinese White Dolphin (CWD) is found within the exclusion
zone. The dolphin observers shall have relevant training on dolphin monitoring
and should be independent of the construction contractor and form part of the
Environmental Team. Passive Acoustic Monitoring, using hydrophones or cetacean
detectors, shall be used for the detection of dolphin outside the daylight
hours.
10.2.17 Dolphin Watching Plan - A dolphin watching plan for
works areas will also be included in the EM&A programme.
For reclamation sites, once the perimeter silt curtains are installed or
re-deployed, the filling works would be conducted inside the silt curtains and
a dolphin exclusion zone is not needed. Instead a dolphin watching plan will be
performed. The plan would include regular inspection of the silt
curtains, visual inspection of the waters surrounded by the curtains, and an
action plan should be devised to cope with any unpredicted incidents such as in
case dolphins are found within the waters surrounded by the silt curtains.
10.2.18 Acoustic decoupling of compressors and other
equipment – Air compressors and other noisy equipment that must be mounted on
construction vessels will be acoustically-decoupled to the greatest extent
feasible, for instance by using rubber air-filled tires. A proposal on design
and implementation of acoustic decoupling measures applied during reclamation
works should be deposited with the EPD before the commencement of the
construction of the Project.
Marine Traffic
10.2.19 Vessel speed limit control – It is known that
fast-moving vessels are a threat to dolphins and porpoises, a speed limit of 10
knots will be strictly enforced within the work areas. This speed limit
for vessels within the boundaries of the Sha
Chau/Lung Kwu Chau Marine Park appears to be
effective in protecting the dolphins from vessel collisions.
10.2.20 Skipper training – Captains of construction vessels
working in the West Lantau waters and near the
Brothers Islands should undergo training to learn about local dolphins and
porpoises. They should be trained to be aware of the protocol for “dolphin
friendly” vessel operation (reference made to Code of Conduct for Dolphin
Watching Activities available from AFCD).
10.2.21 Predefined and regular routes for working vessels –
Captains of all working vessels should be required to use regular travel
routes, in order to minimize the chance of vessel collision. And the
routes would not go through the dolphin hotspot in Brothers Islands. A plan
showing the regular marine travel routes of vessels moving to and from the
Project work sites should be deposited to EPD at least 2 weeks before the
commencement of the construction of the Project. Any subsequent changes to the
regular routes shall be verified by the IEC as conforming to the requirements
in the EIA Report and deposited to EPD.
Road Surface
Runoff
10.2.22 Silt-grease traps should be deployed to prevent a
direct input of road surface runoff to the marine waters.
Chemical
spillage
10.2.23 A Maritime Oil Spill Response Plan (MOSRP) has been
developed by Marine Department to deal with oil spill and their potential
hazard to the Hong Kong waters. The main objective of the MOSRP is to ensure a
timely and effective response to oil spillages and/or their potential treats in
the Hong Kong waters.
10.2.24 Similar to the Shenzhen Western Corridor project, a
Spill Response Plan will be formulated to deal with the accidental event of the
serious spillage of oil or other hazardous chemicals and it should be at least
1 month before the commencement of the construction of the Project. A Spill
Response Plan in this regard will be primarily for safety issues and water
quality, but could also help to safeguard the dolphin population. It will
detail the actions to be taken in the event of accidental spillage of oil or
other hazardous chemicals from construction activities including vessels
operating of for the Project, with specific provisions for protecting marine
ecology and the Chinese White Dolphins. Following the example of Shenzhen
Western Corridor, it will be specified in the contingency plan that AFCD must
be alerted by the Hong Kong Police Force or Fire Service Department in case an
accident of spillage of chemical or oil is reported.
Precautionary/Enhancement
Measures
10.2.25 N.A. (Not relevant to the Hong Kong Boundary Crossing
Facilities – Reclamation Works)
10.2.26 N.A. (Not relevant to the Hong Kong Boundary Crossing
Facilities – Reclamation Works)
10.2.27 N.A. (Not relevant to the Hong Kong Boundary Crossing
Facilities – Reclamation Works)
10.3
Monitoring and Audit for Ecology
10.3.1
An ecological monitoring and audit programme would be needed for the Project. The monitoring programme will include monitoring of physical parameters
such as air, noise and water quality, and ecological aspects such as CWD.
The ecological monitoring and audit programme will
monitor potential impacts through construction activities, and will verify the
assessments which were made in the EIA report. The monitoring includes the
following tasks:
10.3.2
Vessel-based dolphin monitoring – A
dolphin monitoring programme at Northeast and
Northwest Lantau , in particular the dolphin sighting
hotspots (e.g. Brothers Islands) and areas where juveniles have been sighted,
should be set up to verify the predictions of impacts and to ensure that there
are no unforeseen impacts on the dolphin population during construction
phase. The monitoring period should cover the
pre-construction phase (baseline conditions), the entire period of construction
phase (tentatively 2012 – 2016), and at least two years after the completion of
construction works.
10.3.2.1 The dolphin monitoring should adopt line-transect vessel
survey method, and cover the following line-transect survey areas as in AFCD
annual marine mammal monitoring programme:
· Northeast
Lantau survey area; and
· Northwest
Lantau survey area.
10.3.2.2 On each survey day, the survey vessel will depart
from Tung Chung Development Pier or nearest convenient and safe location.
Observation for incidental sighting will begin immediately at the beginning of
the transect lines as defined by AFCD monitoring programme.
The survey vessel shall have an open upper deck, allowing for observer eye
heights of 4 to 5m above water level and relatively unobstructed forward
visibility between 270° and 90°. When on-effort, the vessel shall travel
along the survey lines at a speed of approximately 7 to 8 knots (13 to 15
km/hr). The direction of the survey shall be alternated on different days
to avoid possible biases related to the timing of the survey coverage.
10.3.2.3 Vessel-based transect observations by a three-person
team shall be conducted by searching the 180° swath in front of the survey
vessel (270° to 90°). The area behind the vessel need not be searched,
although dolphins observed in this area should be recorded as off-effort
sightings. The primary observer will scan the entire search path (270° to
90°) continuously with Fujinon 7x50 marine binoculars
or equivalent as the second member of the team, designated the data “recorder”,
scans the same area with the naked eye and occasional
binocular check. The third observer on the boat is required to rotate
into the observation team after half an hour, thus relieving one of the initial
team. Observers should rotate every half an hour. While on-effort,
observers shall ignore potential sighting cues that could bias the sighting
distance calibration (e.g. pair-trawl fishing vessels).
10.3.2.4 A critical consideration in the survey will be to
ensure a strict timed quantification of “sighting effort” in order to maximise the comparative value of the field survey
results. The time and position for the start and end of a period of
intensive, uninterrupted effort, and the sighting conditions such as visibility
range and Beaufort scale associated with it shall be recorded. The
collection of effort data allows comparisons within a single study as well as
between studies. Strict recording of time and speed travelling along the
assigned transect (“on-effort”) shall, therefore, be recorded. Time spent
during any deviation from the transect will be
recorded as “off-effort”.
10.3.2.5 During periods of poor weather, when visibility is
hindered (e.g., below 1km) or when a Beaufort force 5 is reached, the survey
should normally be postponed.
10.3.2.6 Sightings distant to 500m perpendicular distance and
sightings of single dolphins that were hard to track should not be pursued
(although those distant to 500m ahead of the vessel should be pursued).
The initial sighting distance between the dolphin and the survey vessel and
sighting angle shall be recorded in order to estimate the positions of the dolphins.
These and other details of the sighting, including the exact location of the
sighting and number of individuals should be agreed among the observation team
and recorded immediately. Distances and angles shall be as accurate as
possible.
10.3.2.7 A global positioning system shall be used during the
surveys. A sighting record shall be filled out at the initial sighting with
time, position, distance and angle data filled in immediately and verified
between primary observer and recorder. All other information on sea
state, weather conditions (Beaufort Scale), as well as
notes on dolphin appearance, behaviour, and any other
information shall also be completed.
10.3.2.8 A summary of equipment requirement is summarized in
Table 6.5 below.
Table
10.1 Summary of Dolphin Monitoring Equipment Requirements
Equipment
|
Type
|
Vessel for Monitoring
|
A monitoring boat which should have a flying bridge
or upper
deck with a relatively unobstructed
forward visibility (270o – 90o)
allowing for observer eye height of 4-5m
above water
|
Observation
|
Fujinon 7x50 marine binoculars (or
similar) with compass/reticule
|
Calibration
|
Leica Geovid
laser range finder binnacles or equivalent
|
Navigation and Positioning
|
Global Positioning System Device (Magellen NAV 5000D or
similar approved) (+ spare batteries)
|
10.3.2.9 As the project will last for a few years, the ET
Leader should seek approval from the IEC, AFCD and EPD on an appropriate
methodology and parameters to be recorded. A detailed ecological monitoring
plan with specification and detailed methodology for baseline monitoring will
be prepared prior to the baseline monitoring, and submitted to AFCD and EPD for
approval.
10.3.2.10 In order to provide a suitable long-term dataset for comparison,
baseline, impact and post-construction phase dolphin monitoring will employ an
identical methodology and follow the same line transects.
10.3.3
N.A (Not relevant to the Hong Kong Boundary
Crossing Facilities – Reclamation Works)
10.3.4
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.3.5
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.3.6
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.3.7
The ecological monitoring surveys
shall be undertaken by suitably qualified specialist(s), (i.e. dolphin
specialist), who shall have sufficient (at least 5-10 years) relevant
post-graduate experience and publication in the respective aspects and should
be independent of the construction contractor and should form part of the
independent ET. Approval on the specialist(s) responsible for ecological monitoring
survey shall be sought from AFCD and EPD. The IEC may audit the work of
the ET if deemed necessary.
10.4 Monitoring Locations
10.4.1
The dolphin monitoring should adopt
line-transect vessel survey method, and cover the following line-transect
survey areas as in AFCD annual marine mammal monitoring programme:
· Northeast
Lantau survey area; and
· Northwest
Lantau survey area.
10.4.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.4.3
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.4.4
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.4.5
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.5
Baseline Monitoring for Ecology
10.5.1
Baseline for dolphin

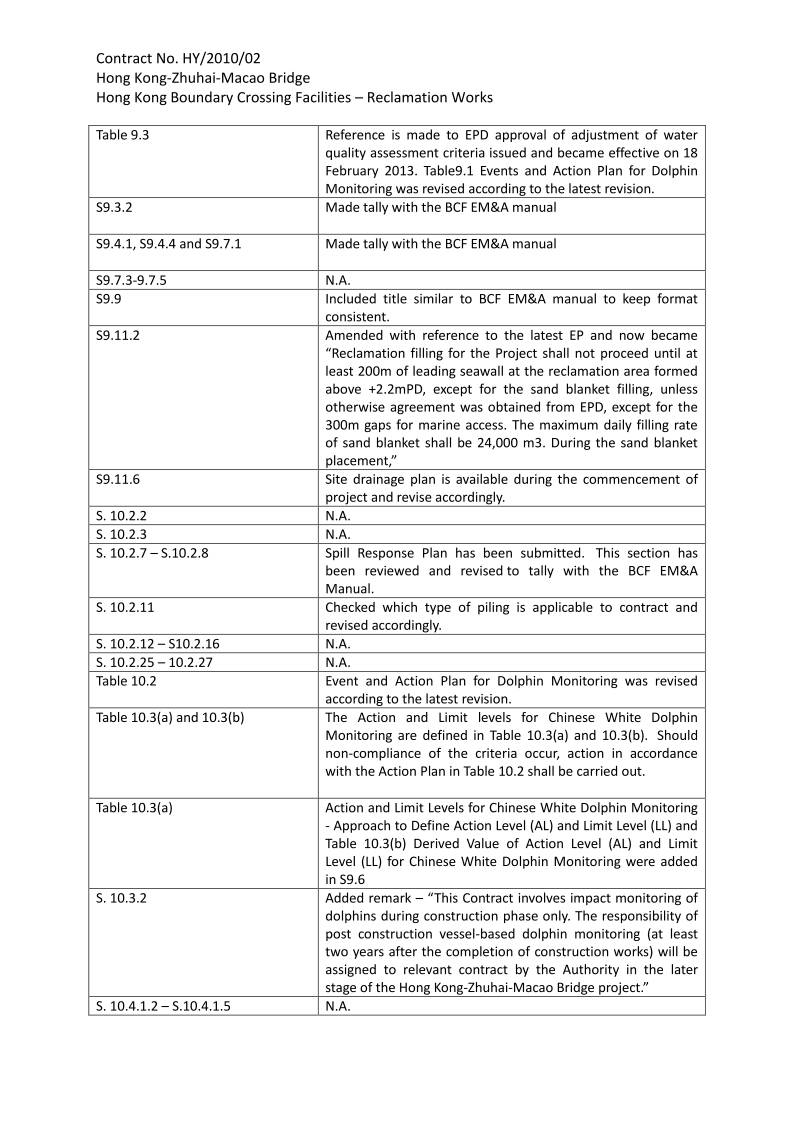

monitoring shall be established by two surveys per month in each survey area
stated in Section 9.3.3 for a period of three months prior to the commencement
of works and agreed with AFCD. The purpose of the baseline monitoring is
to establish pre-construction conditions prior to the commencement of the works
and to demonstrate the suitability of the proposed monitoring method.
10.5.2

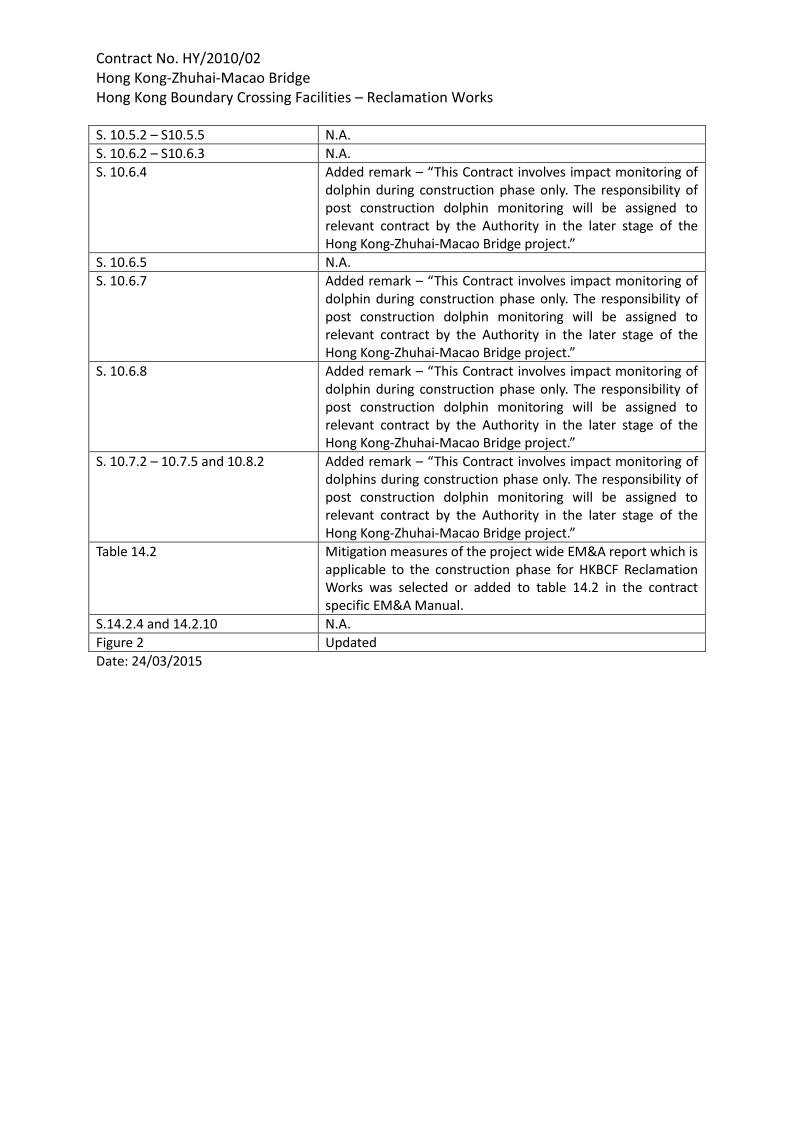

N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.5.3
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.5.4
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.5.5
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.6 Impact Monitoring for Ecology
10.6.1
Dolphin monitoring will be
conducted twice a month in each survey area stated in Section 10.4.1 throughout
the entire construction period.
10.6.2
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.6.3
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.6.4
Should dolphin sighting numbers,
density or the distribution pattern in the construction or post construction be significantly different (taking into
account naturally occurring alterations to distribution patterns such as due to
seasonal change) to the pre-construction baseline activity, the ET should
inform AFCD and investigate the possible causes of the change.
Appropriate actions and a further monitoring should be recommended and
additional mitigation measures should be implemented as necessary. Data
should then be re-assessed and the need for any further monitoring established. The monitoring results should be made available to
EPD, AFCD, ER and IEC within 2 weeks after the last survey day of the
monitoring month.
10.6.5
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
10.6.6
The data from impact
monitoring should be compared with the pre-construction baseline
findings. Any apparent differences in density among survey phases should
be analysed for trends and the statistical power of
the analysis to detect effects of the desired size should be tested.
Statistical procedures shall be used for data comparison. A range of applicable
statistical procedures exist (e.g., t-test, ANOVA and ANCOVA, etc.) and the ET
shall propose the procedure to be applied as part of the impact and
post-construction2 dolphin monitoring programme design to be agreed with AFCD prior to the
monitoring being undertaken.
10.6.7
Should dolphin sighting numbers,
density or the distribution pattern in the construction or post construction
phases2 be significantly different (taking into account naturally
occurring alterations to distribution patterns such as due to seasonal change)
to the pre-construction baseline activity, the ET should inform AFCD and
investigate the possible causes of the change. Appropriate actions and a
further monitoring should be recommended and additional mitigation measures
should be implemented as necessary. Data should then be re-assessed and
the need for any further monitoring established. The
monitoring results should be made available to EPD, AFCD, ER and IEC within 2
weeks after the last survey day of the monitoring month.
10.6.8
Comparison of the impact and
post-construction2 dolphin monitoring with that of over the
pre-construction baseline dolphin monitoring will allow the assessment of the
overall efficacy of the project-specific mitigation measures through the
implementation of an Event and Action Plan detailed in the Table 10.2.
Table 10.2 EVENT AND ACTION PLAN
Event
|
ET Leader
|
IEC
|
ER / SOR
|
Contractor
|
Action Level
|
1. Repeat statistical data analysis to confirm
findings;
2. Review all available and relevant data, including
raw data and statistical analysis results of other parameters covered in the
EM&A, to ascertain if differences are as a result of natural variation
or previously observed seasonal differences;
3. Identify source(s) of impact;
4. Inform the IEC, ER/SOR and Contractor;
5. Check monitoring data.
6. Review to ensure all the dolphin protective
measures are fully and properly implemented and advise on additional
measures if necessary.
|
1. Check monitoring data submitted by ET and
Contractor;
2. Discuss monitoring results and finding with the ET
and the Contractor.
|
1. Discuss monitoring with the IEC and any other
measures proposed by the ET;
2. If ER/SOR is satisfied with the proposal of any
other measures, ER/SOR to signify the agreement in writing on the measures
to be implemented.
|
1. Inform the ER/SOR and confirm notification of the
non-compliance in writing;
2. Discuss with the ET and the IEC and propose
measures to the IEC and the ER/SOR;
3. Implement the agreed measures.
|
Limit Level
|
1. Repeat statistical data analysis to confirm
findings;
2. Review all available and relevant data, including
raw data and statistical analysis results of other parameters covered in the
EM&A, to ascertain if differences are as a result of natural variation
or previously observed seasonal differences;
3. Identify source(s) of impact;
4. Inform the IEC, ER/SOR and Contractor of findings;
5. Check monitoring data;
6. Repeat review to ensure all the dolphin protective
measures are fully and properly implemented and advise
on additional measures if necessary.
7. If ET proves that the source of impact is caused by
any of the construction activity by the works contract, ET to arrange a
meeting to discuss with IEC, ER/SOR and Contractor the necessity of
additional dolphin monitoring and/or any other potential mitigation measures
(e.g., consider to modify the perimeter silt curtain or consider to
control/temporarily stop relevant construction activity etc.) and submit to
IEC a proposal of additional dolphin monitoring and/or mitigation measures
where necessary.
|
1. Check monitoring data submitted by ET and
Contractor;
2. Discuss monitoring results and findings with the ET
and the Contractor;
3. Attend the meeting to discuss with ET, ER/SOR and
Contractor the necessity of additional dolphin monitoring and any other
potential mitigation measures.
4. Review proposals for additional monitoring and any
other mitigation measures submitted by ET and Contractor and advise ER/SOR
of the results and findings accordingly.
5. Supervise / Audit the implementation of additional
monitoring and/or any other mitigation measures and advise ER/SOR the
results and findings accordingly.
|
1. Attend the meeting to discuss with ET, IEC and
Contractor the necessity of additional dolphin monitoring and any other
potential mitigation measures.
2. If ER/SOR is satisfied with the proposals for
additional dolphin monitoring and/or any other mitigation measures submitted
by ET and Contractor and verified by IEC, ER/SOR to signify the agreement in
writing on such proposals and any other mitigation measures.
3. Supervise the implementation of additional
monitoring and/or any other mitigation measures.
|
1. Inform the ER/SOR and confirm notification of the
non-compliance in writing;
2. Attend the meeting to discuss with ET, IEC and
ER/SOR the necessity of additional dolphin monitoring and any other
potential mitigation measures.
3. Jointly submit with ET to IEC a proposal of
additional dolphin monitoring and/or any other mitigation measures when
necessary.
4. Implement the agreed additional dolphin monitoring
and/or any other mitigation measures.
|
10.7
Post-construction Monitoring for Ecology
10.7.1
Dolphin monitoring will be conducted twice a
month in each survey area stated in Section 10.4.1 after completion of
construction.
10.7.2
The dolphin monitoring will be
conducted in the post-construction phase at least for 2 year after completion of
construction. Forty-eight survey events to be undertaken at a frequency of 2
per month over a period of 24 months should be conducted following cessation of
the construction.
10.7.3
The data from impact monitoring
should be compared with the pre-construction baseline findings. Any
apparent differences in density among survey phases should be analysed for trends and the statistical power of the
analysis to detect effects of the desired size should be tested.
Statistical procedures shall be used for data comparison. A range of applicable
statistical procedures exist (e.g., t-test, ANOVA and ANCOVA, etc.) and the ET
shall propose the procedure to be applied as part of the impact and
post-construction3 dolphin monitoring programme
design to be agreed with AFCD prior to the monitoring being undertaken.
10.7.4
Should dolphin sighting numbers,
density or the distribution pattern in the construction or post-construction3
phases be significantly different (taking into account naturally occurring
alterations to distribution patterns such as due to seasonal change) to the
pre-construction baseline activity, the ET should inform AFCD and investigate
the possible causes of the change. Appropriate actions and a further
monitoring should be recommended and additional mitigation measures should be
implemented as necessary. Data should then be re-assessed and the need
for any further monitoring established. The
monitoring results should be made available to EPD, AFCD, ER and IEC within 2
weeks after the last survey day of the monitoring month.
10.7.5
Comparison of the impact and
post-construction3 dolphin monitoring with that of over the
pre-construction baseline dolphin monitoring will allow the assessment of the
overall efficacy of the project-specific mitigation measures through the
implementation of an Action Plan detailed in the Table 10.2.
10.8 Event and Action Plan
10.8.1
The Action and Limit levels for
Chinese White Dolphin Monitoring are defined in Table
10.3(a) and 10.3(b). Should non-compliance of the criteria occur, action
in accordance with the Action Plan in Table 10.2 shall be carried out.
10.8.2
An action plan has been defined to
indicate that should dolphin numbers be significantly different (taking into
account naturally occurring alterations to distribution patterns such as due to
seasonal change) to the baseline monitoring activity following the impact and
post-construction3 monitoring, the ET should inform AFCD and
investigate the possible causes of the change. Appropriate actions and a
further monitoring should be recommended and additional mitigation measures
should be implemented as necessary. Data should then be re-assessed and
the need for any further monitoring established. The action plan should be
undertaken within a period of 1 month after a significant difference has been
determined.
10.8.3
For the purpose of the EM&A
works, the “significance” level which will trigger the action plan shall be
proposed by the ET as part of the post-construction monitoring programme
design to be agreed with AFCD and EPD prior to the monitoring being
undertaken.
Table 10.3a) Action
and Limit Levels for Chinese White Dolphin Monitoring
- Approach to Define Action Level (AL) and Limit Level (LL):
|
North Lantau Social
Cluster
|
|
NEL
|
NWL
|
Action Level
|
(STG < 70% of baseline) &
(ANI < 70% of baseline)
|
(STG < 70% of baseline) &
(ANI < 70% of baseline)
|
Limit Level
|
[(STG < 40% of baseline) & (ANI
< 40% of baseline)] AND
[ (STG < 40% of baseline) & (ANI
< 40% of baseline)]
|
For North Lantau Social Cluster, action level will be trigger if
either NEL or NWL fall below the criteria; limit level will be triggered if
both NEL and NWL fall below the criteria.
Table10.3(b) Derived Value of Action Level (AL) and Limit Level (LL) for Chinese
White Dolphin Monitoring
|
North Lantau Social Cluster
|
|
NEL
|
NWL
|
Action Level
|
(STG < 4.2) &
(ANI < 15.5 )
|
(STG < 6.9) &
(ANI < 31.3)
|
Limit Level
|
[(STG < 2.4) &
(ANI <8.9)] AND
[ (STG < 3.9)&
(ANI < 17.9)]
|
11
Fishery
11.1 Summary
11.1.1
The EIA report identified and
assessed the potential impacts related to fisheries and marine culture.
11.1.2
The water quality monitoring and
audit requirements are included in Section 9 Water Quality.
11.1.3
As mentioned in the EIA report, no
further monitoring and audit for fisheries are
required.
12
CulturAL Heritage
12.1 Summary
12.1.1
The marine archaeology
investigation (MAI) has concluded that there is no underwater cultural heritage
within the study area. No adverse impact on marine archaeological is
anticipated. Hence, further investigation or mitigation measure is not
required.
12.1.2
The HKBCF is located in the waters
to be north-east of the Airport. It would not have any impacts on known
built heritage and archaeological site. Mitigation measure is not
required for built heritage and terrestrial archaeology.
13
Hazard to life
13.1 Summary
13.1.1
The HKBCF is a newly reclaimed
site, it is anticipated that blasting work will not be required during construction
of the HKBCF. Therefore no explosives QRA is required and hence no mitigation
measure is required.
14
Landscape
& Visual Impact
14.1 Introduction
14.1.1
The EIA has recommended landscape
and visual mitigation measures to be undertaken during the construction phases
for HKBCF and southern landfall of TMCLKL. This section outlines the
monitoring and audit of these measures for HKBCF and southern landfall of
TMCLKL.
14.2 Monitoring Details
14.2.1
The design, implementation and
maintenance of landscape mitigation measures should be checked to ensure that
any potential conflicts between the proposed landscape measures and any other
works of the project would be resolved as early as practical without affecting
the implementation of the mitigation measures.
Table 14.1 Monitoring Programme
Stage
|
Monitoring
Task
|
Monitoring Report
|
Form of Approval
|
Frequency
|
Detailed
Design
|
Checking
of design works against the recommendations of the landscape and visual
impact assessments within the EIA should be undertaken during detailed design
phase and tender stage, to ensure that they fulfil the intention of the
mitigation measures. Any changes to the design, including design
changes on site should also be checked.
|
Not Required
|
Not Required
|
At
the end of the Detailed Design Phase
|
Construction
|
Checking
of the contractor’s operations during the construction period.
|
Report
on Contractor's compliance, by ET
|
Counter-signature
of report by IEC
|
Weekly
|
Notes:
§ Environmental
Team (ET) – employed by the Contractor;
Detailed Design Phase
14.2.2
The mitigation measures, which are proposed
in the EIA to mitigate the landscape and visual impacts, should be embodied
into the detailed engineering design, landscape design drawings and contract
documents. The Detailed Design should be checked during design stage and
before tender stage by a Registered Landscape Architect to ensure that the
measures are fully incorporated. Potential conflicts with civil engineering,
geotechnical, structural, lighting, signage, drainage and underground utilities
and operational requirements should resolved as early as practical.
Monitoring of design works against the recommendations of the landscape and
visual impact assessments within the EIA should be undertaken when the designs
are produced to ensure that they fulfill the intentions of mitigation measures.
14.2.3
The following mitigation measures
are proposed to avoid and reduce the identified impacts:
· Minimize
the footprint of project and that the quantity of landscape character units and
landscape resources affected;
· Minimize
temporary works areas for construction works; and
· Undertaking good site practices by applying hydroseeding on temporary stockpiles and reclamation areas.
14.2.4
N.A. (Not relevant to the Hong Kong
Boundary Crossing Facilities – Reclamation Works)
14.2.5
The following mitigation measures
should be monitored during construction phases:
Table 14.2
Mitigation Measures to be monitored during Construction Phase
14.2.6
An implementation programme will be prepared as required by TM-EIAO.
Reference will be made to the ETWB TC(W) No. 2/2004 on
Maintenance of Vegetation and Hard Landscape Features which defines the management
and maintenance responsibilities for natural vegetation and landscape works,
including both softworks and hardworks,
and the authorities for tree preservation and felling. The format of the
preliminary arrangement of implementation programme
is listed below:
Table 14.3
Proposed format for Preliminary Funding, Implementation, Management and
Maintenance Proposal
Mitigation items
|
Funding & Implementation unit(See Remark)
|
Maintenance unit(See Remark)
|
During
Construction
|
V1 and CM6
|
Project Proponent
(i.e. HyD)
|
The Contractor
|
G1/CM4, G9 and CM7
|
Project Proponent
(i.e. HyD)
|
HyD / LCSD
|
Note: The proposed mitigation
measures and arrangements are tentative. The responsible parties are also
tentative and subject to further agreements amongst the Government Departments.
Construction phase & Establishment Period
14.2.7
The implementation of landscape
construction works must be supervised by qualified Landscape Resident Site Staff
(Registered Landscape Architect, as defined by the Landscape Architect’s
Registration Board or Professional Member of the Hong Kong Institute of
Landscape Architects).
14.2.8
Measures to mitigate landscape and
visual impacts during construction should be checked to ensure compliance with
the intended aims of the measures.
14.2.9
The progress of the engineering
works shall be regularly reviewed on site to identify the earliest practical
opportunities for the landscape works to be undertaken.
Long Term Management (10 Years)
14.2.10 N.A. (Not relevant to the Hong Kong Boundary Crossing
Facilities – Reclamation
Works)
14.3
Baseline Monitoring
14.3.1
A one off survey shall be conducted
prior to commencement of any construction works. A photographic record of the
site at the time of the contractor’s possession of the site shall be prepared
by the Contractor and approved by the ER. The approved photographic
record shall be submitted to the Project Proponent, ET, IEC and EPD for record.
14.4 Action Plan for Landscape and
Visual Works
Table 14.4 Action Plan
EVENT
|
ACTION
|
ET
|
IEC
|
ER
|
CONTRACTOR
|
Conflicts occur
|
· Check Contractor’s final design conforms to the
requirements of EP and prepare checking report(s)
|
· Check and endorse ET’s report(s)
· Check and certify Contractor’s proposed design
· Recommend remedial design if necessary
|
· Under remedial design if necessary
|
-
|
Non-conformity
on one occasion
|
·
Identify Source
·
Inform IEC and ER
·
Discuss remedial actions with IEC, ER
and Contractor
·
Monitor remedial actions until rectification
has been completed
|
·
Check report
·
Check Contractor's working method
·
Discuss with ET and Contractor on
possible remedial measures
·
Advise ER on effectiveness of proposed
remedial measures.
·
Check implementation of remedial
measures.
|
·
Notify Contractor
·
Ensure remedial measures are properly
implemented
|
·
Amend working methods
·
Rectify damage and undertake any
necessary replacement
|
Repeated Non-conformity
|
·
Identify Source
·
Inform IEC and ER
·
Increase monitoring frequency
·
Discuss remedial actions with IEC, ER
and Contractor
·
Monitor remedial actions until
rectification has been completed
·
If non-conformity stops, cease
additional monitoring
|
·
Check monitoring report
·
Check Contractor's working method
·
Discuss with ET and Contractor on
possible remedial measures
·
Advise ER on effectiveness of proposed
remedial measures
·
Supervise implementation of remedial
measures.
|
·
Notify Contractor
·
Ensure remedial measures are properly
implemented
|
·
Amend working methods
·
Rectify damage and undertake any
necessary replacement
|
15
Site
Environmental Audit
15.1 Site Inspection
15.1.1
Site inspection provides a direct
means to initiate and enforce specified environmental protection and pollution
control measures. These shall be undertaken routinely to inspect construction
activities in order to ensure that appropriate environmental protection and
pollution control mitigation measures are properly implemented. Site
inspection is one of the most effective tools to enforce the environmental
protection requirements at the works area.
15.1.2
The ET Leader shall be responsible
for formulating the environmental site inspection, the deficiency and action
reporting system, and for carrying out the site inspection works. Within
21 days of the construction contract commencement, he shall submit a proposal
for site inspection and deficiency and action reporting procedures to the
Contractor for agreement, and to the ER for approval. The ET’s proposal
for rectification would be made known to the IEC.
15.1.3
Regular site inspections shall be
carried out at least once per week. The areas of inspection shall not be
limited to the environmental situation, pollution control and mitigation
measures within the site. It should also review the environmental situations
outside the works area which is likely to be affected, directly or indirectly,
by the site activities. The following information should be made
reference in conducting the inspection:
(i) EIA
recommendations on environmental protection and pollution control mitigation
measures;
(ii) works
progress and programme;
(iii)
individual works methodology proposals (which shall
include proposal on associated pollution control measures);
(iv)
contract specifications on environmental protection;
(v)
relevant environmental protection and pollution
control laws; and
(vi) previous site inspection results.
15.1.4
The Contractor shall keep the ET
Leader updated with all relevant information on the construction contract
necessary for him to carry out the site inspections. Inspection results
and associated recommendations for improvements to the environmental protection
and pollution control works shall be submitted to the IEC and the Contractor
within 1 working day. The Contractor shall follow the procedures and
time-frame as stipulated in the environmental site inspection, and the
deficiency and action reporting system formulated by the ET Leader, to report
on any remedial measures subsequent to the site inspections.
15.1.5
Ad-hoc site inspections shall also
be carried out if significant environmental problems are identified.
Inspections may also be required subsequent to receipt of an environmental
complaint, or as part of the investigation work, as specified in the Action
Plan for environmental monitoring and audit.
15.2 Compliance with Legal and
Contractual Requirements
15.2.1
There are contractual environmental
protection and pollution control requirements as well as environmental
protection and pollution control laws in Hong Kong with which construction
activities must comply.
15.2.2
In order that the works comply with
the contractual requirements, all works method statements submitted by the
Contractor to the ER for approval shall be sent to the ET Leader for vetting to
ensure sufficient environmental protection and pollution control measures have
been included. The implementation schedule of mitigation measures is summarised in Appendix B.
15.2.3
The ET Leader shall also review the
progress and programme of the works to check that
relevant environmental laws have not been violated, and that any foreseeable
potential for violating laws can be prevented.
15.2.4
The Contractor shall regularly copy
relevant documents to the ET Leader so that checking can be carried out.
The document shall at least include the updated Works Progress Reports, updated
Works Programme, any application letters for
different licence / permits under the environmental
protection laws, and copies of all valid licences /
permits. The site diary shall also be available for the ET Leader's
inspection upon his request.
15.2.5
After reviewing the document, the
ET Leader shall advise the IEC and Contractor of any non-compliance with
contractual and legislative requirements on environmental protection and
pollution control for them to take follow-up actions. If the ET Leader's
review concludes that the current status on licence /
permit application and any environmental protection and pollution control
preparation works may result in potential violation of environmental protection
and pollution control requirements, he shall also advise the Contractor and the
ER accordingly.
15.2.6
Upon receipt of the advice, the
Contractor shall undertake immediate actions to correct the situation.
The ER shall follow up to ensure that appropriate action has been taken in
order to satisfy contractual and legal requirements.
15.3 Environmental Complaints
15.3.1
Complaints shall be referred to the
ET Leader for action. The ET Leader shall undertake the following
procedures upon receipt of any complaint:
(i) log
complaint and date of receipt onto the complaint database and inform the IEC
immediately;
(ii) investigate the complaint to determine its validity, and
assess whether the source of the problem is due to works activities;
(iii) identify mitigation measures in consultation with the IEC if
a complaint is valid and due to works;
(iv) advise the Contractor if mitigation measures are required;
(v) review the Contractor's response to identified mitigation
measures, and the updated situation;
(vi) if the complaint is transferred from the EPD, submit interim
report to the EPD on status of the complaint investigation and follow-up action
within the time frame assigned by the EPD;
(vii) undertake additional monitoring and audit to verify the
situation if necessary, and review that circumstances leading to the complaint
do not recur;
(viii) report investigation results and subsequent actions to
complainant (if the source of complaint is EPD, the results should be reported
within the timeframe assigned by the EPD); and
(ix) record the complaint, investigation, the subsequent actions
and the results in the monthly EM&A
reports.
16.1 General
16.1.1
Reports can be provided in an
electronic medium upon agreeing the format with the ER and EPD. This would
enable a transition from a paper / historic and reactive approach to an
electronic / real time proactive approach. All the monitoring data
(baseline and impact) shall also be submitted on diskettes or other approved
media. The formats for air quality, noise and water quality monitoring
data to be submitted shall be separately agreed.
16.1.2
The ET is responsible for
establishing and maintaining a dedicated website throughout the entire
construction period for publishing the all the relevant environmental
monitoring data (including but not limited to the baseline and impact
monitoring). The ET shall propose the format and functionality of the
website for agreement with the ER and IEC prior to publishing of data.
Once the monitoring data are available (e.g. noise, dust, water quality etc)
and vetted by the IEC, the ET is responsible to upload the relevant data to the
dedicated website.
16.1.3
Types of reports that the ET Leader
shall prepare and submit include baseline monitoring report, monthly EM&A
report, quarterly EM&A summary report and final EM&A review
report. In accordance with Annex 21 of the EIAO-TM, a copy of the
monthly, quarterly summary and final review EM&A reports shall be made
available to the Director of Environmental Protection.
16.2 Baseline Monitoring Report
16.2.1
The ET Leader shall prepare and
submit a Baseline Environmental Monitoring Report within 10 working days of
completion of the baseline monitoring. Copies of the Baseline
Environmental Monitoring Report shall be submitted to the Contractor, the IEC,
the ER and EPD. The ET Leader shall liaise with the relevant parties on
the exact number of copies they require. The report format and baseline
monitoring data format shall be agreed with the EPD prior to submission.
16.2.2
The baseline monitoring report
shall include at least the following:
(i) up to half a
page executive summary;
(ii)
brief project background information;
(iii)
drawings showing locations of the baseline monitoring
stations;
(iv)
monitoring results (in both hard and diskette copies)
together with the following information:
monitoring
methodology;
name of
laboratory and types of equipment used and calibration details;
parameters
monitored;
monitoring
locations;
monitoring
date, time, frequency and duration; and
quality
assurance (QA) / quality control (QC) results and detection limits;
(v)
details of influencing factors, including:
major activities,
if any, being carried out on the site during the period;
weather
conditions during the period; and
other factors
which might affect results;
(vi) determination
of the Action and Limit Levels for each monitoring parameter and statistical analysis
of the baseline data, the analysis shall conclude if there is any significant
difference between control and impact stations for the parameters monitored;
(vii)
revisions for inclusion in the Contract Specific
EM&A Manual; and
(viii) comments, recommendations and conclusions.
16.3 Monthly EM&A Reports
16.3.1
The results and findings of all
EM&A work required in the Manual shall be recorded in the monthly EM&A
reports prepared by the ET Leader. The EM&A report shall be prepared
and submitted within 10 working days of the end of each reporting month, with
the first report due the month after construction commences. Each monthly
EM&A report shall be submitted to the following parties: the Contractor,
the IEC, the ER and EPD. Before submission of the first EM&A report,
the ET Leader shall liaise with the parties on the required number of copies
and format of the monthly reports in both hard copy and electronic medium.
16.3.2
The ET leader shall review the number
and location of monitoring stations and parameters every six months, or on as
needed basis, in order to cater for any changes in the surrounding environment
and the nature of works in progress.
First
Monthly EM&A Report
16.3.3
The first monthly EM&A report
shall include at least the following:
(i) Executive summary (1-2 pages):
breaches of
Action and Limit levels;
complaint
log;
notifications
of any summons and successful prosecutions;
reporting
changes; and
future key
issues.
(ii)
Basic project information:
project
organisation including key personnel contact names and telephone numbers;
programme;
management
structure, and
works
undertaken during the month.
(iii)
Environmental status:
works
undertaken during the month with illustrations (such as location of works,
daily excavation rate, etc); and
drawings
showing the project area, any environmental sensitive receivers and the
locations of the monitoring and control stations (with co-ordinates of the
monitoring locations).
(iv) A brief summary of EM&A
requirements including:
all
monitoring parameters;
environmental
quality performance limits (Action and Limit levels);
Event-Action
Plans;
environmental
mitigation measures, as recommended in the Project EIA study final reports; and
environmental
requirements in contract documents.
(v)
Implementation status:
advice on the
implementation status of environmental protection and pollution control /
mitigation measures, as recommended in the project EIA.
(vi) Monitoring results (in both hard and
diskette copies) together with the following information:
monitoring
methodology;
name of
laboratory and types of equipment used and calibration details;
parameters
monitored;
monitoring
locations;
monitoring
date, time, frequency, and duration;
weather
conditions during the period;
any other
factors which might affect the monitoring results; and
QA/QC results
and detection limits.
(vii) Report
on non-compliance, complaints, and notifications of summons and successful
prosecutions:
record of all
non-compliance (exceedances) of the environmental
quality performance limits (Action and Limit levels);
record of all
complaints received (written or verbal) for each media, including locations and
nature of complaints investigation, liaison and consultation undertaken,
actions and follow-up procedures taken, results and summary;
record of all notification of summons
and successful prosecutions for breaches of current environmental protection /
pollution control legislation, including locations and nature of the breaches,
investigation, follow-up actions taken, results and summary;
review of the
reasons for and the implications of non-compliance, complaints, summons and
prosecutions including review of pollution sources and working procedures; and
description
of the actions taken in the event of non-compliance and deficiency reporting
and any follow-up procedures related to earlier non-compliance.
(viii)
Others
an account of
the future key issues as reviewed from the works programme and work method
statements;
advice on the
solid and liquid waste management status; and
comments (for
examples, effectiveness and efficiency of the mitigation measures),
recommendations (for example, any improvement in the EM&A programme) and
conclusions.
Subsequent
EM&A Reports
16.3.4
Subsequent monthly EM&A reports
shall include the following:
(i) Executive summary (1 - 2 pages):
breaches of
Action and Limit levels;
complaints
log;
notifications
of any summons and successful prosecutions;
reporting
changes; and
future key
issues.
(ii)
Basic project information:
project
organisation including key personnel contact names and telephone numbers;
programme;
management
structure; and
work
undertaken during the month.
(iii)
Environmental status:
works
undertaken during the month with illustrations (such as location of works,
daily excavation rate, etc.); and
drawing
showing the project area, any environmental sensitive receivers and the
locations of the monitoring and control stations.
(iv) Implementation status:
advice on the
implementation status of environmental protection and pollution control /
mitigation measures, as recommended in the project EIA.
(v)
Monitoring results (in both hard and diskette copies) together with the
following information:
monitoring
methodology;
name of
laboratory and types of equipment used and calibration details;
parameters
monitored;
monitoring
locations;
monitoring
date, time, frequency, and duration;
weather
conditions during the period;
any other
factors which might affect the monitoring results; and
QA / QC
results and detection limits.
(vi) Report on non-compliance, complaints,
and notifications of summons and successful prosecutions:
record of all
non-compliance (exceedances) of the environmental
quality performance limits (Action and Limit levels);
record of all
complaints received (written or verbal) for each media, including locations and
nature of complaints investigation, liaison and consultation undertaken,
actions and follow-up procedures taken, results and summary;
record of all notification of summons
and successful prosecutions for breaches of current environmental protection /
pollution control legislation, including locations and nature of the breaches,
investigation, follow-up actions taken, results and summary;
review of the
reasons for and the implications of non-compliance, complaints, summons and
prosecutions including review of pollution sources and working procedures; and
description
of the actions taken in the event of non-compliance and deficiency reporting
and any follow-up procedures related to earlier non-compliance.
(vii)
Others
an account of
the future key issues as reviewed from the works programme and work method
statements;
advice on the
solid and liquid waste management status; and
comments (for
examples, effectiveness and efficiency of the mitigation measures),
recommendations (for example, any improvement in the EM&A programme) and
conclusions.
(viii)
Appendices
Action and
Limit levels;
graphical
plots of trends of monitored parameters at key stations over the past four
reporting periods for representative monitoring stations annotated against the
following:
a) major activities being carried out on site during the
period;
b) weather conditions during the period; and
c) any other factors that might affect the monitoring results.
· monitoring
schedule for the present and next reporting period;
· cumulative statistics on complaints, notifications of
summons and successful prosecutions; and
· outstanding issues and deficiencies.
16.4 Quarterly EM&A Summary Reports
16.4.1
A quarterly EM&A summary report
of around 5 pages shall be produced and shall contain at least the following
information:
(i) Executive summary (1 - 2 pages);
(ii) Basic
project information including a synopsis of the project organisation,
programme, contacts of key management, and a synopsis of works undertaken
during the quarter;
(iii)
A brief summary of EM&A requirements including:
· monitoring
parameters;
· environmental quality performance limits (Action and Limit
levels); and
· environmental mitigation measures, as recommended in the
Project EIA Final Reports;
(iv)
Advice on the implementation status of environmental protection and pollution
control / mitigation measures, as recommended in the project EIA Final Report,
summarised in the updated implementation schedule;
(v)
Drawings showing the project area, any environmental sensitive receivers and
the locations of the monitoring and control stations;
(vi) Graphical plots of any trends in
monitored parameters over the past four months (the last month of the previous
quarter and the present quarter) for representative monitoring stations
annotated against:
· the major activities being carried out on site during the
period;
· weather conditions during the period; and
· any other factors which might affect the monitoring results;
(vii)
Advice on the solid and liquid waste management status;
(viii) A
summary of non-compliance (exceedances) of the
environmental quality performance limits (Action and Limit levels);
(ix)
A brief review of the reasons for and the implications of any non-compliance,
including a review of pollution sources and
working procedures;
(x)
A summary description of actions taken in the event of non-compliance and any
follow-up procedures related to any earlier non-compliance;
(xi)
A summarised record of all complaints received (written or verbal) for each
media, liaison and consultation undertaken, actions and follow-up procedures
taken;
(xii)
Comments (for examples, a review of the effectiveness and efficiency of the
mitigation measures and the performance of the environmental management system,
that is, of the overall EM&A programme); recommendations (for example, any
improvement in the EM&A programme) and conclusions for the quarter; and
(xiii)
Project Proponent’s contacts and any hotline telephone number for the public to
make enquiries.
16.5 Annual/Final EM&A Review Reports
16.5.1
The final EM&A report should
contain at least the following information:
(i) Executive summary (1 - 2 pages);
(ii) Drawings
showing the project area, any environmental sensitive receivers and the
locations of the monitoring and control stations;
(iii) Basic
project information including a synopsis of the project organisation, contacts
of key management, and a synopsis of work undertaken during the course of the
project or past twelve months;
(iv) A brief summary of EM&A
requirements including:
· environmental mitigation measures, as recommended in the
Project EIA Reports;
· environmental impact hypotheses tested;
· environmental quality performance limits (Action and Limit
levels);
· all
monitoring parameters;
· Event-Action
Plans;
(v)
A summary of the implementation status of environmental protection and
pollution control / mitigation measures, as recommended in the project EIA
Report, summarised in the updated implementation schedule;
(vi) Graphical plots and the statistical
analysis of the trends of monitored parameters over the course of the project,
including the post-project monitoring (or the past twelve months for annual
reports) for all monitoring stations annotated against:
· the major activities being carried out on site during the
period;
· weather conditions during the period; and
· any other factors which might affect the monitoring results;
· The return of ambient environmental conditions in comparison
with baseline data.
(vii)
A summary of non-compliance (exceedances) of the
environmental quality performance limits (Action and Limit levels);
(viii)
A review of the reasons for and the implications of non-compliance including
review of pollution sources and working procedures as appropriate;
(ix)
A description of the actions taken in the event of non-compliance;
(x)
A summary record of all complaints received (written or verbal) for each media,
liaison and consultation undertaken, actions and follow-up procedures taken;
(xi)
A summary record of notifications of summons and successful prosecutions for
breaches of the current environmental protection / pollution control
legislation, locations and nature of the breaches, investigation follow-up
actions taken and results;
(xii) A
comparison of the EM&A data with the EIA predictions with annotations and
explanations for any discrepancies, including a review of the validity of EIA
predictions and identification of shortcomings in the EIA recommendations.
(xiii) A
review of the monitoring methodology adopted and with the benefit of hindsight,
comment on its effectiveness, including cost effectiveness
(xiv) A
review of success of the EM&A programme, including
a review of the effectiveness and efficiency of the mitigation measures, and
recommendations for any improvements in the EM&A programme.
(xv) A
clear cut statement on the environmental acceptability of the project with
reference to specific impact hypotheses and a conclusion to state the return to
ambient and/or the predicted scenario as the EIA findings.
16.6
Data Keeping
16.6.1
No site-based documents (such as
monitoring field records, laboratory analysis records, site inspection forms,
etc.) are required to be included in the monthly EM&A reports.
However, any such document shall be well kept by the ET Leader and be ready for
inspection upon request. All relevant information shall be clearly and
systematically recorded in the document. Monitoring data shall also be
recorded in magnetic media form, and the software copy must be available upon
request. Data format shall be agreed with EPD. All documents and
data shall be kept for at least one year following completion of the
construction contract.
16.7 Interim Notifications of
Environmental Quality Limit Exceedances
16.7.1
With reference to the Event and
Action Plan, when the environmental quality performance limits are exceeded,
the ET Leader shall immediately notify the IEC and EPD, as appropriate.
The notification shall be followed up with advice to IEC and EPD on the results
of the investigation, proposed actions and success of the actions taken, with
any necessary follow-up proposals. A sample template for the interim
notifications is presented in Appendix F.
