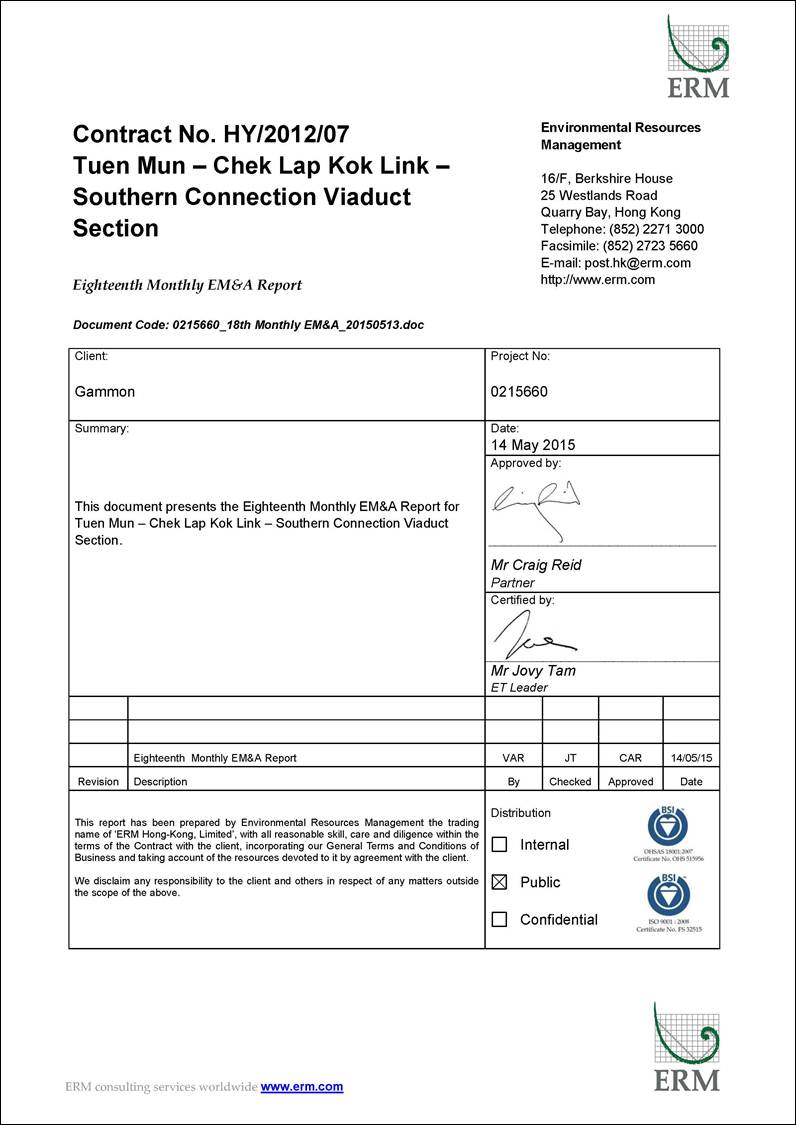

Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of the Tuen Mun ¡V Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON
Hong Kong Ltd. was employed by the HyD as the
Independent Environmental Checker (IEC) and Environmental Project Office (ENPO)
in accordance with Environmental Permit
No. EP-354/2009/A.
Further applications for variation of
environmental permit (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
The
construction phase of the Contract commenced on 31 October 2013 and will tentatively
be completed by 2018. The impact
monitoring of the EM&A programme, including air quality, noise, water
quality and marine ecological monitoring as well as environmental site
inspections, commenced on 31 October 2013.
This
is the Eighteenth Monthly EM&A report presenting the EM&A works carried
out during the period from 1 to 30 April 2015 for the Southern
Connection Viaduct Section in accordance with the Updated EM&A Manual of the
TM-CLK Link Project. As informed by the Contractor, major
activities in the reporting period included:
Marine Works
¡P
Construction and installation of pile caps;
¡P
Marine piling platform installation &
uninstallation;
¡P
Pier construction;
¡P
Installation of launching gantry;
¡P
Marine piling; and,
¡P
Installation of pier head segment.
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Drainage works;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Tree survey, felling and transplanting;
¡P
Utility surveys; and
¡P
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
A summary of
monitoring and audit activities conducted in the reporting period is listed
below:
24-hour
TSP monitoring 6
sessions
1-hour
TSP monitoring 6
sessions
Noise
monitoring 6
sessions
Impact
Water Quality Monitoring 13
sessions
Impact
Dolphin Monitoring 2
sessions
Joint
Environmental site inspection 5
sessions
Breaches of Action and Limit Levels for Air Quality
No exceedance
of Action and Limit Levels was recorded for construction air monitoring in the
reporting month.
Breaches of Action and Limit Levels for Noise
No exceedance
of Action and Limit Levels was recorded for construction noise monitoring in
the reporting month.
Breaches of Action and Limit Levels for Water Quality
No exceedance
of Action and Limit Levels was recorded for water quality monitoring in the
reporting month.
Impact Dolphin Monitoring
During
this month of dolphin monitoring, no unacceptable impact from the construction
activities of the TM-CLKL Southern Connection Viaduct Section on Chinese White
Dolphins was noticeable from general observations. Due to monthly variation in dolphin
occurrence within the study area, it would be more appropriate to draw
conclusion on whether any impacts on dolphins have been detected related to the
construction activities of the TM-CLKL Southern Connection Viaduct Section in
the quarterly EM&A reports, where comparison on distribution, group size
and encounter rates of dolphins between the quarterly impact monitoring period and
baseline monitoring period will be made.
Daily
marine mammal exclusion zone monitoring was undertaken during the period of
marine works under this Contract. Passive Acoustic Monitoring (PAM) was
implemented when the marine piling works were carried out outside the daylight
hours in this reporting month. No sighting of the Indo-Pacific humpback dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was recorded in April 2015 during the exclusion
zone monitoring.
Environmental Complaints, Non-compliance & Summons
No
environmental complaint, notification of summons and successful prosecution was
received in the reporting month.
Reporting Change
The separate checklist for Landscape and Visual
(L&V) mitigation measures monitoring was implemented in the reporting
period.[JY1]
Upcoming Works for the Next Reporting Period
Works to be
undertaken in the next monitoring period of May 2015 include the following:
Marine
Works
¡P
Construction and installation of pile caps;
¡P
Marine piling platform installation & uninstallation;
¡P
Pier construction;
¡P
Installation of launching gantry;
¡P
Marine piling and
¡P
Installation of pier head segment.
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Drainage works;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Tree survey, felling and transplanting;
¡P
Relocation of MTRC fence; and
¡P
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
Future Key Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of May 2015 are mainly associated with dust, noise,
marine water quality, marine ecology and waste management issues.
According to
the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure
Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau
Link and North Lantau Highway would be operating beyond capacity after 2016. This forecast has been based on the
estimated increase in cross boundary traffic, developments in the Northwest New
Territories (NWNT), and possible developments in North Lantau, including the
Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong ¡V
Zhuhai ¡V Macao Bridge (HZMB). In
order to cope with the anticipated traffic demand, two new road sections
between NWNT and North Lantau ¡V Tuen Mun ¡V Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The
EIA Report was submitted under the Environmental Impact Assessment Ordinance
(EIAO) in August 2009. Subsequent
to the approval of the EIA Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (EP-354/2009/A)
was issued on 8 December 2010.
Under
Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Southern
Connection Viaduct Section of TM-CLKL (¡§the Contract¡¨) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON
Hong Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO) in
accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of
environmental permit (VEP), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The
organization structure of the Contract is shown in Appendix A. The key personnel contact names and
contact details are summarized in Table
1.1 below.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD
(Highways Department) |
Project Coordinator
|
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior
Engineer |
Steven Shum |
2762 4133 |
3188 6614 |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident
Engineer |
Kingman Chan |
3691 3950 |
3691 2899 |
ENPO / IEC (ENVIRON Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465 2888 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3465 2828 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Marine
Works
¡P
Construction and installation of pile caps;
¡P
Marine piling platform installation &
uninstallation;
¡P
Pier construction;
¡P
Installation of launching gantry;
¡P
Marine piling; and,
¡P
Installation of pier head segment.
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Drainage works;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Tree survey, felling and transplanting;
¡P
Utility surveys; and
¡P
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
The

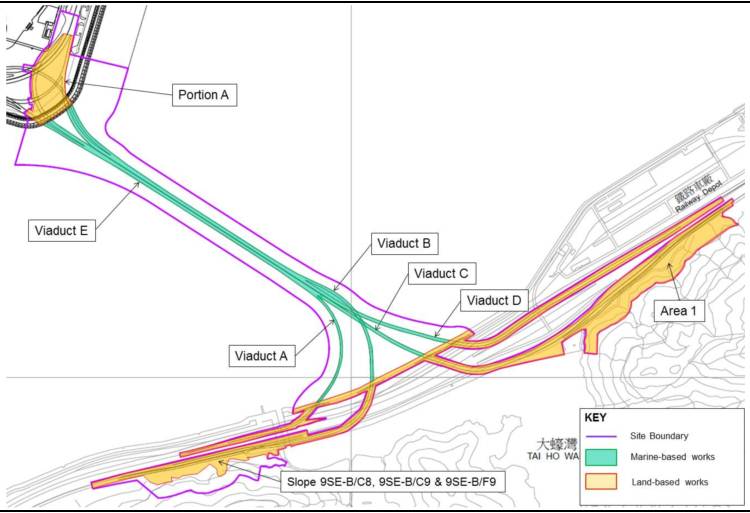

locations of the construction activities are shown in Figure 1.3. The Environmental Sensitive Receivers in
the vicinity of the Project are shown in Figure 1.4.
The EM&A
programme required environmental monitoring for air quality, noise, water
quality and marine ecology as well as environmental site inspections for air
quality, noise, water quality, waste management, marine ecology and landscape
and visual impacts. The EM&A
requirements and related findings for each component are summarized in the
following sections.
Table 2.1 Locations
of Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
Description |
Monitoring Dates |
ASR 9 |
MTR Depot |
On the
ground nearby MTR Depot Entrance |
6, 9, 15,
21, 27 and 30 April 2015 |
ASR 8A |
Area 4 |
On ground at
the works area, Area 4 |
6, 9, 15,
21, 27 and 30 April 2015 |
High Volume Samplers (HVSs) were used for carried out 1-hour and 24-hour
TSP monitoring on 6, 9, 15, 21, 27 and 30 April 2015 at ASR8A and ASR9 in accordance with the
requirements of the Updated EM&A Manual. The TSP monitoring stations are
illustrated in Figure 2.1 and detailed
in Table 2.1. Wind anemometer was deployed at Area 4
for logging wind speed and wind direction.
Copies of the calibration certificates for the
equipment are presented in Appendix E.
Details of the deployed equipment are given in Table 2.2.
Table 2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow
Controlled Total Suspended Particulate (TSP) High
Volume Sampler (Model No. TE-5170) |
Wind Sensor |
Global Water (Wind Speed
Sensor: WE550; Wind Direction Sensor: WE570) |
Wind Anemometer for
calibration |
Lutron (Model No.
AM-4201) |
Table 2.3 Summary
of 1-hour TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
86 |
59
- 124 |
394 |
500 |
ASR
9 |
112 |
59
- 217 |
393 |
500 |
Table 2.4 Summary
of 24-hour TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
56 |
50
- 60 |
178 |
260 |
ASR
9 |
65 |
56
¡V 72 |
178 |
260 |
All
1-hour and 24-hour TSP results were below the Action and Limit levels at all
monitoring locations in the reporting period. No action is thus required to be
undertaken in accordance with the Event Action Plan presented in Appendix L.
Meteorological
information collected at ASR8A including
wind speed and wind direction is provided in Appendix H.
Noise
monitoring was performed on 6, 9, 15, 21, 27 and 30 April 2015 by using sound level meter at the designated monitoring
station NSR1A (Figure 2.2; Table 2.5)
in accordance with the requirements stipulated in the Updated EM&A
Manual. Acoustic calibrator was
deployed to check the sound level meters at a known sound pressure level. Details of the deployed equipment are
provided in Table 2.6. Copies of the calibration certificates
for the equipment are presented in Appendix E.
Table 2.5 Location
of Impact Noise Monitoring Station
Monitoring Station |
Location |
Description |
Parameter |
Frequency and Duration |
Monitoring Dates |
NSR 1A |
Pak Mong Village Pavilion |
On the
ground at the village entrance |
30-minute
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. |
At least
once per week |
6, 9, 15,
21, 27 and 30 April 2015 |
Table 2.6 Noise
Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic
Calibrator |
Rion
NC-73 |
Table 2.7 Summary
of Construction Noise Monitoring Results in the Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
|
NSR
1A |
60 |
57
¡V 61 |
75 |
|
Table 2.8 Locations
of Impact Water Quality Monitoring Stations and its Corresponding Monitoring
Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Frequency |
Depth |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact Station
(Close to HKBCF construction site) |
813273 |
818850 |
Temperature(¢XC)
pH (pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) ¡P
SS (mg/L) |
Impact monitoring: 3 days per week, at mid-flood and
mid-ebb tides during the construction period of the Contract |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed. If
the water depth is less than 3m, mid-depth sampling only. If water depth less than 6m, mid-depth
may be omitted |
IS(Mf)16 |
Impact Station
(Close to HKBCF construction site) |
814328 |
819497 |
|||
IS8 |
Impact Station
(Close to HKBCF construction site) |
814251 |
818412 |
|||
SR4 |
Sensitive receiver
(Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|||
*Notes: |
Table 2.9 Water
Quality Monitoring Equipment
Equipment |
Brand and Model |
DO and Salinity |
YSI Pro2030 |
Turbidity meter |
HACH Model 2100Q |
pH meter |
HANNA HI8314 |
Positioning
Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
Although
depth-averaged
SS on 2 and 7 April during ebb-tide and flood-tide, and 28 April during
ebb-tide were observed higher than the Action Level[JY2] [JY3] ,
the results were lower than 120% of the upstream control at the same tide of
the same day. As such, the above
depth-averaged SS results were considered as sporadic events of natural
variation in water quality. No
Action and Limit levels exceedances was thus recorded at all monitoring
stations for impact water quality monitoring in the reporting month. No action was required to be undertaken
in accordance with the Event Action Plan presented in Appendix L.
Table
2.10 Dolphin
Monitoring Equipment
Equipment |
Model |
|
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom
lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and
reticules 65 foot single engine motor vessel with viewing platform 4.5m above
water level |
|
Table
2.11 Impact
Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start Point |
804671 |
814577 |
13 |
Start Point |
816506 |
819480 |
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
2 |
Start Point |
805475 |
815457 |
14 |
Start Point |
817537 |
820220 |
2 |
End Point |
805477 |
826654 |
14 |
End Point |
817537 |
824613 |
3 |
Start Point |
806464 |
819435 |
15 |
Start Point |
818568 |
820735 |
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
4 |
Start Point |
807518 |
819771 |
16 |
Start Point |
819532 |
821420 |
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
5 |
Start Point |
808504 |
820220 |
17 |
Start Point |
820451 |
822125 |
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
6 |
Start Point |
809490 |
820466 |
18 |
Start Point |
821504 |
822371 |
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
7 |
Start Point |
810499 |
820690 |
19 |
Start Point |
822513 |
823268 |
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
8 |
Start Point |
811508 |
820847 |
20 |
Start Point |
823477 |
823402 |
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
9 |
Start Point |
812516 |
820892 |
21 |
Start Point |
805476 |
827081 |
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
10 |
Start Point |
813525 |
820872 |
22 |
Start Point |
806464 |
824033 |
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
11 |
Start Point |
814556 |
818449 |
23 |
Start Point |
814559 |
821739 |
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
12 |
Start Point |
815542 |
818807 |
|
|
|
|
12 |
End Point |
815542 |
824882 |
|
|
|
|
The Action and
Limit levels of dolphin impact monitoring are shown in Appendix D. The Event and Action plan is presented
in Appendix L.
Encounter rates of Chinese White Dolphins are deduced
from the survey effort and on-effort sighting data made under favourable conditions (Beaufort 3 or below) in April 2015
are shown in Tables 2.12 and 2.13.
Table 2.12 Individual
Survey Event Encounter Rates
|
|
Encounter rate (STG) (no. of on-effort
dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per 100 km of survey
effort) |
Primary
Lines Only |
Primary
Lines Only |
||
NEL |
Set
1: Apr 8th / 10th |
0.0 |
0.0 |
Set
2: Apr 17th / 22nd |
0.0 |
0.0 |
|
NWL |
Set
1: Apr 8th / 10th |
1.4 |
4.2 |
Set
2: Apr 17th / 22nd |
0.0 |
0.0 |
|
Note: Dolphin Encounter Rates are deduced
from the two sets of surveys ( two surveys in each set) in April 2015 in Northeast
(NEL) and Northwest Lantau (NWL) |
Table 2.13 Monthly
Average Encounter Rates
|
Encounter rate (STG)
(no. of
on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per
100 km of survey effort) |
||
Primary Lines Only |
Both Primary and Secondary Lines |
Primary Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
0.7 |
1.1 |
2.2 |
6.3 |
Note:
Overall dolphin encounter rates (sightings per 100 km of survey effort)
from all four surveys are conducted in April 2015 on primary lines only as well
as both primary lines and secondary lines in Northeast and Northwest Lantau
The average group size of Chinese White Dolphins in
April 2015 was 4.33 individuals per group, which was slightly higher than the
ones in previous months of dolphin monitoring. Two (2) of the three (3) dolphin groups
were composed of two to three (2-3) dolphins, while another larger group of
eight (8) dolphins were also sighted during the monitoring period.
No
unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Chinese White Dolphins was noticeable from
general observations during the dolphin monitoring in this reporting month.[JY4]
Daily 250 m marine
mammal exclusion zone monitoring was undertaken during the period of marine works
activities being undertaken.
Passive Acoustic Monitoring (PAM) was implemented when the marine piling
works were carried out outside the daylight hours in this reporting month. No sighting of Indo-Pacific humpback
dolphin Sousa chinensis
(i.e. Chinese White Dolphin) were recorded in April 2015 during the exclusion
zone monitoring.
Table 2.14 Specific
Observations Identified during the Weekly Site Inspections in this Reporting
Month
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
2 April 2015 |
Dockyard
near Area 23 ¡P
Drip trays were not plugged. Area 1 ¡P
Soil stockpile was not covered. |
Dockyard
near Area 23 ¡P
Drip trays should be plugged. Area 1 ¡P
Soil stockpile should be covered by tarpaulin sheet
or watered to avoid dust emission. |
9 April 2015 |
Pier E13AB ¡P
The updated checklist for wetsep
was not displayed. Pier E9 ¡P
A generator was not placed on acoustic decoupling
pad. |
Pier E13AB ¡P
The updated checklist should be displayed at the wetsep. Pier E9 ¡P
Operating generators on marine platform should be
placed on acoustic decoupling pad. |
15 April
2015 |
Slope B/F9 ¡P
The exposed area was partially dry. Pier B14 ¡P
The updated EP was not displayed. Pier D12 ¡P
The updated EP was not displayed. ¡P
A drip tray for generator was not plugged. |
Slope B/F9 ¡P
Watering was applied immediately. Pier B14 ¡P
The updated EP should be displayed. Pier D12 ¡P
The updated EP should be displayed. ¡P
The drip tray should be plugged. |
22 April
2015 |
Seafront ¡P
Some chemical containers were not placed in drip
trip. Pier D3 ¡P
Gutter was not properly installed. Pier E11 ¡P
A generator was not placed on acoustic decoupling
pad. |
Seafront ¡P
Chemical containers should be placed in drip trip. Pier D3 ¡P
Gutter should be properly installed. Pier E11 ¡P
Generator on marine platform should be placed on acoustic
decoupling pad. |
30 April
2015 |
Pier ACD1 ¡P
A drip tray for generator was placed without
acoustic decoupling pad and containing stagnant water. ¡P
A drip tray for
generator was not plugged. |
Pier ACD1 ¡P
Acoustic decoupling pad should be provided and stagnant
water should be removed. ¡P
A drip tray for
generator should be plugged. |
The Contractor
has rectified all of the observations identified during environmental site
inspections in the reporting month.
The Contractor
has submitted application form for registration as chemical waste producer
under the Contract. Sufficient
numbers of receptacles were available for general refuse collection and
sorting.
Wastes
generated during this reporting period include mainly construction wastes
(inert and non-inert) and recyclable materials. Reference has been made to the waste
flow table prepared by the Contractor (Appendix
M). The quantities of different
types of wastes are summarized in Table
2.15.
Table 2.15 Quantities
of Different Waste Generated in the Reporting Period
Month/Year |
Inert C&D Materials (a) (m3) |
Imported Fill (m3) |
Inert Construction Waste Re-used (m3) |
Non-inert Construction Waste (b) (kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
Category L |
Category M (Mp & Mf) |
|||||||
April 2015 |
7,694 |
0 |
1,885 |
133,630 |
105 |
0 |
0 |
0 |
Notes: |
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber, felled trees
and others. |
The Contractor
was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials and
wastes. The Contractor was also
reminded to properly maintain the site tidiness and dispose of the wastes
accumulated on site regularly and properly.
For chemical
waste containers, the Contractor was reminded to treat properly and store
temporarily in designated chemical waste storage area on site in accordance
with the Code of Practice on the Packaging, Labelling and Storage of Chemical
Wastes.
The status of
environmental licensing and permit is summarized in Table 2.16 below.
Table 2.16 Summary
of Environmental Licensing and Permit Status
License/
Permit |
License
or Permit No. |
Date of Issue |
Date of Expiry |
License/
Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/D |
13 March 2015 |
N/A |
HyD |
Tuen Mun- Chek
Lap Kok Link |
Construction Dust Notification |
361571 |
5 Jul 2013 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17 Jul 2013 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong
Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Chemical Waste Registration |
5213-951-G2380-17 |
12 Jun 2014 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Construction Waste Disposal Account |
7017735 |
10 Jul 2013 |
N/A |
GCL |
- |
Construction Waste Disposal Account |
7019470 |
3 Mar 2014 |
N/A |
GCL |
Vessel CHIT Account |
Waste Water Discharge License |
WT00019017-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for land portion |
Construction
Noise Permit |
Nil |
N/A |
N/A |
GCL |
For Piling Works |
Construction
Noise Permit for night works and works in general holidays |
GW-RW0093-15 |
26 Feb 2015 |
26 Aug 2015 |
GCL |
General
works at WA5 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0307-15 |
27 Mar 2015 |
27 Sep 2015 |
GCL |
For
Load unload at NLH near Viaduct D |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0470-14 |
29 Apr 2015 |
28 Oct 2015 |
GCL |
For
Broad Permit |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0078-15 |
28 Jan 2015 |
29 Jul 2015 |
GCL |
For
Plant mobilization using tractor with trailer |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0326-15 |
30 Mar 2015 |
31 May 2015 |
GCL |
B9-B16
Pier Head Segments Erection |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0137-15 |
12 Feb 2015 |
15 Aug 2015 |
GCL |
Pre-casted
pile cap shell installation at E10-E13 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0212-15 |
2 Mar 2015 |
4 Jun 2015 |
GCL |
Pier
A8A9 Safety Fence Erection |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0225-15 |
13 Mar 2015 |
12 May 2015 |
GCL |
TTA
Case 009 Ch.2.1E-4.2E |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0266-15 |
20 Mar 2015 |
30 Apr 2015 |
GCL |
B8
Pier Head Segment Erection and Formwork Installation |
Marine
Dumping Permit |
EP/MD/16-002 |
17 Apr 2015 |
26 May 2015 |
GCL |
For dumping Type I (Dedicated Site) and Type II
sediment |
Marine
Dumping Permit |
EP/MD/15-257 |
2 Apr 2015 |
7 Oct 2015 |
GCL |
For dumping
Type I sediment |
The landscape
and visual (L&V) mitigation measures were also monitored on weekly basis in
the reporting period. The
monitoring status is summarized in Appendix C.
No complaint,
notification of summons and prosecution was received in the reporting period.
Statistics on
complaints, notifications of summons, successful prosecutions are summarized in
Appendix N.
Marine
Works
¡P
Construction and installation of pile caps;
¡P
Marine piling platform installation &
uninstallation;
¡P
Pier construction;
¡P
Installation of launching gantry;
¡P
Marine piling and
¡P
Installation of pier head segment.
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Drainage works;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Tree survey, felling and transplanting;
¡P
Relocation of MTRC fence; and
¡P
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of May 2015 are mainly associated with dust, noise,
marine water quality, marine ecology and waste management issues.
This
Eighteenth Monthly EM&A Report presents the findings of the EM&A
activities undertaken during the period from 1 to 30 April 2015, in accordance
with the Updated EM&A Manual and the requirements of the Environmental Permit (EP-354/2009/D).
Three (3)
groups of thirteen (13) Chinese White Dolphins were sighted during the two sets
of monitoring surveys in April 2015.
All sightings were made in NWL, with no dolphin being sighted at all in
NEL. During surveys in April 2015,
only one (1) of the three (3) sightings was made on primary lines during
on-effort search, and none of the dolphin groups was associated with operating
fishing vessel. No sighting was
made in the proximity of the Project¡¦s alignment. During this month of dolphin monitoring, no
unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Chinese White Dolphins was noticeable from
general observations.
The ET will
keep track on the construction works to confirm compliance of environmental
requirements and the proper implementation of all necessary mitigation
measures.
