Table of Contents
Executive Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Noise Monitoring
2.3 Water Quality Monitoring
2.4 Dolphin monitoring
2.5 EM&A Site inspection
2.6 Waste Management Status
2.7 Environmental Licenses and Permits
2.8 Implementation Status of Environmental Mitigation Measures
2.9 Summary of Exceedances of the Environmental Quality Performance Limit
2.10 Summary of Complaints, Notification of Summons and Successful
Prosecutions
3.1 Construction Programme for the Coming Months
3.2 Key Issues for the Coming Month
3.3 Monitoring Schedule for the Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
List of Appendices
Appendix A Project Organization for
Environmental Works
Appendix B Three Month Rolling Construction
Programmes
Appendix C Implementation Schedule of
Environmental Mitigation Measures (EMIS)
Appendix D Summary of Action and Limit Levels
Appendix E Calibration Certificates of
Monitoring Equipment
Appendix F EM&A Monitoring Schedules
Appendix G Impact Air Quality Monitoring
Results and Graphical Presentation
Appendix H Meteorological Data for the
Reporting Month
Appendix I Impact Noise Monitoring Results and
Graphical Presentation
Appendix J Impact Water Quality Monitoring
Results and Graphical Presentation
Appendix K Impact Dolphin Monitoring Survey
Results
Appendix L Event Action Plan
Appendix M Monthly Summary of Waste Flow Table
Under
Contract No. HY/2012/07, Gammon Construction Limited (GCL) is commissioned by the
Highways Department (HyD) to undertake the design and
construction of the Southern Connection Viaduct Section of the Tuen Mun – Chek
Lap Kok Link Project (TM-CLK Link Project) while AECOM Asia Company Limited was
appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET). Ramboll
Environ Hong Kong Ltd. was employed by the HyD as the
Independent Environmental Checker (IEC) and Environmental Project Office (ENPO)
in accordance with Environmental Permit
No. EP-354/2009/A.
Further
applications for variation of environmental permit (VEP), EP-354/2009/B, EP-354/2009/C
and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The construction phase of the
Contract commenced on 31 October 2013 and will tentatively be completed by 2018. The impact monitoring of the EM&A programme, including air quality, noise, water quality and
marine ecological monitoring as well as environmental site inspections,
commenced on 31 October 2013.
This is the Twenty-second Monthly
EM&A report presenting the EM&A works carried out during the period
from 1 to 31 August 2015 for the Southern Connection Viaduct Section in accordance with the Updated EM&A Manual of the
TM-CLK
Link Project. As informed by the Contractor, major
activities in the reporting period included:
Marine Works
· Construction and installation of
pile caps;
· Uninstallation of marine piling
platform;
· Pile cap installation;
· Pier construction;
· Launching gantry assembly;
· Marine piling; and,
· Installation of pier head segment.
Land-based Works
· Predrilling at Viaduct F;
· Construction and installation of
pile caps;
· Pier construction;
· Pile cap installation;
· Re-alignment of Cheung Tung Road;
· Land piling;
· Installation of pier head segment;
· Additional land GI, trial pits
& lab testing;
· Relocation of MTRC fence; and,
· Slope work of Viaducts A & B.
A summary of monitoring and audit
activities conducted in the reporting period is listed below:
24-hour TSP monitoring 6 sessions
1-hour TSP monitoring 6 sessions
Noise monitoring 6
sessions
Impact Water Quality Monitoring 13 sessions
Impact Dolphin Monitoring 2 sessions
Joint Environmental site inspection 4 sessions
Breaches of
Action and Limit Levels for Air Quality
No exceedance of Action and Limit
Levels was recorded for construction air monitoring in the reporting month.
Breaches of
Action and Limit Levels for Noise
No exceedance of Action and Limit
Levels was recorded for construction noise monitoring in the reporting month.
Breaches of
Action and Limit Levels for Water Quality
No exceedance of Action and Limit
Levels was recorded for water quality impact monitoring in the reporting
period.
Impact
Dolphin Monitoring
Whilst one (1) Limit Level exceedance was observed for the
quarterly dolphin monitoring data between June and August 2015, no unacceptable
impact from the construction activities of the TM-CLKL Southern Connection
Viaduct Section on Chinese White Dolphins was noticeable from general
observations.
Daily marine mammal exclusion zone
monitoring was undertaken during the period of marine works under this
Contract. No Passive Acoustic Monitoring
(PAM) was implemented as the marine works were not carried out outside the
daylight hours in this reporting month. No sighting of
the Indo-Pacific humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) was recorded in
August 2015 during the exclusion zone monitoring.
Environmental
Complaints, Non-compliance & Summons
There was no environmental
complaint, notification of summons or successful prosecution recorded in the
reporting period.
Reporting
Change
There was
no reporting change in the reporting period.
Upcoming Works for the Next
Reporting Period
Works to be undertaken in the next
monitoring period of September 2015 include the following:
Marine Works
· Construction and installation of
pile caps;
· Uninstallation of marine piling
platform;
· Pile cap installation;
· Pier construction;
· Launching gantry assembly;
· Marine piling; and,
· Installation of pier head segment.
Land-based Works
· Predrilling at Viaduct F;
· Construction and installation of pile caps;
· Pier construction;
· Pile cap installation;
· Re-alignment of Cheung Tung Road;
· Land piling;
· Installation of pier head segment;
· Additional land GI, trial pits & lab
testing;
· Relocation of MTRC fence; and
·
Slope work
of Viaduct A.
Future Key Issues
Potential environmental impacts
arising from the above upcoming construction activities in the next reporting
month of September 2015 are mainly associated with dust, noise, marine water
quality, marine ecology and waste management issues.
According to the findings of the
Northwest New Territories (NWNT) Traffic and Infrastructure Review conducted by
the Transport Department, Tuen Mun
Road, Ting Kau Bridge, Lantau Link and North Lantau
Highway would be operating beyond capacity after 2016. This forecast has been based on the estimated
increase in cross boundary traffic, developments in the Northwest New Territories
(NWNT), and possible developments in North Lantau, including the Airport
developments, the Lantau Logistics Park (LLP) and the Hong Kong – Zhuhai –
Macao Bridge (HZMB). In order to cope
with the anticipated traffic demand, two new road sections between NWNT and
North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB)
are proposed.
An Environmental Impact Assessment
(EIA) of TM-CLKL (the Project) was prepared in accordance with the EIA Study
Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental Impact Assessment Process
(EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009) for TM-CLKL was granted by
the Director of Environmental Protection (DEP) on 4 November 2009, and EP
variation (EP-354/2009/A) was issued
on 8 December 2010.
Under
Contract No. HY/2012/07, Gammon Construction Limited (GCL) is commissioned by the
Highways Department (HyD) to undertake the design and
construction of the Southern Connection Viaduct Section of TM-CLKL (“the
Contract”) while AECOM Asia
Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). Ramboll Environ Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A.
Further applications for variation of environmental
permit (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
The organization structure of the
Contract is shown in Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD (Highways Department) |
Project Coordinator |
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior Engineer |
Steven Shum |
2762 4133 |
3188 6614 |
SOR (AECOM Asia Company Limited) |
Chief Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident Engineer |
Kingman Chan |
3691 3950 |
3691 2899 |
ENPO / IEC (Ramboll Environ Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3547 2133 |
3465 2899 |
IEC |
Dr. F.C. Tsang |
3547 2134 |
3465 2899 |
|
Contractor (Gammon Construction Limited) |
Environmental Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Marine Works
· Construction and installation of
pile caps;
· Uninstallation of marine piling
platform;
· Pile cap installation;
· Pier construction;
· Launching gantry assembly;
· Marine piling; and,
· Installation of pier head segment.
Land-based Works
· Predrilling at Viaduct F;
· Construction and installation of pile caps;
· Pier construction;
· Pile cap installation;
· Re-alignment of Cheung Tung Road;
· Land piling;
· Installation of pier head segment;
· Additional land GI, trial pits & lab
testing;
· Relocation of MTRC fence; and,
·
Slope work
of Viaducts A & B.
The locations of the construction activities are shown
in Figure 1.3. The Environmental Sensitive Receivers in the
vicinity of the Project are shown in Figure 1.4.

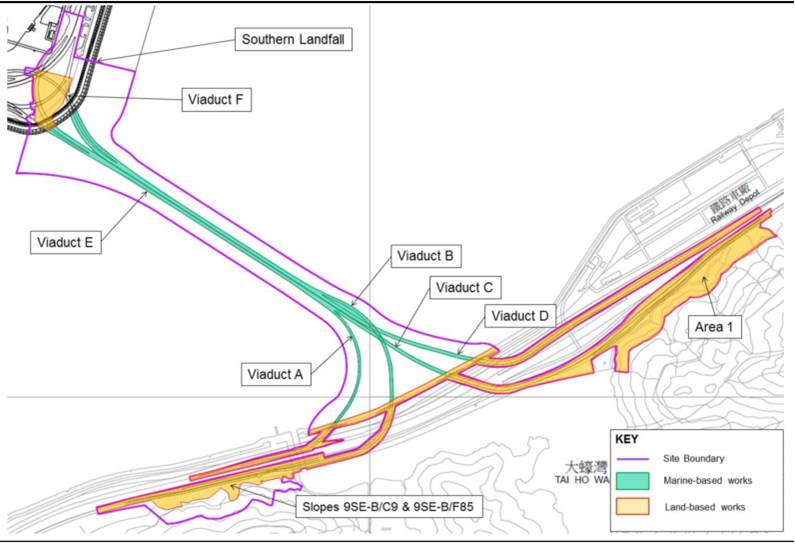

Figure 1.3 Locations of
Construction Activities in the Reporting Month
The
EM&A programme required environmental monitoring
for air quality, noise, water quality and marine ecology as well as
environmental site inspections for air quality, noise, water quality, waste
management, marine ecology and landscape and visual impacts. The EM&A requirements and related
findings for each component are summarized in the following sections.
Table 2.1 Locations of
Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
Description |
Monitoring Dates |
ASR 9 |
MTR Depot |
On the ground nearby MTR Depot Entrance |
3, 6, 12, 18, 24 and 27 August 2015 |
ASR 8A |
Area 4 |
On ground at the works area, Area 4 |
3, 6, 12, 18, 24 and 27 August 2015 |
High
Volume Samplers (HVSs) were used for carried out 1-hour and 24-hour TSP
monitoring on 3, 6, 12, 18,
24 and 27 August 2015 at ASR8A and ASR9 in accordance with the requirements of the Updated
EM&A Manual. The TSP monitoring
stations are illustrated in Figure 2.1 and detailed in Table 2.1. Wind anemometer was deployed at Area 4 for
logging wind speed and wind direction. Copies of the calibration
certificates for the equipment are presented in Appendix E. Details of the deployed equipment are given
in Table 2.2.
Table
2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch
Environmental Mass Flow Controlled Total Suspended Particulate
(TSP) High Volume Sampler (Model No. TE-5170) |
Wind Sensor |
Global Water (Wind Speed Sensor: WE550; Wind
Direction Sensor: WE570) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
Table 2.3 Summary of
1-hour TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR 8A |
88 |
58 - 148 |
394 |
500 |
ASR 9 |
104 |
60 - 165 |
393 |
500 |
Table 2.4 Summary of 24-hour
TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR 8A |
61 |
48 – 85 |
178 |
260 |
ASR 9 |
68 |
51 – 101 |
178 |
260 |
All 1-hour and 24-hour TSP results were below the Action and Limit
levels at all monitoring locations in the reporting period. No action is thus required to be undertaken
in accordance with the Event Action Plan presented in Appendix L.
Meteorological information
collected at ASR8A including
wind speed and wind direction is provided in Appendix H.
Noise
monitoring was performed on 3, 6, 12, 18, 24 and 27 August 2015 by using sound level meter at the
designated monitoring station NSR1A (Figure 2.2; Table 2.5) in accordance
with the requirements stipulated in the Updated EM&A Manual. Acoustic calibrator was deployed to check the
sound level meters at a known sound pressure level. Details of the deployed equipment are
provided in Table 2.6. Copies of the calibration certificates for
the equipment are presented in Appendix E.
Table 2.5 Location of Impact
Noise Monitoring Station
Monitoring Station |
Location |
Description |
Parameter |
Frequency and Duration |
Monitoring Dates |
NSR 1A |
Pak Mong Village Pavilion |
On the ground at the village entrance |
30-minute measurement at each monitoring station
between 0700 and 1900 on normal weekdays (Monday to Saturday). Leq, L10 and L90 would
be recorded. |
At least once per week |
3, 6, 12, 18, 24 and 27 August 2015 |
Table 2.6 Noise
Monitoring Equipment
Equipment |
Brand and Model |
Integrated Sound Level Meter |
Rion NL-31 |
Acoustic Calibrator |
Rion NC-73 |
Table 2.7 Summary of
Construction Noise Monitoring Results in the Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
|
NSR 1A |
58 |
57 - 60 |
75 |
|
Table 2.8 Locations of
Impact Water Quality Monitoring Stations and its Corresponding Monitoring
Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Frequency |
Depth |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact Station (Close to HKBCF
construction site) |
813273 |
818850 |
Temperature(°C)
pH (pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of
saturation) · SS (mg/L) |
Impact
monitoring: 3 days per week, at mid-flood and mid-ebb tides during the
construction period of the Contract |
3 water depths: 1m below sea surface, mid-depth and 1m above sea
bed. If the water depth is less than
3m, mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted |
IS(Mf)16 |
Impact Station (Close to HKBCF
construction site) |
814328 |
819497 |
|||
IS8 |
Impact Station (Close to HKBCF construction
site) |
814251 |
818412 |
|||
SR4 |
Sensitive receiver (Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control Station |
817990 |
821129 |
|||
*Notes: |
Table 2.9 Water
Quality Monitoring Equipment
Equipment |
Brand
and Model |
DO and Salinity |
YSI Pro2030 |
Turbidity meter |
HACH Model 2100Q |
pH meter
|
Thermo Scientific Orion 2 Star |
Positioning
Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech
Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
The SS level at IS(Mf)16
during mid-ebb tide on 1 August 2015 was higher than the corresponding Action
Level but below 120% of the upstream control station at the same tide on the
same day. Thus the result was not
regarded as an exceedance.
No Action and Limit levels
exceedances was recorded at all monitoring stations for impact water quality
monitoring in the reporting month. No
action is thus required to be undertaken in accordance with the Event Action
Plan presented in Appendix L.
Table 2.10 Dolphin
Monitoring Equipment
Equipment |
Model |
|
Global
Positioning System (GPS) Camera Laser
Binoculars Marine
Binocular Vessel
for Monitoring |
Garmin
18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90
20-300m zoom lens Infinitor
LRF 1000 Bushell 7 x
50 marine binocular with compass and reticules 65 foot single engine motor vessel with viewing platform
4.5m above water level |
|
Table 2.11 Impact Dolphin
Monitoring Line Transect Co-ordinates
Line
No. |
Easting |
Northing |
Line
No. |
Easting |
Northing |
||
1 |
Start Point |
804671 |
815456 |
13 |
Start Point |
816506 |
819480 |
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
2 |
Start Point |
805475 |
815913 |
14 |
Start Point |
817537 |
820220 |
2 |
End Point |
805477 |
826654 |
14 |
End Point |
817537 |
824613 |
3 |
Start Point |
806464 |
819435 |
15 |
Start Point |
818568 |
820735 |
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
4 |
Start Point |
807518 |
819771 |
16 |
Start Point |
819532 |
821420 |
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
5 |
Start Point |
808504 |
820220 |
17 |
Start Point |
820451 |
822125 |
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
6 |
Start Point |
809490 |
820466 |
18 |
Start Point |
821504 |
822371 |
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
7 |
Start Point |
810499 |
820880 |
19 |
Start Point |
822513 |
823268 |
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
8 |
Start Point |
811508 |
821123 |
20 |
Start Point |
823477 |
823402 |
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
9 |
Start Point |
812516 |
821303 |
21 |
Start Point |
805476 |
827081 |
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
10 |
Start Point |
813525 |
820872 |
22 |
Start Point |
806464 |
824033 |
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
11 |
Start Point |
814556 |
818853 |
23 |
Start Point |
814559 |
821739 |
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
12 |
Start Point |
815542 |
818807 |
|
|
|
|
12 |
End Point |
815542 |
824882 |
|
|
|
|
The Action and Limit levels of
dolphin impact monitoring are shown in Appendix D. The Event and Action plan is presented in Appendix
L
.
A total of
297.72 km of survey effort was collected, with 99.6% of the
total survey effort being conducted under favourable weather conditions (i.e.
Beaufort Sea State 3 or below with good visibility) during the surveys of
August 2015. Among the two areas, 113.58
km and 184.14 km of survey effort were collected from NEL and NWL survey areas
respectively. The total survey effort
conducted on primary and secondary lines were 215.91 km and 81.81 km
respectively. The survey efforts are
summarized in Appendix K.
Six (6)
groups of twenty-one (21) Chinese White Dolphins were sighted during the two
sets of monitoring surveys in August 2015.
During surveys of August 2015, all six (6) sightings were made in NWL,
while no dolphin was sighted in NEL.
During the surveys, all six (6) dolphin sightings were made on primary
lines during on-effort search, while none of the dolphin groups was associated
with operating fishing vessel. No
sighting was made in the proximity of the Project’s alignment. The distribution of dolphin sighting during
the reporting month is shown in Figure 2.5.
Encounter rates of Chinese White
Dolphins are deduced from the survey effort and on-effort sighting data made
under favourable conditions (Beaufort 3 or below) in
August 2015 are shown in Tables 2.12
& 2.13.
Table 2.12 Individual
Survey Event Encounter Rates
|
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km
of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set
1: Aug 10th / 14th |
0.0 |
0.0 |
Set
2: Aug 19th / 28th |
0.0 |
0.0 |
|
NWL |
Set
1: Aug 10th / 14th |
0.0 |
0.0 |
Set
2: Aug 19th / 28th |
8.5 |
29.8 |
|
Note: Dolphin
Encounter Rates are deduced from the two sets of surveys ( two surveys in
each set) in August 2015 in Northeast (NEL) and Northwest Lantau (NWL) |
Table 2.13 Monthly Average
Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin
sightings per 100 km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
||
Primary Lines Only |
Both Primary and Secondary
Lines |
Primary Lines Only |
Both Primary and Secondary
Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
4.2 |
3.3 |
14.7 |
11.5 |
Note: Overall
dolphin encounter rates (sightings per 100 km of survey effort) from all four
surveys are conducted in August 2015 on primary lines only as well as both
primary lines and secondary lines in Northeast and Northwest Lantau
Whilst one (1) Limit Level exceedance
was observed for the quarterly dolphin monitoring data between June and August
2015. No unacceptable impact from the
construction activities of the TM-CLKL Southern Connection Viaduct Section on
Chinese White Dolphins was noticeable from general observations during the
dolphin monitoring in this reporting month.
Due to monthly variation in dolphin
occurrence within the study area, it would be more appropriate to draw
conclusion on whether any impacts on dolphins have been detected related to the
construction activities of the TM-CLKL Southern Connection Viaduct Section in
the quarterly EM&A reports, where comparison on distribution, group size
and encounter rates of dolphins between the quarterly impact monitoring period
and baseline monitoring period will be made.
Daily 250 m marine mammal exclusion
zone monitoring was undertaken during the period of marine works activities
being undertaken. Passive Acoustic
Monitoring (PAM) was not implemented as the marine piling works were not
carried out outside the daylight hours in this reporting month. No sighting of Indo-Pacific humpback dolphin Sousa chinensis
(i.e. Chinese White Dolphin) were recorded in August 2015 during the exclusion
zone monitoring.
Table 2.14 Specific
Observations Identified during the Weekly Site Inspections in this Reporting
Month
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
7 August 2015 |
Pier C3 Stagnant water was accumulated in
drip tray Pier E12 Gutter was not properly
installed. |
Pier C3 Stagnant water in drip tray should
be cleaned up to avoid runoff. Pier E12
Gutter should be properly installed to avoid
runoff. |
12 August 2015 |
Area 1 Chemical containers were placed
too close to the natural habitat. Chemical containers were placed
without drip tray. Soil stockpile next to drainage
was not well covered. Pier B14 Chemical containers were placed
without drip tray. |
Area 1 Chemical containers should be
placed in drip tray and away from natural habitat. Tarpaulin sheet or hydroseeding should be provided to the soil stockpile
next to drainage. Pier B14 Chemical containers should be
placed in drip tray. |
19 August 2015 |
Pier E6 Some chemical containers were not
placed in drip tray. An expired dumping permit was
displayed. Pier E12 A drip tray was not plugged. Pier B13 Refuse was found accumulated
onsite. |
Pier E6 Chemical containers should be
placed in drip tray. Expired dumping permit should not
be displayed. Pier E12 Drip tray should be plugged. Pier B13 Refuse should be regularly
cleaned up |
27 August 2015 |
Abutment D A label of chemical container was
damaged. Checklist of wetsep
was not displayed. Stagnant water was found in a
drip tray for air compressor. Pier E1 Excessive soil was found in
gutter Pier C4 A generator was not well placed
on decoupling pad. |
Abutment D Chemical container should be
properly labeled. Checklist of wetsep
should be displayed. Stagnant water in drip tray
should be removed to avoid runoff. Pier E1 Excessive soil should be cleaned up
regularly. Pier C4 Stationary PME should be well
placed on decoupling pad. |
The Contractor has rectified all of
the observations identified during environmental site inspections in the
reporting month.
The Contractor has submitted
application form for registration as chemical waste producer under the
Contract. Sufficient numbers of
receptacles were available for general refuse collection and sorting.
Wastes generated during this
reporting period include mainly construction wastes (inert and non-inert),
recyclable materials and chemical wastes.
Reference has been made to the waste flow table prepared by the
Contractor (Appendix M). The quantities of different types of wastes
are summarized in Table 2.15.

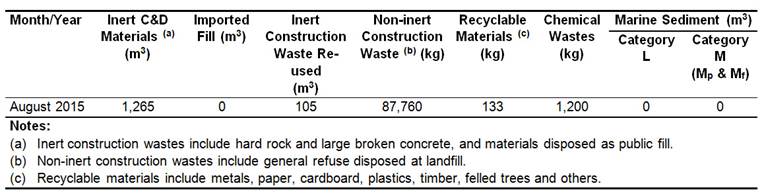

Table 2.15 Quantities of
Different Waste Generated in the Reporting Period
The Contractor was advised to
properly maintain on site C&D materials and waste collection, sorting and
recording system, dispose of C&D materials and wastes at designated ground
and maximize reuse/ recycle of C&D materials and wastes. The Contractor was also reminded to properly
maintain the site tidiness and dispose of the wastes accumulated on site
regularly and properly.
For chemical waste containers, the
Contractor was reminded to treat properly and store temporarily in designated
chemical waste storage area on site in accordance with the Code of Practice on
the Packaging, Labelling and Storage of Chemical Wastes.
The status of environmental licensing
and permit is summarized in Table 2.16 below.
Table 2.16 Summary of
Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date
of Issue |
Date
of Expiry |
License/ Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/D |
13 March
2015 |
N/A |
HyD |
Tuen Mun- Chek Lap Kok Link |
Construction Dust Notification |
361571 |
5 Jul
2013 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17 Jul
2013 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct
2013 |
N/A |
GCL |
Chemical waste produced in
Contract HY/2012/07 (Area 1 adjacent to Cheng Tung
Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct
2013 |
N/A |
GCL |
Chemical waste produced in
Contract HY/2012/07 (Area 2 adjacent to Cheung Tung
Road, Pak Mong Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov
2013 |
N/A |
GCL |
Chemical waste produced in Contract
HY/2012/07 (WA5 adjacent to Cheung Tung
Road, Yam O) |
Chemical Waste Registration |
5213-951-G2380-17 |
12 Jun
2014 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Construction Waste Disposal
Account |
7017735 |
10 Jul
2013 |
N/A |
GCL |
- |
Construction Waste Disposal Account |
7019470 |
3 Mar
2014 |
N/A |
GCL |
Vessel CHIT Account |
Waste Water Discharge License |
WT00019017-2014 |
13 May
2014 |
31 May
2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May
2014 |
31 May
2019 |
GCL |
Discharge for land portion |
Construction
Noise Permit |
Nil |
N/A |
N/A |
GCL |
For Piling Works |
Construction
Noise Permit for night works and works in general holidays |
GW-RW0422-15 |
21 Aug 2015 |
25 Jan 2016 |
GCL |
General
works at WA5 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0307-15 |
27 Mar 2015 |
27 Sep 2015 |
GCL |
For
Load unload at NLH near Viaduct D |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0691-15 |
23 Jun 2015 |
22 Dec 2015 |
GCL |
For
Broad Permit |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0809-15 |
29 Jul 2015 |
29 Jan 2016 |
GCL |
For
Plant mobilization using tractor with trailer |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0911-15 |
27 Aug 2015 |
26 Feb 2016 |
GCL |
Broad
Permit for Seg. Launching at Land Portion |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0854-15 |
12 Aug 2014 |
15 Feb 2016 |
GCL |
Pre-casted
pile cap shell installation at E10-E13 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0769-15 |
15 Jul 2015 |
30 Sep 2015 |
GCL |
TTA
Case 009 Ch.2.1E-4.2E |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0855-15 |
12 Aug 2015 |
11 Feb 2016 |
GCL |
Pier
construction at C7, D8, D9 |
Construction
Noise Permit for night works and works in general holidays |
GW-RW0861-15 |
13 Aug 2015 |
30 Sep 2015 |
GCL |
Portal
beam installation at Pier D14 |
Marine
Dumping Permit |
EP/MD/16-071 |
19 Aug 2015 |
26 Sep 2015 |
GCL |
For dumping Type I (Dedicated Site)
and Type II sediment |
Marine
Dumping Permit |
EP/MD/15-257 |
2 Apr 2015 |
7 Oct 2015 |
GCL |
For dumping Type I sediment |
The
landscape and visual (L&V) mitigation measures were also monitored on
weekly basis in the reporting period.
The monitoring status is summarized in Appendix C
.
There was no environmental
complaint, notification of summons or successful prosecution recorded in the
reporting period.
Statistics on complaints,
notifications of summons, successful prosecutions are summarized in Appendix
N.
Marine Works
· Construction and installation of pile
caps;
· Uninstallation of marine piling
platform;
· Pile cap installation;
· Pier construction;
· Launching gantry assembly;
· Marine piling and
· Installation of pier head segment
Land-based Works
· Predrilling at Viaduct F;
· Construction and installation of pile caps;
· Pier construction;
· Pile cap installation;
· Re-alignment of Cheung Tung Road;
· Land piling;
· Installation of pier head segment;
· Additional land GI, trial pits & lab
testing;
· Relocation of MTRC fence; and
·
Slope work of Viaduct
A.
Potential environmental impacts
arising from the above upcoming construction activities in the next reporting
month of September 2015 are mainly associated with dust, noise, marine water
quality, marine ecology and waste management issues.
This Twenty-second Monthly EM&A
Report presents the findings of the EM&A activities undertaken during the
period from 1 to 31 August 2015, in accordance with the Updated EM&A Manual
and the requirements of the
Environmental Permit (EP-354/2009/D).
There was no environmental
complaint, notification of summons or successful prosecution recorded in the
reporting period.
The ET will keep track on the
construction works to confirm compliance of environmental requirements and the
proper implementation of all necessary mitigation measures.
