table of Contents
Executive
Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Water Quality Monitoring
2.3 Dolphin Monitoring
2.4 EM&A Site Inspection
2.5 Waste Management Status
2.6 Environmental Licenses and
Permits
2.7 Implementation Status of
Environmental Mitigation Measures
2.8 Summary of Exceedances of the
Environmental Quality Performance Limit
2.9 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Activities for
the Coming Month
3.2 Key Issues for the Coming
Month
3.3 Monitoring Schedule for the
Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
Under
Contract No. HY/2012/08, Dragages –
Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to
undertake the design and construction of the Northern Connection Sub-sea Tunnel
Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while
AECOM Asia Company Limited was appointed by HyD as the Supervising
Officer. For implementation of the
environmental monitoring and audit (EM&A) programme under the Contract,
ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET)
in accordance with Environmental Permit
No. EP-354/2009/A. Ramboll Hong Kong Ltd. was employed by HyD as
the Independent Environmental Checker (IEC) and Environmental Project Office
(ENPO). Subsequent
applications for variation of environmental permits (VEP), EP-354/2009/B, EP-354/2009/C and
EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The
construction phase of the Contract commenced on 1 November 2013 and will
tentatively be completed by the end of 2019.
The impact monitoring of the EM&A programme, including air quality,
water quality, marine ecological monitoring and environmental site inspections,
were commenced on 1 November 2013.
This
is the Sixty-sixth Monthly EM&A report presenting the EM&A works
carried out during the period from 1 to 30 April 2019 for the Contract No. HY/2012/08 Northern Connection
Sub-sea Tunnel Section (the “Contract”) in
accordance with the Updated EM&A Manual of the TM-CLK
Link Contract. As informed by the
Contractor, major activities in the reporting period included:
Land-based
Works
·
Construction of Thermal barrier – TBM tunnel;
·
Construction of Walkway Corbel & Cover – TBM
Tunnel;
·
RC structure – Portion N-A & S-A;
·
ELS Removal – Portion S-A;
·
D-wall Construction – Portion S-C
·
Seawall Inspection and Remedial Works – Portion N-B
·
Marine-based
Works
·
Seawall Modification Works – Portion S-B
A
summary of monitoring and audit activities conducted in the reporting period is
listed below:
24-hour
TSP Monitoring 10
sessions
1-hour
TSP Monitoring 10
sessions
Water
Quality Monitoring 7
sessions
Impact
Dolphin Monitoring 2
sessions
Joint
Environmental Site Inspection 4
sessions
Implementation of Marine Mammal Exclusion Zone
Daily marine mammal exclusion zone was in effect
during the period of silt curtain installation in open waters under this
Contract. No sighting of the
Indo-Pacific humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) was
recorded in April 2019 during the exclusion zone monitoring.
Summary
of Breaches of Action/Limit Levels
Breaches of Action and Limit Levels for Air Quality
No
exceedances were recorded in the air quality monitoring of this reporting
month.
Breaches of Action and Limit Levels for Water Quality
No
exceedances were recorded in the water quality monitoring of this reporting
month.
Breaches of Action and Limit Levels for Dolphin
Monitoring
Due to monthly variation in
dolphin occurrence within the survey area, it would be more appropriate to draw
conclusion on whether any unacceptable impacts on dolphins have been detected
in relation to the construction activities of this Project in the quarterly
EM&A reports, where comparison on distribution, group size and encounter
rates of dolphins between the quarterly impact monitoring period and baseline
monitoring period will be made.
Environmental
Complaints, Non-compliance & Summons
No non-compliance with
EIA recommendations,
EP conditions and other requirements associated with the construction of this
Contract was recorded in this reporting period.
No environmental complaint
was received in this reporting period.
No
environmental summons was received in this reporting period.
Reporting
Change
As
stage 2 of sloping seawall construction has commenced on 15 April 2019, water
quality monitoring was resumed in this reporting month.
Upcoming
Works for the Next Reporting Month
Works
to be undertaken in the next monitoring period of May 2019 include the
following:
Land-based
Works
·
Construction of Thermal barrier – TBM tunnel;
·
Bitumen Laying – TBM tunnel
·
Construction of Walkway Corbel & Cover – TBM Tunnel;
·
RC structure – Portion N-A & S-A;
·
E&M Platform Installation – Portion S-A
·
ELS Removal – Portion S-A;
·
D-wall Construction – Portion S-C
·
Seawall Inspection and Remedial Works – Portion N-B
·
Marine-based
Works
·
Seawall Modification Works – Portion S-B
Future
Key Issue
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of May 2019 are mainly associated with dust, marine
water quality, marine ecology and waste management issues.
According
to the findings of the Northwest New Territories (NWNT) Traffic and
Infrastructure Review conducted by the Transport Department, Tuen Mun Road,
Ting Kau Bridge, Lantau Link and North Lantau Highway would be operating beyond
capacity after 2016. This forecast has
been based on the estimated increase in cross boundary traffic, developments in
the Northwest New Territories (NWNT), and possible developments in North
Lantau, including the Airport developments, the Lantau Logistics Park (LLP) and
the Hong Kong – Zhuhai – Macao Bridge (HZMB).
In order to cope with the anticipated traffic demand, two new road
sections between NWNT and North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL)
and Tuen Mun Western Bypass (TMWB) are proposed.
An Environmental
Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in accordance
with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental Impact Assessment Process
(EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (VEP) (EP-354/2009/A) was issued on 8 December
2010. Subsequent applications for
variation of environmental permits (VEPs), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D,
were granted on 28 January 2014, 10 December 2014 and 13 March 2015,
respectively.
Under
Contract No. HY/2012/08, Dragages –
Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD)
to undertake the design and construction of the Northern Connection Sub-sea
Tunnel Section of TM-CLKL while AECOM Asia Company Limited was
appointed by HyD as the Supervising Officer.
For implementation of the environmental monitoring and audit (EM&A)
programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed
as the Environmental Team (ET). Ramboll Hong
Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC)
and Environmental Project Office (ENPO).
Layout
of the Contract components is presented in Figure 1.1.
The
organization structure of the Contract is shown in Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways
Department |
Engr 22/HZMB |
Chow Man Lung,
Andrew |
2762 4110 |
2762 4110 |
SOR (AECOM Asia
Company Limited) |
Chief Resident
Engineer |
Roger Man Andrew
Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
ENPO / IEC (Ramboll Hong
Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465
2850 |
3465 2899 |
IEC |
Dr. F.C. Tsang |
3465
2851 |
3465 2899 |
|
Contractor (Dragages – Bouygues Joint Venture) |
Deputy
Environmental Manager |
Bryan Lee |
2293 7323 |
2293 7499 |
|
Senior
Environmental Officer |
Ashley Au |
52950766 |
|
|
24-hour
hotline |
|
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jasmine Ng |
2271 3311 |
2723 5660 |
Table 1.2 Summary of Construction Activities Undertaken during the
Reporting Period
Construction Activities Undertaken |
Land-based Works |
·
Construction of Thermal barrier – TBM tunnel; ·
Construction of Walkway Corbel & Cover – TBM
Tunnel; ·
RC structure – Portion N-A & S-A; ·
ELS Removal – Portion S-A; ·
D-wall Construction – Portion S-C ·
Seawall Inspection and Remedial Works – Portion N-B ·
Marine-based
Works ·
Seawall Modification Works – Portion S-B |

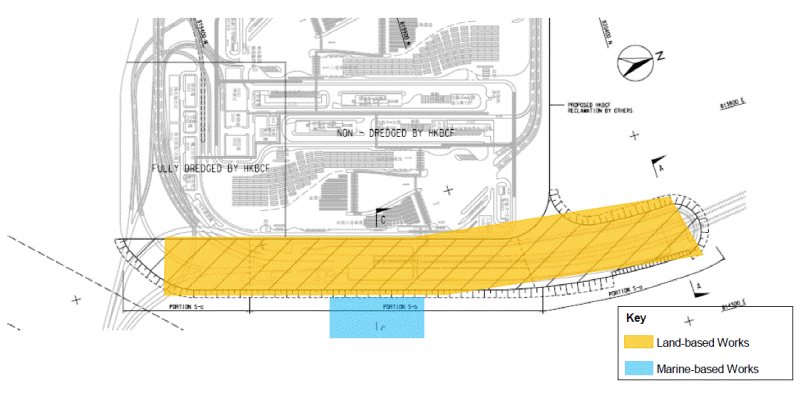

Figure 1.2 Locations of Construction Activities – April 2019
|
The
EM&A programme required environmental monitoring for air quality, water
quality and marine ecology as well as environmental site inspections for air
quality, noise, water quality, waste management, marine ecology and landscape
and visual impacts. The EM&A
requirements and related findings for each component are summarized in the
following sections
In
accordance with the Updated EM&A Manual and the Enhanced TSP Monitoring
Plan, impact 1-hour TSP monitoring was conducted three (3) times every six (6)
days and impact 24-hour TSP monitoring was carried out once every six (6) days
when the highest dust impact was expected.
1-hr and 24-hr TSP monitoring frequency was increased to three times per
day every three days and daily every three days, respectively, as excavation
works for launching shaft commenced on 24 October 2014.
High
volume samplers (HVSs) were used to carry out the 1-hour and 24-hour TSP
monitoring on 2, 5, 8, 11, 14, 17, 20, 23, 26 and 29 April 2019 at the five (5)
air quality monitoring stations in accordance with the requirements stipulated
in the Updated EM&A Manual (Figure 2.1; Table 2.1). Wind meter was installed at the rooftop of
ASR5 for logging wind speed and wind direction.
Details of the equipment deployed are provided in Table 2.2. Copies of the
calibration certificates for the equipment are presented in Appendix E.
Table
2.1 Locations of Impact Air Quality
Monitoring Stations and Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Dates |
Location |
Description |
Parameters
& Frequency |
ASR1 |
2,
5, 8, 11, 14, 17, 20, 23, 26 and 29 April 2019 |
Tuen
Mun Fireboat Station |
Office |
TSP monitoring
1-hour Total Suspended
Particulates (1-hour TSP, µg/m3), 3 times in every 6 days
24-hour Total Suspended
Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 6
days Enhanced TSP monitoring (commenced on 24 October 2014)
1-hour Total Suspended
Particulates (1-hour TSP, µg/m3), 3 times in every 3 days
24-hour Total Suspended
Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 3
days |
ASR5 |
|
Pillar
Point Fire Station |
Office |
|
AQMS1 |
|
Previous
River Trade Golf |
Bare
ground |
|
ASR6 |
|
Butterfly
Beach Laundry |
Office |
|
ASR10 |
|
Butterfly
Beach Park |
Recreational
uses |
Table 2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total
Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model: Vantage Pro 2 (S/N: AS160104014) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The
Action and Limit Levels of the air quality monitoring is provided in Appendix D. The
Event and Action plan is presented in Appendix K.
The
schedule for air quality monitoring in April 2019 is provided in Appendix F.
The
monitoring results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4, respectively. Detailed
impact air quality monitoring results and graphical presentations are presented
in Appendix G.
Table 2.3 Summary of 1-hour TSP Monitoring Results in this Reporting
Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
107 |
19
- 296 |
331 |
500 |
ASR5 |
109 |
28
- 281 |
340 |
500 |
AQMS1 |
77 |
32
- 211 |
335 |
500 |
ASR6 |
91 |
19
- 256 |
338 |
500 |
ASR10 |
56 |
24
- 157 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in this Reporting
Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
99 |
44
- 183 |
213 |
260 |
ASR5 |
78 |
45
- 119 |
238 |
260 |
AQMS1 |
52 |
28
- 96 |
213 |
260 |
ASR6 |
62 |
33
- 115 |
238 |
260 |
ASR10 |
38 |
24
- 89 |
214 |
260 |
The
weather condition during the monitoring period varied from sunny to
cloudy. The major dust sources in the
reporting period included construction activities under the Contract as well as
nearby traffic emissions.
A
total of 10 1-hour TSP and 24-hour TSP monitoring were undertaken in this
reporting month. No exceedances were
recorded in the air quality monitoring of this reporting month.
Meteorological
information collected at the ASR5, including wind speed and wind direction, is
provided in Appendix H.
Seawall
Modification Works at Portion S-B has commenced on 15 April 2019.
Impact
marine water quality monitoring has resumed on 15 April 2019
In
accordance with the approved Environmental Review Report dated 21 March 2018
for the Change in Design of Vertical Seawall to Sloping Seawall on Southern
Landfall, Updated Impact water quality monitoring programme and water quality
monitoring stations IS17, SR7 and IS(Mf)11 specified under the EM&A Manual
for HZMB HKBCF project will be adopted.
(Figure 2.2; Table
2.5).
Results
of water quality monitoring were adopted from the published EM&A data of
Contract No. HY/2012/07 Tuen Mun-Chek Lap Kok Link – Southern Connection Viaduct
Section .
The
Action and Limit Levels of the water quality monitoring were adopted from the
EM&A Manual for HZMB HKBCF project.
The Action and Limit Levels are provided in Appendix D.
Table 2.5 Locations of Water Quality Monitoring Stations and the
Corresponding Monitoring Requirements
Station ID |
Type |
Coordinates |
*Parameters,
unit |
Depth |
Frequency |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)11 |
Impact Station (Close to HKBCF construction site) 8 |
813562 |
820716 |
Temperature(°C)
pH(pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) ·
SS (mg/L) |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed. If the water depth is less than 3m,
mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted. |
Impact monitoring: 3 days per week, at mid-flood and
mid-ebb tides during the construction period of the Contract. |
IS17 |
Impact
Station (Close to HKBCF construction site) |
814539 |
820391 |
|||
SR7 |
Sensitive
receivers (Tai Mo Do) |
814293 |
821431 |
|||
*Notes: In addition to the parameters presented
monitoring location/position, time, water depth, sampling depth, tidal
stages, weather conditions and any special phenomena or works underway nearby
were also recorded. |
Table 2.6 summarizes the equipment used in
the impact water quality monitoring programme.
Copies of the calibration
certificates are attached in Appendix E.
Table
2.6 Water Quality Monitoring Equipment
Equipment |
Model |
Multi-Parameters |
YSI ProDss 17E100747 |
Multi-Parameters |
YSI ProDss 16H104234 |
Multi-Parameters |
YSI ProDss 17H105557 |
Positioning Equipment |
Furuno GP-170 |
Water Depth Detector |
Lowrance Mark 5x / Garmin Striker 4 |
The
Action and Limit levels of water quality impact monitoring are shown in Appendix
D. The Event and Action plan is presented in Appendix
K.
The
schedule for water quality monitoring in April 2019 is provided in Appendix F.
Impact
water quality monitoring was conducted at all designated monitoring stations in
the reporting month. Results and
graphical presentations of impact water quality monitoring are presented in Appendix J.
In
this reporting period, a total of seven (7) monitoring events were undertaken
in which no exceedances were recorded.
Impact
dolphin monitoring is required to be conducted by a qualified dolphin
specialist team to evaluate whether there have been any effects on the
dolphins. In order to fulfil the
EM&A requirements and make good use of available resources, the on-going
impact line transect dolphin monitoring data collected by HyD’s Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong Kong
Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing Facilities
on the monthly basis is adopted to avoid duplicates of survey effort.
Table 2.7 summarises the
equipment used for the impact dolphin monitoring.
Table 2.7 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) |
Garmin
18X-PC Geo One Phottix |
Camera |
Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens |
Laser Binocular |
Infinitor LRF 1000 |
Marine Binocular |
Bushell 7 x 50 marine binocular with compass and reticules |
Vessel for Monitoring |
65 foot single engine motor vessel with viewing platform 4.5m above
water level |
Dolphin
monitoring should cover all transect lines in Northeast Lantau (NEL) and the
Northwest Lantau (NWL) survey areas twice per month throughout the entire
construction period. The monitoring data
should be compatible with, and should be made available for, long-term studies
of small cetacean ecology in Hong Kong.
In order to provide a suitable long-term dataset for comparison,
identical methodology and line transects employed in baseline dolphin
monitoring was followed in the impact dolphin monitoring.
The
impact dolphin monitoring was carried out in the NEL and NWL along the line
transect as depicted in Figure 2.3. The co-ordinates of all transect lines are
shown in Table 2.8 below.
Table 2.8 Impact Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
815456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805476 |
820800* |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805476 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
821150* |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
821500* |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
821850* |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
822150* |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
822000* |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
821176 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
12 |
End
Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
The
Action and Limit levels of impact dolphin monitoring are shown in Appendix D. The
Event and Action plan is presented in Appendix K.
Dolphin
monitoring was carried out on 10, 15, 23 and 25 of April 2019. The dolphin monitoring schedule for the
reporting month is shown in Appendix F.
One
group of 2 Chinese White Dolphins sighting was recorded during the two sets of
surveys in April 2019. The dolphin
sighting was made in NWL, while none was sighted in NEL. The dolphin sighting was made during
on-effort search and was made on primary lines.
The dolphin groups were not associated with any operating fishing
vessel.
No
dolphin sighting was made in the proximity of the TM-CLKL alignment. The
distribution of dolphin sightings during the reporting month is shown in Figure 2.4.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable conditions (Beaufort 3 or below)
in April 2019 with the results present in Tables
2.9 and 2.10.
Table 2.9 Individual Survey Event Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: April 10th
/ 15th |
0.0 |
0.0 |
Set 2: April 23rd
/ 25th |
0.0 |
0.0 |
|
NWL |
Set 1: April 10th
/ 15th |
0.0 |
0.0 |
Set 2: April 23rd
/ 25th |
1.6 |
3.3 |
Note: Dolphin Encounter Rates are deduced from the Two Sets of Surveys
(Two Surveys in Each Set) in April 2019 in Northeast (NEL) and
Northwest Lantau (NWL)
Table 2.10 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100
km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
||
Primary
Lines Only |
Both Primary and Secondary Lines |
Primary Lines
Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
0.9 |
0.7 |
1.9 |
1.3 |
Note: Overall dolphin encounter
rates (sightings per 100 km of survey effort) from all four surveys are
conducted in April 2019
on primary lines only as well as both primary lines and secondary lines in
Northeast and Northwest Lantau.
Due to monthly variation in
dolphin occurrence within the survey area, it would be more appropriate to draw
conclusion on whether any unacceptable impacts on dolphins have been detected
in relation to the construction activities of this Contract in the quarterly
EM&A reports, where comparison on distribution, group size and encounter
rates of dolphins between the quarterly impact monitoring period and baseline
monitoring period will be made.
Daily marine mammal exclusion zone was in effect
during the period of silt curtain installation in open waters under this
Contract. No sighting of the Indo-Pacific
humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) was recorded in
April 2019 during the exclusion zone monitoring.
Site
inspections were carried out on a weekly basis to monitor the implementation of
proper environmental pollution control and mitigation measures under the
Contract. In the reporting month, four
(4) site inspections were carried out on 3, 10, 17 and 24 April 2019.
Key
observations and recommendations during the site inspections in this reporting
period are summarized in Table 2.11.
Table 2.11 Specific Observations and Recommendations during the Weekly
Site Inspection in this Reporting Month
Inspection Date |
Observations |
Recommendations/ Remarks |
3 April 2019 |
Works
Area – Portion S-A Stagnant
water and food waste should be cleaned up and better housekeeping should be
maintained. Reminder from the SOR Works
Area – Portion N-A The
breaker tip should be wrapped with soundproof mat. Recycle
bin should be replaced with green rubbish bin and broken water barriers
should be replaced. Works
Area – Portion S-B The
breaker tip should be wrapped with soundproof mat. |
Works
Area – Portion S-A The
Contractor was reminded to clean up the stagnant water and food waste and
maintain better housekeeping. Reminder from the SOR Works
Area – Portion N-A The
Contractor was reminded to wrap the breaker tip with soundproof mat. The
Contractor was reminded to replace the recycle bin with green rubbish bin and
replace the broken water barriers. Works
Area – Portion S-B The
Contractor was reminded to wrap the breaker tip with soundproof mat. |
10
April 2019 |
Works
Area – Portion S-B The
faded NRMM label should be replaced. Food
waste should be disposed of and the lifting eyes should be filled with sand. Works
Area – Portion S-A Drip
tray should be provided for the chemicals. Works
Area – TBM tunnel Drip
tray should be provided for the chemicals. |
Works
Area – Portion S-B The
Contractor was reminded to replace the faded NRMM label. The
Contractor was reminded to dispose of the food waste and fill the lifting
eyes with sand. Works
Area – Portion S-A The
Contractor was reminded to provide drip tray for the chemicals. Works
Area – TBM tunnel The
Contractor was reminded to provide drip tray for the chemicals. |
17 April 2019 |
Works
Area – Portion N-A The
surface channel should remain unobstructed. Drip
tray and chemical labels should be provided for the chemicals. Reminder from the SOR Works
Area – Portion S-B The
opening of the water barriers should be capped. |
Works
Area – Portion N-A The
Contractor was reminded to keep the surface channel unobstructed. The
Contractor was reminded to provide drip tray and chemical labels for the
chemicals. Reminder from the SOR Works
Area – Portion S-B The
Contractor was reminded to cap the opening of the water barriers. |
24
April 2019 |
Works
Area – TBM tunnel Drip
tray should be provided for the chemicals. |
Works
Area – TBM tunnel The
Contractor was reminded to provide drip tray for the chemicals. |
The
Contractor has rectified all of the observations as identified during
environmental site inspections in the reporting month.
The
Contractor had submitted application form for registration as chemical waste
producer under the Contract. Sufficient
numbers of receptacles were available for general refuse collection and
sorting.
Wastes
generated during this reporting period included mainly construction wastes
(inert and non-inert). Reference has
been made to the waste flow table prepared by the Contractor (Appendix M). The
quantities of different types of wastes are summarized in Table 2.12.
Table 2.12 Quantities of Different Waste Generated in the Reporting Month
Month/Year |
Inert Construction Waste (a)
(tonnes) |
Inert Construction Waste Re-used (tonnes) |
Non-inert Construction Waste (b)
(tonnes) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|||
Category L |
Category M (Mp & Mf) |
Mixed (L+M) |
|||||||
April 2019 |
130,329 |
58,956 |
707 |
264,790 |
1,045 |
12,561 |
19,851 |
0 |
|
Notes: |
|
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and materials
disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
|
||||||||
The
Contractor was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials
and wastes. The Contractor was also
reminded to properly maintain the site tidiness and dispose of the wastes
accumulated on site regularly and properly.
For
chemical waste containers, the Contractor was reminded to treat properly and
store temporarily in designated chemical waste storage area on site in
accordance with the Code of Practice on the Packaging, Labelling and Storage of
Chemical Wastes.
The
status of environmental licensing and permit is summarized in Table 2.13 below.
Table 2.13 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental
Permit |
EP-354/2009/D |
13
March 2015 |
Throughout
the Contract |
HyD |
Application for VEP on 3 March 2015 to supersede
EP-354/2009/C |
Construction
Dust Notification |
363510 |
19
August 2013 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Construction
Dust Notification |
403620 |
10 June 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Chemical
Waste Registration |
5213-422-D2516-02 |
18 January 2017 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Chemical
Waste Registration |
5213-951-D2591-01 |
25 May 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Construction
Waste Disposal Account |
7018108 |
28
August 2013 |
Throughout
the Contract |
DBJV |
Waste disposal in Contract No. HY/2012/08 |
Construction
Waste Disposal Account |
7021715 |
21
March 2019 |
14
July 2019 |
DBJV |
Vessel Disposal |
Waste
Water Discharge License |
WT00019248-2014 |
5
June 2014 |
30
June 2019 |
DBJV |
For site Portion N6 and Reclamation Area E |
Waste
Water Discharge License |
WT00031435-2018 |
2 August 2018 |
31 August 2023 |
DBJV |
Southern Landfall |
Marine
Dumping Permit |
EP/MD/19-063 |
19 November 2018 |
18 May 2019 |
DBJV |
Type 1 (Open Sea Disposal) |
Marine
Dumping Permit |
EP/MD/19-109 |
5 March 2019 |
4 April 2019 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Marine
Dumping Permit |
EP/MD/19-121 |
5 April 2019 |
4 May 2019 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Construction Noise Permit |
GW-RW0406-18 |
16 October 2018 |
15 April 2019 |
DBJV |
Urmston
Road in front of Pillar Point |
Construction Noise Permit |
GW-RS0966-18 |
26 October 2018 |
14 April 2019 |
DBJV |
Southern
Landfall |
Construction Noise Permit |
GW-RS0224-19 |
25 March 2019 |
24 September 2019 |
DBJV |
Southern
Landfall |
Construction Noise Permit |
GW-RW0179-19 |
27 April 2019 |
15 October 2019 |
DBJV |
Urmston
Road in front of Pillar Point |
Notes: |
|||||
HyD
= Highways Department DBJV
= Dragages – Bouygues Joint Venture VEP
= Variation of Environmental Permit |
In
response to the site audit findings, the Contractors carried out all corrective
actions.
A
summary of the Implementation Schedule of Environmental Mitigation Measures
(EMIS) is presented in Appendix C. The
necessary mitigation measures relevant to this Contract were implemented
properly.
No
exceedances were recorded in the air quality monitoring of this reporting
month.
No
exceedances were recorded in the water quality monitoring of this reporting
month.
Cumulative
statistics are provided in Appendix L.
The Environmental
Complaint Handling Procedure is provided in Figure 2.5.
No environmental complaint
was received in this reporting period.
No
environmental summons was received in this reporting period.
Statistics
on complaints, notifications of summons and successful prosecutions are
summarized in Appendix L.
As
informed by the Contractor, the major works for the Contract in May 2019 are
summarized in Table 3.1.
Table
3.1 Construction Works to Be Undertaken in the Coming Month
Works to be undertaken |
Land-based
Works ·
Construction of Thermal barrier – TBM tunnel; ·
Bitumen Laying – TBM tunnel ·
Construction of Walkway Corbel & Cover – TBM
Tunnel; ·
RC structure – Portion N-A & S-A; ·
E&M Platform Installation – Portion S-A ·
ELS Removal – Portion S-A; ·
D-wall Construction – Portion S-C ·
Seawall Inspection and Remedial Works – Portion N-B ·
Marine-based
Works ·
Seawall Modification Works – Portion S-B |
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of May 2019 are mainly associated with dust, marine
water quality, marine ecology and waste management issues.
The
tentative schedule for environmental monitoring in May 2019 is
provided in Appendix F.
This Sixty-sixth
Monthly EM&A Report presents the findings of the EM&A activities
undertaken during the period from 1 to 30 April 2019, in accordance with the
Updated EM&A Manual and the requirements of EP-354/2009/D.
Air
quality (including 1-hour TSP and 24-hour TSP), water quality monitoring and
dolphin monitoring were carried out in this reporting month.
No
exceedances were recorded in the air quality monitoring of this reporting
month.
No
exceedances were recorded in the water quality monitoring of this reporting
month.
One
group of 2 Chinese White Dolphins sighting was recorded during the two sets of
surveys in April 2019. The dolphin
sighting was made in NWL, while none was sighted in NEL. The dolphin sighting was made during
on-effort search and was made on primary lines.
The dolphin groups were not associated with any operating fishing
vessel.
Environmental
site inspection was carried out four (4) times in April 2019. Remedial actions recommended for the
deficiencies identified during the site audits were properly implemented by the
Contractor.
No
non-compliance event was recorded during the reporting period.
No environmental complaint
was received in this reporting period.
No
environmental summons was received in this reporting period.
The
ET will keep track on the construction works to confirm compliance of environmental
requirements and the proper implementation of all necessary mitigation
measures.
