table
of Contents
Executive
Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Water Quality Monitoring
2.3 Dolphin Monitoring
2.4 EM&A Site Inspection
2.5 Waste Management Status
2.6 Environmental Licenses and
Permits
2.7 Implementation Status of
Environmental Mitigation Measures
2.8 Summary of Exceedances of the
Environmental Quality Performance Limit
2.9 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Activities for
the Coming Quarter
3.2 Key Issues for the Coming
Quarter
3.3 Monitoring Schedule for the
Coming Quarter
Under Contract
No. HY/2012/08, Dragages – Bouygues Joint Venture (DBJV) is commissioned by
the Highways Department (HyD) to undertake the design and construction of the
Northern Connection Sub-sea Tunnel Section of the Tuen Mun – Chek Lap Kok Link
Project (TM-CLK Link Project) while AECOM Asia Company Limited was
appointed by HyD as the Supervising Officer.
For implementation of the environmental monitoring and audit (EM&A)
programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed
as the Environmental Team (ET) in accordance with Environmental Permit No. EP-354/2009/A.
Ramboll Hong Kong Ltd. was employed by HyD as the Independent Environmental
Checker (IEC) and Environmental Project Office (ENPO). Subsequent applications for
variation of environmental permits (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were
granted on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
The construction phase of the Project commenced on 1
November 2013 and will tentatively be completed by the end of 2019. The impact monitoring of the EM&A programme,
including air quality, water quality, marine ecological monitoring and
environmental site inspections, were commenced on 1 November 2013.
This is the Eighteenth Quarterly EM&A report
presenting the EM&A works carried out during the period from 1 March 2018
to 31 May 2018 for the Contract No.
HY/2012/08 Northern
Connection Sub-sea Tunnel Section (the “Project”) in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, the major activities in the reporting quarter included:
Land-based Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Cross Passage Construction by Pipe Jacking – TBM
Tunnel;
·
Corbel & OVHD Construction – TBM Tunnel;
·
Parapet wall and fireboard Installation – TBM Tunnel;
·
Bulk Excavation – Portion S-A; and
·
CSM treatment, Jet Grouting works and D-wall
Construction
·
Ground Freezing Works – Portion S-A
A summary of monitoring and audit activities conducted
in the reporting period is listed below:
24-hour TSP Monitoring 31
sessions
1-hour TSP Monitoring 31
sessions
Impact Dolphin Monitoring 6 sessions
Joint Environmental Site Inspection 13 sessions
Implementation
of Marine Mammal Exclusion Zone
There was no dredging, reclamation or
marine sheet piling works in open waters during this reporting period.
Thus, Passive Acoustic Monitoring (PAM) and the day-time monitoring of Dolphin
Exclusion Zone (DEZ) by dolphin observers were not in effect during the
reporting period.
Summary of Breaches of Action/Limit Levels
Breaches of
Action and Limit Levels for Air Quality
Three (3) Action Level exceedances of 1-hour TSP were
recorded in the air quality monitoring of this reporting period. Investigation report is provided in Appendix I.
Dolphin Monitoring
Whilst
one (1) Limit Level exceedance was observed for the quarterly dolphin monitoring
data between March and May 2018, no unacceptable impact from the construction
activities of the TM-CLKL Northern Connection Sub-sea Tunnel Section on Chinese White Dolphins
was noticeable from general observations during the
dolphin monitoring in this reporting quarter.
Environmental
Complaints, Non-compliance & Summons
No
non-compliance with EIA recommendations, EP conditions and other requirements
associated with the construction of this Contract was recorded in this
reporting period.
No
environmental complaint was received in this reporting period.
No environmental summons was received in this
reporting period.
Reporting Change
There was no reporting change required in the
reporting period.
Upcoming Works for the Next Reporting Period
Works to be undertaken in the coming quarterly period
include the following:
Land-based Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Excavation of Sub-sea Tunnel – TBM tunnel;
·
Parapet wall and fireboard Installation – TBM Tunnel
·
Corbel Construction – TBM Tunnel;
·
Bulk Excavation – Portion S-A;
·
TBM Excavation – Portion S-A; and
·
CSM treatment, Jet Grouting works and D-wall
Construction
Future Key Issues
Potential environmental impacts arising from the above
upcoming construction activities in the coming quarterly period are expected to
be mainly associated with dust, marine ecology and waste management issues.
According to the findings of the Northwest New
Territories (NWNT) Traffic and Infrastructure Review conducted by the Transport
Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau
Highway would be operating beyond capacity after 2016. This forecast has been based on the estimated
increase in cross boundary traffic, developments in the Northwest New Territories
(NWNT), and possible developments in North Lantau, including the Airport
developments, the Lantau Logistics Park (LLP) and the Hong Kong – Zhuhai –
Macao Bridge (HZMB). In order to cope
with the anticipated traffic demand, two new road sections between NWNT and
North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western
Bypass (TMWB) are proposed.
An Environmental Impact Assessment (EIA) of TM-CLKL
(the Project) was prepared in accordance with the EIA Study Brief (No.
ESB-175/2007) and the Technical
Memorandum of the Environmental Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (VEP) (EP-354/2009/A) was issued on 8 December
2010. Subsequent applications for variation
of environmental permits (VEP), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D,
were granted on 28 January 2014, 10 December 2014 and 13 March 2015,
respectively.
Under Contract
No. HY/2012/08, Dragages – Bouygues Joint Venture (DBJV) is commissioned by
the Highways Department (HyD) to undertake the design and construction of the
Northern Connection Sub-sea Tunnel Section of TM-CLKL while AECOM
Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong,
Limited (ERM) has been appointed as the Environmental Team (ET) in accordance
with Environmental Permit No. EP-354/2009/A. Ramboll Hong Kong Ltd.
was employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO).
Layout of the Contract components is
presented in Figure 1.1.
The organization structure of the Contract is shown in
Appendix A. The
key personnel contact names and contact details are summarized in Table 1.1 below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways
Department |
Engr 22/HZMB |
Chow Man Lung,
Andrew |
2762 4110 |
2762 4110 |
SOR (AECOM Asia
Company Limited) |
Chief Resident
Engineer |
Roger Man Andrew
Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
ENPO / IEC (Ramboll Hong
Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465
2850 |
3465 2899 |
IEC |
Dr. F.C. Tsang |
3465
2851 |
3465 2899 |
|
Contractor (Dragages – Bouygues Joint Venture) |
Environmental
Officer |
Bryan Lee |
2293 7323 |
2293 7499 |
|
24-hour
complaint hotline |
Rachel Lam |
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
The general layout plan of the site showing the
detailed works areas is shown in Figure 1.2. The
Environmental Sensitive Receivers in the vicinity of the Project are shown in Figure 1.3.
Table 1.2 Summary of Construction Activities Undertaken during the
Reporting Period
Construction Activities Undertaken |
Land-based Works |
·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Cross Passage Construction by Pipe Jacking – TBM
Tunnel; ·
Corbel & OVHD Construction – TBM Tunnel; ·
Parapet wall and fireboard Installation – TBM
Tunnel; ·
Bulk Excavation – Portion S-A; and ·
CSM treatment, Jet Grouting works and D-wall
Construction ·
Ground Freezing Works – Portion S-A |

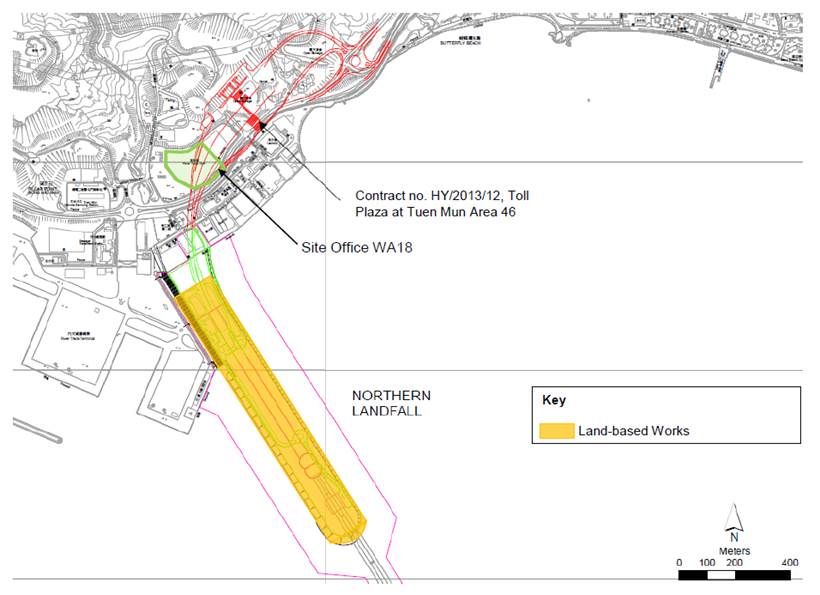

Figure 1.2 Locations of Construction Activities – March to May 2018
|
The EM&A programme required environmental
monitoring for air quality, water quality and marine ecology as well as environmental
site inspections for air quality, noise, water quality, waste management,
marine ecology and landscape and visual impacts. The EM&A requirements and related
findings for each component are summarized in the following sections
As per the requirements
under Condition 2.4 of EP-354/2009/D, the Enhanced TSP
Monitoring Plan has been prepared under Contract
No. HY/2012/08. Details of the
monitoring plan are presented in the Enhanced
TSP Monitoring Plan ([1]).
In accordance with the Updated EM&A Manual and the
Enhanced
TSP Monitoring Plan, impact 1-hour TSP monitoring was conducted three (3)
times in every six (6) days and impact 24-hour TSP monitoring was carried out
once in every six (6) days when the highest dust impact was expected. 1-hr and 24-hr TSP monitoring frequency was
increased to three times per day every three days and daily every three days
respectively as excavation works for launching shaft commenced on 24 October
2014.
High volume samplers (HVSs) were used to carry out the
1-hour and 24-hour TSP monitoring in the reporting quarter at the five (5) air
quality monitoring stations in accordance with the requirements stipulated in
the Updated EM&A Manual (Figure 2.1; Table 2.1). Wind anemometer was installed at the rooftop
of ASR5 for logging wind speed and wind direction. Details of the equipment deployed are
provided in Table 2.2.
Table 2.1 Locations of Impact Air Quality Monitoring Stations and
Monitoring Dates in this Reporting Period
Monitoring
Station |
Monitoring
Dates |
Location |
Description |
Parameters & Frequency |
ASR1 |
2, 5, 8, 11, 14, 17, 20, 23, 26 and 29 March 2018 |
Tuen Mun Fireboat Station |
Office |
TSP monitoring 1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3
times in every 6 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour in every 6 days Enhanced TSP monitoring
(commenced on 24 October 2014) 1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3
times in every 3 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour in every 3 days |
ASR5 |
1, 4, 7, 10, 13, 16, 19, 22, 25 and 28 April 2018 |
Pillar Point Fire Station |
Office |
|
AQMS1 |
1, 4, 7, 10, 13, 16, 19, 22, 25, 28 and 31 May 2018 |
Previous River Trade Golf |
Bare ground |
|
ASR6 |
|
Butterfly Beach Laundry |
Office |
|
ASR10 |
|
Butterfly Beach Park |
Recreational uses |
Table
2.2 Air Quality
Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total
Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model: Vantage Pro 2 (S/N: AS160104014) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The Action and Limit Levels of the air quality
monitoring is provided in Appendix D. The Event and Action plan is presented in Appendix H.
The schedules for air quality monitoring in the
reporting quarter are provided in Appendix E.
Impact air quality monitoring was conducted at all
designated monitoring stations in the reporting period under favourable weather
conditions. The major dust sources in
the reporting period include construction activities under the Contract as well
as nearby traffic emissions.
The monitoring results for 1-hour TSP and 24-hour TSP
are summarized in Tables 2.3 and 2.4, respectively. Monitoring results are presented graphically
in Appendix F and detailed impact air quality monitoring
data were reported in the Fifty-third to Fifty-fifth Monthly EM&A Report.
Table 2.3 Summary of 1-hour TSP Monitoring Results in this Reporting
Period
Month/Year |
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
March to May
2018 |
ASR 1 |
127 |
39
- 460 |
331 |
500 |
ASR 5 |
162 |
57
- 389 |
340 |
500 |
|
AQMS1 |
95 |
22
- 197 |
335 |
500 |
|
ASR6 |
116 |
33
- 295 |
338 |
500 |
|
ASR10 |
75 |
28
- 196 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in this Reporting
Period
Month/Year |
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
March to May
2018 |
ASR 1 |
86 |
30
- 176 |
213 |
260 |
ASR 5 |
94 |
62
- 179 |
238 |
260 |
|
AQMS1 |
63 |
36
- 124 |
213 |
260 |
|
ASR6 |
75 |
43
- 164 |
238 |
260 |
|
ASR10 |
54 |
24
- 132 |
214 |
260 |
Three (3) Action Level exceedances of 1-hour TSP were
recorded in the air quality monitoring of this reporting period. Summary of Exceedances for Air Quality Impact
Monitoring in this Reporting Quarter is detailed in Table 2.13.
Seawall Enhancement Works at Northern Landfall has
been completed on 31 December 2017.
Notification of suspension of water quality monitoring has been approved
by EPD on 2 March 2018. Water Quality
Monitoring will be resumed prior to the start of Seawall Modification Works at
Southern Landfall in January 2019.
Impact dolphin monitoring is required to be conducted
by a qualified dolphin specialist team to evaluate whether there have been any
effects on the dolphins. In order to
fulfil the EM&A requirements and make good use of available resources, the
on-going impact line transect dolphin monitoring data collected by HyD’s Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong Kong
Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing
Facilities on the monthly basis is adopted to avoid duplicates of survey
effort.
Table 2.5 summarizes
the equipment used for the impact dolphin monitoring.
Table 2.5 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and reticules 65 foot single engine motor vessel with viewing platform 4.5m above
water level |
Dolphin monitoring should cover all transect lines in
Northeast Lantau (NEL) and the Northwest Lantau (NWL) survey areas twice per
month throughout the entire construction period. The monitoring data should be compatible
with, and should be made available for, long-term studies of small cetacean
ecology in Hong Kong. In order to
provide a suitable long-term dataset for comparison, identical methodology and
line transects employed in baseline dolphin monitoring was followed in the
impact dolphin monitoring.
The impact dolphin monitoring was carried out in the
NEL and NWL along the line transect as depicted in Figure 2.2. The co-ordinates of all transect lines are
shown in Table 2.6 below.
Table
2.6 Impact Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
815456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805476 |
820800* |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805476 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
821150* |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
821500* |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
821850* |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
822150* |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
822000* |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
821176 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
12 |
End
Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
The Action and Limit levels of dolphin impact
monitoring are shown in Appendix D. The Event and Action plan is presented in Appendix H.
The dolphin monitoring schedules for the reporting
period are shown in Appendix E.
A total of 791.83 km of survey effort was conducted,
with 89.8% of the total survey effort being conducted under
favourable weather conditions (ie Beaufort Sea State 3 or below with good
visibility) in this reporting quarter.
Amongst the two areas, 290.90 km and 500.93 km of survey effort were
conducted from NEL and NWL survey areas, respectively. The total survey effort conducted on primary
and secondary lines were 576.61 km and 215.22 km, respectively. The survey efforts are summarized in Appendix G.
A total of 9 groups of 30 Chinese White Dolphins
sightings were recorded during the six sets of surveys
in this reporting quarter. All dolphin sightings were made during on-effort search, and eight of
the nine on-effort dolphin sightings were made on primary lines.
During this reporting quarter, all dolphin groups were sighted in NWL,
while no dolphin was sighted
in NEL.
Encounter rates of Chinese White Dolphins are deduced from
the survey effort and on-effort sighting data made under favourable conditions
(Beaufort 3 or below with good visibility) in the reporting quarter with the
results and comparison with baseline results present in Tables 2.7 and 2.8.
Table 2.7 Individual Survey Event Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1
(8 & 12 Mar) |
0.00 |
0.00 |
Set 2
(20 & 23 Mar) |
0.00 |
0.00 |
|
Set 3
(10 & 17 Apr) |
0.00 |
0.00 |
|
Set 4
(19 & 25 Apr) |
0.00 |
0.00 |
|
Set 5
(7 & 10 May) |
0.00 |
0.00 |
|
Set 6
(16 & 30 May) |
0.00 |
0.00 |
|
NWL |
Set 1
(8 & 12 Mar) |
1.73 |
5.19 |
Set 2
(20 & 23 Mar) |
12.32 |
56.69 |
|
Set 3
(10 & 17 Apr) |
0.00 |
0.00 |
|
Set 4
(19 & 25 Apr) |
3.24 |
4.87 |
|
Set 5
(7 & 10 May) |
0.00 |
0.00 |
|
Set 6
(16 & 30 May) |
0.00 |
0.00 |
Note: Dolphin Encounter Rates are
deduced from the Two Sets of Surveys (Two Surveys in Each Set) in the reporting
quarter in Northeast (NEL) and Northwest Lantau (NWL)
Table 2.8 Quarterly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
||
September – November 2011 |
March –
May 2018 |
September – November 2011 |
||
Northeast Lantau |
0.0 |
6.00
± 5.05 |
0.0 |
22.19
± 26.81 |
Northwest Lantau |
2.88
± 4.81 |
9.85
± 5.85 |
11.12
± 22.46 |
44.66
± 29.85 |
Note: Encounter rates deduced from the
baseline monitoring period have been recalculated based only on survey effort
and on-effort sighting data made along the primary transect lines under
favourable conditions.
Group size of Chinese White
Dolphins ranged from 1 - 8 individuals per group in North Lantau region during
March to May 2018. The average dolphin
group sizes from these three months were compared with the ones deduced from
the baseline period in September to November 2011, as shown in Table 2.9.
Table 2.9 Average Dolphin Group Size
|
Average Dolphin Group Size |
|
March
– May 2018 |
September – November 2011 |
|
Overall |
3.33
± 3.39 (n = 9) |
3.72
± 3.13 (n = 66) |
Northeast Lantau |
--- |
|
Northwest Lantau |
3.33
± 3.39 (n = 9) |
3.92
± 3.40 (n = 49) |
Whilst one limit level exceedance was observed for the
quarterly dolphin monitoring data between March and May 2018, no
unacceptable impact from the construction activities of this Contract was
recorded from the general observations.
Although the dolphins infrequently occurred along the
alignment of TM-CLKL Northern Connection Sub-Sea Tunnel Section in the past and
during the baseline monitoring period, it is apparent that dolphin usage has
been significantly reduced in NEL.
It is critical to monitor the dolphin usage in North
Lantau region in the upcoming quarters to determine whether the dolphins are
continuously affected by the various construction activities in relation to the
HZMB-related works, and whether suitable mitigation measure can be applied to
revert the situation.
There was no dredging, reclamation or marine sheet piling works in
open waters during this reporting period. Thus, Passive Acoustic
Monitoring (PAM) and the day-time monitoring of Dolphin Exclusion Zone (DEZ) by
dolphin observers were not in effect during the reporting period.
Site inspections were carried out on a weekly basis to
monitor the implementation of proper environmental pollution control and
mitigation measures under the Contract.
Thirteen (13) site inspections were carried out in the reporting quarter
on 7, 14, 21 and 28 March 2018;
4, 11, 18 and 25 April 2018;
2, 9, 16, 23 and 30 May 2018.
Key observations during the site inspections in this
reporting period are summarized in Table
2.10.
Table 2.10 Specific Observations and Recommendations during the Weekly
Site Inspection in this Reporting Period
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
|
7 March 2018 |
Works
Area – Portion N-C Accumulated
waste in the waste container should be removed. Drip
tray should be provided for the oil drum. Cement
bags should be covered with tarpaulin sheeting. Works
Area – Portion S-A U-channel
should be installed for collection of rainwater. Reminder
from SOR Works
Area – Portion S-A The
tip of excavator should be mounted with noise absorbent. |
Works
Area – Portion N-C The
Contractor was reminded to remove the accumulated waste in the waste
container. The
Contractor was reminded to provide drip tray for the oil drum. The
Contractor was reminded to cover the cement bags with tarpaulin sheeting. Works
Area – Portion S-A The
Contractor was reminded to install U-channel for collection of rainwater. Reminder
from SOR Works
Area – Portion S-A The
Contractor was reminded to mount the tip of excavator with noise absorbent. |
|
14
March 2018 |
Works
Area – TBM tunnel Drip
tray should be provided for the chemical containers. Cement
bags should be covered with tarpaulin sheeting. Works
Area –Portion S-B Cement
bags should be covered with tarpaulin sheeting. Drip
tray should be provided for the chemical containers. Drip
tray should be provided for the chemical containers. |
Works
Area – TBM tunnel The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to cover the cement bags with tarpaulin sheeting. Works
Area –Portion S-B The
Contractor was reminded to cover the cement bags with tarpaulin sheeting. The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to provide drip tray for the chemical containers. |
|
21 March 2018 |
Works
Area – Portion N-C Drip
tray should be provided for the chemical containers. Cement
bags should be covered with tarpaulin sheeting. Works
Area - Portion N-A Drip
tray should be provided for the chemical containers. Works
Area - Portion S-A The
top and 3 sides of the grout mixer should be enclosed with impervious
sheeting. Drip
tray should be provided for the oil drums. |
Works
Area – Portion N-C The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to cover the cement bags with tarpaulin sheeting. Works
Area - Portion N-A The
Contractor was reminded to provide drip tray for the chemical containers. Works
Area - Portion S-A The
Contractor was reminded to enclose the top and 3 sides of the grout mixer
with impervious sheeting. The
Contractor was reminded to provide drip tray for the oil drums. |
|
28
March 2018 |
Works
Area - Portion N-C Drip
tray should be provided for the chemical containers. Works
Area - Portion N-A Dusty
material should be covered with tarpaulin sheets. Proper
NRMM label should be displayed. Works
Area - Portion S-C The
cement bags should be covered with impervious sheeting. Works
Area - Portion S-B Drip
tray should be provided for the chemical containers. Drip
tray should be provided for the chemical containers. The
chemical should be stored properly.. |
Works
Area - Portion N-C The
Contractor was reminded to provide drip tray for the chemical containers. Works
Area - Portion N-A The
Contractor was reminded to cover the dusty mateiral with tarpaulin sheetings. The
Contractor was reminded to display proper NRMM label. Works
Area - Portion S-C The
Contractor was reminded to cover the cement bags with impervious sheeting. Works
Area - Portion S-B The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to store the chemical properly. |
|
4 April 2018 |
Works
Area – Portion S-B The
cement bags should be covered with impervious sheeting. Works
Area – Portion N-C Stagnant
water should be pumped off to avoid mosquito larva breeding. |
Works
Area – Portion S-B The
Contractor was reminded to cover the cement bags with impervious sheeting. Works
Area – Portion N-C The
Contractor was reminded to pump off the stagnant water to avoid mosquito
breeding. |
|
11 April 2018 |
Works
Area – Portion S-B Drip
tray should be provided to the chemical containers. Works
Area – Portion N-C Stagnant
water should be pumped off to avoid mosquito larva breeding. Works
Area – Portion N-A Proper
NRMM label should be displayed. Reminder
from SOR Works
Area - Portion S-B The
broken water barriers should be replaced. |
Works
Area – Portion S-B The
Contractor was reminded to provide drip tray to the chemical containers. Works
Area – Portion N-C The
Contractor was reminded to pump off the stagnant water to avoid mosquito
breeding. Works
Area – Portion N-A The
Contractor was reminded to display proper NRMM label. Reminder
from SOR Works
Area - Portion S-B The
Contractor was reminded to replace the broken barriers. |
|
18
April 2018 |
Works
Area – TBM tunnel Drip
tray should be provided for the chemical containers. Works
Area - Portion S-B NRMM
label should be displayed on the generator. |
Works
Area – TBM tunnel The
Contractor was reminded to provide drip tray to the chemical containers. Works
Area - Portion S-B The
Contractor was reminded to display NRMM label on the generator. |
|
25 April 2018 |
Works
Area - Portion S-B Proper
NRMM label should be displayed on the excavator. Drip
tray should be provided for the chemical containers Works
Area - Portion N-C Faded
NRMM label should be replaced by standard NRMM label. |
Works
Area - Portion S-B The
Contractor was reminded to display proper NRMM label on the excavator. The
Contractor was reminded to provide drip tray for the chemical containers. Works
Area - Portion N-C The
Contractor was reminded to replace the faded NRMM label with standard NRMM
label. |
|
2
May 2018 |
Works
Area – Portion S-B Stagnent
water on the oil drum should be removed. Works
Area – Portion S-A Drip
tray should be provided for the oil drums. Works
Area – TBM tunnel Cement
bags should be covered with impervious sheeting. Drip
tray should be provided for the chemical containers. Drip
tray should be provided for the chemical containers. |
Works
Area – Portion S-B The
Contractor was reminded to remove stagnent water on the oil drum. Works
Area – Portion S-A The
Contractor was reminded to provide drip tray for the oil drums. Works
Area – TBM tunnel The
Contractor was reminded to cover the cement bags with impervious sheeting. The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to provide drip tray for the chemical containers. |
|
9 May 2018 |
Works
Area – Portion S-B General
refuse should be removed. Works
Area – Portion N-C Drip
tray should be provided for the chemical containers. Works
Area – Portion N-A The
faded NRMM should be replaced by the standard NRMM label. |
Works
Area – Portion S-B The
Contractor was reminded to remove the general refuse. Works
Area – Portion N-C The
Contractor was reminded to provide drip tray for the chemical containers. Works
Area – Portion N-A The
Contractor was reminded to replace the faded NRMM label with the standard
NRMM label. |
|
16
May 2018 |
Works
Area – Portion N-A Stagnant
water in the drip tray should be removed. Reminder from the SOR Works
Area - Portion S-A The
tip of the excavator should be enclosed with noise abatement material. |
Works
Area – Portion N-A The
Contractor was reminded to remove the stagnant water in the drip tray. Reminder from the SOR Works
Area - Portion S-A The
Contractor was reminded to enclose the tip of the excavator with noise
abatement mateiral. |
|
23 May 2018 |
Works
Area - Portion N-C Drip
tray should be provided to the chemical containers. Cement
bags should be covered with tarpaulin sheets. Works
Area - Portion S-A Stagnant
water in the drip tray should be removed. Works
Area - Portion S-B Accumulated
rubbish in the skip should be removed. |
Works
Area - Portion N-C The
Contractor was reminded to provide drip tray to the chemical containers. The
Contractor was reminded to cover the cement nags with tarpaulin sheets. Works
Area - Portion S-A The
Contractor was reminded to remove the stagnant water in the drip tray. Works
Area - Portion S-B The
Contractor was reminded to remove the accumulated rubbish in the skip. |
|
30
May 2018 |
Works
Area - Portion N-C Cement
bags should be covered with tarpaulin sheets. Works
Area - Portion N-A Water
spraying should be applied more frequently during dry conditions. The
slope surface should be covered with impervious sheeting. Works
Area - Portion S-B Cement
bags should be covered with tarpaulin sheets. Stagnant
water should be removed. Water
spraying should be applied more frequently during dry conditions. The
slope surface should be covered with impervious sheeting. Reminder from the SOR: Works
Area - Portion S-B The
breaker tip should be wrapped with soundproof mat. |
Works
Area - Portion N-C The
Contractor was reminded to cover the cement bags with tarpaulin sheets. Works
Area - Portion N-A The
Contractor was reminded to apply water spraying more frequently during dry
conditions. The
Contractor was reminded to cover the slope surface with impervious sheeting. Works
Area - Portion S-B The
Contractor was reminded to cover the cement bags with tarpaulin sheets. The
Contractor was reminded to remove the stagnant water. The
Contractor was reminded to apply water spraying more frequently during dry
conditions. The
Contractor was reminded to cover the slope surface with impervious sheeting. Reminder from the SOR: Works
Area - Portion S-B The
Contractor was reminder to wrap the breaker tip with soundproof mat. |
|
The Contractor had submitted application form for
registration as chemical waste producer under the Contract. Sufficient numbers of receptacles were
available for general refuse collection and sorting.
Wastes generated during this reporting period include
mainly construction wastes (inert and non-inert) and chemical wastes. Reference
has been made to the waste flow table prepared by the Contractor (Appendix J). The
quantities of different types of wastes are summarized in Table 2.11.
Table 2.11 Quantities of Different Waste Generated in the Reporting Period
Month/Year |
Inert Construction Waste (a)
(tonnes) |
Inert Construction Waste Re-used (tonnes) |
Non-inert Construction Waste (b)
(tonnes) |
Imported
Fill (tonnes) (d) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
||
|
Category L |
Category M (Mp & Mf) |
|||||||
March 2018 |
66,457 |
62,247 |
459 |
0 |
229,360 |
2,000 |
0 |
6,195 |
|
April 2018 |
123,942 |
50,648 |
281 |
56,192.51 |
195,550 |
8,600 |
0 |
1,957 |
|
May 2018 |
127,964 |
62,822 |
686 |
13,289 |
93,310 |
0 |
0 |
177 |
|
|
Notes: |
|
|||||||
|
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. (d) The
origin of imported fill is from Contract
No. HY/2013/03. |
|
|||||||
The Contractor was advised to properly maintain on
site C&D materials and waste collection, sorting and recording system,
dispose of C&D materials and wastes at designated ground and maximize
reuse/ recycle of C&D materials and wastes.
The Contractor was also reminded to properly maintain the site tidiness
and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was
reminded to treat properly and store temporarily in designated chemical waste
storage area on site in accordance with the Code of Practice on the Packaging,
Labelling and Storage of Chemical Wastes.
The status of environmental licensing and permit is
summarized in Table 2.12 below.
Table 2.12 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental
Permit |
EP-354/2009/D |
13
March 2015 |
Throughout
the Contract |
HyD |
Application for VEP on 3 March 2015 to supersede
EP-354/2009/C |
Construction
Dust Notification |
363510 |
19
August 2013 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Construction
Dust Notification |
403620 |
10 June 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Chemical
Waste Registration |
5213-422-D2516-02 |
18 January 2017 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Chemical
Waste Registration |
5213-951-D2591-01 |
25 May 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Construction
Waste Disposal Account |
7018108 |
28
August 2013 |
Throughout
the Contract |
DBJV |
Waste disposal in Contract No. HY/2012/08 |
Construction
Waste Disposal Account |
7021715 |
17
April 2018 |
17
July 2018 |
DBJV |
Vessel Disposal |
Waste
Water Discharge License |
WT00017707-2013 |
18
November 2013 |
30
November 2018 |
DBJV |
For site WA18 |
Waste
Water Discharge License |
WT00019248-2014 |
5
June 2014 |
30
June 2019 |
DBJV |
For site Portion N6 and Reclamation Area E |
Waste
Water Discharge License |
WT00025944-2016 |
15 December 2016 |
31 December 2021 |
DBJV |
Southern Landfall |
Marine
Dumping Permit |
EP/MD/19-001 |
24 April 2018 |
23 May 2018 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Marine
Dumping Permit |
EP/MD/18-125 |
21 February 2018 |
20 March 2018 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Marine
Dumping Permit |
EP/MD/18-133 |
22 March 2018 |
21 April 2018 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Marine
Dumping Permit |
EP/MD/19-001 |
28 May 2018 |
27 June 2018 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Construction
Noise Permit |
GW-RW0538-17 |
16 April 2018 |
15 October 2018 |
DBJV |
For
Urmston Road in front of Pillar Point |
Construction
Noise Permit |
GW-RW0641-17 |
16 December 2017 |
6 December 2018 |
DBJV |
WA23
@ Tsing Yi |
Construction Noise Permit |
PP-RS0026-17 |
3 April 2017 |
31 July 2018 |
DBJV |
Southern Landfall (Percussive Piling) |
Construction Noise Permit |
GW-RS0878-17 |
11 October 2017 |
2 April 2018 |
DBJV |
Southern Landfall |
Construction Noise Permit |
GW-RW0060-18 |
20 February 2018 |
19 August 2018 |
DBJV |
WA23
@ Tsing Yi |
Construction Noise Permit |
GW-RS0027-18 |
22 January 2018 |
14 July 2018 |
DBJV |
Southern
Landfall |
Notes: |
|||||
HyD
= Highways Department DBJV
= Dragages – Bouygues Joint Venture VEP
= Variation of Environmental Permit |
In response to the site audit findings, the
Contractors carried out all corrective actions.
A summary of the Implementation Schedule of
Environmental Mitigation Measures (EMIS) is presented in Appendix C. The necessary mitigation measures relevant to
this Contract were implemented properly.
For
air quality impact monitoring, a total of thirty-one monitoring events for both
1-hour TSP and 24-hour TSP were undertaken in which three (3) Action Level
exceedances of 1-hour TSP were recorded in the air quality monitoring of this
reporting period. (Table 2.13).
Table 2.13 Summary of
Exceedances for Air Quality Impact Monitoring in this Reporting Quarter
|
One (1) Limit Level exceedance was observed for the
quarterly dolphin monitoring data between March and May 2018, whilst no
unacceptable impact from the construction activities of the TM-CLKL Northern
Connection Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from
general observations.
Cumulative statistics are provided in Appendix I.
The Environmental Complaint Handling Procedure is
provided in Figure 2.3.
No
environmental complaint was received in this reporting period.
No environmental summons was received in this
reporting period.
Statistics on complaints, notifications of summons and
successful prosecutions are summarized in Appendix I.
As informed by the Contractor, the major works for the
Project in the coming quarter are summarized in Table 3.1.
Table 3.1 Construction Works to Be Undertaken in the Coming Quarter
Works to be undertaken |
Land-based
Works ·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Excavation of Sub-sea Tunnel – TBM tunnel; ·
Parapet wall and fireboard Installation – TBM Tunnel ·
Corbel Construction – TBM Tunnel; ·
Bulk Excavation – Portion S-A; ·
TBM Excavation – Portion S-A; and ·
CSM treatment, Jet Grouting works and D-wall
Construction |
Potential environmental impacts arising from the above
upcoming construction activities in the coming quarterly period are expected to
be mainly associated with dust, marine ecology and waste management issues.
Impact monitoring for air quality and marine ecology
(include dolphin monitoring) are scheduled to continue for the next reporting
period.
This Eighteenth Quarterly EM&A Report presents the
findings of the EM&A activities undertaken during the period from 1 March
2018 to 31 May 2018, in accordance with the Updated EM&A Manual and the
requirements of EP-354/2009/D.
Air quality (including 1-hour TSP and 24-hour TSP and
dolphin monitoring were carried out in the reporting period. Three (3) Action Level exceedances of 1-hour
TSP were recorded in the air quality monitoring of this reporting period.
A total of 9 groups of 30 Chinese White Dolphins
sightings were recorded during the six sets of surveys
in this reporting quarter. All dolphin sightings were made during on-effort search, and eight of
the nine on-effort dolphin sightings were made on primary lines. Whilst one limit level exceedance was
observed for the quarterly dolphin monitoring data between March and May 2018, no
unacceptable impact from the construction activities of this Contract was
recorded from the general observations. Although the dolphins infrequently occurred
along the alignment of TM-CLKL Northern Connection Sub-Sea Tunnel Section in
the past and during the baseline monitoring period, it is apparent that dolphin
usage has been significantly reduced in NEL.
It is critical to monitor the dolphin usage in North Lantau region in
the upcoming quarters, to determine whether the dolphins are continuously
affected by the various construction activities in relation to the construction
works of the Contract, and whether suitable mitigation measure can be applied
to improve the situation.
Thirteen weekly environmental site
inspections were carried out in the reporting period. Recommendations on remedial actions provided
for the deficiencies identified during the site audits were properly
implemented by the Contractor. No
non-compliance event was recorded during the reporting period.
The monitoring programme has been reviewed and was
considered as adequate to cater for the nature of works in progress. Change to the monitoring programme
was thus not recommended at this stage.
The monitoring programme will be evaluated as appropriate in the next
reporting period. The ET will keep track
on the construction works to confirm compliance of environmental requirements
and the proper implementation of all necessary mitigation measures.
