Table of Contents
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Noise Monitoring
2.3 Water Quality Monitoring
2.4 Dolphin monitoring
2.5 EM&A Site inspection
2.6 Waste Management Status
2.7 Environmental Licenses and Permits
2.8 Implementation Status of
Environmental Mitigation Measures
2.9 Summary of Exceedances of the
Environmental Quality Performance Limit
2.10 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Programme for
the Coming Months
3.2 Key Issues for the Coming
Month
3.3 Monitoring Schedule for the
Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
List
of Appendices
Appendix A Project Organization for Environmental Works
Appendix B Three Month Rolling Construction Programmes
Appendix C Implementation Schedule of Environmental Mitigation
Measures (EMIS)
Appendix D Summary of Action and Limit Levels
Appendix E Calibration Certificates of Monitoring Equipment
Appendix F EM&A Monitoring Schedules
Appendix G Impact Air Quality Monitoring Results and Graphical
Presentation
Appendix H Meteorological Data for the Reporting Month
Appendix I Impact Noise Monitoring Results and Graphical
Presentation
Appendix J Impact Water Quality Monitoring Results and Graphical
Presentation
Appendix K Impact Dolphin Monitoring Survey Results
Appendix L Event Action Plan
Appendix M Monthly Summary of Waste Flow Table
Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON Hong
Kong Ltd. was employed by the HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO) in
accordance with Environmental Permit No. EP-354/2009/A. Further
applications for variation of environmental permit (VEP), EP-354/2009/B, EP-354/2009/C
and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The construction phase of the Contract commenced on 31
October 2013 and will tentatively be completed by 2018. The impact monitoring of the EM&A programme, including air quality, noise, water quality and
marine ecological monitoring as well as environmental site inspections,
commenced on 31 October 2013.
This is the Nineteenth Monthly EM&A report
presenting the EM&A works carried out during the period from 1 to 31 May
2015 for the Southern Connection Viaduct
Section in accordance with the Updated EM&A Manual of the
TM-CLK Link Project. As informed by the Contractor, major
activities in the reporting period included:
Marine Works
·
Construction and installation of pile caps;
·
Marine piling platform installation &
uninstallation;
·
Pier construction;
·
Installation of launching gantry;
·
Marine piling and
·
Installation of pier head segment.
Land-based
Works
·
Construction and installation of pile caps;
·
Pier construction;
·
Drainage works;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Tree survey, felling and transplanting;
·
Relocation of MTRC fence; and
·
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
A
summary of monitoring and audit activities conducted in the reporting period is
listed below:
24-hour
TSP monitoring 5
sessions
1-hour
TSP monitoring 5
sessions
Noise
monitoring 5
sessions
Impact
Water Quality Monitoring 13
sessions
Impact
Dolphin Monitoring 2
sessions
Joint
Environmental site inspection 4
sessions
Breaches of Action and Limit Levels for Air Quality
No
exceedance of Action and Limit Levels was recorded for construction air monitoring
in the reporting month.
Breaches of Action and Limit Levels for Noise
No
exceedance of Action and Limit Levels was recorded for construction noise
monitoring in the reporting month.
Breaches of Action and Limit Levels for Water Quality
One
(1) exceedance of Action Level for depth-averaged SS during mid-ebb tide was
recorded for water quality monitoring in the reporting month.
Impact Dolphin Monitoring
Whilst one (1) Limit Level
exceedance was observed for the quarterly dolphin monitoring data between March
and May 2015, no unacceptable impact from the construction activities of the
TM-CLKL Southern Connection Viaduct Section on Chinese White Dolphins was
noticeable from general observations.
Due to monthly variation in dolphin occurrence within the study area, it
would be more appropriate to draw conclusion on whether any impacts on dolphins
have been detected related to the construction activities of the TM-CLKL
Southern Connection Viaduct Section in the quarterly EM&A reports, where
comparison on distribution, group size and encounter rates of dolphins between
the quarterly impact monitoring period and baseline monitoring period will be
made.
Daily
marine mammal exclusion zone monitoring was undertaken during the period of
marine works under this Contract.
Passive Acoustic Monitoring (PAM) was implemented when the marine piling
works were carried out outside the daylight hours in this reporting month. No sighting of the Indo-Pacific humpback
dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was recorded in May 2015 during the exclusion zone
monitoring.
Environmental Complaints, Non-compliance & Summons
No
environmental complaint, notification of summons and successful prosecution was
received in the reporting month.
Reporting Change
Upcoming
Works for the Next Reporting Period
Works
to be undertaken in the next monitoring period of June 2015 include the
following:
Marine Works
·
Construction and installation of pile caps;
·
Marine piling platform installation &
uninstallation;
·
Pier construction;
·
Launching gantry and off-loading gantry assembly;
·
Marine piling and
·
Installation of pier head segment.
Land-based
Works
·
Construction and installation of pile caps;
·
Pier construction;
·
Drainage works;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Tree survey, felling and transplanting;
·
Relocation of MTRC fence; and
·
Slope work of Slopes 9SE-B/C9.
Future Key
Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of June 2015 are mainly associated with dust,
noise, marine water quality, marine ecology and waste management issues.
According
to the findings of the Northwest New Territories (NWNT) Traffic and
Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be
operating beyond capacity after 2016. This
forecast has been based on the estimated increase in cross boundary traffic,
developments in the Northwest New Territories (NWNT), and possible developments
in North Lantau, including the Airport developments, the Lantau Logistics Park
(LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic
demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek
Lap Kok Link (TM-CLKL) and Tuen
Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The EIA
Report was submitted under the Environmental Impact Assessment Ordinance (EIAO)
in August 2009. Subsequent to the
approval of the EIA Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (EP-354/2009/A)
was issued on 8 December 2010.
Under Contract
No.
HY/2012/07, Gammon Construction
Limited (GCL) is commissioned by the Highways Department (HyD)
to undertake the design and construction of the Southern Connection Viaduct
Section of TM-CLKL (“the Contract”) while AECOM Asia
Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON Hong
Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO) in
accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of
environmental permit (VEP), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The
organization structure of the Contract is shown in Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD
(Highways Department) |
Project
Coordinator |
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior
Engineer |
Steven Shum |
2762 4133 |
3188 6614 |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident
Engineer |
Kingman Chan |
3691 3950 |
3691 2899 |
ENPO / IEC (ENVIRON Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3547 2133 |
3465 2899 |
IEC |
Dr. F.C. Tsang |
3547 2134 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy
Tam |
2271 3113 |
2723 5660 |
Marine
Works
·
Construction and installation of pile caps;
·
Marine piling platform installation &
uninstallation;
·
Pier construction;
·
Installation of launching gantry;
·
Marine piling and
·
Installation of pier head segment.
Land-based
Works
·
Construction and installation of pile caps;
·
Pier construction;
·
Drainage works;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Tree survey, felling and transplanting;
·
Relocation of MTRC fence; and
·
Slope work of Slopes 9SE-B/C8, 9SE-B/C9 &
9SE-B/F9.
The locations

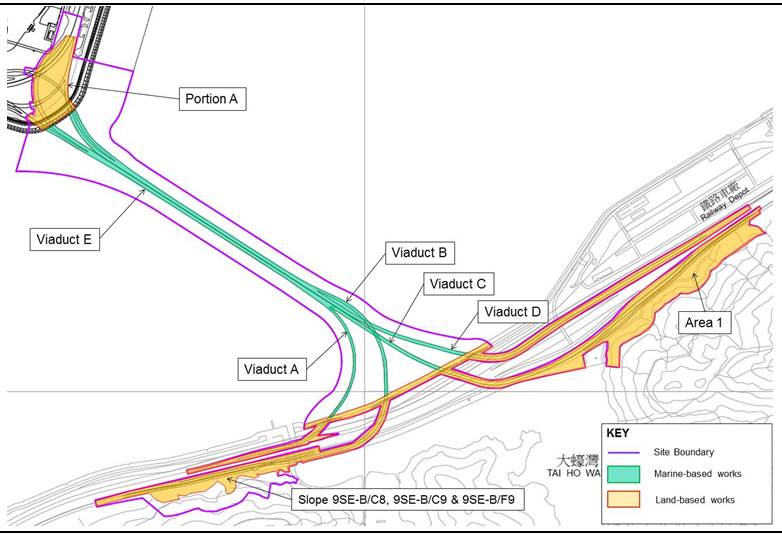

of the construction activities are shown in Figure 1.3.
The Environmental Sensitive Receivers in the vicinity of the Project are
shown in Figure 1.4.
The
EM&A programme required environmental monitoring for
air quality, noise, water quality and marine ecology as well as environmental
site inspections for air quality, noise, water quality, waste management,
marine ecology and landscape and visual impacts. The EM&A requirements and related
findings for each component are summarized in the following sections.
Table 2.1 Locations of Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
Description |
Monitoring Dates |
ASR 9 |
MTR Depot |
On the
ground nearby MTR Depot Entrance |
6, 12, 18,
21 and 27 May 2015 |
ASR 8A |
Area 4 |
On ground at
the works area, Area 4 |
6, 12, 18,
21 and 27 May 2015 |
High Volume Samplers (HVSs) were used for carried
out 1-hour and 24-hour TSP monitoring on 6, 12, 18, 21
and 27 May 2015 at ASR8A and ASR9 in
accordance with the requirements of the Updated EM&A Manual. The TSP monitoring stations are illustrated
in Figure 2.1 and detailed in Table 2.1. Wind anemometer
was deployed at Area 4 for logging wind speed and wind direction. Copies of the calibration
certificates for the equipment are presented in Appendix E. Details of
the deployed equipment are given in Table
2.2.
Table 2.2 Air Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume
Sampler |
Tisch Environmental Mass Flow
Controlled Total Suspended Particulate (TSP) High
Volume Sampler (Model No. TE-5170) |
Wind Sensor |
Global Water
(Wind Speed Sensor: WE550; Wind Direction Sensor: WE570) |
Wind
Anemometer for calibration |
Lutron (Model
No. AM-4201) |
Table 2.3 Summary of 1-hour TSP Monitoring Results in the Reporting
Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
64 |
49
- 149 |
394 |
500 |
ASR
9 |
77 |
53
- 119 |
393 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in the Reporting
Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
48 |
43
– 52 |
178 |
260 |
ASR
9 |
56 |
46
– 71 |
178 |
260 |
All 1-hour and 24-hour TSP results were below the Action and Limit
levels at all monitoring locations in the reporting period. No action is thus required to be undertaken
in accordance with the Event Action Plan presented in Appendix L.
Meteorological
information collected at ASR8A including
wind speed and wind direction is provided in Appendix H.
Noise monitoring was performed on 6, 12, 18, 21 and 27
May 2015 by using sound
level meter at the designated monitoring station NSR1A (Figure 2.2;
Table 2.5) in accordance with the requirements stipulated in the Updated
EM&A Manual. Acoustic calibrator was
deployed to check the sound level meters at a known sound pressure level. Details of the deployed equipment are
provided in Table 2.6. Copies of the calibration certificates for
the equipment are presented in Appendix E.
Table 2.5 Location of Impact Noise Monitoring Station
Monitoring Station |
Location |
Description |
Parameter |
Frequency and Duration |
Monitoring Dates |
NSR 1A |
Pak Mong Village Pavilion |
On the
ground at the village entrance |
30-minute
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. |
At least
once per week |
6, 12, 18,
21 and 27 May 2015 |
Table 2.6 Noise Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic
Calibrator |
Rion
NC-73 |
Table 2.7 Summary of Construction Noise Monitoring Results in the
Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
|
NSR
1A |
60 |
57
– 61 |
75 |
|
Table 2.8 Locations of Impact Water Quality Monitoring Stations and its
Corresponding Monitoring Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Frequency |
Depth |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact
Station (Close to HKBCF construction site) |
813273 |
818850 |
Temperature(°C)
pH (pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) ·
SS (mg/L) |
Impact monitoring: 3 days per week, at mid-flood and
mid-ebb tides during the construction period of the Contract |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed. If the water depth is less than 3m,
mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted |
IS(Mf)16 |
Impact
Station (Close to HKBCF construction site) |
814328 |
819497 |
|||
IS8 |
Impact
Station (Close to HKBCF construction site) |
814251 |
818412 |
|||
SR4 |
Sensitive
receiver (Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|||
*Notes: |
Table 2.9 Water Quality Monitoring Equipment
Equipment |
Brand and Model
|
DO and Salinity |
YSI Pro2030 |
Turbidity meter |
HACH Model 2100Q |
pH meter |
HANNA HI8314 |
Positioning
Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
One (1) Action level exceedance of depth-averaged SS
during mid-ebb tide was recorded on 19 May 2015 at monitoring station
SR4a. Actions were taken in accordance
with the Event Action Plan as presented in Appendix L.
Apart from the observed exceedance, results of
depth-averaged turbidity on 14 May 2015 at mid-flood tide, and depth-averaged
SS on 14, 16, 19 and 23 May 2015 during mid-ebb and/or mid-flood tides were
higher than the corresponding Action Levels at some of the impact stations and
sensitive receivers, but the results were lower than 120% of the upstream
control at the same tide of the same day (Table
2.10). As such, the above
depth-averaged turbidity and depth-average SS results were not regarded as
exceedance. No action is thus required
to be undertaken in accordance with the Event Action Plan (Appendix L).
Table 2.10 Summary of WQM Results Breaching the Action Level without
Exceedance
Date |
Tide |
Parameter |
Station |
14 May 2015 |
Mid-flood |
Turbidity |
IS8 and SR4 |
14 May 2015 |
Mid-ebb and
mid-flood |
SS |
IS(Mf)16, IS(Mf)9,
IS8, SR4 and SR4a |
16 May 2015 |
Mid-ebb and
mid-flood |
SS |
IS(Mf)16,
IS(Mf)9, IS8, SR4 and SR4a |
19 May 2015 |
Mid-ebb and
mid-flood |
SS |
IS(Mf)16,
IS(Mf)9, IS8, SR4 and SR4a |
23 May 2015 |
Mid-ebb |
SS |
IS(Mf)16,
IS(Mf)9, IS8 and SR4 |
23 May 2015 |
Mid-flood |
SS |
IS8 and SR4 |
Table
2.11 Dolphin Monitoring Equipment
Equipment |
Model |
|
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for
Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m
zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and
reticules 65 foot single engine motor vessel with viewing platform 4.5m above
water level |
|
Table
2.12 Impact Dolphin Monitoring Line Transect
Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
814577 |
13 |
Start
Point |
816506 |
819480 |
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
2 |
Start
Point |
805475 |
815457 |
14 |
Start
Point |
817537 |
820220 |
2 |
End Point |
805477 |
826654 |
14 |
End Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
819435 |
15 |
Start
Point |
818568 |
820735 |
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
819771 |
16 |
Start
Point |
819532 |
821420 |
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
820220 |
17 |
Start
Point |
820451 |
822125 |
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
820466 |
18 |
Start
Point |
821504 |
822371 |
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
820690 |
19 |
Start
Point |
822513 |
823268 |
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
820847 |
20 |
Start
Point |
823477 |
823402 |
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
820892 |
21 |
Start
Point |
805476 |
827081 |
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
820872 |
22 |
Start
Point |
806464 |
824033 |
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818449 |
23 |
Start
Point |
814559 |
821739 |
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
|
|
|
|
12 |
End Point |
815542 |
824882 |
|
|
|
|
The
Action and Limit levels of dolphin impact monitoring are shown in Appendix D. The
Event and Action plan is presented in Appendix L.
A
total of 301.70 km of survey effort was collected, with 98.7% of the total
survey effort being conducted under favourable
weather conditions (i.e. Beaufort Sea State 3 or below with good visibility)
during the surveys of May 2015. Among
the two areas, 114.90 km and 186.80 km of survey effort were collected from NEL
and NWL survey areas respectively. The
total survey effort conducted on primary and secondary lines were 219.76 km and
81.94 km respectively. The survey
efforts are summarized in Appendix K.
No
Chinese White Dolphins were sighted during the two sets of monitoring surveys
in May 2015.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable
conditions (Beaufort 3 or below) in May 2015 are shown in Tables 2.13 & 2.14.
Table 2.13 Individual Survey Event Encounter Rates
|
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km
of survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings
per 100 km of survey effort) |
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: May 4th / 8th |
0.0 |
0.0 |
Set 2: May 14th / 18th |
0.0 |
0.0 |
|
NWL |
Set 1: May 4th / 8th |
0.0 |
0.0 |
Set 2: May 14th / 18th |
0.0 |
0.0 |
|
Note: Dolphin Encounter Rates are deduced from the
two sets of surveys ( two surveys in each set) in May 2015 in Northeast (NEL)
and Northwest Lantau (NWL) |
Table 2.14 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
||
Primary Lines Only |
Both Primary and Secondary Lines |
Primary Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Note: Overall dolphin encounter rates (sightings per
100 km of survey effort) from all four surveys are conducted in May 2015 on
primary lines only as well as both primary lines and secondary lines in
Northeast and Northwest Lantau
Whilst
one (1) Limit Level exceedance was observed for the quarterly dolphin
monitoring data between March and May 2015.
No unacceptable impact from the construction activities of the TM-CLKL
Southern Connection Viaduct Section on Chinese White Dolphins was noticeable
from general observations during the dolphin monitoring in this reporting
month.
Due
to monthly variation in dolphin occurrence within the study area, it would be
more appropriate to draw conclusion on whether any impacts on dolphins have
been detected related to the construction activities of the TM-CLKL Southern
Connection Viaduct Section in the quarterly EM&A reports, where comparison
on distribution, group size and encounter rates of dolphins between the
quarterly impact monitoring period and baseline monitoring period will be made.
Daily
250 m marine mammal exclusion zone monitoring was undertaken during the period
of marine works activities being undertaken.
Passive Acoustic Monitoring (PAM) was implemented when the marine piling
works were carried out outside the daylight hours in this reporting month. No sighting of Indo-Pacific humpback dolphin Sousa chinensis
(i.e. Chinese White Dolphin) were recorded in May 2015 during the exclusion
zone monitoring.
Table 2.15 Specific Observations Identified during the Weekly Site
Inspections in this Reporting Month
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
8 May 2015 |
Area 1 ·
Some chemical containers were not placed in drip
tray. ·
Soil
stockpile near drainage was not well covered. Site Access
4A ·
Chemical waste storage was not secured properly. Pier D14B ·
Refuse was accumulated in drainage. Pier D10 ·
Checklist for wet sep was not displayed. |
Area 1 ·
Chemical containers should be placed in drip tray. ·
Soil
stockpile should be well covered. Site Access
4A ·
Chemical waste storage should be secured as appropriate. Pier D14B ·
Refuse in drainage should be cleaned up. Pier D10 ·
Checklist for wet sep should be displayed. |
13 May 2015 |
Seafront ·
Stagnant water was accumulated in drainage. ·
Stagnant
water was accumulated in a drip tray for generator. Gammon 39 (Pier
E1) ·
Excessive soil was accumulated on barge. |
Seafront ·
Stagnant water in drainage and drip tray should be
regularly cleaned up regularly. Gammon 39
(Pier E1) ·
Excessive soil on barge should be cleaned up
regularly. |
20 May 2015 |
Slope B/C8 ·
Tarpaulin sheet for rock drilling was not well
covered. Slope B/C9 ·
Tarpaulin sheet for cement loading station was not
well covered. |
Slope B/C8
& B/C9 ·
Tarpaulin sheet for rock drilling and cement loading
station should be well covered. |
28 May 2015 |
Pier E6 ·
Excessive soil was accumulated in gutter and the
gutter was not properly installed.. |
Pier E6 ·
Gutter should be cleaned up regularly and properly
installed. |
The
Contractor has rectified all of the observations identified during environmental
site inspections in the reporting month.
The
Contractor has submitted application form for registration as chemical waste
producer under the Contract. Sufficient
numbers of receptacles were available for general refuse collection and
sorting.
Wastes
generated during this reporting period include mainly construction wastes
(inert and non-inert), recyclable materials and marine sediment (Category
L). Reference has been made to the waste
flow table prepared by the Contractor (Appendix M). The quantities of different types of wastes
are summarized in Table 2.16.
Table 2.16 Quantities of Different Waste Generated in the Reporting Period
Month/Year |
Inert C&D Materials (a) (m3) |
Imported Fill (m3) |
Inert Construction Waste Re-used (m3) |
Non-inert Construction Waste (b) (kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
Category L |
Category M (Mp & Mf) |
|||||||
May 2015 |
8,091 |
0 |
653 |
107,920 |
42 |
0 |
550 |
0 |
Notes: |
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber, felled trees
and others. |
The
Contractor was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials
and wastes. The Contractor was also
reminded to properly maintain the site tidiness and dispose of the wastes accumulated
on site regularly and properly.
For
chemical waste containers, the Contractor was reminded to treat properly and
store temporarily in designated chemical waste storage area on site in
accordance with the Code of Practice on the Packaging, Labelling and Storage of
Chemical Wastes.
The
status of environmental licensing and permit is summarized in Table 2.17 below.
Table 2.17 Summary of Environmental Licensing and Permit Status
License/
Permit |
License
or Permit No. |
Date of Issue |
Date of Expiry |
License/
Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/D |
13 March 2015 |
N/A |
HyD |
Tuen Mun- Chek Lap
Kok Link |
Construction Dust Notification |
361571 |
5 Jul 2013 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17 Jul 2013 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong
Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Chemical Waste Registration |
5213-951-G2380-17 |
12 Jun 2014 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Construction Waste Disposal Account |
7017735 |
10 Jul 2013 |
N/A |
GCL |
- |
Construction
Waste Disposal Account |
7019470 |
3 Mar 2014 |
N/A |
GCL |
Vessel CHIT
Account |
Waste Water Discharge License |
WT00019017-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for land portion |
Construction Noise Permit |
Nil |
N/A |
N/A |
GCL |
For Piling Works |
Construction Noise Permit for night
works and works in general holidays |
GW-RW0093-15 |
26 Feb 2015 |
26 Aug 2015 |
GCL |
General works at WA5 |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0307-15 |
27 Mar 2015 |
27 Sep 2015 |
GCL |
For Load unload at NLH near Viaduct
D |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0470-14 |
29 Apr 2015 |
28 Oct 2015 |
GCL |
For Broad Permit |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0078-15 |
28 Jan 2015 |
29 Jul 2015 |
GCL |
For Plant mobilization using tractor
with trailer |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0326-15 |
30 Mar 2015 |
31 May 2015 |
GCL |
B9-B16 Pier Head Segments Erection |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0137-15 |
12 Feb 2015 |
15 Aug 2015 |
GCL |
Pre-casted pile cap shell
installation at E10-E13 |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0212-15 |
2 Mar 2015 |
4 Jun 2015 |
GCL |
Pier A8A9 Safety Fence Erection |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0491-15 |
8 May 2015 |
30 Jun 2015 |
GCL |
TTA Case 009 Ch.2.1E-4.2E |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0489-15 |
8 May 2015 |
7 Aug 2015 |
GCL |
B8 Pier Head Temp Works Lifting |
Marine Dumping Permit |
EP/MD/16-020 |
22 May 2015 |
26 Jun 2015 |
GCL |
For dumping Type I (Dedicated Site) and Type II sediment |
Marine Dumping Permit |
EP/MD/15-257 |
2 Apr 2015 |
7 Oct 2015 |
GCL |
For dumping
Type I sediment |
The landscape and visual (L&V) mitigation measures
were also monitored on weekly basis in the reporting period. The monitoring status is summarized in Appendix C.
One (1) Action level exceedance of depth-averaged SS
during mid-ebb tide was recorded on 19 May 2015 at monitoring station
SR4a. The exceedance was considered not
related to this Contract upon further investigation and the investigation
report is presented in Appendix N.
Whilst one (1) Limit Level exceedance was observed for
the quarterly dolphin monitoring data between March and May 2015. No unacceptable impact from the construction
activities of the TM-CLKL Southern Connection Viaduct Section on Chinese White
Dolphins was noticeable from general observations during the dolphin monitoring
in this reporting month.
Statistics
on complaints, notifications of summons, successful prosecutions are summarized
in Appendix N.
Marine
Works
·
Construction and installation of pile caps;
·
Marine piling platform installation &
uninstallation;
·
Pier construction;
·
Launching gantry and off-loading gantry assembly;
·
Marine piling and
·
Installation of pier head segment.
Land-based
Works
·
Construction and installation of pile caps;
·
Pier construction;
·
Drainage works;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Tree survey, felling and transplanting;
·
Relocation of MTRC fence; and
·
Slope work of Slopes 9SE-B/C9.
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of June 2015 are mainly associated with dust,
noise, marine water quality, marine ecology and waste management issues.
This
Nineteenth Monthly EM&A Report presents the findings of the EM&A
activities undertaken during the period from 1 to 31 May 2015, in accordance
with the Updated EM&A Manual and the requirements of the Environmental Permit (EP-354/2009/D).
No
Chinese White Dolphins were sighted during the two sets of monitoring surveys
in May 2015. Whilst one (1) Limit Level
exceedance was observed for the quarterly dolphin monitoring data between March
and May 2015, no unacceptable impact from the
construction activities of the TM-CLKL Southern Connection Viaduct Section on
Chinese White Dolphins was noticeable from general observations during the
dolphin monitoring in this reporting month.
The
ET will keep track on the construction works to confirm compliance of
environmental requirements and the proper implementation of all necessary
mitigation measures.
