Table of Contents
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Noise Monitoring
2.3 Water Quality Monitoring
2.4 Dolphin monitoring
2.5 EM&A Site inspection
2.6 Waste Management Status
2.7 Environmental Licenses and
Permits
2.8 Implementation Status of
Environmental Mitigation Measures
2.9 Summary of Exceedances of the
Environmental Quality Performance Limit
2.10 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Programme for
the Coming Months
3.2 Key Issues for the Coming
Month
3.3 Monitoring Schedule for the
Coming Month
4 Conclusions and recommendations
4.1 Conclusions
List of Appendices
Appendix A |
|
Appendix B |
|
Appendix C |
Implementation Schedule
of Environmental Mitigation Measures (EMIS) |
Appendix D |
|
Appendix E |
|
Appendix F |
|
Appendix G |
Impact Air Quality
Monitoring Results and Graphical Presentation |
Appendix H |
|
Appendix I |
|
Appendix K |
|
Appendix L |
|
Appendix M |
|
Appendix N |
Under Contract No.
HY/2012/07, Gammon Construction Limited (GCL) is
commissioned by the Highways Department (HyD) to
undertake the design and construction of the Southern Connection Viaduct
Section of the Tuen Mun ¡V Chek Lap Kok Link Project (TM-CLK
Link Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET). ENVIRON Hong Kong Ltd.
was employed by the HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO) in
accordance with Environmental Permit No. EP-354/2009/A. Further applications
for variation of environmental permit (VEP), EP-354/2009/B, EP-354/2009/C
and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The construction phase of the Contract commenced on 31
October 2013 and will tentatively be completed by 2018. The impact monitoring of the EM&A programme, including air quality, noise, water quality and
marine ecological monitoring as well as environmental site inspections,
commenced on 31 October 2013.
This is the Twentieth Monthly EM&A report
presenting the EM&A works carried out during the period from 1 to 30 June
2015 for the Southern Connection Viaduct Section in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, major activities in the reporting period included:
Marine
Works
¡P
Construction and installation of pile caps;
¡P
Uninstallation of marine piling platform;
¡P
Pile cap installation;
¡P
Pier construction;
¡P
Launching gantry assembly;
¡P
Marine piling and
¡P
Installation of pier head segment
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Pile cap installation;
¡P
Re-alignment of Cheung Tung Road;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Relocation of MTRC fence; and
¡P
Slope work of Slopes 9SE-B/C9 and 9SE-B/F85.
A summary
of monitoring and audit activities conducted in the reporting period is listed
below:
24-hour
TSP monitoring 6
sessions
1-hour
TSP monitoring 6
sessions
Noise
monitoring 6
sessions
Impact Water
Quality Monitoring 13
sessions
Impact Dolphin
Monitoring 2
sessions
Joint
Environmental site inspection 4
sessions
Breaches of Action and Limit Levels for Air Quality
No
exceedance of Action and Limit Levels was recorded for construction air
monitoring in the reporting month.
Breaches of Action and Limit Levels for Noise
No
exceedance of Action and Limit Levels was recorded for construction noise
monitoring in the reporting month.
Breaches of Action and Limit Levels for Water Quality
No
exceedance of Action and Limit Levels was recorded for water quality impact
monitoring in the reporting period.
Impact Dolphin Monitoring
During this month of dolphin
monitoring, no unacceptable impact from the construction activities of the
TM-CLKL Southern Connection Viaduct Section on Chinese White Dolphins was
noticeable from general observations.
Due to monthly variation in dolphin occurrence within the study area, it
would be more appropriate to draw conclusion on whether any impacts on dolphins
have been detected related to the construction activities of the TM-CLKL
Southern Connection Viaduct Section in the quarterly EM&A reports, where
comparison on distribution, group size and encounter rates of dolphins between
the quarterly impact monitoring period and baseline monitoring period will be
made.
Daily
marine mammal exclusion zone monitoring was undertaken during the period of
marine works under this Contract. No
Passive Acoustic Monitoring (PAM) was implemented as the marine works were not
carried out outside the daylight hours in this reporting month. No sighting of the Indo-Pacific humpback
dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was recorded in June 2015 during the exclusion
zone monitoring.
Environmental Complaints, Non-compliance & Summons
One
(1) environmental complaint regarding to dust emission from vehicles of this
Project was received on 18 June 2015.
Reporting Change
There was no reporting change in the reporting period.
Upcoming
Works for the Next Reporting Period
Works
to be undertaken in the next monitoring period of June 2015 include the
following:
Marine Works
¡P
Construction and installation of pile caps;
¡P
Uninstallation of marine piling platform;
¡P
Pile cap installation;
¡P
Pier construction;
¡P
Launching gantry assembly;
¡P
Marine piling and
¡P
Installation of pier head segment
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Pile cap installation;
¡P
Re-alignment of Cheung Tung Road;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Relocation of MTRC fence; and
¡P
Slope work of Slopes 9SE-B/C9 and 9SE-B/F85.
Future Key Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of July 2015 are mainly associated with dust,
noise, marine water quality, marine ecology and waste management issues.
According
to the findings of the Northwest New Territories (NWNT) Traffic and
Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be
operating beyond capacity after 2016.
This forecast has been based on the estimated increase in cross boundary
traffic, developments in the Northwest New Territories (NWNT), and possible
developments in North Lantau, including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong ¡V Zhuhai ¡V Macao Bridge (HZMB). In order to cope with the anticipated
traffic demand, two new road sections between NWNT and North Lantau ¡V Tuen Mun ¡V Chek
Lap Kok Link (TM-CLKL) and Tuen
Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The
EIA Report was submitted under the Environmental Impact Assessment Ordinance
(EIAO) in August 2009. Subsequent
to the approval of the EIA Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (EP-354/2009/A)
was issued on 8 December 2010.
Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of TM-CLKL (¡§the Contract¡¨) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM)
has been appointed as the Environmental Team (ET). ENVIRON Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of
environmental permit (VEP), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The
organization structure of the Contract is shown in Appendix A. The key personnel contact names and
contact details are summarized in Table
1.1 below.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD
(Highways Department) |
Project
Coordinator |
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior
Engineer |
Steven Shum |
2762 4133 |
3188 6614 |
SOR (AECOM Asia
Company Limited) |
Chief Resident
Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident
Engineer |
Kingman Chan |
3691 3950 |
3691 2899 |
ENPO / IEC (ENVIRON Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3547 2133 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3547 2134 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Marine
Works
¡P
Construction and installation of pile caps;
¡P
Uninstallation of marine piling platform;
¡P
Pile cap installation;
¡P
Pier construction;
¡P
Launching gantry assembly;
¡P
Marine piling and
¡P
Installation of pier head segment
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Pile cap installation;
¡P
Re-alignment of Cheung Tung Road;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Relocation of MTRC fence; and
¡P
Slope work of Slopes 9SE-B/C9 and 9SE-B/F85.

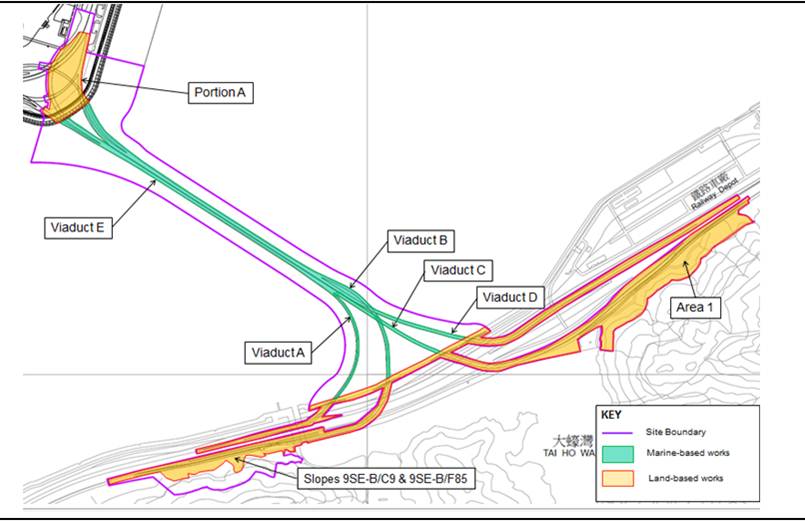

The locations
of the construction activities are shown in Figure 1.3.
The Environmental Sensitive Receivers in the vicinity of the Project are
shown in Figure 1.4.
The
EM&A programme required environmental monitoring for
air quality, noise, water quality and marine ecology as well as environmental
site inspections for air quality, noise, water quality, waste management,
marine ecology and landscape and visual impacts. The EM&A requirements and related
findings for each component are summarized in the following sections.
Table 2.1 Locations
of Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
Description |
Monitoring Dates |
ASR 9 |
MTR Depot |
On the
ground nearby MTR Depot Entrance |
2, 8, 11,
17, 23 and 29 June 2015 |
ASR 8A |
Area 4 |
On ground at
the works area, Area 4 |
2, 8, 11,
17, 23 and 29 June 2015 |
High Volume Samplers (HVSs) were used for carried
out 1-hour and 24-hour TSP monitoring on 2, 8, 11, 17,
23 and 29 June 2015 at ASR8A and ASR9 in
accordance with the requirements of the Updated EM&A Manual. The TSP monitoring stations are
illustrated in Figure 2.1 and detailed
in Table 2.1. Wind anemometer was deployed at Area 4
for logging wind speed and wind direction.
Copies of the calibration certificates for the
equipment are presented in Appendix E.
Details of the deployed equipment are given in Table 2.2.
Table 2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow
Controlled Total Suspended Particulate (TSP) High Volume
Sampler (Model No. TE-5170) |
Wind Sensor |
Global Water (Wind
Speed Sensor: WE550; Wind Direction Sensor: WE570) |
Wind Anemometer for
calibration |
Lutron (Model No.
AM-4201) |
Table 2.3 Summary
of 1-hour TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
59 |
41
- 95 |
394 |
500 |
ASR
9 |
71 |
48
- 119 |
393 |
500 |
Table 2.4 Summary
of 24-hour TSP Monitoring Results in the Reporting Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
45 |
42
¡V 47 |
178 |
260 |
ASR
9 |
47 |
45
¡V 49 |
178 |
260 |
All 1-hour and 24-hour TSP results were below the
Action and Limit levels at all monitoring locations in the reporting
period. No action is thus required
to be undertaken in accordance with the Event Action Plan presented in Appendix L.
Meteorological information collected at ASR8A including wind speed and wind
direction is provided in Appendix H.
Noise monitoring was performed on 2, 8, 11, 17, 23 and
29 June 2015 by using sound
level meter at the designated monitoring station NSR1A (Figure 2.2;
Table 2.5) in accordance with the requirements stipulated in the Updated
EM&A Manual. Acoustic
calibrator was deployed to check the sound level meters at a known sound
pressure level. Details of the
deployed equipment are provided in Table
2.6. Copies of the calibration
certificates for the equipment are presented in Appendix E.
Table 2.5 Location
of Impact Noise Monitoring Station
Monitoring Station |
Location |
Description |
Parameter |
Frequency and Duration |
Monitoring Dates |
NSR 1A |
Pak Mong Village Pavilion |
On the
ground at the village entrance |
30-minute
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. |
At least
once per week |
2, 8, 11,
17, 23 and 29 June 2015 |
Table 2.6 Noise
Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic Calibrator |
Rion
NC-73 |
Table 2.7 Summary
of Construction Noise Monitoring Results in the Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
|
NSR
1A |
59 |
58
- 60 |
75 |
|
Table 2.8 Locations
of Impact Water Quality Monitoring Stations and its Corresponding Monitoring
Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Frequency |
Depth |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact
Station (Close to HKBCF construction site) |
813273 |
818850 |
Temperature(¢XC)
pH (pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) ¡P
SS (mg/L) |
Impact monitoring: 3 days per week, at mid-flood and
mid-ebb tides during the construction period of the Contract |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed. If the water depth is less than 3m,
mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted |
IS(Mf)16 |
Impact Station
(Close to HKBCF construction site) |
814328 |
819497 |
|||
IS8 |
Impact Station
(Close to HKBCF construction site) |
814251 |
818412 |
|||
SR4 |
Sensitive receiver
(Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|||
*Notes: |
Table 2.9 Water
Quality Monitoring Equipment
Equipment |
Brand and Model |
DO and Salinity |
YSI Pro2030 |
Turbidity meter |
HACH Model 2100Q |
pH meter |
HANNA HI8314 |
Positioning
Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
No Action and Limit levels exceedances was recorded at
all monitoring stations for impact water quality monitoring in the reporting
month. No action is thus required
to be undertaken in accordance with the Event Action Plan presented in Appendix L.
Table
2.10 Dolphin
Monitoring Equipment
Equipment |
Model |
|
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom
lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and
reticules 65 foot single engine motor vessel with viewing platform 4.5m above water
level |
|
Table
2.11 Impact
Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
814577 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805475 |
815457 |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805477 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
819435 |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
819771 |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
820220 |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
820466 |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
820690 |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
820847 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
820892 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
820872 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818449 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
|
|
|
|
12 |
End
Point |
815542 |
824882 |
|
|
|
|
The Action and Limit levels of dolphin impact
monitoring are shown in Appendix D. The Event and Action plan is presented
in Appendix L.
A total of 301.30 km of
survey effort was collected, with 91.6% of the total survey effort being
conducted under favourable weather conditions (i.e. Beaufort Sea State 3 or
below with good visibility) during the surveys of June 2015. Among the two areas, 115.90 km and
185.40 km of survey effort were collected from NEL and NWL survey areas
respectively. The total survey
effort conducted on primary and secondary lines were 220.07 km and 81.23 km
respectively. The survey efforts
are summarized in Appendix K.
Three (3) groups of fifteen
(15) Chinese White Dolphins were sighted during the two sets of monitoring
surveys in June 2015. Two (2)
sightings were made in NWL, while one (1) sighting of a lone dolphin was made
in NEL. During surveys of June 2015,
all three (3) dolphin sightings were made on primary lines during on-effort
search, and none of the dolphin groups was associated with operating fishing
vessel. No sighting was made in the
proximity of the Project¡¦s alignment.
The distribution of dolphin sighting during the reporting month is shown
in Figure 2.5.
Encounter rates of Chinese White Dolphins are deduced
from the survey effort and on-effort sighting data made under favourable conditions (Beaufort 3 or below) in June 2015
are shown in Tables 2.12 & 2.13.
Table 2.12 Individual
Survey Event Encounter Rates
|
|
Encounter rate (STG) (no. of
on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per 100 km of survey
effort) |
Primary
Lines Only |
Primary
Lines Only |
||
NEL |
Set 1: June 2nd / 10th |
0.0 |
0.0 |
Set 2: June 24th / 26th |
2.6 |
2.6 |
|
NWL |
Set 1: June 2nd / 10th |
1.5 |
15.2 |
Set 2: June 24th / 26th |
1.6 |
6.4 |
|
Note: Dolphin Encounter Rates are deduced
from the two sets of surveys ( two surveys in each set) in June 2015 in
Northeast (NEL) and Northwest Lantau (NWL) |
Table 2.13 Monthly
Average Encounter Rates
|
Encounter rate (STG)
(no. of
on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per
100 km of survey effort) |
||
Primary Lines Only |
Both Primary and Secondary Lines |
Primary Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
1.3 |
0.9 |
1.3 |
0.9 |
Northwest Lantau |
1.6 |
1.2 |
10.9 |
8.7 |
Note: Overall dolphin encounter rates
(sightings per 100 km of survey effort) from all four surveys are conducted in
June 2015 on primary lines only as well as both primary lines and secondary
lines in Northeast and Northwest Lantau
No unacceptable impact from the construction
activities of the TM-CLKL Southern Connection Viaduct Section on Chinese White
Dolphins was noticeable from general observations during the dolphin monitoring
in this reporting month.
Due to monthly variation in dolphin occurrence within
the study area, it would be more appropriate to draw conclusion on whether any
impacts on dolphins have been detected related to the construction activities
of the TM-CLKL Southern Connection Viaduct Section in the quarterly EM&A
reports, where comparison on distribution, group size and encounter rates of
dolphins between the quarterly impact monitoring period and baseline monitoring
period will be made.
Daily
250 m marine mammal exclusion zone monitoring was undertaken during the period of
marine works activities being undertaken.
Passive Acoustic Monitoring (PAM) was not implemented as the marine
piling works were not carried out outside the daylight hours in this reporting
month. No sighting of Indo-Pacific
humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) were recorded in
June 2015 during the exclusion zone monitoring.
Table 2.14 Specific
Observations Identified during the Weekly Site Inspections in this Reporting
Month
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
2 June 2015 |
Pier E11 ¡P
Excessive soil was found in gutter. ¡P
Stagnant water
was accumulated in drip tray. Pier E6 ¡P
A label for sediment was missing on barge. Barge G39 ¡P
Some chemical containers were not placed in drip
tray. |
Pier E11 ¡P
Gutter should be cleaned up regularly. ¡P
Stagnant water
should be removed to avoid runoff. Pier E6 ¡P
Type of sediment should be properly labelled.. Barge G39 ¡P
Chemical containers should be placed in drip tray. |
10 June 2015 |
Area 1 ¡P
Refuse was found in drainage. ¡P
Some chemical containers were not placed in drip
tray . |
Area 1 ¡P
Refuse in drainage should be cleaned up. ¡P
Chemical containers should be placed in drip tray. |
17 June 2015 |
Pier E13 ¡P
The updated dumping permit was not displayed. ¡P
A generator was not placed on acoustic decoupling
pad. ¡P
A drip tray was not plugged. |
Pier E13 ¡P
The updated dumping permit should be displayed. ¡P
Generator on marine platform should be placed on
acoustic decoupling pad. ¡P
Drip tray should be plugged. |
25 June 2015 |
Site
Entrance 4A ¡P
Cover of a dump truck was damaged. ¡P
Excessive soil was found in drainage. ¡P
Chemical containers were not placed in drip tray. Barge G39 ¡P
Chemical containers were not placed in drip tray. |
Site
Entrance 4A ¡P
Cover of a dump truck should be able to effectively
cover dusty material. ¡P
Soil in drainage should be cleaned up. Bund or
sandbag should be provided to avoid soil runoff into drainage. ¡P
Chemical containers should be placed in drip tray. Barge G39 ¡P
Chemical containers should be placed in drip tray. |
The
Contractor has rectified all of the observations identified during
environmental site inspections in the reporting month.
The
Contractor has submitted application form for registration as chemical waste
producer under the Contract.
Sufficient numbers of receptacles were available for general refuse
collection and sorting.
Wastes
generated during this reporting period include mainly construction wastes
(inert and non-inert), recyclable materials, chemical wastes and marine
sediment (Categories M and L).
Reference has been made to the waste flow table prepared by the
Contractor (Appendix M). The quantities of different types of
wastes are summarized in Table 2.15.
Table 2.15 Quantities
of Different Waste Generated in the Reporting Period
Month/Year |
Inert C&D Materials (a) (m3) |
Imported Fill (m3) |
Inert Construction Waste Re-used (m3) |
Non-inert Construction Waste (b) (kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
Category L |
Category M (Mp & Mf) |
|||||||
June 2015 |
7,166 |
0 |
1,144 |
89,930 |
119 |
17 |
324 |
287 |
Notes: |
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber, felled trees
and others. |
The
Contractor was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials and
wastes. The Contractor was also
reminded to properly maintain the site tidiness and dispose of the wastes
accumulated on site regularly and properly.
For
chemical waste containers, the Contractor was reminded to treat properly and
store temporarily in designated chemical waste storage area on site in
accordance with the Code of Practice on the Packaging, Labelling and Storage of
Chemical Wastes.
The
status of environmental licensing and permit is summarized in Table 2.16 below.
Table 2.16 Summary
of Environmental Licensing and Permit Status
License/
Permit |
License
or Permit No. |
Date of Issue |
Date of Expiry |
License/
Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/D |
13 March 2015 |
N/A |
HyD |
Tuen Mun- Chek
Lap Kok Link |
Construction Dust Notification |
361571 |
5 Jul 2013 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17 Jul 2013 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong
Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Chemical Waste Registration |
5213-951-G2380-17 |
12 Jun 2014 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Construction Waste Disposal Account |
7017735 |
10 Jul 2013 |
N/A |
GCL |
- |
Construction Waste Disposal Account |
7019470 |
3 Mar 2014 |
N/A |
GCL |
Vessel CHIT Account |
Waste Water Discharge License |
WT00019017-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for land portion |
Construction
Noise Permit |
Nil |
N/A |
N/A |
GCL |
For Piling Works |
Construction
Noise Permit for night works and works in general holidays |
GW-RW0093-15 |
26 Feb 2015 |
26 Aug 2015 |
GCL |
General
works at WA5 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0307-15 |
27 Mar 2015 |
27 Sep 2015 |
GCL |
For
Load unload at NLH near Viaduct D |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0691-15 |
23 Jun 2015 |
22 Dec 2015 |
GCL |
For
Broad Permit |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0078-15 |
28 Jan 2015 |
29 Jul 2015 |
GCL |
For
Plant mobilization using tractor with trailer |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0539-15 |
14 May 2015 |
31 Jul 2015 |
GCL |
B9-B16
Pier Head Segments Erection |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0137-15 |
12 Feb 2015 |
15 Aug 2015 |
GCL |
Pre-casted
pile cap shell installation at E10-E13 |
Construction
Noise Permit for night works and works in general holidays |
GW-RW0695-15 |
30 Jun 2015 |
30 Nov 2015 |
GCL |
Segment
Erection between B6-B11 by LG1 |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0491-15 |
8 May 2015 |
30 Jun 2015 |
GCL |
TTA
Case 009 Ch.2.1E-4.2E |
Construction
Noise Permit for night works and works in general holidays |
GW-RS0489-15 |
8 May 2015 |
7 Aug 2015 |
GCL |
B8
Pier Head Temp Works Lifting |
Marine
Dumping Permit |
EP/MD/16-020 |
22 May 2015 |
26 Jun 2015 |
GCL |
For dumping Type I (Dedicated Site) and Type II sediment |
Marine
Dumping Permit |
EP/MD/15-257 |
2 Apr 2015 |
7 Oct 2015 |
GCL |
For dumping Type I sediment |
The landscape and visual (L&V) mitigation measures
were also monitored on weekly basis in the reporting period. The monitoring status is summarized in Appendix C.
Statistics
on complaints, notifications of summons, successful prosecutions are summarized
in Appendix N.
Marine
Works
¡P
Construction and installation of pile caps;
¡P
Uninstallation of marine piling platform;
¡P
Pile cap installation;
¡P
Pier construction;
¡P
Launching gantry assembly;
¡P
Marine piling and
¡P
Installation of pier head segment
Land-based
Works
¡P
Construction and installation of pile caps;
¡P
Pier construction;
¡P
Pile cap installation;
¡P
Re-alignment of Cheung Tung Road;
¡P
Land piling;
¡P
Pre-drilling works;
¡P
Installation of pier head segment;
¡P
Additional land GI, trial pits & lab testing;
¡P
Relocation of MTRC fence; and
¡P
Slope work of Slopes 9SE-B/C9 and 9SE-B/F85.
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of July 2015 are mainly associated with dust,
noise, marine water quality, marine ecology and waste management issues.
This
Twentieth Monthly EM&A Report presents the findings of the EM&A
activities undertaken during the period from 1 to 30 June 2015, in accordance
with the Updated EM&A Manual and the requirements of the Environmental Permit (EP-354/2009/D).
Three
(3) groups of fifteen (15) Chinese White Dolphins were sighted during the two
sets of monitoring surveys in June 2015.
Two (2) sightings were made in NWL, while one (1) sighting of a lone
dolphin was made in NEL. During
surveys of June 2015, all three (3) dolphin sightings were made on primary
lines during on-effort search, and none of the dolphin groups was associated
with operating fishing vessel. No
sighting was made in the proximity of the Project¡¦s alignment. During this month of dolphin monitoring, no
unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Chinese White Dolphins was noticeable from
general observations.
The
ET will keep track on the construction works to confirm compliance of
environmental requirements and the proper implementation of all necessary
mitigation measures.
