Table of Contents
1.1 Background
1.2 Scope
of Report
1.3 Organization
Structure
1.4 Summary
of Construction Works
2.1 Air
quality
2.2 Noise
Monitoring
2.3 Water
Quality Monitoring
2.4 Dolphin
monitoring
2.5 EM&A
Site inspection
2.6 Waste
Management Status
2.7 Environmental
Licenses and Permits
2.8 Implementation
Status of Environmental Mitigation Measures
2.9 Summary
of Exceedances of the Environmental Quality Performance Limit
2.10 Summary
of Complaints, Notification of Summons and Successful Prosecutions
3.1 Construction
Programme for the Coming Months
3.2 Key
Issues for the Coming Month
3.3 Monitoring
Schedule for the Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
List
of Appendices
Appendix A |
|
Appendix B |
|
Appendix C |
Implementation Schedule of Environmental Mitigation
Measures (EMIS) |
Appendix D |
|
Appendix E |
|
Appendix F |
|
Appendix G |
Impact Air Quality Monitoring Results and Graphical
Presentation |
Appendix H |
|
Appendix I |
|
Appendix J |
Impact Water Quality Monitoring Results and
Graphical Presentation |
Appendix K |
|
Appendix L |
|
Appendix M |
|
Appendix N |
Under Contract
No.
HY/2012/07, Gammon Construction
Limited (GCL) is commissioned by the Highways Department (HyD)
to undertake the design and construction of the Southern Connection Viaduct
Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK
Link Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET). Ramboll
Environ Hong Kong Ltd. was employed by the HyD as the
Independent Environmental Checker (IEC) and Environmental Project Office (ENPO)
in accordance with Environmental Permit
No. EP-354/2009/A.
Further applications
for variation of environmental permit (VEP), EP-354/2009/B, EP-354/2009/C
and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The
construction phase of the Contract commenced on 31 October 2013 and will
tentatively be completed by 2018. The
impact monitoring of the EM&A programme,
including air quality, noise, water quality and marine ecological monitoring as
well as environmental site inspections, commenced on 31 October 2013.
This
is the Twenty-first Monthly EM&A report presenting the EM&A works
carried out during the period from 1 to 31 July 2015 for the Southern
Connection Viaduct Section in accordance with the Updated EM&A Manual of the
TM-CLK Link Project. As informed by the Contractor, major
activities in the reporting period included:
Marine Works
·
Construction and installation of pile caps;
·
Uninstallation of marine piling platform;
·
Pile cap installation;
·
Pier construction;
·
Launching gantry assembly;
·
Marine piling; and,
·
Installation of pier head segment.
Land-based
Works
·
Predrilling at Viaduct F;
·
Construction and installation of pile caps;
·
Pier construction;
·
Pile cap installation;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Relocation of MTRC fence; and,
·
Slope work of Viaducts A
& B.
A
summary of monitoring and audit activities conducted in the reporting period is
listed below:
24-hour
TSP monitoring 6
sessions
1-hour
TSP monitoring 6 sessions
Noise monitoring 6 sessions
Impact Water Quality Monitoring 12 sessions
Impact
Dolphin Monitoring 2 sessions
Joint Environmental site
inspection 5 sessions
Breaches of Action and Limit Levels for Air Quality
No
exceedance of Action and Limit Levels was recorded for construction air monitoring
in the reporting month.
Breaches of Action and Limit Levels for Noise
No
exceedance of Action and Limit Levels was recorded for construction noise monitoring
in the reporting month.
Breaches of Action and Limit Levels for Water Quality
No
exceedance of Action and Limit Levels was recorded for water quality impact
monitoring in the reporting period.
Impact Dolphin Monitoring
During this month of
dolphin monitoring, no unacceptable impact from the construction activities of
the TM-CLKL Southern Connection Viaduct Section on Chinese White Dolphins was
noticeable from general observations.
Due to monthly variation in dolphin occurrence within the study area, it
would be more appropriate to draw conclusion on whether any impacts on dolphins
have been detected related to the construction activities of the TM-CLKL
Southern Connection Viaduct Section in the quarterly EM&A reports, where
comparison on distribution, group size and encounter rates of dolphins between
the quarterly impact monitoring period and baseline monitoring period will be
made.
Daily
marine mammal exclusion zone monitoring was undertaken during the period of
marine works under this Contract. No
Passive Acoustic Monitoring (PAM) was implemented as the marine works were not
carried out outside the daylight hours in this reporting month. No sighting of the Indo-Pacific humpback
dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was recorded in July 2015 during the exclusion
zone monitoring.
Environmental Complaints, Non-compliance & Summons
There
was no environmental complaint, notification of summons or successful
prosecution recorded in the reporting period.
Reporting Change
There was no reporting change in the reporting period.
Upcoming
Works for the Next Reporting Period
Works
to be undertaken in the next monitoring period of August 2015 include the
following:
Marine Works
·
Construction and installation of pile caps;
·
Uninstallation of marine piling platform;
·
Pile cap installation;
·
Pier construction;
·
Launching gantry assembly;
·
Marine piling and
·
Installation of pier head segment
Land-based
Works
·
Predrilling at Viaduct F;
·
Construction and installation of pile caps;
·
Pier construction;
·
Pile cap installation;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Relocation of MTRC fence; and
·
Slope work of Viaducts A
& B.
Future Key Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of August 2015 are mainly associated with dust, noise,
marine water quality, marine ecology and waste management issues.
According
to the findings of the Northwest New Territories (NWNT) Traffic and
Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be
operating beyond capacity after 2016.
This forecast has been based on the estimated increase in cross boundary
traffic, developments in the Northwest New Territories (NWNT), and possible
developments in North Lantau, including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic
demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek
Lap Kok Link (TM-CLKL) and Tuen
Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The EIA
Report was submitted under the Environmental Impact Assessment Ordinance (EIAO)
in August 2009. Subsequent to the
approval of the EIA Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (EP-354/2009/A)
was issued on 8 December 2010.
Under Contract
No.
HY/2012/07, Gammon Construction
Limited (GCL) is commissioned by the Highways Department (HyD)
to undertake the design and construction of the Southern Connection Viaduct
Section of TM-CLKL (“the Contract”) while AECOM Asia
Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). Ramboll Environ Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of
environmental permit (VEP), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The
organization structure of the Contract is shown in Appendix A.
The key personnel contact names and
contact details are summarized in Table
1.1 below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
HyD
(Highways Department) |
Project
Coordinator |
Stanley Chan |
2762 3406 |
3188 6614 |
|
Senior
Engineer |
Steven Shum |
2762 4133 |
3188 6614 |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident
Engineer |
Kingman Chan |
3691 3950 |
3691 2899 |
ENPO / IEC (Ramboll Environ Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3547 2133 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3547 2134 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy
Tam |
2271 3113 |
2723 5660 |
Marine
Works
·
Construction and installation of pile caps;
·
Uninstallation of marine piling platform;
·
Pile cap installation;
·
Pier construction;
·
Launching gantry assembly;
·
Marine piling and
·
Installation of pier head segment
Land-based
Works
·
Predrilling at Viaduct F;
·
Construction and installation of pile caps;
·
Pier construction;
·
Pile cap installation;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Relocation of MTRC fence; and
·
Slope work of Viaducts A
& B.
The locations

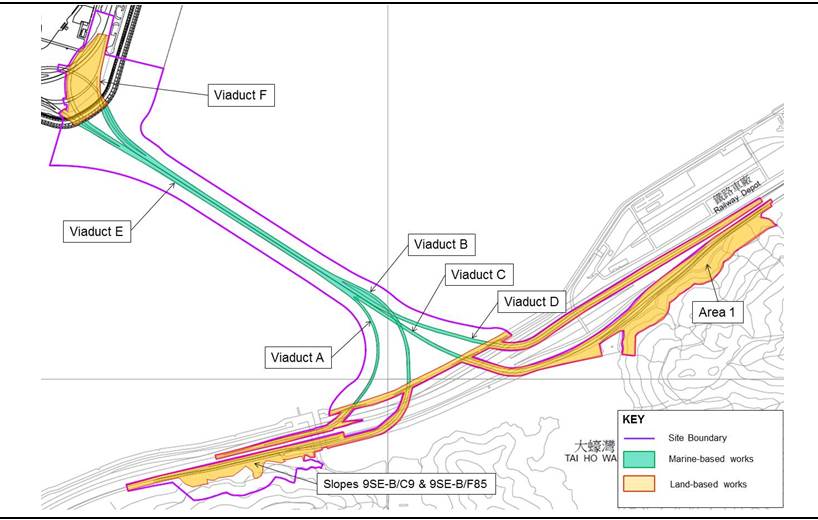

of the construction activities are shown in Figure 1.3. The
Environmental Sensitive Receivers in the vicinity of the Project are shown in Figure 1.4.
The
EM&A programme required environmental monitoring
for air quality, noise, water quality and marine ecology as well as
environmental site inspections for air quality, noise, water quality, waste
management, marine ecology and landscape and visual impacts. The EM&A requirements and related
findings for each component are summarized in the following sections.
Table 2.1 Locations of Impact Air Quality Monitoring Stations
Monitoring Station |
Location |
Description |
Monitoring Dates |
ASR 9 |
MTR Depot |
On the
ground nearby MTR Depot Entrance |
2, 7, 13, 16,
22 and 28 July 2015 |
ASR 8A |
Area 4 |
On ground at
the works area, Area 4 |
2, 7, 13,
16, 22 and 28 July 2015 |
High Volume Samplers (HVSs) were used for carried
out 1-hour and 24-hour TSP monitoring on 2, 7, 13, 16,
22 and 28 July 2015 at ASR8A and ASR9 in
accordance with the requirements of the Updated EM&A Manual. The TSP monitoring stations are illustrated in
Figure 2.1 and detailed in Table 2.1. Wind anemometer
was deployed at Area 4 for logging wind speed and wind direction. Copies of the calibration
certificates for the equipment are presented in Appendix E. Details of
the deployed equipment are given in Table
2.2.
Table 2.2 Air Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume
Sampler |
Tisch Environmental Mass Flow
Controlled Total Suspended Particulate (TSP) High
Volume Sampler (Model No. TE-5170) |
Wind Sensor |
Global Water (Wind
Speed Sensor: WE550; Wind Direction Sensor: WE570) |
Wind
Anemometer for calibration |
Lutron (Model
No. AM-4201) |
Table 2.3 Summary of 1-hour TSP Monitoring Results in the Reporting
Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
63 |
41
- 139 |
394 |
500 |
ASR
9 |
73 |
41
- 116 |
393 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in the Reporting
Period
Monitoring Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR
8A |
51 |
44
– 75 |
178 |
260 |
ASR
9 |
56 |
47
– 89 |
178 |
260 |
All 1-hour and 24-hour TSP results were below
the Action and Limit levels at all monitoring locations in the reporting period.
No action is thus required to be
undertaken in accordance with the Event Action Plan presented in Appendix L.
Meteorological information collected at ASR8A including wind speed and wind
direction is provided in Appendix H.
Noise monitoring was performed on 2, 7, 13, 16, 22 and
28 July 2015 by using sound
level meter at the designated monitoring station NSR1A (Figure 2.2;
Table 2.5) in accordance with the requirements stipulated in the Updated
EM&A Manual. Acoustic calibrator was
deployed to check the sound level meters at a known sound pressure level. Details of the deployed equipment are provided
in Table 2.6. Copies of the calibration certificates for the
equipment are presented in Appendix E.
Table 2.5 Location of Impact Noise Monitoring Station
Monitoring Station |
Location |
Description |
Parameter |
Frequency and Duration |
Monitoring Dates |
NSR 1A |
Pak Mong Village Pavilion |
On the
ground at the village entrance |
30-minute
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. |
At least
once per week |
2, 7, 13,
16, 22 and 28 July 2015 |
Table 2.6 Noise Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic
Calibrator |
Rion
NC-73 |
Table 2.7 Summary of Construction Noise Monitoring Results in the
Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
|
NSR
1A |
60 |
53
- 61 |
75 |
|
Table 2.8 Locations of Impact Water Quality Monitoring Stations and its
Corresponding Monitoring Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Frequency |
Depth |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact
Station (Close to HKBCF construction site) |
813273 |
818850 |
Temperature(°C)
pH (pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) · SS (mg/L) |
Impact monitoring: 3 days per week, at mid-flood
and mid-ebb tides during the construction period of the Contract |
3 water depths:
1m below sea
surface, mid-depth and 1m above sea bed. If the water depth is less than 3m,
mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted |
IS(Mf)16 |
Impact
Station (Close to HKBCF construction site) |
814328 |
819497 |
|||
IS8 |
Impact
Station (Close to HKBCF construction site) |
814251 |
818412 |
|||
SR4 |
Sensitive
receiver (Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive
receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|||
*Notes: |
Table 2.9 Water Quality Monitoring Equipment
Equipment |
Brand and Model
|
DO and Salinity |
YSI Pro2030 |
Turbidity meter |
HACH Model 2100Q |
pH meter |
HANNA HI8314 |
Positioning
Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
The SS level at IS8 during mid-ebb tide on 25 July
2015 was higher than the corresponding Action Level but not higher than 120% of
the upstream control station at the same tide on same day. Thus the result was not regarded as an
exceedance.
No Action and Limit levels exceedances was recorded at
all monitoring stations for impact water quality monitoring in the reporting
month. No action is thus required to be
undertaken in accordance with the Event Action Plan presented in Appendix L.
Table
2.10 Dolphin Monitoring Equipment
Equipment |
Model |
|
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for
Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m
zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and
reticules 65 foot single engine motor vessel with viewing platform 4.5m above
water level |
|
Table
2.11 Impact Dolphin Monitoring Line Transect
Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
814577 |
13 |
Start
Point |
816506 |
819480 |
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
2 |
Start
Point |
805475 |
815457 |
14 |
Start
Point |
817537 |
820220 |
2 |
End Point |
805477 |
826654 |
14 |
End Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
819435 |
15 |
Start
Point |
818568 |
820735 |
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
819771 |
16 |
Start
Point |
819532 |
821420 |
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
820220 |
17 |
Start
Point |
820451 |
822125 |
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
820466 |
18 |
Start
Point |
821504 |
822371 |
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
820690 |
19 |
Start
Point |
822513 |
823268 |
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
820847 |
20 |
Start
Point |
823477 |
823402 |
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
820892 |
21 |
Start
Point |
805476 |
827081 |
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
820872 |
22 |
Start
Point |
806464 |
824033 |
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818449 |
23 |
Start
Point |
814559 |
821739 |
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
|
|
|
|
12 |
End Point |
815542 |
824882 |
|
|
|
|
The
Action and Limit levels of dolphin impact monitoring are shown in Appendix D. The
Event and Action plan is presented in Appendix L.
A total of 301.62 km of survey effort was collected,
with 87.2% of the total survey effort being conducted under favourable weather
conditions (i.e. Beaufort Sea State 3 or below with good visibility) during the
surveys of July 2015. Among the two
areas, 116.10 km and 185.52 km of survey effort were collected from NEL and NWL
survey areas respectively. The total
survey effort conducted on primary and secondary lines were 219.76 km and 81.86
km respectively. The survey efforts are
summarized in Appendix K.
Three (3) groups of six (6) Chinese White Dolphins
were sighted during the two sets of monitoring surveys in July 2015. All three (3) sightings were made in NWL, while no dolphin was sighted in NEL. During surveys
of July 2015, all three (3) dolphin sightings were made on primary lines during
on-effort search, and none of the dolphin groups was associated with operating fishing
vessel. No sighting was made in the
proximity of the Project’s alignment.
The distribution of dolphin sighting during the reporting month is shown
in Figure 2.5.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable
conditions (Beaufort 3 or below) in July 2015 are shown in Tables 2.12 & 2.13.
Table 2.12 Individual Survey Event Encounter Rates
|
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km
of survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: July 2nd / 7th |
0.0 |
0.0 |
Set 2: July 22nd / 27th |
0.0 |
0.0 |
|
NWL |
Set 1: July 2nd / 7th |
1.7 |
3.4 |
Set 2: July 22nd / 27th |
3.5 |
6.9 |
|
Note: Dolphin Encounter Rates are deduced from
the two sets of surveys ( two surveys in each set) in July 2015 in Northeast
(NEL) and Northwest Lantau (NWL) |
Table 2.13 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
||
Primary Lines Only |
Both Primary and Secondary Lines |
Primary Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
2.6 |
2.0 |
5.1 |
4.1 |
Note: Overall dolphin encounter rates (sightings
per 100 km of survey effort) from all four surveys are conducted in July 2015
on primary lines only as well as both primary lines and secondary lines in
Northeast and Northwest Lantau
No
unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Chinese White Dolphins was noticeable from
general observations during the dolphin monitoring in this reporting month.
Due
to monthly variation in dolphin occurrence within the study area, it would be
more appropriate to draw conclusion on whether any impacts on dolphins have
been detected related to the construction activities of the TM-CLKL Southern
Connection Viaduct Section in the quarterly EM&A reports, where comparison
on distribution, group size and encounter rates of dolphins between the
quarterly impact monitoring period and baseline monitoring period will be made.
Daily
250 m marine mammal exclusion zone monitoring was undertaken during the period
of marine works activities being undertaken. Passive Acoustic Monitoring (PAM) was not implemented
as the marine piling works were not carried out outside the daylight hours in
this reporting month. No sighting of
Indo-Pacific humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) were recorded in
July 2015 during the exclusion zone monitoring.
Table 2.14 Specific Observations Identified during the Weekly Site
Inspections in this Reporting Month
Inspection Date |
Environmental Observations |
Recommendations/ Remarks |
2 July 2015 |
Area 1 Chemical
containers were not placed in drip tray. Refuse
was found in drainage. Area 2 EP was not displayed. |
Area 1 Chemical
containers should be placed in drip tray. Refuse
in drainage should be cleaned up regularly. Area 2 EP should be displayed. |
9 July 2015 |
Pier A2 Gutter
was not properly installed. Seafront A
drip tray was not plugged. A power pack was not placed in drip tray. Checklist for a wet sep was not displayed. |
Pier A2 Gutter
should be properly installed. Seafront Drip
tray should be plugged. Power pack should be placed in drip tray. Checklist for wet sep should be displayed. |
14 July 2015 |
Area 1 The
ground was partially dry. Some
chemical containers were not placed in drip tray. The
old EP was displayed. Site Access
4A A
drip tray for air compressor contained stagnant water. Pier D12 A Stagnant
water was accumulated in drip tray. Pier D10 The
ground was partially dry. Some
chemical containers were not placed in drip tray. |
Area 1 Unpaved
area should be watered to avoid dust emission. Chemical
containers should be placed in drip tray. The
old EP was removed immediately. Site Access
4A Stagnant
water in drip tray should be removed to avoid overflow. Pier D12 A Stagnant
water in drip tray should be removed to avoid overflow. Pier D10 Unpaved
area should be watered to avoid dust emission. Chemical
containers should be placed in drip tray. |
22 July 2015 |
Slope B/F8 Oil
stain was found in drainage. Chemical
containers were not placed in drip tray. Slope B/C9 Chemical
containers of Aqua Sed were not labelled. Seafront Chemical
containers were not placed in drip tray. |
Slope B/F8 Oil
stain in drainage should be removed. Chemical
containers should be placed in drip tray. Slope B/C9 Chemical
containers should be labelled. Seafront Chemical
containers should be placed in drip tray. |
30 July 2015 |
Pier D5 A
drip tray for generator was not plugged. A
decoupling mat was damaged. A
part of gutter was damaged. Barge Kiu Lik (next to Pier A7) A
drip tray for generator was not plugged. Some
chemical containers were not placed in drip tray. Pier E12 A
generator was not placed on acoustic decoupling mat. |
Pier D5 Drip
tray for generator should be plugged. Damaged
decoupling mat should be replaced by new decoupling mat. Damaged
gutter should be repaired to avoid runoff. Barge Kiu Lik (next to Pier A7) Drip
tray for generator should be plugged. Chemical
containers should be placed in drip tray. Pier E12 Generator
should be placed on acoustic decoupling mat. |
The
Contractor has rectified all of the observations identified during environmental
site inspections in the reporting month.
The
Contractor has submitted application form for registration as chemical waste
producer under the Contract. Sufficient
numbers of receptacles were available for general refuse collection and
sorting.
Wastes
generated during this reporting period include mainly construction wastes
(inert and non-inert), imported fill, recyclable materials and chemical wastes. Reference has been made to the waste flow
table prepared by the Contractor (Appendix M). The quantities of different types of wastes
are summarized in Table 2.15.
Table 2.15 Quantities of Different Waste Generated in the Reporting Period
Month/Year |
Inert C&D Materials (a) (m3) |
Imported Fill (m3) |
Inert Construction Waste Re-used (m3) |
Non-inert Construction Waste (b) (kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
Category L |
Category M (Mp & Mf) |
|||||||
July 2015 |
2,322 |
78 |
992 |
111,570 |
105 |
1,400 |
0 |
0 |
Notes: |
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber, felled trees and
others. |
The
Contractor was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and wastes
at designated ground and maximize reuse/ recycle of C&D materials and
wastes. The Contractor was also reminded
to properly maintain the site tidiness and dispose of the wastes accumulated on
site regularly and properly.
For
chemical waste containers, the Contractor was reminded to treat properly and
store temporarily in designated chemical waste storage area on site in
accordance with the Code of Practice on the Packaging, Labelling and Storage of
Chemical Wastes.
The
status of environmental licensing and permit is summarized in Table 2.16 below.
Table 2.16 Summary of Environmental Licensing and Permit Status
License/
Permit |
License
or Permit No. |
Date of Issue |
Date of Expiry |
License/
Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/D |
13 March 2015 |
N/A |
HyD |
Tuen Mun- Chek
Lap Kok Link |
Construction Dust Notification |
361571 |
5 Jul 2013 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17 Jul 2013 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong
Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov 2013 |
N/A |
GCL |
Chemical waste produced in Contract HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Chemical Waste Registration |
5213-951-G2380-17 |
12 Jun 2014 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Construction Waste Disposal Account |
7017735 |
10 Jul 2013 |
N/A |
GCL |
- |
Construction
Waste Disposal Account |
7019470 |
3 Mar 2014 |
N/A |
GCL |
Vessel CHIT
Account |
Waste Water Discharge License |
WT00019017-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for land portion |
Construction Noise Permit |
Nil |
N/A |
N/A |
GCL |
For Piling Works |
Construction Noise Permit for night
works and works in general holidays |
GW-RW0093-15 |
26 Feb 2015 |
26 Aug 2015 |
GCL |
General works at WA5 |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0307-15 |
27 Mar 2015 |
27 Sep 2015 |
GCL |
For Load unload at NLH near Viaduct
D |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0691-15 |
23 Jun 2015 |
22 Dec 2015 |
GCL |
For Broad Permit |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0078-15 |
28 Jan 2015 |
29 Jul 2015 |
GCL |
For Plant mobilization using tractor
with trailer |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0539-15 |
14 May 2015 |
31 Jul 2015 |
GCL |
B9-B16 Pier Head Segments Erection |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0137-15 |
12 Feb 2015 |
15 Aug 2015 |
GCL |
Pre-casted pile cap shell
installation at E10-E13 |
Construction Noise Permit for night
works and works in general holidays |
GW-RW0695-15 |
30 Jun 2015 |
30 Nov 2015 |
GCL |
Segment Erection between B6-B11 by
LG1 |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0769-15 |
15 Jul 2015 |
30 Sep 2015 |
GCL |
TTA Case 009 Ch.2.1E-4.2E |
Construction Noise Permit for night
works and works in general holidays |
GW-RS0489-15 |
8 May 2015 |
7 Aug 2015 |
GCL |
B8 Pier Head Temp Works Lifting |
Marine Dumping Permit |
EP/MD/16-049 |
22 Jul 2015 |
26 Aug 2015 |
GCL |
For dumping Type I (Dedicated Site) and Type II sediment |
Marine Dumping Permit |
EP/MD/15-257 |
2 Apr 2015 |
7 Oct 2015 |
GCL |
For dumping
Type I sediment |
The landscape and visual (L&V) mitigation measures
were also monitored on weekly basis in the reporting period. The monitoring status is summarized in Appendix C.
There
was no environmental complaint, notification of summons or successful
prosecution recorded in the reporting period.
Statistics
on complaints, notifications of summons, successful prosecutions are summarized
in Appendix N.
Marine Works
·
Construction and installation of pile caps;
·
Uninstallation of marine piling platform;
·
Pile cap installation;
·
Pier construction;
·
Launching gantry assembly;
·
Marine piling and
·
Installation of pier head segment
Land-based
Works
·
Predrilling at Viaduct F;
·
Construction and installation of pile caps;
·
Pier construction;
·
Pile cap installation;
·
Re-alignment of Cheung Tung Road;
·
Land piling;
·
Pre-drilling works;
·
Installation of pier head segment;
·
Additional land GI, trial pits & lab testing;
·
Relocation of MTRC fence; and
·
Slope work of Viaducts A
& B.
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of August 2015 are mainly associated with dust, noise,
marine water quality, marine ecology and waste management issues.
This
Twenty-first Monthly EM&A Report presents the findings of the EM&A
activities undertaken during the period from 1 to 31 July 2015, in accordance
with the Updated EM&A Manual and the requirements of the Environmental Permit (EP-354/2009/D).
Three
(3) groups of six (6) Chinese White Dolphins were sighted during the two sets of
monitoring surveys in July 2015. All
three (3) sightings were made in NWL, while no dolphin was
sighted in NEL. During surveys of July 2015, all three (3) dolphin
sightings were made on primary lines during on-effort search, and none of the
dolphin groups was associated with operating fishing vessel. No sighting was made in the proximity of the
Project’s alignment. During this month of dolphin monitoring, no
unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Chinese White Dolphins was noticeable from
general observations.
There
was no environmental complaint, notification of summons or successful
prosecution recorded in the reporting period.
The
ET will keep track on the construction works to confirm compliance of
environmental requirements and the proper implementation of all necessary
mitigation measures.
