1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
1.5 Summary of EM&A Programme
Requirements
2.1 Air Quality
2.2 Noise Monitoring
2.3 Water Quality Monitoring
2.4 Dolphin Monitoring
2.5 Bored Piling Monitoring
2.6 Post Translocation Coral
Monitoring
2.7 EM&A Site Inspection
2.8 Waste Management Status
2.9 Environmental Licenses and
Permits
2.10 Implementation Status of
Environmental Mitigation Measures
2.11 Summary of Exceedances of the
Environmental Quality Performance Limit
2.12 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Activities for
the Coming Quarter
3.2 Key Issues for the Coming
Quarter
3.3 Monitoring Schedule for the
Coming Quarter
4 Conclusions and recommendations
4.1 Conclusions
List of Appendices
Appendix A |
|
Appendix B |
|
Appendix C |
Implementation Schedule
of Environmental Mitigation Measures (EMIS) |
Appendix D |
|
Appendix E |
|
Appendix F |
Impact Air Quality
Monitoring Results and Graphical Presentation |
Appendix G |
|
Appendix H |
Impact Water Quality
Monitoring Results and Graphical Presentation |
Appendix I |
|
Appendix J |
|
Appendix K |
|
Appendix L |
Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Southern
Connection Viaduct Section of the Tuen Mun ¡V Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON
Hong Kong Ltd. was employed by the HyD as the
Independent Environmental Checker (IEC) and Environmental Project Office (ENPO)
in accordance with Environmental Permit
No. EP-354/2009/A.
Another application for variation of
environmental permit (VEP) (EP-354/2009/B)
was granted on 28 January 2014.
The
construction phase of the Contract commenced on 31 October 2013 and will be
tentatively be completed by 2018.
The impact monitoring of the EM&A programme, including air quality,
noise, water quality and marine ecological monitoring as well as environmental
site inspections, commenced on 31 October 2013.
This
is the second quarterly EM&A report presenting the EM&A works carried
out during the period from 1 March 2014 to 31 May 2014 for the Southern
Connection Viaduct Section in accordance with the Updated EM&A Manual of the
TM-CLK Link Project. As informed by the Contractor, major
activities in the reporting period included:
March
2014
Marine-based Works
¡P Marine
piling platform installation;
¡P Marine
Piling at Viaduct B;
¡P Construction
of rockfill platform at Viaduct D landing; and
¡P Additional
marine ground investigation (GI) and laboratory testing.
Land-based Works
¡P Satellite
container offices erection along seawall;
¡P Fence
installation and relocation of Area 2, Viaduct A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaducts B, D & E; and
¡P Additional
land ground investigation (GI), trial pits & laboratory testing;
¡P Utility
surveys; and
¡P Slope
work of 9SE-B/C8 and 9SE-B/C9
April
2014
Marine Works
¡P Marine
piling platform installation;
¡P Marine
piling at Viaducts B & E;
¡P Construction
of rockfill platform at Viaduct D landing and
¡P Additional
marine ground investigation (GI) and laboratory testing
Land-based Works
¡P Satellite
container offices erection along seawall (i.e. CEDD Access Road);
¡P Fence
installation and relocation of Works Area 2, Viaducts A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaducts B, D & E;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys and
¡P Slope
work of 9SE-B/ C8 and 9SE-B/C9
May
2014
Marine-based Works
¡P Marine
piling platform installation;
¡P Marine
piling at Viaducts B & E;
¡P Construction
of rockfill platform at Viaduct D landing and
¡P Additional
marine ground investigation (GI) and laboratory testing
Land-based Works
¡P Satellite
container offices erection along seawall (i.e. CEDD Access Road);
¡P Fence
installation and relocation of Area 2, Viaducts A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaducts B, D & E;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys; and
¡P Slope
work of 9SE-B/C8 and 9SE-B/C9
A summary of
monitoring and audit activities conducted in the reporting period is listed
below:
24-hour TSP
monitoring 16
sessions
1-hour TSP
monitoring 16
sessions
Noise
monitoring 16
sessions
Water quality monitoring 40
sessions
Dolphin
monitoring 6
sessions
Joint
Environmental site inspection 13
sessions
Breaches of Action and Limit Levels for Air Quality
No exceedance of Action and Limit Levels was recorded
for construction noise monitoring in the reporting period.
Breaches of Action and Limit Levels for Noise
No exceedance of Action and Limit Levels was recorded
for construction noise monitoring in the reporting period.
Breaches of Action and Limit Levels for Water Quality
No exceedance
of Action and Limit Levels was recorded for impact water quality monitoring in
the reporting period.
Impact Dolphin Monitoring
Whilst two Action
Level exceedances were observed for the quarterly dolphin monitoring data
between March 2014 and May 2014, no unacceptable impact from the construction activities
of the TM-CLKL Southern Connection Viaduct Section on Chinese White Dolphins
was noticeable from general observations during the dolphin monitoring in this
reporting quarter. The exceedance
is considered to be the natural variation of Chinese White Dolphin ranging
pattern upon further investigation.
Daily marine mammal
exclusion zone monitoring was undertaken. No sighting of the Indo-Pacific
humpback dolphin Sousa chinensis (i.e. Chinese White Dolphin) was recorded in
the reporting period during the exclusion zone monitoring.
Environmental Complaints, Non-compliance & Summons
No
notification of summons and successful prosecution was received in the
reporting period.
Reporting Change
There was no
reporting change required in the reporting period.
Upcoming Works for the Next Reporting Period
Works to be
undertaken in the coming quarter include the following:
June 2014
Marine
Works
¡P Marine
piling platform installation;
¡P Marine
Piling at Viaduct B & E;
¡P Construction
of rockfill platform at Viaduct D landing and
¡P Additional
marine ground investigation (GI) and laboratory.
Land-based
Works
¡P Construction
of pile cap superstructure of Viaduct B;
¡P Fence
installation and relocation of
Works Area 2, Viaduct A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaduct B, D and E;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys and
¡P Slope
work of Slope 9SE-B/C8, 9SE-B/C9 & 9SE-B/F9.
July 2014
Marine
Works
¡P Construction
of Pile caps at Viaduct B;
¡P Marine
piling platform installation;
¡P Marine
Piling at Viaduct B & E;
¡P Construction
of rockfill platform at Viaduct D landing and
¡P Additional
marine ground investigation (GI) and laboratory testing.
Land-based Works
¡P Construction
of pile cap superstructure of Viaduct B;
¡P Fence
installation and relocation of
Works Area 2, Viaduct A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaduct B, C, D and E;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys and
¡P Slope
work of Slope 9SE-B/C8, 9SE-B/C9 & 9SE-B/F9.
August 2014
Marine
Works
¡P Construction
of Pile caps at Viaduct B;
¡P Marine
piling platform installation;
¡P Marine
Piling at Viaduct B, D & E;
¡P Construction
of rockfill platform at Viaduct D landing and
¡P Additional
marine ground investigation (GI) and laboratory testing
Land-based
Works
¡P Construction
of pile cap superstructure of Viaduct B;
¡P Fence
installation and relocation of Works Area 2, Viaduct A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaduct B, C, D and E;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys and
¡P Slope
work of Slope 9SE-B/C8, 9SE-B/C9 & 9SE-B/F9
Future Key Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the coming quarterly period are mainly associated with air quality, noise, marine
water quality, marine ecology and waste management issue.
According to
the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure
Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau
Link and North Lantau Highway would be operating beyond capacity after
2016. This forecast has been based
on the estimated increase in cross boundary traffic, developments in the
Northwest New Territories (NWNT), and possible developments in North Lantau,
including the Airport developments, the Lantau Logistics Park (LLP) and the
Hong Kong ¡V Zhuhai ¡V Macao Bridge (HZMB).
In order to cope with the anticipated traffic demand, two new road
sections between NWNT and North Lantau ¡V Tuen Mun ¡V Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The
EIA Report was submitted under the Environmental Impact Assessment Ordinance
(EIAO) in August 2009. Subsequent
to the approval of the EIA Report (EIAO Register Number AEIAR-145/2009), an
Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of
Environmental Protection (DEP) on 4 November 2009, and EP variation
(EP-354/2009A) was issued on 8 December 2010. Another application for variation of
environmental permit (VEP) (EP-354/2009/B)
was granted on 28 January 2014.
Under
Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of TM-CLKL (¡§the Contract¡¨) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For
implementation of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). ENVIRON
Hong Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO) in accordance
with Environmental Permit No. EP-354/2009/A.
The
organization structure of the Contract is shown in Appendix A.
The key personnel contact names and
contact details are summarized in Table
1.1 below.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
|
Resident
Engineer |
Kingman Chan |
3691 2950 |
3691 2899 |
ENPO / IEC (ENVIRON
Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465 2888 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3465 2828 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
March
2014
Marine-based
Works
¡P Marine
piling platform installation;
¡P Marine
Piling at Viaduct B;
¡P Construction
of rockfill platform at Viaduct D landing; and
¡P Additional
marine ground investigation (GI) and laboratory testing.
Land-based
Works
¡P Satellite
container offices erection along seawall;
¡P Fence
installation and relocation of Area 2, Viaduct A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaducts B, D & E; and
¡P Additional
land ground investigation (GI), trial pits & laboratory testing;
¡P Utility
surveys; and
¡P Slope
work of 9SE-B/C8 and 9SE-B/C9
April 2014
Marine
Works
¡P Marine
piling platform installation;
¡P Marine
piling at Viaducts B & E;
¡P Construction
of rockfill platform at Viaduct D landing and
¡P Additional
marine ground investigation (GI) and laboratory testing
Land-based
Works
¡P Satellite
container offices erection along seawall (i.e. CEDD Access Road);
¡P Fence
installation and relocation of Works Area 2, Viaducts A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaducts B, D & E;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys and
¡P Slope
work of 9SE-B/ C8 and 9SE-B/C9
May 2014
Marine-based
Works
¡P Marine
piling platform installation;
¡P Marine
piling at Viaducts B & E;
¡P Construction
of rockfill platform at Viaduct D landing; and
¡P Additional
marine ground investigation (GI) and laboratory testing
Land-based
Works
¡P Satellite
container offices erection along seawall (i.e. CEDD Access Road);
¡P Fence
installation and relocation of Area 2, Viaducts A, B, C & D;
¡P Land
Piling at Viaduct B;
¡P Piling
platform installation for Viaducts B, D & E;
¡P Additional
land GI, trial pits & lab testing;
¡P Utility
surveys; and
¡P Slope
work of 9SE-B/C8 and 9SE-B/C9.
Table 1.2 Summary
of Construction Activities Undertaken during the Reporting Period
Construction Activities Undertaken |
Marine-based Works |
¡P
Marine piling platform installation; ¡P
Marine piling at Viaducts B & E; ¡P
Construction of rockfill platform at Viaduct
D landing; and ¡P
Additional marine ground investigation (GI) and laboratory testing. |
Land-based Works |
¡P
Satellite container
offices erection along seawall (i.e. CEDD Access Road); ¡P
Fence installation and
relocation of Area 2, Viaducts A, B, C & D; ¡P
Land Piling at Viaduct
B ¡P
Piling platform
installation for Viaducts B, D & E ¡P
Additional land ground
investigation (GI), trial pits & laboratory testing; ¡P
Utility surveys; and ¡P
Slope work of 9SE-B/C8
and 9SE-B/C9 |
The EM&A
programme required environmental monitoring for air quality, noise, water
quality and marine ecology as well as environmental site inspections for air
quality, noise, water quality, waste management, marine ecology and landscape
and visual impacts. The EM&A
requirements and related findings for each component are described in the
following sections, which include:
- Monitoring
parameters;
- Monitoring
schedules for the reporting months and forthcoming months;
- Action
and Limit levels for all environmental parameters;
- Event/
Action Plan;
- Results
and observations;
- Environmental
mitigation measures, as recommended in the Project EIA reports; and
- Environmental
requirement in contract documents.
The EM&A
programme required environmental monitoring for air quality, noise, water
quality and marine ecology as well as environmental site inspections for air
quality, noise, water quality, waste management, marine ecology and landscape
and visual impacts. The EM&A
requirements and related findings for each component are summarized in the
following sections.
The baseline
air quality monitoring undertaken by the Hong Kong ¡V Zhuhai ¡VMacao Bridge Hong
Kong Projects (HKZMB) during October 2011 has included the two monitoring
stations ASR9A and ASR9C for this project.
Thus, the baseline monitoring results and Action/ Limit Level presented
in HKZMB Baseline Monitoring Report ([1]) are
adopted for this Project.
Wind
data monitoring equipment has been installed at the rooftop of Pak Mong Village Watch Tower during the reporting period for
logging wind speed and wind direction.
The wind sensor was setup such as it was clear of obstructions or
turbulence caused by building. The
wind data monitoring equipment is recalibrated at least once every six months.
Table 2.1 Locations
of Impact Air Quality Monitoring Stations and Monitoring Dates in this
Reporting Period
Monitoring Station |
Monitoring Period |
Location |
Description |
Parameters & Frequency |
|
|
|||||
ASR8A |
6, 12, 18,
24 and 28 March; 3, 9, 15, 18, 24 and 30 April; 5, 10, 16, 22 and 28 May |
Area 4 |
On ground at
the Area 4 |
1-hour Total Suspended Particulates (1-hour
TSP, µg/m3), 3 times per day every 6 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour every 6 days |
|
ASR8 |
6, 12, 18,
24 and 28 March; 3, 9, 15, 18, 24 and 30 April; 5, 10, 16, 22 and 28 May |
Pak Mong Village Watch Tower |
Rooftop of
the premise |
||
Note: (1) Air Quality Monitoring
Stations ASR9A and ASR9C at Siu Ho Wan MTRC Depot proposed in accordance with
the Updated EM&A were temporarily relocated to ASR 8A and ASR8,
respectively.
Table 2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind Speed Sensor Wind Direction Sensor |
WE550 (S/N:EC0000) WE570 (S/N:ED0000) |
The Action and
Limit Levels of the air quality monitoring is provided in Appendix D. The Event and Action plan is presented
in Appendix J.
The schedules
for air quality monitoring in the reporting quarter is provided in Appendix E.
The monitoring
results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4,
respectively. Monitoring results
are presented graphically in Appendix F and
detailed impact air quality monitoring results and meteorological information were
reported in the Fifth to Seventh Monthly EM&A Report.
Table 2.3 Summary
of 1-hour TSP Monitoring Results in this Reporting Period
Month |
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
March 2014 |
ASR8A |
120 |
58
- 240 |
394 |
500 |
ASR8 |
118 |
70
- 175 |
393 |
500 |
|
April 2014 |
ASR8A |
101 |
61
¡V 165 |
394 |
500 |
|
ASR8 |
106 |
66
- 173 |
393 |
500 |
May 2014 |
ASR8A |
63 |
45
¡V 83 |
394 |
500 |
|
ASR8 |
82 |
54
- 144 |
393 |
500 |
Table 2.4 Summary
of 24-hour TSP Monitoring Results in this Reporting Period
Month |
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
March 2014 |
ASR8A |
56 |
37
¡V 83 |
178 |
500 |
ASR8 |
64 |
45
- 83 |
178 |
500 |
|
April 2014 |
ASR8A |
67 |
40
¡V 109 |
178 |
500 |
|
ASR8 |
63 |
43
- 89 |
178 |
500 |
May 2014 |
ASR8A |
43 |
35
¡V 48 |
178 |
500 |
|
ASR8 |
47 |
36
- 60 |
178 |
500 |
The major dust
sources in the reporting period include construction activities under the
Contract as well as nearby traffic emissions.
In this
reporting period, a total of sixteen monitoring events were undertaken within
the reporting period, in which no Action or Limit Level exceedances for 1-hr
and 24-hr TSP for air quality were recorded during the reporting period.
The baseline
noise monitoring undertaken by the Hong Kong ¡V Zhuhai ¡V Macao Bridge Hong Kong
Projects (HKZMB) during the period of 18 October to 1 November 2011 has
included the monitoring station NSR1 for this project. Thus, the baseline monitoring results
and Action/ Limit Level presented in HKZMB Baseline Monitoring Report ([2]) are
adopted for this Project.
Monitoring
location was set up at NSR 1 in accordance with the Updated EM&A
Manual. Figure 2.2 shows
the location of the monitoring station.
Table 2.5 describes the
details of the monitoring station.
Noise
monitoring was performed using sound level meter at each designated monitoring
station. The sound level meters
deployed comply with the International Electrotechnical
Commission Publications (IEC) 651:1979 (Type 1) and 804:1985 (Type 1)
specifications. Acoustic calibrator
was deployed to check the sound level meters at a known sound pressure level. Brand and model of the equipment is given in Table 2.6.
Table 2.5 Location of Impact Noise
Monitoring Station and Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Period |
Location |
Parameters & Frequency |
NSR 1 |
March 2014
to May 2014 |
Pak Mong Village Watch Tower |
30-mins
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. At
least once a week |
Table 2.6 Noise Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic
Calibrator |
Rion
NC-73 |
The Action and
Limit levels of the noise monitoring are provided in Appendix D. The Event and Action plan is presented
in Appendix J.
The schedules
for noise monitoring in the reporting quarter is provided in Appendix E.
The monitoring
results for noise monitoring are summarized in Table 2.7. Monitoring
results are presented graphically in Appendix G and
detailed impact noise monitoring results are reported in the Fifth to Seventh Monthly EM&A Report.
Table 2.7 Summary of Construction
Noise Monitoring Results at NSR1 in the Reporting Period
|
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
March
2014 |
59 |
58
- 60 |
75 |
April
2014 |
58 |
56
- 59 |
75 |
May
2014 |
56 |
52
- 59 |
75 |
The baseline
water quality monitoring undertaken by the Hong Kong ¡V Zhuhai ¡V Macao Bridge
Hong Kong Projects (HKZMB) between 6 and 31 October 2011 has included all
monitoring stations except SR4a for the Project. Thus, the baseline monitoring results
except for station SR4a and Action/Limit Level presented in HKZMB Baseline
Monitoring Report ([3]) are
adopted for this Project. Baseline
water quality monitoring was conducted at station SR4a from 29 August to 24
September 2013.
Table 2.8 Locations
of Water Quality Monitoring Stations and the Corresponding Monitoring
Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Depth |
Frequency |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact
Station (Close to HKBCF construction site) |
813273 |
818850 |
Temperature(¢XC)
pH(pH unit)
Turbidity (NTU)
Water depth (m)
Salinity (ppt)
DO (mg/L and % of saturation) ¡P
SS (mg/L) |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed.
If the water depth is less than 3m, mid-depth sampling only. If water depth less than 6m, mid-depth
may be omitted. |
Impact monitoring: 3 days per week, at mid-flood
and mid-ebb tides during the construction period of the Contract. |
IS(Mf)16 |
Impact Station
(Close to HKBCF construction site) |
814328 |
819497 |
|||
IS8 |
Impact Station(Close
to HKBCF construction site) |
814251 |
818412 |
|||
SR4 |
Sensitive receiver
(Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|||
*Notes: In addition to the parameters presented monitoring location/position,
time, water depth, sampling depth, tidal stages, weather conditions and any
special phenomena or works underway nearby were also recorded. |
Table 2.9 summarizes the equipment used in the impact water quality monitoring
programme.
Table 2.9 Water
Quality Monitoring Equipment
Equipment |
Brand and Model |
DO, Temperature meter and Salinity |
YSI Pro2030 |
Turbidimeter |
HACH Model 2100Q |
pH meter |
HANNA HI8314 |
Positioning
Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
The schedules
for water quality monitoring in the reporting quarter are provided in Appendix E.
Impact water
quality monitoring was conducted at all designated monitoring stations in the
reporting period. Monitoring
results are presented graphically in Appendix H and
detailed impact water quality monitoring results were reported in the Fifth to Seventh Monthly EM&A Report.
In this
reporting period, a total of forty monitoring events were undertaken in which no
Action or Limit Level exceedance were recorded during the reporting quarter.
Impact dolphin
monitoring is required to be conducted by a qualified dolphin specialist team
to evaluate whether there have been any effects on the dolphins. In order to fulfil the EM&A
requirements and make good use of available resources, the on-going impact line
transect dolphin monitoring data collected by HyD¡¦s Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong
Kong Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing
Facilities on the monthly basis is adopted to avoid duplicates of survey
effort.
Table 2.10 summarises the equipment
used for the impact dolphin monitoring.
Table
2.10 Dolphin
Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and
reticules 65 foot single
engine motor vessel with viewing platform 4.5m above water level |
|
|
Dolphin
monitoring should cover all transect lines in Northeast Lantau (NEL) and the
Northwest Lantau (NWL) survey areas twice per month throughout the entire construction
period. The monitoring data should
be compatible with, and should be made available for, long-term studies of
small cetacean ecology in Hong Kong. In order to provide a suitable long-term
dataset for comparison, identical methodology and line transects employed in
baseline dolphin monitoring was followed in the impact dolphin monitoring.
The impact
dolphin monitoring was carried out in the NEL and NWL along the line transect
as depicted in Figure 2.4. The
co-ordinates of all transect lines are shown in Table 2.11 below.
Table
2.11 Impact
Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start Point |
804671 |
814577 |
13 |
Start Point |
816506 |
819480 |
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
2 |
Start Point |
805475 |
815457 |
14 |
Start Point |
817537 |
820220 |
2 |
End Point |
805477 |
826654 |
14 |
End Point |
817537 |
824613 |
3 |
Start Point |
806464 |
819435 |
15 |
Start Point |
818568 |
820735 |
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
4 |
Start Point |
807518 |
819771 |
16 |
Start Point |
819532 |
821420 |
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
5 |
Start Point |
808504 |
820220 |
17 |
Start Point |
820451 |
822125 |
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
6 |
Start Point |
809490 |
820466 |
18 |
Start Point |
821504 |
822371 |
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
7 |
Start Point |
810499 |
820690 |
19 |
Start Point |
822513 |
823268 |
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
8 |
Start Point |
811508 |
820847 |
20 |
Start Point |
823477 |
823402 |
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
9 |
Start Point |
812516 |
820892 |
21 |
Start Point |
805476 |
827081 |
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
10 |
Start Point |
813525 |
820872 |
22 |
Start Point |
806464 |
824033 |
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
11 |
Start Point |
814556 |
818449 |
23 |
Start Point |
814559 |
821739 |
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
12 |
Start Point |
815542 |
818807 |
|
|
|
|
12 |
End Point |
815542 |
824882 |
|
|
|
|
The action and
limit levels of dolphin impact monitoring are shown in Appendix D. The Event and Action plan is presented
in Appendix J.
The dolphin
monitoring schedules for the reporting period are shown in Appendix E.
A total of 891.87
km of survey effort was collected, with 87.4% of the total survey effort being
conducted under favourable weather conditions (i.e. Beaufort Sea State 3 or
below with good visibility). Among
the two areas, 350.40 km and 541.47 km of survey effort were collected from NEL
and NWL survey areas respectively. The
total survey effort conducted on primary lines was 642.67 km, while the effort
on secondary lines was 249.20 km. Both
survey effort conducted on primary and secondary lines
were considered as on-effort survey data. The survey efforts are summarized in Appendix I.
A total of 31 groups
of 103 Chinese White Dolphin sightings were recorded during the six sets of surveys
from March to May 2014.
All except one
sighting were made during on-effort search. Twenty-five on-effort sightings
were made on primary lines, while another five on-effort sightings were made on
secondary lines. In this quarterly
period, all dolphin groups were sighted in NWL, while none was sighted in NEL.
Encounter
rates of Chinese White Dolphins deduced from the survey effort and on-effort
sighting data from the primary transect lines under favourable conditions
(Beaufort 3 or below) in the reporting period with the results presented in Tables 2.12 and 2.13.
Table 2.12 Individual Survey Event Encounter
Rates
|
|
Encounter rate (STG) (no. of
on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per 100 km of survey
effort) |
|
Set
1 (5 & 11 Mar 2014) |
Primary
Lines Only |
Primary
Lines Only |
NEL |
Set
2 (17 & 25 Mar 2014) Set
3 (4 & 14 Apr 2014) Set
4 (16 & 24 Apr 2014) Set
5 (2 & 19 May 2014) Set
6 (21 & 26 May 2014) |
0.0 0.0 0.0 0.0 0.0 0.0 |
0.0 0.0 0.0 0.0 0.0 0.0 |
NWL |
Set
1 (5 & 11 Mar 2014) Set
2 (17 & 25 Mar 2014) Set
3 (4 & 14 Apr 2014) Set
4 (16 & 24 Apr 2014) Set
5 (2 & 19 May 2014) Set
6 (21 & 26 May 2014) |
6.4 13 4.9 4.9 5.5 4.2 |
23.57 24.83 26.88 11.54 18.24 9.75 |
Table 2.13 Quarterly Average Encounter Rates
|
Encounter rate (STG) (no. of
on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI)
(no. of dolphins from all on-effort sightings per
100 km of survey effort) |
||
March ¡VMay 2014 |
September -November 2011 |
March ¡VMay 2014 |
September -November 2011 |
|
Northeast Lantau |
0.0 |
6.00 ¡Ó 5.05 |
0.0 |
22.19 ¡Ó 26.81 |
Northwest Lantau |
6.51 ¡Ó 3.34 |
9.85 ¡Ó 5.85 |
19.14 ¡Ó 7.19 |
44.66 ¡Ó 29.85 |
Table 2.14 Comparison of Quarterly Average
Encounter Rates
|
Average Dolphin Group Size |
|
March ¡V May 2014 |
September -November 2011 |
|
Overall |
3.32 ¡Ó
2.87 (n = 31) |
3.72 ¡Ó 3.13 (n = 66) |
Northeast Lantau |
0.0 |
3.18 ¡Ó 2.16 (n = 17) |
Northwest Lantau |
3.32 ¡Ó 2.87 (n = 31) |
3.92 ¡Ó 3.40 (n = 49) |
Daily 250 m marine
mammal exclusion zone monitoring was undertaken under this Contract. No sighting of the Indo-Pacific humpback dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was recorded in the reporting period during the
exclusion zone monitoring.
Marine bored
piling monitoring programme for dolphins (ie
Land-based Theodolite Tracking, Underwater Noise Monitoring and Acoustic Behavioural Monitoring)
was commenced on 3 March 2014 and completed on 25 April 2014. Data analysis was being undertaken for
the marine bored piling monitoring programme which will be presented in the
Final Monitoring Reports for the Land-based Theodolite Tracking and Underwater
Noise and Dolphin Acoustic Behavioural Monitoring.
The second
quarterly Coral Post-Translocation Monitoring was conducted on 16 April 2014
and the results were provided in the Second
Quarterly Post-Translocation Coral Monitoring Report. The findings indicated that the Action
or Limit Levels for coral monitoring were not exceeded as increase in
percentage of partial mortality was not detected for both the tagged translocated and natural coral colonies when comparing to
the pre-translocation dataset.
Site
inspections were carried out on a weekly basis to monitor the implementation of
proper environmental pollution control and mitigation measures under the
Contract. Thirteen (13) site
inspections were carried out in the reporting quarter on 5, 12, 19, 26 March; 2,
9, 16, 23, 30 April; 7, 13, 21 and 29 May 2014.
Key
observations during the site inspections in this reporting period are summarized
in Table 2.15.
Table
2.15 Specific
Observations Identified during the Weekly Site Inspection in this Reporting
Period
Inspection Date |
Location & Environmental Observations |
Recommendations/ Remarks |
5 March 2014 |
Seafront
site ¡P
Plugs of 2 drip drays were missing. ¡P
A few cans of chemical were not placed in drip tray. |
Seafront
site ¡P
The drip drays were plugged. ¡P
The chemicals were put into drip tray immediately. |
12 March
2014 |
G38 Oil stain
was observed near bored pile. |
G38 Absorbent
was deployed immediately. |
19 March
2014 |
B11 Pavement
needed to be cover by tarpaulin sheet. Watering
programme had to be carried out regularly for dust suppression. |
B11 Tarpaulin
sheet was provided. Watering
programme was carried out regularly for dust suppression. |
26 March
2014 |
B1 Oil
stain was observed. Seafront Chemical
containers were placed without drip tray. |
B1 Oil
stain was removed. Seafront Drip
tray was provided. |
2 April 2014 |
Area 1 |
Area 1 |
|
¡P
Stagnant water was found accumulating and
overflowing from drip tray of a generator |
¡P
The Contractor was reminded to take appropriate
action to clean up the stagnant water. |
|
B15 |
B15 |
|
¡P
Water leakage was observed from a pipe buried
underground which transport treated water from sedimentation tank to the
discharge point. |
¡P
The Contractor was reminded to take appropriate
action. |
9 April 2014 |
E12 |
E12 |
|
¡P
Stagnant water was found accumulated in the drip
tray of a generator |
¡P
The Contractor was reminded to take appropriate
action to clean up the stagnant water. |
|
G28 |
G28 |
|
¡P
Two chemical drums were not placed properly in drip
tray |
¡P
The Contractor was reminded to put the chemical
drums in place. |
|
|
¡P
The Contractor was reminded to implement the
acoustic decoupling measures during mechanical device operation. |
16 April
2014 |
Area 1 |
Area 1 |
|
¡P
Temporary stockpiles were found partially exposed |
¡P
The Contractor was reminded to cover the temporary
stockpiles properly. |
|
Pak Mong |
Pak Mong |
|
¡P
Existing trees in the project site shall be
carefully protected. |
¡P
The Contractor was reminded to protect/ transplant
the existing trees properly before works commencement. |
|
¡P
General refuse was observed in the project site
area. |
¡P
The Contractor was reminded to keep litter free in
the Project site. |
23 April
2014 |
E3 |
E3 |
|
¡P
One of the drip trays for holding the generator was
found unplugged with stagnant water leaked from the drain hole. |
¡P
The Contractor was advised to plug the drain hole of
the drip tray properly. |
|
B3 |
B3 |
|
¡P
The chemical waste drums were placed unattended
without drip tray. |
¡P
The Contractor was reminded to place the chemical
waste drums properly. |
|
¡P
Drip tray of a generator was not plugged properly. |
¡P
The Contractor was reminded to plug the drip tray
properly. |
|
B5/G23 |
B5/G23 |
|
¡P
Oily floor was observed on G23. |
¡P
The Contractor took immediate action to clean up oil
by chemical absorbance. |
|
¡P
Some chemical drums were not placed in drip trays. |
¡P
The Contractor was reminded to place the chemical
drums in drip trays. |
30
April 2014 |
B15 |
B15 |
|
¡P
Trash was observed. |
¡P
The Contractor was reminded to clean up the trash in
the project area regularly. |
|
B1 |
B1 |
|
¡P
The wielding machine was not placed on isolated
pad. |
¡P
The Contractor was advised to implement acoustic
decoupling plan properly. |
7 May 2014 |
Area 1 |
Area 1 |
|
¡P
General refuse was found disposed in chemical
container ¡P
Litter was found in the project area |
¡P
The Contractor was reminded to dispose general
refuse correctly |
|
Pak Mong |
Pak Mong |
|
¡P
Chemical container was placed near drainage area |
¡P
The Contractor put the containers far away from
drainage area immediately. |
13 May 2014 |
B1 |
B1 |
|
¡P
Acoustic decoupling pad was not found at the water
pump. |
¡P
The Contractor was reminded to deploy a decoupling
pad |
|
Seafront |
Seafront |
|
¡P
Label was not found on the chemical container ¡P
Stagnant water was found on the ground ¡P
General refuse was found scattering at the project
area. |
¡P
The Contractor was reminded to label chemicals
correctly. ¡P
The Contractor was reminded to clean up the stagnant
water. |
|
|
¡P
The Contractor was reminded to maintain good
housekeeping. |
21 May 2014 |
Area 1 |
Area 1 |
|
¡P
Some chemical containers were found not placed in
drip tray. ¡P
A drip tray was found not plugged. |
¡P
The Contractor was reminded to place the chemical
containers in drip tray ¡P
The Contractor was reminded to plug the drip tray. |
|
Rockfill platform at
Seafront |
Rockfill platform at
Seafront |
|
¡P
Some oil was found under a mobile crane. |
¡P
The Contractor removed the oil immediately. |
|
|
|
29 May 2014 |
B16 |
B16 |
|
¡P
Stagnant water was found accumulated in drip tray. ¡P
Chemical containers were found placed
inappropriately. |
¡P
The Contractor was reminded to clean up the drip
tray. ¡P
The Contractor was reminded to place chemical
containers in drip tray. |
|
B15 |
B15 |
|
¡P
Lack of sandbag to prevent surface runoff. |
¡P
The Contractor was reminded to place more sandbag to
prevent surface runoff. |
|
¡P
Accumulation of general refuses was found. |
¡P
The Contractor was reminded to keep good house
keeping |
|
E9 |
E9 |
|
¡P
Stagnant water was found accumulated in drip tray. |
¡P
The Contractor was reminded to clean up the drip
tray. |
Wastes
generated during this reporting period include mainly construction wastes
(inert and non-inert), imported fill, recyclable materials, and marine
sediments. Reference has been made
to the waste flow table prepared by the Contractor (Appendix K). The quantities of different types of
wastes are summarized in Table 2.16.
Table
2.16 Quantities
of Different Waste Generated in the Reporting Period
Month/Year |
Inert Construction Waste (a)
(m3) |
Imported Fill (m3) |
Inert Construction Waste
Re-used (m3) |
Non-inert Construction Waste (b)
(tonnes) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
Category L |
Category M |
|||||||
March 2014 |
221 |
2,098 |
960 |
12.39 |
46,050 |
0 |
0 |
0 |
April 2014 |
118 |
914 |
80 |
87.65 |
15,760 |
0 |
0 |
0 |
May 2014 |
1,546 |
451 |
40 |
98.03 |
8,586 |
0 |
386,000 |
0 |
Total |
1,885 |
3,463 |
1,080 |
198.07 |
70,396 |
0 |
386,000 |
0 |
Notes: |
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
The Contractor
was advised to properly maintain on site C&D materials and waste
collection, sorting and recording system, dispose of C&D materials and
wastes at designated ground and maximize reuse/ recycle of C&D materials
and wastes. The Contractor was also
reminded to properly maintain the site tidiness and dispose of the wastes
accumulated on site regularly and properly.
For
chemical waste containers, the Contractor was reminded to treat properly and
store temporarily in designated chemical waste storage area on site in
accordance with the Code of Practice on the Packaging, Labelling and Storage of
Chemical Wastes.
The status of
environmental licensing and permit is summarized in Table 2.17 below.
Table
2.17 Summary
of Environmental Licensing and Permit Status
License/
Permit |
License
or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit
Holder |
Remarks |
Environmental Permit |
EP-354/2009/A |
8 Dec 2010 |
NA |
HyD |
Tuen Mun- Chek Lap Kok Link |
Environmental Permit |
EP-354/2009/B |
28 Jan 2014 |
NA |
HyD |
Tuen Mun- Chek Lap Kok Link |
Construction Dust Notification |
361571 |
5 Jul 2013 |
NA |
GCL |
- |
Construction Dust Notification |
362093 |
17 Jul 2013 |
NA |
GCL |
For Area 23 |
Billing Account for Disposal |
7017735 |
10 Jul 2013 |
End of Project |
GCL |
- |
Chemical Waste Registration |
5213-961-G2380-13 |
10 Oct 2013 |
NA |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 1 adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10 Oct 2013 |
NA |
GCL |
Chemical waste produced in Contract HY/2012/07 (Area 2 adjacent to Cheung Tung Road, Pak Mong
Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
4 Nov 2013 |
NA |
GCL |
Chemical waste produced in Contract HY/2012/07 (WA5 adjacent to Cheung Tung Road, Yam O) |
Construction Waste Disposal Account |
7017735 |
10 Jul 2013 |
NA |
GCL |
Waste disposal in Contract HY/2012/07 |
Waste Water Discharge License |
WT00019017-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13 May 2014 |
31 May 2019 |
GCL |
Discharge for land portion |
Construction Noise Permit |
Nil |
Application
in process |
NA |
GCL |
For Piling Works |
Construction Noise Permit |
GW-RS0419-14 |
15 May 2014 |
13 Nov 2014 |
GCL |
For loading & unloading on NLH near Viaducts A & B |
Construction Noise Permit |
GW-RS0226-14 |
30 Mar 2014 |
29 Sep 2014 |
GCL |
For loading & unloading on NLH near Viaduct D |
Construction Noise Permit |
GW-RS0236-14 |
27 Mar 2014 |
14 May 2014 |
GCL |
For loading & unloading on NLH near Viaducts A & B |
Construction Noise Permit |
GW-RS0280-14 |
31 Mar 2014 |
31 May 2014 |
GCL |
For excavation at Pier B9 |
Construction Noise Permit |
GW-RS0299-14 |
7 Apr 2014 |
5 Jul 2014 |
GCL |
Pier B8 at CEDD Access Road |
Construction Noise Permit |
GW-RS0331-14 |
4 Apr 2014 |
6 Jul 2014 |
GCL |
Broad permit for works at seafront
& marine piers |
Construction Noise Permit |
GW-RS0338-14 |
4 Apr 2014 |
3 Jun 2014 |
GCL |
For bored piling works between Pier
E13 and HKBCF |
Construction Noise Permit |
GW-RS1423-13 |
11 Dec 2013 |
30 Apr 2014 |
GCL |
Renewal for marine portion |
Construction Noise Permit |
GW-RW0123-14 |
27 Feb 2014 |
27 Aug 2014 |
GCL |
For night works and works in general holiday at WA5 |
Dumping Permit/ Loading Permit (Type 1 ¡V Open Sea Disposal) |
(4) in EP/MD/14-075 |
25 Sep 2013 |
NA |
GCL |
- |
Marine Dumping Permit |
EP/MD/14-075 |
28 Jan 2014 |
27 Jul 2014 |
GCL |
For dumping Type I Sediment |
Marine Dumping Permit |
EP/MD/15-028 |
1 Jun 2014 |
30 Jun 2014 |
GCL |
For dumping Type I (Dedicated Site) and Type II sediment |
Construction Noise Permit |
GW-RS1129-13 |
31 Oct 2013 |
30 Apr 2014 |
GCL |
For night works and works in general
holidays |
|
|
|
|
|
|
Construction Noise Permit |
GW-RW0925-13 |
19 Dec 2013 |
17 Apr 2014 |
GCL |
Renewal of WA5 site office erection |
Construction Noise Permit |
GW-RS1423-13 |
11 Dec 2013 |
30 Apr 2014 |
GCL |
Renewal for marine portion |
Construction Noise Permit |
GW-RS1413-13 |
17 Dec 2013 |
26 Mar 2014 |
GCL |
For loading and unloading on NLH near viaduct A & B |
Construction Noise Permit |
GW-RS0034-14 |
14 Jan 2014 |
29 Mar 2014 |
GCL |
For night works and works in general holiday |
|
|
|
|
|
|
Marine Dumping Permit |
EP/MD/14-155 |
1 April 2014 |
30 April 2014 |
GCL |
For dumping Type I (Dedicated Site) and Type II Sediment |
For
noise monitoring, a total of sixteen monitoring events were undertaken in the
reporting quarter and no exceedance of Action and Limit Levels were recorded.
For
water quality monitoring, a total of forty monitoring events were undertaken
and no exceedance of Action and Limit Levels were recorded.
For
impact dolphin monitoring, a total of two Action Level exceedances were
recorded. Investigation findings
were detailed in Appendix L.
June
2014
Marine
Works
¡P
Marine piling platform installation;
¡P
Marine Piling at Viaduct B & E;
¡P
Construction of rockfill platform at
Viaduct D landing; and
¡P
Additional marine ground investigation (GI) and laboratory.
Land-based
Works
¡P
Construction of pile cap superstructure of Viaduct B;
¡P
Fence installation and relocation of Works Area 2, Viaduct A, B, C & D;
¡P
Land Piling at Viaduct B;
¡P
Piling platform installation for Viaduct B, D and E;
¡P
Additional land GI, trial pits & lab testing;
¡P
Utility surveys; and
¡P
Slope work of Slope 9SE-B/C8, 9SE-B/C9 & 9SE-B/F9.
July 2014
Marine
Works
¡P
Construction of Pile caps at Viaduct B;
¡P
Marine piling platform installation;
¡P
Marine Piling at Viaduct B & E;
¡P
Construction of rockfill platform at
Viaduct D landing; and
¡P
Additional marine ground investigation (GI) and laboratory testing.
Land-based Works
¡P
Construction of pile cap superstructure of Viaduct B;
¡P
Fence installation and relocation of Works Area 2, Viaduct A, B, C & D;
¡P
Land Piling at Viaduct B;
¡P
Piling platform installation for Viaduct B, C, D and E;
¡P
Additional land GI, trial pits & lab testing;
¡P
Utility surveys; and
¡P
Slope work of Slope 9SE-B/C8, 9SE-B/C9 & 9SE-B/F9.
August 2014
Marine
Works
¡P
Construction of Pile caps at Viaduct B;
¡P
Marine piling platform installation;
¡P
Marine Piling at Viaduct B, D & E;
¡P
Construction of rockfill platform at
Viaduct D landing; and
¡P
Additional marine ground investigation (GI) and laboratory testing.
Land-based
Works
¡P
Construction of pile cap superstructure of Viaduct B;
¡P
Fence installation and relocation of Works Area 2, Viaduct
A, B, C & D;
¡P
Land Piling at Viaduct B;
¡P
Piling platform installation for Viaduct B, C, D and E;
¡P
Additional land GI, trial pits & lab testing;
¡P
Utility surveys; and
¡P
Slope work of Slope 9SE-B/C8, 9SE-B/C9 & 9SE-B/F9.
Potential
environmental impacts arising from the above upcoming construction activities are
mainly associated with air quality, noise, marine water quality, marine ecology
and waste management issues.
Impact
monitoring for air quality, noise, marine water quality and marine ecology
(include dolphin monitoring and post-translocation coral monitoring) are
scheduled to continue for the next reporting period.
The monitoring
programme has been reviewed and was considered as adequate to cater for the
nature of works in progress.

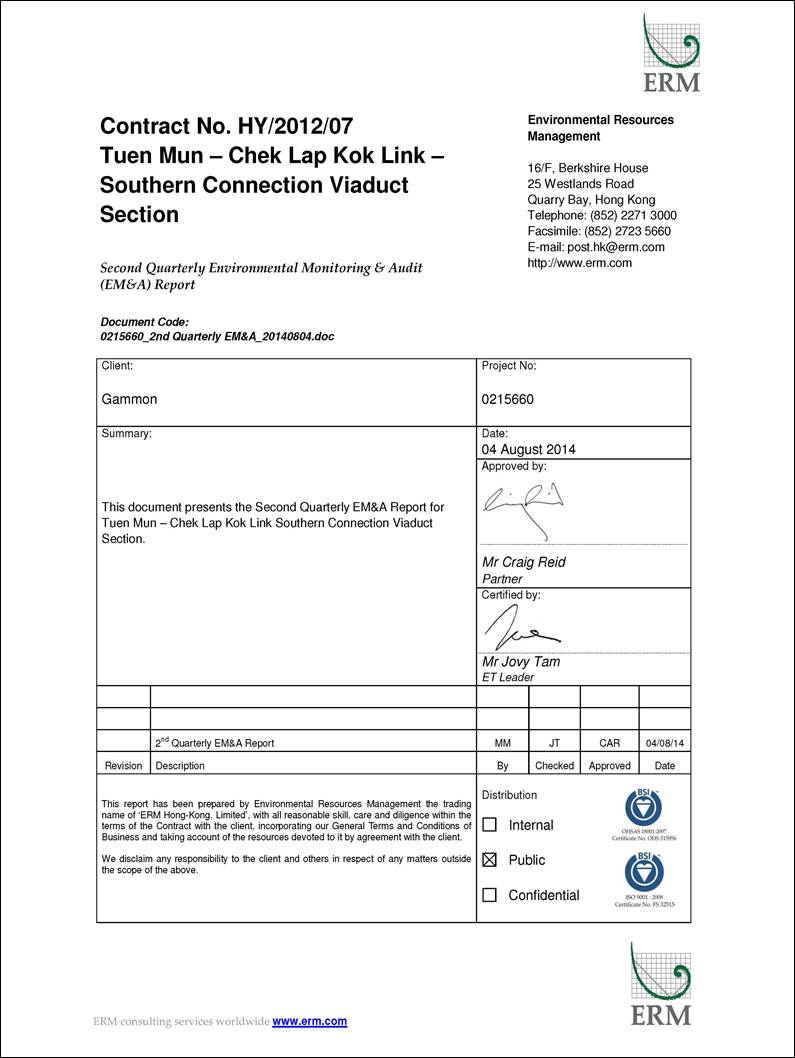

This Second Quarterly
EM&A Report presents the findings of the EM&A activities undertaken
during the period from 1 March to 31 May 2014, in accordance with the Updated
EM&A Manual and the requirements of EP-354/2009/B.
Neither Action
Level nor Limit Level exceedances were observed for air quality, noise and
water quality impact monitoring in this reporting period.
A total of 31 groups of 103 Chinese
White Dolphin sightings were recorded
during the six sets
of surveys from March 2014 to May 2014. Whilst two Action Level exceedances were
recorded for the quarterly dolphin monitoring data between March and May 2014,
no unacceptable impact from the construction activities of the TM-CLKL Southern
Connection Viaduct Section on Chinese White Dolphins was noticeable from
general observations.
Although the dolphins infrequently occurred along the alignment of TM-CLKL Southern
Connection Viaduct Section in the past and during the baseline monitoring
period, it is apparent that dolphin usage has been significantly reduced in NEL. It is critical to monitor the dolphin
usage in North Lantau region in the upcoming quarters, to determine whether the
dolphins are continuously affected by the various construction activities in
relation to the construction works of the Contract, and whether suitable
mitigation measure can be applied to improve the situation.
Environmental
site inspection was carried out thirteen (13) times in the reporting period. Recommendations on remedial actions were
given to the Contractor for the deficiencies identified during the site audits.
No summons/
prosecution were received during the reporting period.
The monitoring
programme has been reviewed and was considered as adequate to cater for the
nature of works in progress. Change
to the monitoring programme was thus not recommended at this stage. The monitoring programme will be
evaluated as appropriate in the next reporting period. The ET will keep track on the
construction works to confirm compliance of environmental requirements and the
proper implementation of all necessary mitigation measures.

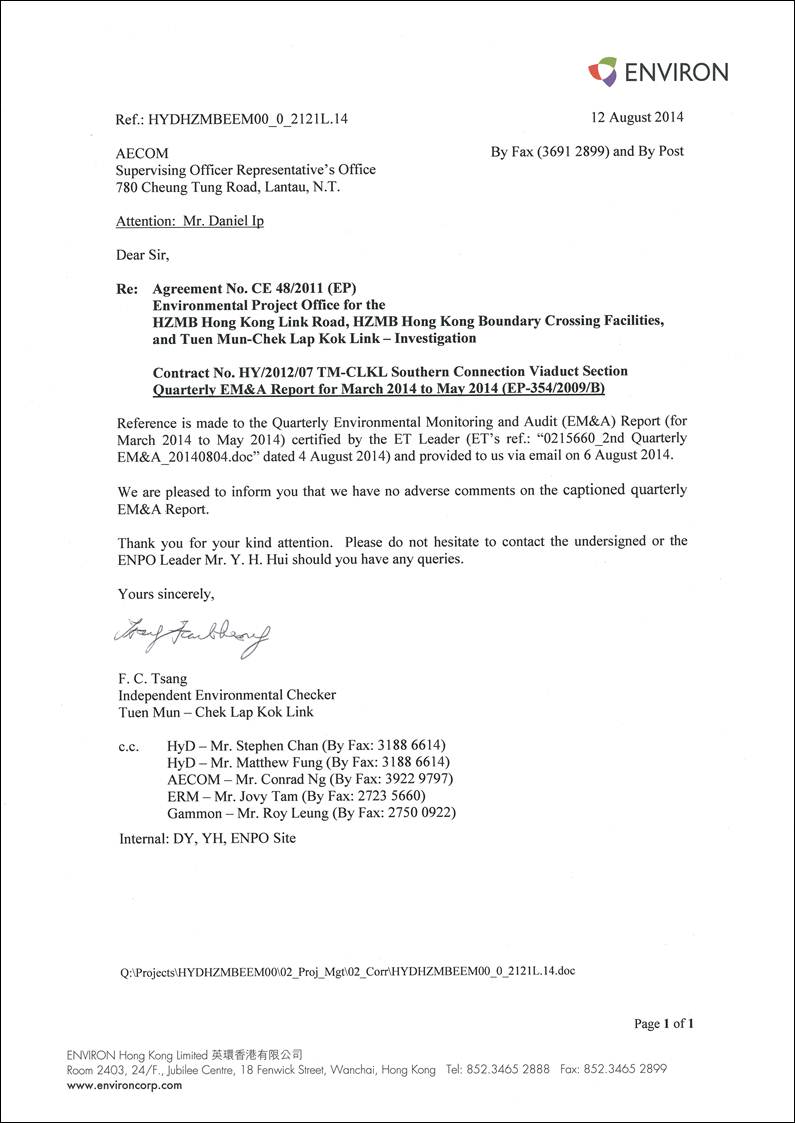

([1])
Agreement No. CE 35/2011 (EP)
Baseline Environmental Monitoring for Hong Kong - Zhuhai - Macao Bridge Hong
Kong Projects - Investigation. Baseline
Environmental Monitoring Report (Version C). Submitted on 8 March 2012 and
subsequently approved by EPD.
