Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Southern
Connection Viaduct Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). Ramboll Environ Hong Kong Ltd. was employed by the HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A. Further applications for variation of
environmental permit (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.

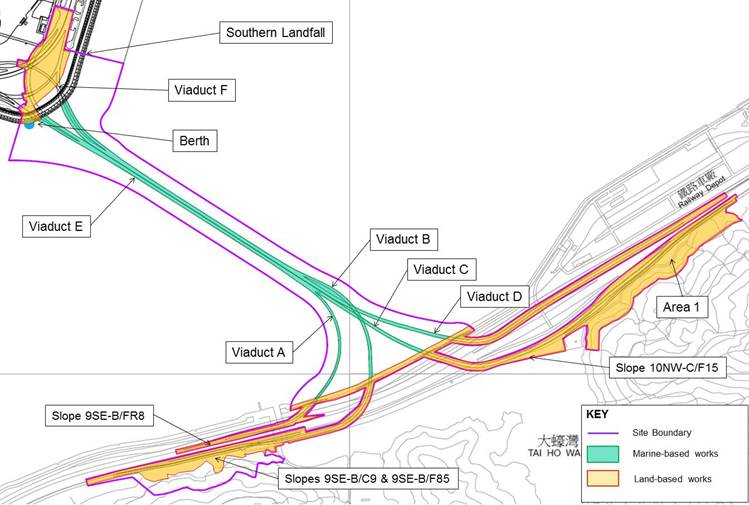

The southern landfall of TM-CLK Link lies alongside
the Hong Kong - Zhuhai - Macao Bridge Hong Kong Boundary Crossing Facilities
(HKBCF) where a reclamation area is constructed by Contract No. HY/2010/02
under Environmental Permit No. EP-353/2009/K and EP-354/2009/D. Upon the agreement and confirmation between
the Supervising Officer Representatives and Contractors of HY/2010/02 and HY/2012/07
in September 2015, part of the reclamation area for southern landfall under EP-353/2009/K and EP-354/2009/D was handed-over to Contract No. HY/2012/07. Another part of the southern landfall area
under EP-354/2009/D was handed-over
to Contract No. HY/2012/07 after
completion of reclamation works by Contract
No. HY/2010/02 in June 2016.
The construction phase of the Contract commenced on 31
October 2013 and will be tentatively completed by 2018. The impact monitoring of the EM&A programme, including air quality, noise, water quality and
marine ecological monitoring as well as environmental site inspections,
commenced on 31 October 2013.
This is the Eleventh Quarterly EM&A Report presenting
the EM&A works carried out during the period from 1 June to 31 August 2016 for
the Southern Connection Viaduct Section in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, major activities in the reporting period included:
June 2016
Marine
Works
· Construction
and installation of pile caps;
· Uninstallation
of marine piling platform;
· Pier
construction;
· Construction
of marine section of berth at Southern Landfall;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based
Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Construction
of land section of berth at Southern Landfall;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
July 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Construction
of land section of berth at Southern Landfall;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
August 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Construction
of land section of berth at Southern Landfall;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
A summary of monitoring and audit activities conducted
in the reporting period is listed below:
24-hour TSP monitoring 18 sessions
1-hour TSP monitoring 18 sessions
Noise monitoring 18
sessions
Water quality monitoring 38 sessions
Dolphin monitoring 6
sessions
Joint Environmental site inspection 13 sessions
Breaches of
Action and Limit Levels for Air Quality
No exceedance of Action and Limit Levels was recorded
for air quality monitoring in the reporting period.
Breaches of
Action and Limit Levels for Noise
No exceedance of Action and Limit Levels was recorded
for construction noise monitoring in the reporting period.
Breaches of
Action and Limit Levels for Water Quality
No exceedance of Action and Limit Levels was recorded
for water quality monitoring in the reporting period.
Impact Dolphin
Monitoring
One (1) Limit Level exceedance was observed
for the quarterly dolphin monitoring data between June and August 2016. No unacceptable impact from the construction activities
of the TM-CLKL Southern Connection Viaduct Section on Indo-Pacific
humpback dolphin Sousa chinensis (i.e. Chinese
White Dolphins) was noticeable from general observations during the dolphin
monitoring in this reporting quarter.
The exceedances are considered unlikely due to the works of this Project
upon further investigation.
Daily
marine mammal exclusion zone monitoring was undertaken during the period of
marine works under this Contract. No
Passive Acoustic Monitoring (PAM) was implemented as the marine piling works
were not carried out outside the daylight hours in this reporting period. No sighting of Chinese White Dolphin was
recorded in the monitoring period during the exclusion zone monitoring.
Environmental
Complaints, Non-compliance & Summons
No environmental complaint, notification of summons
and successful prosecution was received in the reporting period.
Reporting
Change
There was no reporting change in this reporting
period.
Upcoming
Works for the Next Reporting Period
Works to be undertaken in the coming quarter include
the following:
September 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
October 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
November 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
Future Key
Issues
Potential environmental impacts arising from the above
upcoming construction activities in the coming quarterly period are mainly
associated with air quality, noise, marine water quality, marine ecology and
waste management issue.
According to the findings of the Northwest New
Territories (NWNT) Traffic and Infrastructure Review conducted by the Transport
Department, Tuen Mun Road,
Ting Kau Bridge, Lantau Link and North Lantau Highway
would be operating beyond capacity after 2016.
This forecast has been based on the estimated increase in cross boundary
traffic, developments in the Northwest New Territories (NWNT), and possible
developments in North Lantau, including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic
demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek
Lap Kok Link (TM-CLKL) and Tuen
Mun Western Bypass (TMWB) are proposed.
An Environmental Impact Assessment (EIA) of TM-CLKL
(the Project) was prepared in accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental
Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number: AEIAR-146/2009),
an Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (EP-354/2009A)
was issued on 8 December 2010. Further applications for variation of
environmental permit (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
Under Contract No. HY/2012/07,
Gammon Construction Limited (GCL) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Southern Connection Viaduct Section of TM-CLKL (“the Contract”) while AECOM
Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme
under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the
Environmental Team (ET). Ramboll Environ Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and
Environmental Project Office (ENPO) in accordance with Environmental Permit No. EP-354/2009/A.
The southern landfall of TM-CLK Link lies alongside
the Hong Kong - Zhuhai - Macao Bridge Hong Kong Boundary Crossing Facilities
(HKBCF) where a reclamation area is constructed by Contract No. HY/2010/02
under Environmental Permit No. EP-353/2009/K and EP-354/2009/D. Upon the agreement and confirmation between
the Supervising Officer Representatives and Contractors of HY/2010/02 and HY/2012/07
in September 2015, part of the reclamation area for southern landfall under EP-353/2009/K and EP-354/2009/D was handed-over to Contract No. HY/2012/07. Another part of the southern landfall area
under EP-354/2009/D was handed-over
to Contract No. HY/2012/07 after
completion of reclamation works by Contract
No. HY/2010/02 in June 2016.
The organization structure of the Contract is shown in
Appendix A. The
key personnel contact names and contact details are summarized in Table 1.1 below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Daniel Ip |
3553 3800 |
2492 2057 |
Resident
Engineer |
Kingman Chan |
3691 2950 |
3691 2899 |
|
ENPO / IEC (Ramboll Environ Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3547 2133 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3547 2134 |
3465 2899 |
|
Contractor (Gammon
Construction Limited) |
Environmental
Manager |
Brian Kam |
3520 0387 |
3520 0486 |
Environmental
Officer |
Roy Leung |
3520 0387 |
3520 0486 |
|
|
24-hour
Complaint Hotline |
|
9738 4332 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
June 2016
Marine
Works
· Construction
and installation of pile caps;
· Uninstallation
of marine piling platform;
· Pier
construction;
· Construction
of marine section of berth at Southern Landfall;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based
Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Construction
of land section of berth at Southern Landfall;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
July 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Construction
of land section of berth at Southern Landfall;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
August 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Construction
of land section of berth at Southern Landfall;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
The
locations of the construction activities are shown in Figure 1.3.
The Environmental Sensitive Receivers in the vicinity of the Project are
shown in Figure 1.4.
The EM&A programme
required environmental monitoring for air quality, noise, water quality and
marine ecology as well as environmental site inspections for air quality, noise,
water quality, waste management, marine ecology and landscape and visual
impacts. The EM&A requirements and
related findings for each component are described in the following sections,
which include:
· Monitoring
parameters;
· Monitoring
schedules for the reporting months and forthcoming months;
· Action
and Limit levels for all environmental parameters;
· Event
Action Plan;
· Results
and observations;
· Environmental
mitigation measures, as recommended in the approved EIA Report; and
· Environmental
requirement in contract documents.
The EM&A programme required
environmental monitoring for air quality, noise, water quality and marine
ecology as well as environmental site inspections for air quality, noise, water
quality, waste management, marine ecology and landscape and visual
impacts. The EM&A requirements and
related findings for each component are summarized in the following sections.
The baseline air quality monitoring undertaken by the HZMB
Projects during October 2011 included the two monitoring stations ASR9A and
ASR9C for this Project. Thus, the
baseline monitoring results and Action/Limit Level presented in HZMB Baseline
Monitoring Report ([1])
are adopted for this Project.
1-hour TSP and 24-hour TSP
monitoring were conducted at 2 alternative air quality monitoring stations,
ASR8A (Area 4) and ASR9 (entrance of MTR Depot) during the reporting period in
accordance with the requirement of the Updated EM&A Manual. The monitoring stations are indicated in Figure 2.1 and details are presented in Table 2.1.
High Volume Samplers (HVSs)
were used for carrying out 1-hour and 24-hour TSP monitoring during the
reporting period. The HVSs meets all
requirements of the Updated EM&A Manual.
Brand and model of the equipment are given in Table 2.2.
Wind data monitoring equipment was installed at Area 4
during the reporting period for logging wind speed and wind direction. The wind sensor was setup such that it was clear
of obstructions or turbulence caused by building. The wind data monitoring equipment is
recalibrated at least once every six months.
Table 2.1 Locations of Impact Air Quality
Monitoring Stations and Monitoring Dates in this Reporting Period
Monitoring Station (1) |
Monitoring Period |
Location |
Description |
Parameters & Frequency |
ASR8A |
1, 7, 13,
16, 22 and 28 June 2016 4, 7, 13,
19, 25 and 29 July 2016 3, 9, 15,
18, 24 and 30 August 2016 |
Area 4 |
On ground at
the works area, Area 4 |
1-hour Total
Suspended Particulates (1-hour TSP, µg/m3), 3 times per day every
6 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour every 6 days |
ASR9 |
MTR Depot |
On the
ground nearby MTR Depot entrance |
Note:
(1) Air Quality Monitoring Stations ASR9A and ASR9C at Siu
Ho Wan MTRC Depot proposed in accordance with the Updated EM&A were
relocated to ASR9 and ASR8A respectively.
Table
2.2 Air Quality
Monitoring Equipment
Equipment |
Brand and Model |
High
Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind
Sensor |
Global
Water (Wind Speed Sensor: WE550; Wind Direction Sensor: WE570) |
Wind
Anemometer for calibration |
Lutron
(Model No. AM-4201) |
The Action and Limit Levels of the air quality
monitoring are provided in Appendix D. The Event and Action plan is presented in Appendix J.
The schedules for air quality monitoring in the reporting
quarter are provided in Appendix E.
The monitoring results for 1-hour TSP and 24-hour TSP
are summarized in Tables 2.3 and 2.4, respectively. Monitoring results are presented graphically
in Appendix F. Detailed
impact air quality monitoring results and meteorological information were
reported in the Thirty-second to Thirty-fourth Monthly EM&A Reports.
Table 2.3 Summary of 1-hour TSP Monitoring Results
in this Reporting Period
Month |
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
June 2016 |
ASR 8A |
58 |
48
– 69 |
394 |
500 |
ASR 9 |
59 |
48
- 87 |
393 |
500 |
|
July 2016 |
ASR 8A |
57 |
47
– 69 |
394 |
500 |
ASR 9 |
68 |
44
- 107 |
393 |
500 |
|
August 2016 |
ASR 8A |
61 |
41
– 116 |
394 |
500 |
ASR 9 |
75 |
45
- 114 |
393 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring
Results in this Reporting Period
Month |
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
June 2016 |
ASR 8A |
45 |
40
– 50 |
178 |
260 |
ASR 9 |
46 |
40
– 56 |
178 |
260 |
|
July 2016 |
ASR 8A |
46 |
43
– 50 |
178 |
260 |
ASR 9 |
55 |
42
– 102 |
178 |
260 |
|
August 2016 |
ASR 8A |
48 |
44
– 53 |
178 |
260 |
ASR 9 |
59 |
45
– 101 |
178 |
260 |
The major dust sources in the reporting period include
construction activities under the Contract as well as nearby traffic emissions.
In this reporting period, a total of 18 monitoring
events were undertaken within the reporting period, in which no Action or Limit
Level exceedance for 1-hour and 24-hour TSP for air quality was recorded during
the reporting period.
The baseline noise monitoring undertaken by the HZMB
Projects during the period of 18 October to 1 November 2011 included the
monitoring station NSR1 for this Project.
Thus, the baseline monitoring results and Action/ Limit Level presented
in HZMB Baseline Monitoring Report ([2])
are adopted for this Project.
In accordance with the Updated EM&A Manual, impact
noise monitoring should be conducted once per week during the construction
phase of the Contract.
Noise monitoring was conducted at the alternative
noise monitoring station, NSR1A (Pak Mong Village
Pavilion) during the reporting period in accordance with the requirement of
Updated EM&A Manual. Figure 2.2 shows the location of the monitoring
station. Table 2.5 describes the details of the monitoring station.
Noise monitoring was performed sound level meter at the
designated monitoring station in the reporting quarter. The deployed sound level meter complies with
the International Electrotechnical Commission Publications
(IEC) 651:1979 (Type 1) and 804:1985 (Type 1) specifications. Acoustic calibrator was deployed to check the
sound level meter at a known sound pressure level. Brand
and model of the equipment is given in
Table 2.6.
Table 2.5 Location of Impact Noise Monitoring
Station and Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Period |
Location |
Parameters & Frequency |
NSR1A |
1, 7, 13,
16, 22 and 28 June 2016 4, 7, 13,
19, 25 and 29 July 2016 3, 9, 15,
18, 24 and 30 August 2016 |
Pak Mong Village Pavilion |
30-mins
measurement at each monitoring station between 0700 and 1900 on normal
weekdays (Monday to Saturday). Leq, L10
and L90 would be recorded. At
least once a week |
Note: (1)
Noise Monitoring Station NSR1 at Pak Mong Village proposed in accordance with the Updated
EM&A was relocated to NSR1A. |
Table 2.6 Noise Monitoring Equipment
Equipment |
Brand and Model |
Integrated
Sound Level Meter |
Rion
NL-31 |
Acoustic
Calibrator |
Rion
NC-73 |
The Action and Limit levels of the noise monitoring are
provided in Appendix D. The Event and Action plan is presented in Appendix J.
The schedules for noise monitoring in the reporting
quarter are provided in Appendix E.
The monitoring results for noise monitoring are
summarized in Table 2.7. Monitoring results are presented graphically
in Appendix G and detailed impact noise monitoring results
are reported in the Thirty-second to Thirty-fourth Monthly EM&A Reports.
Table 2.7 Summary of Construction Noise Monitoring
Results at NSR1A in the Reporting Period
Month |
Average , dB(A), Leq (30mins) |
Range, dB(A), Leq (30mins) |
Limit Level, dB(A), Leq (30mins) |
June 2016 |
59 |
59
- 60 |
75 |
July 2016 |
59 |
56
- 60 |
75 |
August 2016 |
60 |
58
- 62 |
75 |
The baseline water quality monitoring undertaken by
the HZMB Projects between 6 and 31 October 2011 included all monitoring
stations except SR4a for the Project.
Thus, the baseline monitoring results except for station SR4a and
Action/Limit Level presented in HZMB Baseline Monitoring Report ([3])
are adopted for this Project. Baseline
water quality monitoring was conducted at station SR4a from 29 August to 24
September 2013.
Table 2.8 Locations of Water Quality Monitoring
Stations and the Corresponding Monitoring Requirements
Station ID |
Type |
Coordinates |
*Parameters,
unit |
Depth |
Frequency |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)9 |
Impact Station (Close to HKBCF construction site) |
813273 |
818850 |
Temperature(°C) pH(pH unit) Turbidity (NTU) Water depth (m) Salinity (ppt) Dissolved Oxygen (DO) (mg/L and % of saturation) ·
Suspended Solid
(SS) (mg/L) |
3 water depths: 1m below sea surface, mid-depth and 1m above sea bed. If the water depth is less than 3m,
mid-depth sampling only. If water
depth less than 6m, mid-depth may be omitted. |
Impact monitoring: 3 days
per week, at mid-flood and mid-ebb tides during the construction period of
the Contract. |
IS(Mf)16 |
Impact
Station (Close to HKBCF construction site) |
814328 |
819497 |
|||
IS8 |
Impact
Station(Close to HKBCF construction site) |
814251 |
818412 |
|||
SR4 |
Sensitive
receiver (Tai Ho Inlet) |
814760 |
817867 |
|||
SR4a |
Sensitive
receiver |
815247 |
818067 |
|||
CS(Mf)3 |
Control
Station |
809989 |
821117 |
|||
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|||
Notes: In addition to the parameters presented
monitoring location/position, time, water depth, sampling depth, tidal
stages, weather conditions and any special phenomena or works underway nearby
were also recorded. |
Table 2.9 summarizes the equipment
used in the impact water quality monitoring programme.
Table
2.9 Water Quality Monitoring
Equipment
Equipment |
Brand and Model |
DO, Temperature meter and Salinity |
YSI Pro2030 |
Turbidimeter |
HACH Model 2100Q |
pH meter
|
Thermo Scientific Orion 2 Star |
Positioning Equipment |
Koden913MK2 with KBG-3 DGPS antenna |
Water Depth Detector |
Speedtech Instrument SM-5 |
Water Sampler |
Kemmerer 1520 (1520-C25) 2.2L with messenger |
The schedules for water quality monitoring in the
reporting quarter are provided in Appendix E. The water quality monitoring was cancelled on
2 August 2016 due to adverse weather.
Impact water quality monitoring was conducted at all
designated monitoring stations in the reporting period. Monitoring results are presented graphically
in Appendix H and detailed impact water quality monitoring
results were reported in the Thirty-second
to Thirty-fourth Monthly EM&A
Reports.
In this reporting period, a total of 38 monitoring
events were undertaken
with no Action Level and Limit Level exceedance recorded at the monitoring
station in the reporting period. No
action is thus required to be undertaken in accordance with the Event Action
Plan presented in Appendix J.
Impact dolphin monitoring is required to be conducted
by a qualified dolphin specialist team to evaluate whether there have been any
effects on the dolphins. In order to
fulfil the EM&A requirements and make good use of available resources, the
on-going impact line transect dolphin monitoring data collected by HyD’s Contract No. HY/2011/03 Hong
Kong-Zhuhai-Macao Bridge. Hong Kong Link Road - Section between Scenic
Hill and Hong Kong Boundary Crossing Facilities on the monthly basis is
adopted to avoid duplicates of survey effort.
Table 2.10 summarizes
the equipment used for the impact dolphin monitoring.
Table 2.10 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) Camera Laser Binoculars Marine Binocular Vessel for
Monitoring |
Garmin 18X-PC Geo One Phottix Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens Infinitor LRF 1000 Bushell 7 x 50 marine binocular with compass and reticules 65 foot single engine motor vessel with viewing platform 4.5m above
water level |
Dolphin monitoring should cover all transect lines in Northeast
Lantau (NEL) and the Northwest Lantau (NWL) survey areas twice per month
throughout the entire construction period. The monitoring data should be compatible with,
and should be made available for, long-term studies of small cetacean ecology
in Hong Kong. In order to provide a suitable
long-term dataset for comparison, identical methodology and line transects
employed in baseline dolphin monitoring was followed in the impact dolphin
monitoring.
The impact dolphin monitoring was carried out in the
NEL and NWL along the line transect as depicted in Figure 2.4. The co-ordinates of all transect lines are
shown in Table 2.11 below.
Table 2.11 Impact Dolphin Monitoring Line Transect
Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
814456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805475 |
815913 |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805477 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
819435 |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
819771 |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
820220 |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
820466 |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
820880 |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
820872 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
|
|
|
|
12 |
End
Point |
815542 |
824882 |
|
|
|
|
The Action and Limit levels of dolphin impact
monitoring are shown in Appendix D. The Event and Action plan is presented in Appendix J.
The dolphin monitoring schedules for the reporting
period are shown in Appendix E.
A total of 897.06 km of survey effort was collected, with 92.5% of the
total survey effort being conducted under favourable
weather conditions (i.e. Beaufort Sea State 3 or below with good
visibility). Among the two areas, 341.80 km and 555.26 km
of survey effort were conducted in NEL and NWL survey areas respectively. The total survey effort conducted on primary lines
was 648.70 km, while the effort on secondary lines was 248.36 km. Survey
effort conducted on both primary and secondary lines were considered as
on-effort survey data. The survey
efforts are summarized in Appendix I.
During the six sets of monitoring surveys in June to August
2016, a total of ten
(10) groups of 34 Chinese White Dolphins were sighted. Seven (7) dolphin sightings were made on
primary lines during on-effort search. In
this quarterly period, all dolphin groups were sighted in NWL, except one
off-effort sighting of one dolphin was sighted in NEL. Summary table of the dolphin sightings is
shown in Appendix I.
Encounter rates of Chinese White Dolphins deduced from
the survey effort and on-effort sighting data from the primary transect lines
under favourable conditions (Beaufort 3 or below) in
the reporting period with the results presented in Tables 2.12 and 2.13.
Table 2.12 Individual Survey Event Encounter Rates
Survey Area |
Survey
period |
Encounter rate (STG) (no. of
on-effort dolphin sightings per 100 km of survey effort) |
Encounter rate (ANI) (no. of
dolphins from all on-effort sightings per 100 km of survey effort) |
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: 1st / 6th
Jun 2016 |
0.0 |
0.0 |
Set 2: 13th / 17th
Jun 2016 |
0.0 |
0.0 |
|
Set 3: 5th /12th
Jul 2016 |
0.0 |
0.0 |
|
Set 4: 18th / 27th
Jul 2016 |
0.0 |
0.0 |
|
Set 5: 5th / 9th
Aug 2016 |
0.0 |
0.0 |
|
Set 6: 17th /23rd
Aug 2016 |
0.0 |
0.0 |
|
NWL |
Set 1: 1st / 6th
Jun 2016 |
0.0 |
0.0 |
Set 2: 13th / 17th
Jun 2016 |
0.0 |
0.0 |
|
Set 3: 5th /12th
Jul 2016 |
4.6 |
9.2 |
|
Set 4: 18th / 27th
Jul 2016 |
0.0 |
0.0 |
|
Set 5: 5th / 9th
Aug 2016 |
4.2 |
28.3 |
|
Set 6: 17th /23rd
Aug 2016 |
1.5 |
7.4 |
Note: Dolphin
Encounter Rates are deduced from the six sets of surveys (two surveys in each
set) in the reporting period in Northeast (NEL) and Northwest Lantau (NWL)
Table 2.13 Quarterly Average Encounter Rates
Survey Area |
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
||
June – August 2016 |
September -November 2011 |
June – August 2016 |
September -November 2011 |
|
Northeast
Lantau |
0.0 |
6.00 ± 5.05 |
0.0 |
22.19 ± 26.81 |
Northwest
Lantau |
1.72 ± 2.17 |
9.85 ± 5.85 |
7.48 ± 10.98 |
44.66 ± 29.85 |
Note: encounter rates deduced from the baseline
monitoring period (September – November 2011) have been recalculated based only
on survey effort and on-effort sighting data made along the primary transect
lines under favourable conditions
Table 2.14 Comparison of Quarterly Average Group
Sizes
|
Average Dolphin Group Size |
|
June - August 2016 |
September - November 2011 |
|
Overall |
3.40 ± 3.34 (n = 10) |
3.72 ± 3.13 (n = 66) |
Northeast Lantau |
1.00 (n = 1) |
3.18 ± 2.16 (n = 17) |
Northwest Lantau |
3.67 ± 3.43 (n = 9) |
3.92 ± 3.40 (n = 49) |
Although the dolphins infrequently occurred along the
alignment of TM-CLKL Southern Connection Viaduct in the past and during the
baseline monitoring period, it is apparent that dolphin usage has been
significantly reduced in NEL, and many individuals have shifted away from the
important habitat around the Brothers Islands.
Daily
marine mammal exclusion zone monitoring was undertaken during the period of
marine works under this Contract. No
sighting of the Indo-Pacific humpback dolphin Sousa chinensis (i.e. Chinese White
Dolphin) was recorded in the monitoring period during the exclusion zone
monitoring.
Passive Acoustic Monitoring (PAM) was
decommissioned in this reporting period as no marine piling works was carried
out outside the daylight hours since September 2015. Daytime marine mammal exclusion zone was
still in effect to cater for temporary staging installation and uninstallation
works.
Site inspections were carried out on a weekly basis to
monitor the implementation of proper environmental pollution control and
mitigation measures under the Contract. Thirteen (13) site inspections were carried
out in the reporting quarter on 1, 6, 15, 24 and 30 June 2016, 6, 13, 20 and 28
July 2016, 4, 10, 17 and 25 August 2016.
Key observations during the site inspections in this
reporting period are summarized in Table
2.15.
Table 2.15 Specific Observations Identified during
the Weekly Site Inspection in this Reporting Period
Inspection Date |
Location & Environmental Observations |
Recommendations/ Remarks |
1 June 2016 |
Abutment D
Excessive soil was found in drainage outside site access. Near Pier D18
Contact person for wetsep was not displayed.
Stagnant water was accumulated in a drip tray for chemical container.
A chemical container was not placed in drip tray.
A drip tray for generator was not plugged. Landing area of Abutment D
The land was partially dry.
Stagnant water was accumulated in a drip tray for chemical container. A chemical container was not placed in drip tray. |
Abutment D
Excessive soil should be cleaned up regularly Near Pier D18
Contact person for wetsep should be
displayed.
Stagnant water in a drip tray should be cleaned up regularly.
Chemical container should be placed in drip tray.
Drip tray should be plugged. Landing area of Abutment D
Watering should be applied regularly to avoid dust emission.
Stagnant water in a drip tray should be cleaned up regularly. Chemical container should be placed in drip tray. |
6 June 2016 |
Area 1
A chemical container was not placed in drip tray. Refuse was found in drainage. Equipment was placed too close to natural
habitat.
Oil stain was found on the ground. |
Area 1
Chemical container should be placed in drip tray. Refuse in drainage should be cleaned up
regularly. Equipment should be placed away from natural
habitat. Oil stain should be removed. |
15 June 2016 |
Pier E5 A chemical container was not placed in drip tray. A drip tray for generator was not plugged. |
Pier E5 Chemical
container should be placed in drip tray. Drip
tray should be plugged. |
24 June 2016 |
Pier E8 Waste was not properly stored. A drip tray for generator was not plugged. Surface runoff control along edge of pile cap was
insufficient. |
Pier E8 Waste
should be cleaned up regularly. Drip
tray should be plugged. Toe
board or sand bag should be provided at the edge to avoid runoff. |
30 June 2016 |
Pier E8 Waste was not properly stored. A drip tray for generator was not plugged. |
Pier E8 Waste
should be cleaned up regularly. Drip
tray should be plugged. |
6 July 2016 |
Abutment D
Refuse and excessive soil were found in the drainage outside entrance.
A drip tray was not plugged. Stagnant water was accumulated in a drip tray. |
Abutment D
Refuse and excessive soil in the drainage should be cleaned up
regularly.
Drip tray should be plugged. Stagnant water accumulated in drip tray should be
cleaned up regularly. |
13 July 2016 |
Seafront Chemical containers were not placed in drip tray. Oil stain was found on the ground. |
Seafront Chemical containers should be placed in drip
tray. Oil stain should be removed. |
20 July 2016 |
Southern
landfall A chemical container was not placed in drip tray. The
land was partially dry. The
label for general fill storage was not displayed. The
checklist for a wetsep was not displayed. |
Southern
landfall Chemical container should be placed in drip tray. Watering
should be applied regularly. General
fill storage should be properly labelled. Checklist
for wetsep should be displayed. |
28 July 2016 |
Pier E1 A chemical container was not placed in drip tray. The gutter was not properly installed. Pier C18 The soil stockpile was not well covered. The unpaved area was partially dry. |
Pier E1 Chemical container should be placed in drip tray. Gutter should be properly installed. Pier C18 The soil stockpile should be well covered. Watering should be applied regularly. |
4 August
2016 |
Pier E12
A chemical container was not placed in drip tray. Pier E4
2 chemical containers were not placed in drip tray.
The gutter was not properly installed. |
Pier E12
Chemical containers should be placed in drip tray. E4
Chemical containers should be placed in drip tray. Gutter should be properly installed. |
10 August
2016 |
Area 4 A chemical container was not placed in drip tray. Pier C12 Label
for a chemical container was missing. Refuse
was not properly stored. Pier C14 Stagnant
water was accumulated in drip tray. Area 2 Soil stockpile was not well covered. |
Area 4
Chemical containers should be placed in drip tray. Pier C12 Label
for chemical container should be properly displayed. Refuse
should be properly stored. Pier C14 Stagnant
water accumulated in drip tray should be removed. Area 2 Soil stockpile should be well covered. |
17 August
2016 |
Seafront
area Oil stain was found on the ground. A
drip tray for chemical container was not plugged. Pier E6 Surface
runoff control was insufficient. The
gutter was not properly installed. Excessive
soil was found in gutter. |
Seafront
area Oil stain on the ground should be removed. A
drip tray for chemical container should be plugged. Pier E6 Sandbag
or toe board should be provided for surface runoff control. The
gutter should be properly installed. Excessive
soil in gutter should be removed. |
25 August
2016 |
Pier E4 Refuse was found in gutter. Pier D14 The unpaved area was dry. Grouting material was not well covered. Some chemical containers were not placed in drip
tray. |
Pier E4 Refuse in gutter should be cleaned up regularly. Pier D14 The unpaved area should be watered regularly Grouting material should be well covered. Chemical containers should be placed in drip
tray. |
Wastes generated during this reporting period include
mainly construction wastes (inert and non-inert) and recyclable materials. Reference has been made to the waste flow
table prepared by the Contractor (Appendix K). The quantities of different types of wastes
are summarized in Table 2.16.
Table 2.16 Quantities of Different Waste Generated in
the Reporting Period
Month / Year |
Inert Construction Waste (a)
(m3) |
Imported Fill (m3) |
Inert Construction Waste
Re-used (m3) |
Non-inert Construction Waste (b)
(kg) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
||||||||
Category L |
Category M |
||||||||||||||
June
2016 |
383 |
0 |
116 |
103,270 |
105 |
0 |
0 |
0 |
|
||||||
July
2016 |
277 |
0 |
230 |
94,760 |
1,890 |
2,200 |
0 |
0 |
|
||||||
August
2016 |
610 |
0 |
684 |
116,990 |
9,888 |
0 |
0 |
0 |
|
||||||
Total |
1270 |
0 |
1030 |
315020 |
11883 |
2000 |
0 |
0 |
|
||||||
Notes: |
|||||||||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
|||||||||||||||
The Contractor was advised to properly maintain on
site C&D materials and waste collection, sorting and recording system,
dispose of C&D materials and wastes at designated ground and maximize
reuse/ recycle of C&D materials and wastes.
The Contractor was also reminded to properly maintain the site tidiness
and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was
reminded to treat properly and store temporarily in designated chemical waste
storage area on site in accordance with the Code
of Practice on the Packaging, Labelling and Storage of Chemical Wastes.
The status of environmental licensing and permit is
summarized in Table 2.17 below.
Table 2.17 Summary of Environmental Licensing and
Permit Status
License/ Permit |
License or Permit No. |
Date of
Issue |
Date of
Expiry |
License/
Permit Holder |
Remarks |
Environmental Permit |
EP-353/2009/K |
11-Apr-16 |
N/A |
HyD |
Hong Kong Boundary Crossing
Facilities |
Environmental Permit |
EP-354/2009/D |
13-Mar-15 |
N/A |
HyD |
Tuen Mun-
Chek Lap Kok Link |
Construction Dust Notification |
361571 |
05-Jul-13 |
N/A |
GCL |
|
Construction Dust Notification |
362093 |
17-Jul-13 |
N/A |
GCL |
For Area 23 |
Chemical Waste Registration |
5213-951-G2380-17 |
12-Jun-14 |
N/A |
GCL |
Viaducts A, B, C, D & E |
Chemical Waste Registration |
5213-961-G2380-13 |
10-Oct-13 |
N/A |
GCL |
Chemical waste produced in
Contract No. HY/2012/07 (Area 1
adjacent to Cheng Tung Road, Siu Ho Wan) |
Chemical Waste Registration |
5213-961-G2380-14 |
10-Oct-13 |
N/A |
GCL |
Chemical waste produced in
Contract No. HY/2012/07 (Area 2
adjacent to Cheung Tung Road, Pak Mong Village) |
Chemical Waste Registration |
5213-974-G2588-03 |
04-Nov-13 |
N/A |
GCL |
Chemical waste produced in
Contract No. HY/2012/07 (WA5 adjacent
to Cheung Tung Road, Yam O) |
Construction
Waste Disposal Account |
7017735 |
10-Jul-13 |
N/A |
GCL |
- |
Construction
Waste Disposal Account |
7019470 |
03-Mar-14 |
N/A |
GCL |
Vessel CHIT Account |
Waste Water Discharge License |
WT00019017-2014 |
13-May-14 |
31-May-19 |
GCL |
Discharge for marine portion |
Waste Water Discharge License |
WT00019018-2014 |
13-May-14 |
31-May-19 |
GCL |
Discharge for land portion |
Construction Noise Permit for
night works and works in general holidays |
GW-RS0109-16 |
05-Feb-16 |
14-Aug-16 |
GCL |
Pre-casted pile cap shell
installation at E10-E13 |
Construction Noise Permit for
night works and works in general holidays |
GW-RS0383-16 |
20-Apr-16 |
19-Oct-16 |
GCL |
For Broad Permit |
Construction Noise Permit for
night works and works in general holidays |
GW-RS0718-16 |
13-Jul-16 |
13-Jan-17 |
GCL |
Pre-casted pile cap shell
installation at E10-E13 |
Construction Noise Permit for
night works and works in general holidays |
GW-RW0339-16 |
17-Jun-16 |
19-Dec-16 |
GCL |
General works at WA5 |
Construction Noise Permit for
night works and works in general holidays |
GW-RW0504-16 |
25-May-16 |
31-Aug-16 |
GCL |
Broad Permit for Segment
Launching at Land Portion |
Construction Noise Permit for
night works and works in general holidays |
GW-RW0707-16 |
11-Jul-16 |
30-Sep-16 |
GCL |
Broad Permit for Segment
Launching at Land Portion |
Marine
Dumping Permit |
EP/MD/17-037 |
14-Jun-16 |
13-Dec-16 |
GCL |
For dumping Type I sediment |
Marine
Dumping Permit |
EP/MD/17-047 |
22-Jun-16 |
31-Jul-16 |
GCL |
For dumping Type I (Dedicated
Site) and Type II sediment |
Marine
Dumping Permit |
EP/MD/17-066 |
19-Jul-16 |
31-Aug-16 |
GCL |
For dumping Type I (Dedicated
Site) and Type II sediment |
Table 2.18 Comparison between Quarterly Mean and
Ambient Mean Values of Depth-averaged Suspended Solids
Station |
Baseline Mean |
Ambient Mean (a) |
Quarterly
Mean (June to August 2016) |
|||
Mid-ebb |
Mid-flood |
Mid-ebb |
Mid-flood |
Mid-ebb |
Mid-flood |
|
CS(Mf)3 |
9.2 |
12.8 |
12.0 |
16.6 |
13.3 |
12.8 |
CS(Mf)5 |
9.2 |
11.5 |
11.9 |
14.9 |
13.0 |
12.8 |
SR4 |
10.3 |
12.3 |
13.4 |
16.0 |
12.8 |
12.7 |
SR4a |
9.1 |
9.8 |
11.9 |
12.7 |
12.8 |
12.4 |
IS8 |
11.3 |
13.5 |
14.6 |
17.6 |
12.9 |
12.7 |
IS(Mf)9 |
10.9 |
14.3 |
14.2 |
18.5 |
12.8 |
12.6 |
IS(Mf)16 |
11.4 |
10.3 |
14.8 |
13.4 |
13.1 |
12.7 |
Notes: |
||||||
(a) Ambient mean value is defined as a 30%
increase of the baseline mean value |
One (1) Limit Level exceedance was recorded for impact
dolphin monitoring in this reporting quarter.
Following the review of the monitoring data and marine works details as
per the procedure stipulated in the Event and Action Plan of the Updated
EM&A Manual, no unacceptable impact was associated with the construction
works under this Contract that may have affected the dolphin usage in the North
Lantau region. Investigation findings
were detailed in Appendix L.
September 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
October 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
November 2016
Marine Works
· Uninstallation
of marine piling platform;
· Pier
construction;
· Launching
gantry operation; and
· Installation
of deck segment and pier head segment.
Land-based Works
· Pier
construction;
· Re-alignment
of Cheung Tung Road;
· Road
works along North Lantau Highway;
· Installation
of pier head and deck segments; and
· Slope
work of Viaducts A, B & C.
Potential environmental impacts arising from the above
upcoming construction activities are mainly associated with air quality, noise,
marine water quality, marine ecology and waste management issues.
Impact monitoring for air quality, noise, marine
water quality and dolphin monitoring are scheduled to continue for the next
reporting period.
The monitoring programme has
been reviewed and was considered as adequate to cater for
the nature of works in progress.

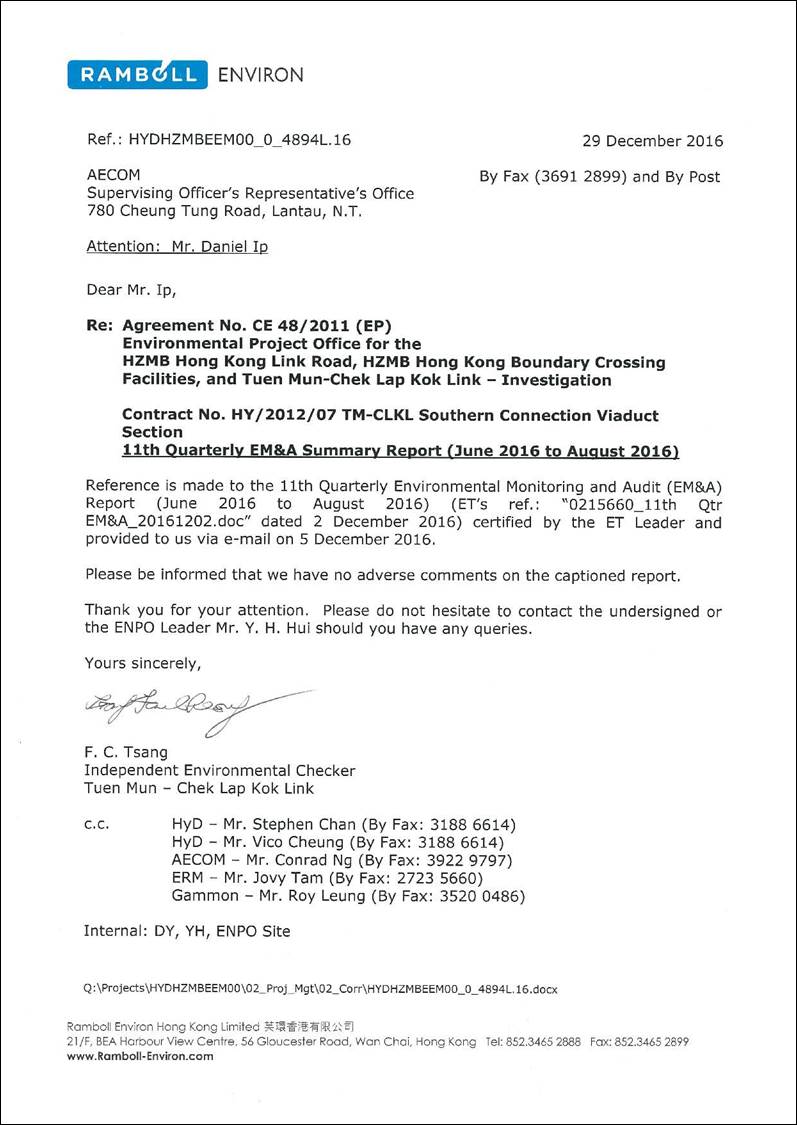

The Eleventh Quarterly EM&A Report presents the
findings of the EM&A activities undertaken during the period from 1 June to
31 August 2016, in accordance with the Updated EM&A Manual and the
requirements of the Environmental Permits
(EP-354/2009/D and EP-353/2009/K).
Neither Action Level nor
Limit Level exceedances were observed for air quality, noise and water quality monitoring
in this reporting period.
A total of ten (10)
groups of thirty-four (34) Chinese White Dolphins were sighted during the six
sets of survey from June to August 2016.
One (1) Limit Level exceedance was recorded for the quarterly dolphin
monitoring data between June and August 2016, no unacceptable impact from the
activities of this Contract on Chinese White Dolphins was noticeable from the general
observations. It is critical to monitor
the dolphin usage in North Lantau region in the upcoming quarters, to determine
whether the dolphins are continuously affected by the various construction
activities in relation to the HZMB-related works, and whether suitable
mitigation measure can be applied to revert the situation.
Environmental site inspection was carried out 13 times
in the reporting period. Recommendations
on remedial actions were given to the Contractor for the deficiencies
identified during the site audits.
There was no environmental
complaint, notification of summon or successful prosecution in the reporting
period.
The monitoring programme
has been reviewed and was considered as adequate to cater for the nature of
works in progress. Change
to the monitoring programme was thus not recommended at this stage. The monitoring programme will be evaluated as
appropriate in the next reporting period.
The ET will keep track on the construction works to confirm compliance
of environmental requirements and the proper implementation of all necessary
mitigation measures.
([1])
Agreement No. CE 35/2011 (EP) Baseline
Environmental Monitoring for Hong Kong - Zhuhai - Macao Bridge Hong Kong
Projects - Investigation. Baseline Environmental Monitoring Report (Version C). Submitted on 8 March 2012 and subsequently
approved by EPD.
