Executive Summary

Under Contract No. HY/2012/08, Dragages ¡V Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Northern Connection Sub-sea Tunnel Section of the Tuen Mun ¡V Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer.  For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET) in accordance with Environmental Permit No. EP-354/2009/A.  ENVIRON Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO).

The construction phase of the Project under the EP-354/2009/A commenced on 1 November 2013 and will tentatively be completed by the end of 2018.  The impact monitoring of the EM&A programme, including air quality, water quality, marine ecological monitoring and environmental site inspections, were commenced on 1 November 2013.

This is the second monthly EM&A report presenting the EM&A works carried out during the period from 1 to 31 December 2013 for the Contract No. HY/2012/08 Northern Connection Sub-sea Tunnel Section (the ¡§Project¡¨) in accordance with the Updated EM&A Manual of the TM-CLK Link Project.  As informed by the Contractor, major activities in the reporting period included:

Marine-based Works

¡P      Removal of existing seawall;

¡P      Dredging;

¡P      Placement of rock grade 400; and,

¡P      Delivery of 1,797 seawall blocks.

Land-based Works

¡P      Sorting of rock material started at Tsing Yi (Site WA 23);

¡P      Completion of site office structural works (Site WA 18); and

¡P      Temporary outdoor substation civil works (Site WA 18).

A summary of monitoring and audit activities conducted in the reporting period is listed below:

24-hour TSP Monitoring                       5 sessions

1-hour TSP Monitoring                                   5 sessions

Impact Water Quality Monitoring                   13 sessions

Impact Dolphin Monitoring                             2 sessions

Joint Environmental Site Inspection     5 sessions

Daily marine mammal exclusion zone monitoring was undertaken during the period of dredging works.  No sighting of the Indo-Pacific humpback dolphin Sousa chinensis was recorded in December 2013 during the exclusion zone monitoring.

Summary of Breaches of Action/Limit Levels

Breaches of Action and Limit Levels for Air Quality

Fourteen Action Level excedances and two Limit Level exceedances for air quality were recorded during the reporting month.  The exceedances were considered not related to the construction works of this Contract upon further investigation.

Breaches of Action and Limit Levels for Water Quality

Five Action Level exceedances of depth-averaged suspended solids were recorded during the reporting month.  The exceedances were considered not related to the construction works of this Contract upon further investigation.

Dolphin Monitoring

During this month of dolphin monitoring, no unacceptable impact from the construction activities of the TM-CLKL Northern Connection Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from general observations. Due to monthly variation in dolphin occurrence within the study area, it would be more appropriate to draw conclusion on whether any unacceptable impacts on dolphins have been detected related to the construction activities of the TM-CLKL Northern Connection Sub-sea Section in the quarterly EM&A reports, where comparison on distribution, group size and encounter rates of dolphins between the quarterly impact monitoring period and baseline monitoring period will be made.

Environmental Complaints, Non-compliance & Summons

No non-compliance with EIA recommendations, EP conditions and other requirements associated with the construction of this Contract was recorded in this reporting period.

No environmental complaint was received in this reporting period.

No environmental summons was received in this reporting period.


Reporting Change

There was no reporting change required in the reporting period.



Upcoming Works for the Next Reporting Period

Works to be undertaken in the next monitoring period of January 2014 include the following:

Marine-based Works

¡P      Seawall construction;

¡P      Removal of existing seawall armour rock;

¡P      Temporary seawall;

¡P      Additional Ground investigation;

¡P      Reclamation; and

¡P      Temporary pontoon installation at River Trade Terminal (RTT).

Land-based Works

¡P      Presonstruction for site office (WA 18);

¡P      Hoarding erection & building demolition (Portion N6); and

¡P      CLP substation construction (Portion N6).

Future Key Issues

Potential environmental impacts arising from the above upcoming construction activities in the next reporting month of January 2014 are expected to be mainly associated with dust, marine water quality, marine ecology and waste management.


1                                             Introduction

1.1                                      Background

According to the findings of the Northwest New Territories (NWNT) Traffic and Infrastructure Review conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be operating beyond capacity after 2016.  This forecast has been based on the estimated increase in cross boundary traffic, developments in the Northwest New Territories (NWNT), and possible developments in North Lantau, including the Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong ¡V Zhuhai ¡V Macao Bridge (HZMB).  In order to cope with the anticipated traffic demand, two new road sections between NWNT and North Lantau ¡V Tuen Mun ¡V Chek Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.

An Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental Impact Assessment Process (EIAO-TM).  The EIA Report was submitted under the Environmental Impact Assessment Ordinance (EIAO) in August 2009.  Subsequent to the approval of the EIA Report (EIAO Register Number AEIAR-145/2009), an Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4 November 2009, and EP variation (EP-354/2009A) was issued on 8 December 2010.

Under Contract No. HY/2012/08, Dragages ¡V Bouygues Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the design and construction of the Northern Connection Sub-sea Tunnel Section of TM-CLKL (¡§the Contract¡¨) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer.  For implementation of the environmental monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental Team (ET) in accordance with Environmental Permit No. EP-354/2009/A.  ENVIRON Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC) and Environmental Project Office (ENPO).

Layout of the Contract components is presented in Figure 1.1.

The construction phase of the Contract commenced on 1 November 2013 and will tentatively be completed by 2018.  The impact monitoring phase of the EM&A programme, including air quality, water quality, marine ecological monitoring and environmental site inspections, were commenced on 1 November 2013.



1.2                                      Scope of Report

This is the second Monthly EM&A Report under the Contract No. HY/2012/08 Tuen Mun ¡V Chek Lap Kok Link ¡V Northern Connection Sub-sea Tunnel Section.  This report presents a summary of the environmental monitoring and audit works in December 2013.

1.3                                      Organization Structure

The organization structure of the Contract is shown in Appendix A.  The key personnel contact names and contact details are summarized in Table 1.1 below.

Table 1.1        Contact Information of Key Personnel

Party

Position

Name

Telephone

Fax

SOR

(AECOM Asia Company Limited)



Chief Resident Engineer

Edwin Ching



Andrew Westmoreland



2450 3111



2450 3511

2450 3099



2450 3099

ENPO / IEC

(ENVIRON Hong Kong Ltd.)

ENPO Leader



Y.H. Hui

3465 2888

3465 2899

IEC



Tony Cheng

3465 2888

3465 2899

Contractor

(Dragages ¡V Bouygues Joint Venture)

Environmental Manager



C.F. Kwong

2293 7322

2670 2798

Environmental Officer



24hour complaint hotline



Bryan Lee





Rachel Lam

2293 7323





2293 7342

2670 2798

ET (ERM-HK)

ET Leader

Jovy Tam

2271 3113

2723 5660

1.4                                      Summary of Construction Works

The construction phase of this Contract was commenced on 1 November 2013.  The three-month rolling construction programme is shown in Appendix B.

As per DBJV¡¦s information, details of major construction works carried out in this reporting period are as follows:

Marine-based Works

¡P      Removal of existing seawall;
¡P      Dredging;
¡P      Placement of rock grade 400; and
¡P      Delivery of 1,797 seawall blocks.

Land-based Works

¡P      Sorting of rock material started at Tsing Yi (Site WA 23);
¡P      Completion of site office structural works (Site WA 18); and

¡P      Temporary outdoor substation civil works (Site WA18).

The general layout plan of the site showing the detailed works areas is shown in Figure 1.2.

The implementation schedule of environmental mitigation measures is presented in Appendix C.

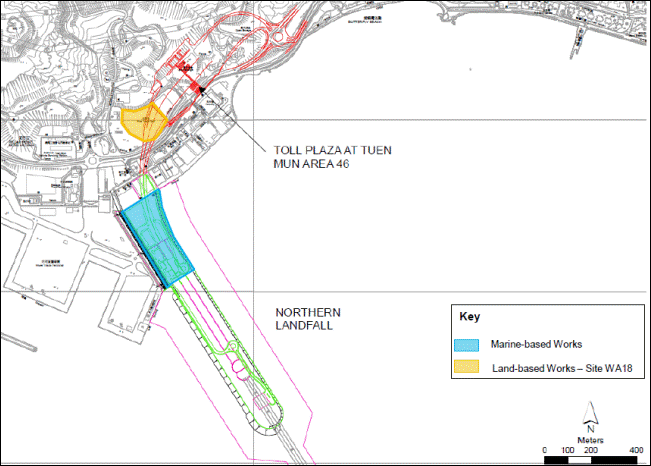

Figure 1.2       Locations of Construction Activities - December 2013

  1. Tuen Mun ¡V Site WA 18 and marine-land based works area



Land-based Works at Site WA 23

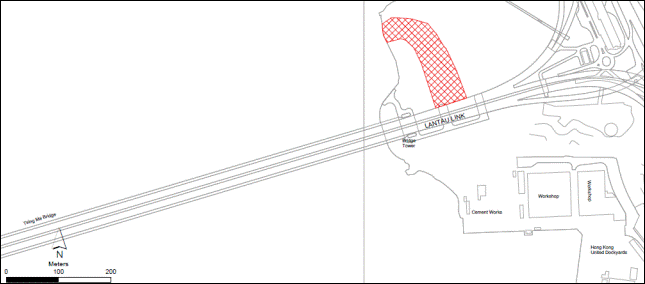

  1. Tsing Yi ¡V Site WA 23





2                                             EM&A Results

The EM&A programme required environmental monitoring for air quality, water quality and marine ecology as well as environmental site inspections for air quality, water quality, waste management, marine ecology and landscape and visual impacts.  The EM&A requirements and related findings for each component are summarized in the following sections

2.1                                      Air quality

2.1.1                               Monitoring Requirements and Equipment

In accordance with the Updated EM&A Manual, impact 1-hour TSP monitoring was conducted three (3) times every six (6) days and impact 24-hour TSP monitoring was carried out once every six (6) days when the highest dust impact was expected.  The Action and Limit Levels of the air quality monitoring is provided in Appendix D.

High volume samplers (HVSs) were used to carry out the 1-hour and 24-hour TSP monitoring on 5, 11, 17, 23 and 28 December 2013 at the five (5) air quality monitoring stations in accordance with the requirements stipulated in the Updated EM&A Manual (Figure 2.1; Table 2.1).  Wind anemometer was installed at the rooftop of ASR5 for logging wind speed and wind direction.  Details of the equipment deployed are provided in Table 2.2.  Copies of the calibration certificates for the equipment are presented in Appendix E.

Table 2.1        Locations of Impact Air Quality Monitoring Stations

Monitoring Station

Monitoring Dates

Location

Description

Parameters & Frequency

ASR1

5, 11, 17, 23 and 28 December 2013

Tuen Mun Fireboat Station

Office

Ÿ  1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3 times per day every 6 days

Ÿ  24-hour Total Suspended Particulates (24-hour TSP, µg/m3), daily for 24-hour every 6 days

ASR5



Pillar Point Fire Station

Office

AQMS1



Previous River Trade Golf

Bare ground

AQMS2*



Bare ground at Ho Suen Street

Bare ground

ASR10



Butterfly Beach Park

Recreational uses

*Notes: AQMS2 is being proposed as a temporary alternative station for monitoring since access to Butterfly Laundry is not granted to the ET at the moment to undertake the air quality monitoring.  Tentatively AQMS2 will be relocated and re-installed at ASR6 (butterfly Laundry) in Mid-January.  AQMS2 will then be superseded by ASR6 for the impact air quality monitoring.


Table 2.2        Air Quality Monitoring Equipment

Equipment

Brand and Model

High Volume Sampler
(1-hour TSP and 24-hour TSP)

Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170)



Wind Anemometer

MetPak, WindSonic

2.1.2                               Monitoring Schedule for the Reporting Month

The schedule for air quality monitoring in December 2013 is provided in Appendix F.

2.1.3                               Results and Observations

The monitoring results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4, respectively.  Detail impact air quality monitoring results and graphical presentations are presented in Appendix G.

Table 2.3        Summary of 1-hour TSP Monitoring Results in this Reporting Period

Station

Average (µg/m3)

Range (µg/m3)

Action Level  (µg/m3)

Limit Level  (µg/m3)

ASR 1

226

60 ¡V 474

331

500

ASR 5

255

43 ¡V 559

340

500

AQMS1

162

48 ¡V 261

335

500

AQMS2

234

56 ¡V 425

338

500

ASR10

172

51 ¡V 386

337

500

Table 2.4        Summary of 24-hour TSP Monitoring Results in this Reporting Period

Station

Average (µg/m3)

Range (µg/m3)

Action Level  (µg/m3)

Limit Level  (µg/m3)

ASR 1

170

58 - 249

213

260

ASR 5

196

54 ¡V 258

238

260

AQMS1

139

46 ¡V 195

213

260

AQMS2

175

68 ¡V 269

238

260

ASR10

121

43 ¡V 166

214

260

The major dust sources in the reporting period include construction activities under the Contract as well as nearby traffic emissions.

A total of five monitoring events were undertaken in which fourteen Action Level exceedances and two Limit Level exceedances of 1-hr TSP and 24-hr TSP were observed on 11, 23 and 28 December 2013.

The Event and Action plan is presented in Appendix K.

Meteorological information collected at the ASR5, including wind speed and wind direction, is provided in Appendix H.

2.2                                      Water Quality Monitoring

2.2.1                               Monitoring Requirements & Equipment

In accordance with the Updated EM&A Manual, impact water quality monitoring was carried out three days per week during the construction period at nine (9) water quality monitoring stations (Figure 2.2; Table 2.5).  The Action and Limit Levels of the water quality monitoring is provided in Appendix D.

Table 2.5        Locations of Water Quality Monitoring Stations and the Corresponding Monitoring Requirements

Station ID

Type

Coordinates

*Parameters, unit

Depth

Frequency





Easting

Northing







IS12

Impact Station

813218

823681

Ÿ Temperature(¢XC)

Ÿ pH(pH unit)

Ÿ Turbidity (NTU)

Ÿ Water depth (m)

Ÿ Salinity (ppt)

Ÿ DO (mg/L and % of

saturation)

¡P    SS (mg/L)

3 water depths: 1m

below sea surface,

mid-depth and 1m

above sea bed.  If the water depth is less than 3m, mid-depth sampling only.  If water depth less than 6m, mid-depth may be omitted.





Impact monitoring: 3 days per week, at mid-flood and mid-ebb tides during the construction period of the Contract.

IS13

Impact Station

813667

824325

IS14

Impact Station

812592

824172

IS15

Impact Station

813356

825008

CS4

Control / Far Field Station

810025

824004

CS6

Control / Far Field Station

817028

823992

SR8

Sensitive receiver (Gazettal beaches in Tuen Mun)

816306

825715

SR9

Sensitive receiver
(Butterfly Beach)

813601

825858

SR10A

Sensitive receiver
(Ma Wan FCZ)

823741

823495

*Notes:

In addition to the parameters presented monitoring location/position, time, water depth, sampling depth, tidal stages, weather conditions and any special phenomena or works underway nearby were also recorded.

Table 2.6 summarises the equipment used in the impact water quality monitoring programme.  Copies of the calibration certificates are attached in Appendix E.

Table 2.6        Water Quality Monitoring Equipment

Equipment

Model

Qty.

Water Sampler

Kahlsico Water-Bottle Model 135DW 150

4

Multi-parameter Water Quality System

YSI 6820-C-M/YSI 6920

6

Dissolved Oxygen Meter

YSI Pro 2030

1

pH Meter

HANNA HI 8314

1

Turbidity Meter

HACH 2100Q

1

Monitoring Position Equipment

¡§Magellan¡¨ Handheld GPS Model eXplorist GC

4

DGPS Koden KGP913MK2 (1)

1

2.2.2                               Action & Limit Levels

The Action and Limit Levels for water quality monitoring are summarized in Appendix D.

2.2.3                               Monitoring Schedule for the Reporting Month

The schedule for water quality monitoring in December 2013 is provided in Appendix F.

2.2.4                               Results and Observations

During this reporting period, marine dredging activities at Portion N-a continued from 1 November 2013.  A closed grab dredger was used and silt curtains (cage-type and single floating type) were deployed during dredging works.  The level of dredging activities was within the working rate described in the EP and approved EIA Report.  It is useful to note that heavy marine traffic (not associated with the Project) was commonly observed nearby the Project site and its vicinity.

Impact water quality monitoring was conducted at all designated monitoring stations in the reporting month.  Detailed impact water quality monitoring results are presented in Appendix G.

A total of thirteen monitoring events were undertaken in which five Action Level exceedances of depth-averaged SS were recorded on 4 and 6 December 2013.

2.3                                      Dolphin Monitoring

2.3.1                               Monitoring Requirements

Impact dolphin monitoring is required to be conducted by a qualified dolphin specialist team to evaluate whether there have been any effects on the dolphins.  In order to fulfil the EM&A requirements and make good use of available resources, the on-going impact line transect dolphin monitoring data collected by HyD¡¦s Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong Kong Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing Facilities on the monthly basis is adopted to avoid duplicates of survey effort.

2.3.2                               Monitoring Equipment

Table 2.8 summarises the equipment used for the impact dolphin monitoring.

Table 2.8        Dolphin Monitoring Equipment

Equipment

Model

Global Positioning System (GPS)



Camera



Laser Binoculars

Marine Binocular

Vessel for Monitoring

Garmin 18X-PC

Geo One Phottix

Nikon D90 300m 2.8D fixed focus

Nikon D90 20-300m zoom lens

Infinitor LRF 1000

Bushell 7 x 50 marine binocular with compass and reticules

65 foot single engine motor vessel with viewing platform 4.5m above water level




2.3.3                               Monitoring Parameter, Frequencies & Duration

Dolphin monitoring should cover all transect lines in Northeast Lantau (NEL) and the Northwest Lantau (NWL) survey areas twice per month throughout the entire construction period.  The monitoring data should be compatible with, and should be made available for, long-term studies of small cetacean ecology in Hong Kong.  In order to provide a suitable long-term dataset for comparison, identical methodology and line transects employed in baseline dolphin monitoring was followed in the impact dolphin monitoring.

2.3.4                               Monitoring Location

The impact dolphin monitoring was carried out in the NEL and NWL along the line transect as depicted in Figure 2.3.  The co-ordinates of all transect lines are shown in Table 2.9 below.


Table 2.9        Impact Dolphin Monitoring Line Transect Co-ordinates

Line No.

Easting

Northing

Line No.

Easting

Northing

1

Start Point

804671

814577

13

Start Point

816506

819480

1

End Point

804671

831404

13

End Point

816506

824859

2

Start Point

805475

815457

14

Start Point

817537

820220

2

End Point

805477

826654

14

End Point

817537

824613

3

Start Point

806464

819435

15

Start Point

818568

820735

3

End Point

806464

822911

15

End Point

818568

824433

4

Start Point

807518

819771

16

Start Point

819532

821420

4

End Point

807518

829230

16

End Point

819532

824209

5

Start Point

808504

820220

17

Start Point

820451

822125

5

End Point

808504

828602

17

End Point

820451

823671

6

Start Point

809490

820466

18

Start Point

821504

822371

6

End Point

809490

825352

18

End Point

821504

823761

7

Start Point

810499

820690

19

Start Point

822513

823268

7

End Point

810499

824613

19

End Point

822513

824321

8

Start Point

811508

820847

20

Start Point

823477

823402

8

End Point

811508

824254

20

End Point

823477

824613

9

Start Point

812516

820892

21

Start Point

805476

827081

9

End Point

812516

824254

21

End Point

805476

830562

10

Start Point

813525

820872

22

Start Point

806464

824033

10

End Point

813525

824657

22

End Point

806464

829598

11

Start Point

814556

818449

23

Start Point

814559

821739

11

End Point

814556

820992

23

End Point

814559

824768

12

Start Point

815542

818807









12

End Point

815542

824882









2.3.5                               Action & Limit Levels

The action and limit levels of dolphin impact monitoring are shown in Appendix D.  The Event and Action plan is presented in Appendix K.


2.3.6                               Monitoring Schedule for the Reporting Month

Dolphin monitoring was carried out on 5, 9, 11 and 19 December 2013.  The dolphin monitoring schedule for the reporting period is shown in Appendix F.

2.3.7                               Results & Observations

A total of 277.40 km of survey effort was collected, with 83.2% of the total survey effort being conducted under favourable weather conditions (ie Beaufort Sea State 3 or below with good visibility) in December 2013.  Amongst the two areas, 98.10 km and 179.30 km of survey effort were collected from NEL and NWL survey areas, respectively.  The total survey effort conducted on primary and secondary lines were 217.14 km and 60.26 km, respectively.  The survey efforts are summarized in Appendix J.

A total of eight groups of thirty-three dolphin sightings were recorded during the two sets of surveys.  All except one sighting was made in NWL during the two sets of surveys in December, with another group being sighted in NEL.

None of the 33 sightings was made in the proximity of this Project.  The distribution of dolphin sightings during the reporting month is shown in Figure 2.4.

Encounter rates of Chinese White Dolphins are deduced from the survey effort and on-effort sighting data made under favourable conditions (Beaufort 3 or below with good visibility) in December 2013 with the results present in Tables 2.12 and 2.13.

Table 2.12      Individual Survey Event Encounter Rates





Encounter rate (STG)     (no. of on-effort dolphin sightings per 100 km of survey effort)

Encounter rate (ANI)            (no. of dolphins from all on-effort sightings per 100 km of survey effort)

Primary Lines Only

Primary Lines Only

NEL

Set 1: Dec 5th/9th

2.68

8.05

Set 2: Dec 11th/19th

0.0

0.0

NWL

Set 1: Dec 5th/9th

6.95

30.57

Set 2: Dec 11th/19th

6.82

27.27

Note: Dolphin Encounter Rates are deduced from the Two Sets of Surveys (Two Surveys in Each Set) in December 2013 in Northeast (NEL) and Northwest Lantau (NWL)

Table 2.13      Monthly Average Encounter Rates





Encounter rate (STG)        (no. of on-effort dolphin sightings per 100 km of survey effort)

Encounter rate (ANI)            (no. of dolphins from all on-effort sightings per 100 km of survey effort)

Primary   Lines Only

Both Primary and Secondary Lines

Primary   Lines Only

Both Primary and Secondary Lines

Northeast Lantau

1.4

1.0

4.1

3.1

Northwest Lantau

6.9

5.3

29.6

22.6

Note: Overall dolphin encounter rates (sightings per 100km of survey effort) from all four surveys are conducted in December 2013 on primary lines only as well as both primary lines and secondary lines in Northeast and Northwest Lantau.

Table d 4.6

nd limit levels of dolphin impact monitoring are shown in Table

The average group size of Chinese White Dolphins in December 2013 was 4.13 individuals per group.  Six of the eight dolphin groups were composed of only 1-4 animals, while the other two were larger groups with 6 and 12 animals per group, respectively.

During this month of dolphin monitoring, no unacceptable impact from the construction activities of this Contract was recorded from the general observations.

Due to monthly variation in dolphin occurrence within the survey area, it would be more appropriate to draw conclusion on whether any unacceptable impacts on dolphins have been detected related to the construction activities of this Project in the quarterly EM&A reports, where comparison on distribution, group size and encounter rates of dolphins between the quarterly impact monitoring period and baseline monitoring period will be made.

2.3.8                               Marine Mammal Exclusion Zone Monitoring

Daily 250 m marine mammal exclusion zone monitoring was undertaken during the period of dredging activities being undertaken.  No sighting of the Indo-Pacific humpback dolphin Sousa chinensis were recorded in December 2013 during the exclusion zone monitoring.

2.4                                      EM&A Site Inspection

Site inspections were carried out on a weekly basis to monitor the implementation of proper environmental pollution control and mitigation measures under the Contract.  In the reporting month, five (5) site inspections were carried out on 4, 10, 18, 24 and 31 December2013.

Key observations during the site inspections are described below:

Air Quality

¡P      Sandy materials were exposed over the ground without proper cleanup.

Noise

¡P      No adverse observation was identified in the reporting month.

Water Quality

¡P      Silt curtain was found damaged (Portion N-A).

¡P      Cage-type silt curtain was not deployed properly and found broken. (Dredging barge ¡V Crown Asia 1).

¡P      Dredging grab was found leaking remarkable (Dredging barge ¡V Crown Asia 1).

¡P      Oil stain was observed near the drip tray for the chemical containers (Dredging barge ¡V Crown Asia 1).

Marine Ecology

Daily 250 m marine mammal exclusion zone monitoring was undertaken during the period of dredging activities being undertaken.  No sighting of the Indo-Pacific humpback dolphin Sousa chinensis were recorded in December 2013 during the exclusion zone monitoring.  In addition, acoustic decoupling monitoring and marine vessel control for dredging works were implemented in this reporting month.

Chemical and Waste Management

¡P      A proper chemical waste container with good conditions and capacity should be provided (Dredging barge - Crown Asia 1).

¡P      Oil stain was observed and drip tray should be provided for the chemical containers (Barge - Wing Ko).

¡P      Drip tray should be maintained with adequate capacity to avoid oil spillage.  Any oil spill observed should be cleaned up properly as chemical waste (Dredging barge - Crown Asia 1).

¡P      The chemical container was observed without drip tray and labels (WA-23)

¡P      Drip trays for the chemical containers were found at full capacity and without the drip tray plug (WA-18)

Landscape and Visual Impact

¡P      No adverse observation was identified in the reporting month.

Miscellaneous

A proper tree protection zone should be set up to avoid disturbance to the remaining natural habitat (WA-23).

The Contractor has rectified all of the observations as identified during environmental site inspection in the reporting month.

2.5                                      Waste Management Status

The Contractor had submitted application form for registration as chemical waste producer under the Contract.  Sufficient numbers of receptacles were available for general refuse collection and sorting.

As advised by the Contractor, 883 tonnes of inert C&D Materials are generated and disposed of as public fill in the reporting period.  40,500 m3 of Category L marine sediment and 5,000 m3 of Category M marine sediment are generated and disposed of at designated sites.  Monthly summary of waste flow table is detailed in Appendix M.

The Contractor was advised to properly maintain on site C&D materials and waste collection, sorting and recording system, dispose of C&D materials and wastes at designated ground and maximize reuse/ recycle of C&D materials and wastes.  The Contractor was reminded to properly maintain the site tidiness and dispose of the wastes accumulated on site regularly and properly.

The Contractor was reminded that chemical waste containers should be properly treated and stored temporarily in designated chemical waste storage area on site in accordance with the Code of Practice on the Packaging, Labelling and Storage of Chemical Wastes.

2.6                                      Environmental Licenses and Permits

The status of environmental licensing and permit is summarized in Table 2.14 below.


Table 2.14      Summary of Environmental Licensing and Permit Status

Statutory Reference

License/ Permit

License or Permit No.

Date of Issue

Date of Expiry

License/ Permit Holder

Remarks

EIAO

Environmental Permit

EP-354/2009/A

8 Dec 2010

Throughout the Contract

HyD

Tuen Mun-Chek Lap Kok Link



NCO

Construction Dust Notification

363510

19 Aug 2013

Throughout the Contract

DBJV

-

WDO

Chemical Waste Registration

5213-422-D2516-01

10 Sep 2013

Throughout the Contract

DBJV

-



WDO

Construction Waste Disposal Account

7018108

19 Aug 2013

Throughout the Contract

DBJV

Waste disposal in Contract HY/2012/08

WPCO

Waste Water Discharge License

WT00017707-2013

18 Nov 2013

30 Nov 2018

DBJV

Discharge of Construction Runoff

NCO

Construction Noise Permit

GW-RW0691-13

15 Oct 2013

14 Apr 2014

DBJV

For Dredging and Reclamation Works

NCO

Construction Noise Permit

GW-RW0822-13

14 Nov 2013

10 May 2014

DBJV

For works in site WA18



NCO

Construction Noise Permit

GW-RS0814-13

15 Nov 2013

10 May 2014

DBJV

For works in site WA23



DASO

Marine Dumping Permit

EP/MD/14-072

1 Nov 2013

30 Apr 2014

DBJV

For Type 1



DASO

Marine Dumping Permit

EP/MD/14-071

1 Dec 2013

31 Dec 2013

DBJV

For Type 1 (Dedicated site) and Type 2


2.7                                      Implementation Status of Environmental Mitigation Measures

In response to the site audit findings, the Contractors carried out corrective actions.

A summary of the Implementation Schedule of Environmental Mitigation Measures (EMIS) is presented in Appendix C.  The necessary mitigation measures relevant to this Contract were implemented properly.

2.8                                      Summary of Exceedances of the Environmental Quality Performance Limit

Five exceedances of Action and no exceedances Limit levels were recorded for water quality monitoring during the reporting month.  Fourteen exceedances of Action level and two exceedances of Limit Level for air quality were recorded during the reporting month.  The exceedances were considered not related to the construction works of this Contract after further investigation.

Cumulative statistics are provided in Appendix L.

2.9                                      Summary of Complaints, Notification of Summons and Successful Prosecutions

The Environmental Complaint Handling Procedure is provided in Figure 2.5.

No complaints, notification of summons and prosecution were received in the reporting period.

Statistics on complaints, notifications of summons and successful prosecutions are summarized in Appendix L.

3                                             Future Key Issues

3.1                                      Construction Programme for the Coming Months

As informed by the Contractor, the major works for the Project in January 2014 will be:

Marine-based Works

¡P      Seawall construction;

¡P      Removal of existing seawall amour rock;

¡P      Temporary seawall;

¡P      Additional ground investigation;

¡P      Reclamation; and

¡P      Temporary pontoon installation at RTT.

Land-based Works

¡P      Construction for site office (WA 18);

¡P      Hoarding erection & building demolition (Portion N6); and

¡P      CLP substation construction (Portion N6).

3.2                                      Key Issues for the Coming Month

Potential environmental impacts arising from the above upcoming construction activities in the next reporting month of January 2014 are mainly associated with dust, marine water quality, marine ecology and waste management issues.

3.3                                      Monitoring Schedule for the Coming Month

The tentative schedule for environmental monitoring in January 2014 is provided in Appendix F.



4                                             Conclusions and recommendations

4.1                                      Conclusions

This Second Monthly EM&A Report presents the findings of the EM&A activities undertaken during the period from 1 to 31 December 2013, in accordance with the Updated EM&A Manual and the requirements of EP-354/2009/A.

Air quality (including 1-hour TSP and 24-hour TSP), water quality and dolphin monitoring were carried out in the reporting period.  Fourteen (14) Action Level and two (2) Limit Level exceedances for air quality monitoring were recorded in the reporting month.  Five (5) Action Level exceedances for water quality monitoring were recorded in the reporting month.  Investigation works show that the exceedance was not due to the Project works.  Nevertheless, the Contractor was reminded to ensure all dust mitigation measures are provided at the construction site and the proper deployment of cage-type silt curtain at the dredging site.

A total of eight groups of thirty-three dolphin sightings were recorded during the two sets of surveys in December 2013.  All except one sighting were made in NWL during the two sets of surveys in December, with another group being sighted in NEL.  None of the 33 sightings was made in the proximity of the TM-CLKL Northern Connection Sub-sea Tunnel Section.  During this month of dolphin monitoring, no unacceptable impact from the construction activities of the TM-CLKL Northern Connection Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from general observations.

Environmental site inspection was carried out five (5) times in December 2013.  Recommendations on remedial actions were given to the Contractor for the deficiencies identified during the site audits.

4.2                                      Recommendations

According to the environmental site inspections performed in the reporting month, the following recommendations were provided:

Air Quality

Temporary stockpiles at the works area should be properly covered by the Contactor when piling is completed.

Water Quality

Measures should be undertaken by the Contractor to avoid residual sandy materials leaving from at the edge of loading area which may lead to surface runoff in the vicinity.

The Contractor should avoid sandy materials from entering the drainage area.

The Contractor should ensure that the dredging is undertaken properly to avoid spillage outside the cage-type silt curtain in the dredging site of barge Crown Asia 1.

Chemical and Waste Management

The Contractor should install drip tray stopper and clear water stagnant in the drip tray.

The Contractor should proper label the oil drums.

The Contractor should clear oil stain on the barge.

Drip tray should be provided by the Contractor for the chemical containers

Miscellaneous

The Environmental Permit should be displayed conspicuously in the site entrance by the Contractor.
