table of Contents
Executive
Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Water Quality Monitoring
2.3 Dolphin Monitoring
2.4 EM&A Site Inspection
2.5 Waste Management Status
2.6 Environmental Licenses and
Permits
2.7 Implementation Status of
Environmental Mitigation Measures
2.8 Summary of Exceedances of the
Environmental Quality Performance Limit
2.9 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Activities for
the Coming Month
3.2 Key Issues for the Coming
Month
3.3 Monitoring Schedule for the
Coming Month
4 Conclusions and recommendations
4.1 Conclusions
Under Contract
No.
HY/2012/08, Dragages – Bouygues Joint
Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake
the design and construction of the Northern Connection Sub-sea Tunnel Section
of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM
Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong,
Limited (ERM) has been appointed as the Environmental Team (ET) in accordance
with Environmental Permit No. EP-354/2009/A. Ramboll Environ
Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker
(IEC) and Environmental Project Office (ENPO).
Subsequent applications for variation of environmental
permits (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
The
construction phase of the Project commenced on 1 November 2013 and will tentatively
be completed by the end of 2018. The
impact monitoring of the EM&A programme, including air quality, water
quality, marine ecological monitoring and environmental site inspections, were
commenced on 1 November 2013.
This
is the Twenty-second Monthly EM&A report presenting the EM&A works
carried out during the period from 1 to 31 August 2015 for the Contract No. HY/2012/08 Northern Connection
Sub-sea Tunnel Section (the “Project”) in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As
informed by the Contractor, major activities in the reporting period included:
Land-based Works
·
Surcharge Removal at Works Area – Portion N-C;
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of capping beam and base slab for Ventilation
Shaft at Works Area – Portion N-C;
·
Installation of Tower Crane at Works Area – Portion
N-C;
·
TBM Tunnel Works at Works Area – Portion N-B; and
·
Modification and Maintenance Works for Slurry
Treatment Plant at Works Area – Portion N-C.
A
summary of monitoring and audit activities conducted in the reporting period is
listed below:
24-hour
TSP Monitoring 10
sessions
1-hour
TSP Monitoring 10
sessions
Impact
Dolphin Monitoring 2
sessions
Joint
Environmental Site Inspection 4
sessions
Implementation of Marine Mammal Exclusion Zone
There was no dredging, reclamation or marine
sheet piling works in open waters during this reporting period. Thus,
Passive Acoustic Monitoring (PAM) and the day-time monitoring of Dolphin
Exclusion Zone (DEZ) by dolphin observers were not in effect during the
reporting period.
Summary
of Breaches of Action/Limit Levels
Breaches of Action and Limit Levels for Air Quality
No
Action Level or Limit Level of air quality exceedances were recorded in the air
quality monitoring of this reporting month.
Breaches of Action and Limit Levels for Dolphin
Monitoring
Whilst one (1) Limit Level
exceedance was observed for the quarterly dolphin monitoring data between June
2015 and August 2015, no unacceptable impact from the construction activities
of the TM-CLKL Northern Connection Sub-sea Tunnel Section on Chinese White Dolphins
was noticeable from general observations.
Due to monthly variation in dolphin occurrence within the study area, it
would be more appropriate to draw conclusion on whether any impacts on dolphins
have been detected related to the construction activities of the TM-CLKL
Northern Connection Sub-sea Tunnel Section in the quarterly EM&A reports,
where comparison on distribution, group size and encounter rates of dolphins
between the quarterly impact monitoring period and baseline monitoring period
will be made.
Environmental
Complaints, Non-compliance & Summons
No non-compliance with
EIA recommendations,
EP conditions and other requirements associated with the construction of this
Contract was recorded in this reporting period.
No environmental complaint
was received in this reporting period.
No environmental summons was received in this
reporting period.
Reporting Change
There
was no reporting change required in the reporting period.
Upcoming
Works for the Next Reporting Month
Works
to be undertaken in the next monitoring period of September 2015 include the
following:
Land-based Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Installation of Tower Crane at Works Area – Portion
N-C;
·
Base Slap Construction for Ventilation Shaft at Works
Area – Portion N-C;
·
TBM Tunnel Works at Works Area – Portion N-B; and
·
Modification and Maintenance Works for Slurry
Treatment Plant at Works Area – Portion N-C.
Future
Key Issues
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of September 2015 are expected to be mainly
associated with dust, marine ecology and waste management.
According
to the findings of the Northwest New Territories (NWNT) Traffic and
Infrastructure Review conducted by the Transport Department, Tuen Mun Road,
Ting Kau Bridge, Lantau Link and North Lantau Highway would be operating beyond
capacity after 2016. This forecast has
been based on the estimated increase in cross boundary traffic, developments in
the Northwest New Territories (NWNT), and possible developments in North
Lantau, including the Airport developments, the Lantau Logistics Park (LLP) and
the Hong Kong – Zhuhai – Macao Bridge (HZMB).
In order to cope with the anticipated traffic demand, two new road
sections between NWNT and North Lantau – Tuen Mun – Chek Lap Kok Link (TM-CLKL)
and Tuen Mun Western Bypass (TMWB) are proposed.
An
Environmental Impact Assessment (EIA) of TM-CLKL (the Project) was prepared in
accordance with the EIA Study Brief (No. ESB-175/2007) and
the Technical Memorandum of the
Environmental Impact Assessment Process (EIAO-TM). The EIA
Report was submitted under the Environmental Impact Assessment Ordinance (EIAO)
in August 2009. Subsequent to the
approval of the EIA Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of
Environmental Protection (DEP) on 4 November 2009, and EP variation (VEP)
(EP-354/2009A) was issued on 8 December 2010.
Subsequent applications for variation of environmental permits (VEPs), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
Under Contract
No.
HY/2012/08, Dragages – Bouygues Joint
Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the
design and construction of the Northern Connection Sub-sea Tunnel Section of
TM-CLKL while AECOM Asia Company Limited was appointed by HyD as the
Supervising Officer. For implementation
of the environmental monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET). Ramboll Environ
Hong Kong Ltd. was employed by HyD as the Independent Environmental Checker
(IEC) and Environmental Project Office (ENPO).
Layout
of the Contract components is presented in Figure 1.1.
The
organization structure of the Contract is shown in Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact Information of Key Personnel
|
Party |
Position |
Name |
Telephone |
Fax |
|
Highways
Department |
Engr
16/HZMB |
Kenneth Lee |
2762 4996 |
3188 6614 |
|
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Edwin Ching Andrew
Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
|
ENPO / IEC (Ramboll Environ Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3547 2133 |
3465 2899 |
|
IEC |
Dr. F.C.
Tsang |
3547 2134 |
3465 2899 |
|
|
Contractor (Dragages
– Bouygues Joint Venture) |
Environmental
Manager |
C.F. Kwong |
2293 7322 |
2293 7499 |
|
Environmental
Officer 24-hour
complaint hotline |
Bryan Lee Rachel Lam |
2293 7323 2293 7330 |
2293 7499 |
|
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Table 1.2 Summary of Construction Activities Undertaken during the Reporting
Period
|
Construction Activities Undertaken |
|
Land-based Works |
|
·
Surcharge Removal at Works Area – Portion N-C; ·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of capping beam and base slab for Ventilation
Shaft at Works Area – Portion N-C; ·
Installation of Tower Crane at Works Area – Portion
N-C; ·
TBM Tunnel Works at Works Area – Portion N-B; and ·
Modification and Maintenance Works for Slurry
Treatment Plant at Works Area – Portion N-C. |

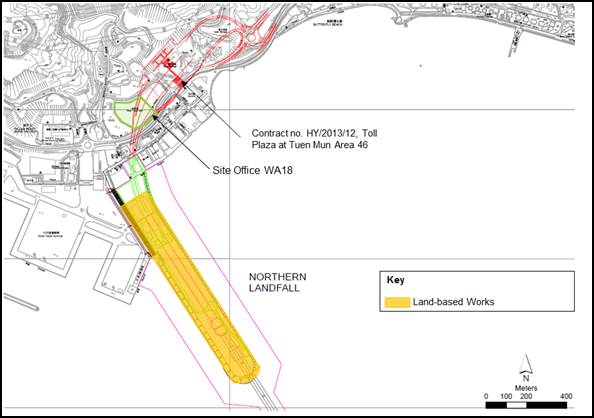

Figure 1.2 Locations of Construction Activities –
August 2015

The
EM&A programme required environmental monitoring for air quality, water quality
and marine ecology as well as environmental site inspections for air quality,
noise, water quality, waste management, marine ecology and landscape and visual
impacts. The EM&A requirements and
related findings for each component are summarized in the following sections
In
accordance with the Updated EM&A Manual and the Enhanced TSP Monitoring
Plan, impact 1-hour TSP monitoring was conducted three (3) times every six (6) days
and impact 24-hour TSP monitoring was carried out once every six (6) days when
the highest dust impact was expected.
1-hr and 24-hr TSP monitoring frequency was increased to three times per
day every three days and daily every three days, respectively, as excavation
works for launching shaft commenced on 24 October 2014.
High
volume samplers (HVSs) were used to carry out the 1-hour and 24-hour TSP
monitoring on 3, 6, 9, 12, 15, 18, 21, 24, 27 and 30 August 2015 at the five
(5) air quality monitoring stations in accordance with the requirements
stipulated in the Updated EM&A Manual (Figure 2.1; Table 2.1). Wind meter was installed at the rooftop of
ASR5 for logging wind speed and wind direction.
Details of the equipment deployed are provided in Table 2.2. Copies of the
calibration certificates for the equipment are presented in Appendix E.
Table 2.1 Locations of Impact Air Quality
Monitoring Stations and Monitoring Dates in this Reporting Period
|
Monitoring
Station |
Monitoring
Dates |
Location |
Description |
Parameters & Frequency |
|
ASR1 |
3,
6, 9, 12, 15, 18, 21, 24, 27 and 30 August 2015 |
Tuen
Mun Fireboat Station |
Office |
TSP monitoring
1-hour Total Suspended Particulates (1-hour
TSP, µg/m3), 3 times in every 6 days
24-hour Total Suspended Particulates
(24-hour TSP, µg/m3), daily for 24-hour in every 6 days Enhanced TSP monitoring (commenced on 24 October 2014)
1-hour Total Suspended Particulates (1-hour
TSP, µg/m3), 3 times in every 3 days
24-hour Total Suspended Particulates
(24-hour TSP, µg/m3), daily for 24-hour in every 3 days |
|
ASR5 |
|
Pillar
Point Fire Station |
Office |
|
|
AQMS1 |
|
Previous
River Trade Golf |
Bare
ground |
|
|
ASR6 |
|
Butterfly
Beach Laundry |
Office |
|
|
ASR10 |
|
Butterfly
Beach Park |
Recreational
uses |
Table 2.2 Air
Quality Monitoring Equipment
|
Equipment |
Brand and Model |
|
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP)
High Volume Sampler (Model No. TE-5170) |
|
Wind Meter |
Davis (Model: Weather Wizard III (S/N: WE90911A30) |
|
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The
Action and Limit Levels of the air quality monitoring is provided in Appendix
D. The Event and Action plan is
presented in Appendix J.
The
schedule for air quality monitoring in August 2015 is provided in Appendix
F.
The
monitoring results for 1-hour TSP and 24-hour TSP are summarized in Tables 2.3 and 2.4, respectively. Detailed
impact air quality monitoring results and graphical presentations are presented
in Appendix
G.
Table 2.3 Summary of 1-hour TSP Monitoring Results in this Reporting
Period
|
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
|
ASR1 |
113 |
60
– 214 |
331 |
500 |
|
ASR5 |
143 |
66
– 241 |
340 |
500 |
|
AQMS1 |
97 |
54
– 165 |
335 |
500 |
|
ASR6 |
131 |
53
– 235 |
338 |
500 |
|
ASR10 |
87 |
52
– 143 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in this Reporting
Period
|
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
|
ASR1 |
67 |
42
– 94 |
213 |
260 |
|
ASR5 |
85 |
59
– 127 |
238 |
260 |
|
AQMS1 |
63 |
50
– 86 |
213 |
260 |
|
ASR6 |
79 |
45
– 103 |
238 |
260 |
|
ASR10 |
58 |
44
– 86 |
214 |
260 |
The
weather condition during the monitoring period varied from sunny to
cloudy. The major dust sources in the reporting
period include construction activities under the Contract as well as nearby
traffic emissions.
A
total of ten monitoring events were undertaken in which no Action or Limit
Level exceedances of 1-hr TSP were recorded in this reporting month. No Action or Limit Level exceedances for
24-hr TSP were record.
Meteorological
information collected at the ASR5, including wind speed and wind direction, is
provided in Appendix H.
As informed
by the Contractor, Phase I Reclamation works for the Northern Landfall was
substantially completed in December 2014, a proposal letter was sent to EPD on
21 May 2015 to seek approval for the temporary suspension of Water Quality
Monitoring. Subsequently, a letter from
EPD on 5 June 2015 stated that they have no strong objection to the temporary
suspension of the water quality monitoring.
Water Quality Monitoring was suspended from 6 June 2015 effectively and
will resume when Phase II Reclamation commences in the fourth quarter of 2016
tentatively.
Impact
dolphin monitoring is required to be conducted by a qualified dolphin
specialist team to evaluate whether there have been any effects on the
dolphins. In order to fulfil the
EM&A requirements and make good use of available resources, the on-going
impact line transect dolphin monitoring data collected by HyD’s
Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong
Kong Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing
Facilities on the monthly basis is adopted to avoid duplicates of survey
effort.
Table 2.5 summarises
the equipment used for the impact dolphin monitoring.
Table 2.5 Dolphin Monitoring Equipment
|
Equipment |
Model |
|
Global Positioning
System (GPS) |
Garmin 18X-PC Geo One Phottix |
|
Camera |
Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens |
|
Laser Binocular |
Infinitor LRF 1000 |
|
Marine Binocular |
Bushell 7 x 50 marine binocular with compass and
reticules |
|
Vessel for Monitoring |
65 foot single
engine motor vessel with viewing platform 4.5m above water level |
Dolphin
monitoring should cover all transect lines in Northeast Lantau (NEL) and the
Northwest Lantau (NWL) survey areas twice per month throughout the entire
construction period. The monitoring data
should be compatible with, and should be made available for, long-term studies
of small cetacean ecology in Hong Kong.
In order to provide a suitable long-term dataset for comparison,
identical methodology and line transects employed in baseline dolphin
monitoring was followed in the impact dolphin monitoring.
The
impact dolphin monitoring was carried out in the NEL and NWL along the line
transect as depicted in Figure 2.2. The co-ordinates of all transect lines are
shown in Table 2.6 below.

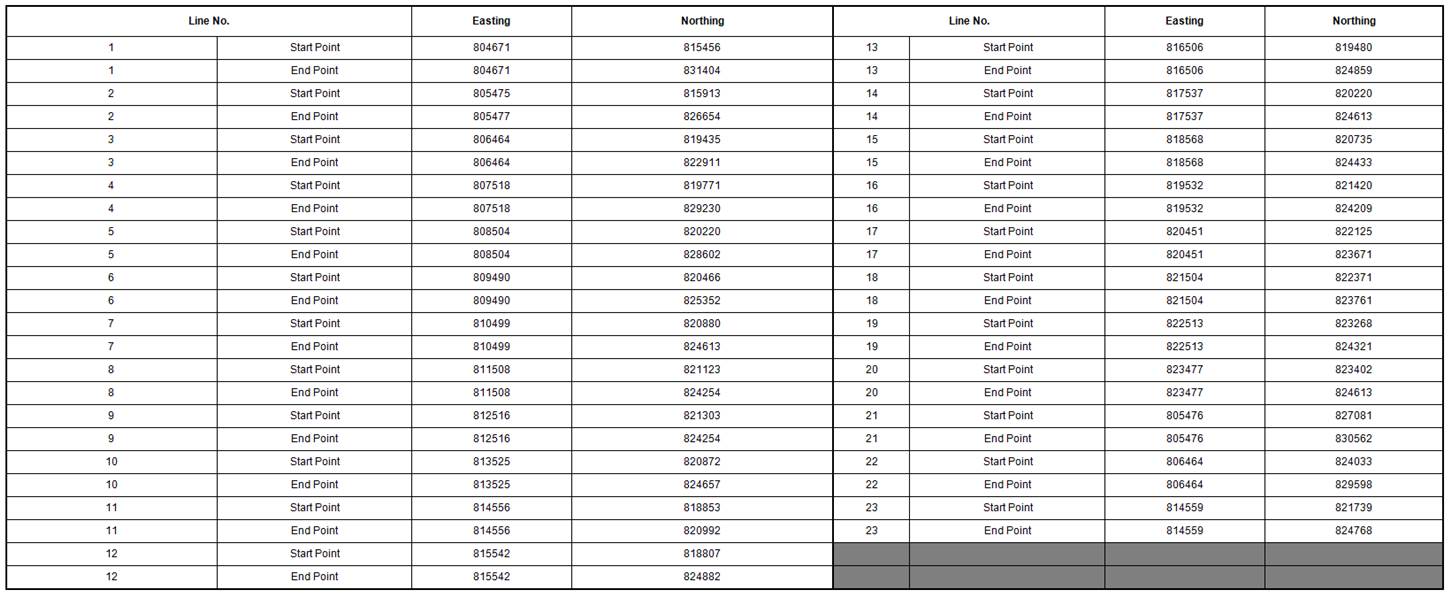

Table 2.6 Impact Dolphin Monitoring Line Transect Co-ordinates

The
Action and Limit levels of impact dolphin monitoring are shown in Appendix
D. The Event and Action plan is
presented in Appendix J.
Dolphin
monitoring was carried out on 10, 14, 19 and 28 of August 2015. The dolphin monitoring schedule for the
reporting month is shown in Appendix F.
A
total of 297.72 km of survey effort was collected, with 99.6% of the total
survey effort being conducted under favourable weather conditions (ie Beaufort
Sea State 3 or below with good visibility) in August 2015. Amongst the two areas, 113.58 km and 184.14
km of survey effort were collected from NEL and NWL survey areas,
respectively. The total survey effort
conducted on primary and secondary lines were 215.91 km and 81.81 km,
respectively. The survey efforts are
summarized in Appendix I.
A total
of 6 groups of twenty-one Chinese White Dolphin
sightings were recorded during the two sets of surveys
in August 2015. All six sightings were
made in NWL during the survey in August 2015.
All six sightings were made on primary lines during on-effort search,
and the sighting was not associated with operating fishing vessel.
None of the sightings was made in the vicinity of the TM-CLKL
Northern Connection Sub-sea Tunnel Section. The distribution of dolphin sightings during
the reporting month is shown in Figure 2.3.
Encounter
rates of Chinese White Dolphins are deduced from the survey effort and
on-effort sighting data made under favourable conditions (Beaufort 3 or below
with good visibility) in August 2015 with the results present in Tables 2.7 and 2.8.
Table 2.7 Individual Survey Event Encounter Rates
|
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
|
Primary Lines Only |
Primary Lines Only |
||
|
NEL |
Set 1: August 10th/14th |
0.0 |
0.0 |
|
Set 2: August 19th/28th |
0.0 |
0.0 |
|
|
NWL |
Set 1: August 10th/14th |
0.0 |
0.0 |
|
Set 2: August 19th/28th |
8.5 |
29.8 |
|
Note: Dolphin Encounter Rates are deduced from the Two
Sets of Surveys (Two Surveys in Each Set) in August 2015 in Northeast (NEL) and
Northwest Lantau (NWL)
Table 2.8 Monthly Average Encounter Rates
|
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100
km of survey effort) |
Encounter rate (ANI) (no.
of dolphins from all on-effort sightings per 100 km of survey effort) |
||
|
Primary Lines Only |
Both Primary and Secondary Lines |
Primary Lines Only |
Both Primary and Secondary Lines |
|
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
|
Northwest Lantau |
4.2 |
3.3 |
14.7 |
11.5 |
Note: Overall
dolphin encounter rates (sightings per 100 km of survey effort) from all four
surveys are conducted in August 2015 on primary lines only as well as both primary
lines and secondary lines in Northeast and Northwest Lantau.
Whilst one (1) Limit Level
exceedance (Both Northeast Lantau social cluster and Northwest Lantau social
cluster exceeded Limit Level) was observed for the quarterly dolphin monitoring
data between June 2015 and August 2015, no unacceptable impact from the
construction activities of the Northern Connection Sub-sea Tunnel Section on Chinese White Dolphins
was noticeable from general observations during the dolphin monitoring in this
reporting month.
Due
to monthly variation in dolphin occurrence within the survey area, it would be
more appropriate to draw conclusion on whether any unacceptable impacts on
dolphins have been detected in relation to the construction activities of this
Project in the quarterly EM&A reports, where comparison on distribution,
group size and encounter rates of dolphins between the quarterly impact
monitoring period and baseline monitoring period will be made.
There was no dredging, reclamation or marine
sheet piling works in open waters during this reporting period. Thus,
Passive Acoustic Monitoring (PAM) and the day-time monitoring of Dolphin
Exclusion Zone (DEZ) by dolphin observers were not in effect during the reporting
period.
Site
inspections were carried out on a weekly basis to monitor the implementation of
proper environmental pollution control and mitigation measures under the
Contract. In the reporting month, four
(4) site inspections were carried out on 6, 12, 19 and 26 August 2015.
Key
observations and recommendations during the site inspections in this reporting
period are summarized in Table 2.9.
Table 2.9 Specific Observations and Recommendations during the Weekly
Site Inspection in this Reporting Month
|
Inspection Date |
Observations |
Recommendations/ Remarks |
|
6 August
2015 |
Works
Area - Portion N-A Floating
litter adjacent to the work site should be cleared more frequently. Water
spraying should be applied more frequently during windy condition. |
Works
Area - Portion N-A The
Contractor was reminded to check and clear the floating litter more
frequently. The
Contractor was reminded to provide water spraying more frequently during
windy condition. |
|
12
August 2015 |
Works
Area - Portion N-A Drip
tray and chemical label should be provided to the oil drum. Works
Area - Portion N-B Water
inside drip tray should be cleared after rainstorm. Excess
sandy materials should be cleared. Works
Area - Portion N-C Accumulated
general refuse should be cleared. Muddy
water should be cleared to avoid runoff. |
Works
Area - Portion N-A The
Contractor was reminded to provide drip tray and chemical label to the oil
drum. Works
Area - Portion N-B The
Contractor was reminded to check and clear the water inside drip tray after
rainstorm. The
Contractor was reminded to clear the excess sandy materials more frequently. Works
Area - Portion N-C The
Contractor was reminded to clear the accumulated general refuse more
frequently. The
Contractor was reminded to clear the muddy water avoid runoff. |
|
19 August
2015 |
Works
Area - Portion N-A Water
inside drip tray should be cleared after rainstorm to maintain capacity. Excess
muddy materials should be cleared more frequently. Used
chemical containers should be cleared or placed inside of drip trays. Accumulated
general refuse should be cleared. |
Works
Area - Portion N-A The
Contractor was reminded to check the capacity of drip trays more frequently. The
Contractor was reminded to clear the excess muddy more frequently. The
Contractor was reminded to clear the used chemical containers or placed them
inside of drip trays. The
Contractor was reminded to clear the accumulated general refuse. |
|
26
August 2015 |
Works
Area - Portion N-A Wetsep should be
kept in adequate capacity to avoid any overflow. Trays
for general refuse should be provided. Wetsep should be
maintained to ensure adequate capacity. Works
Area – Portion N-C Materials
other than chemical containers should be seperated
from the drip tray. Deposited
silt should be removed in the channel. |
Works
Area - Portion N-A The
Contractor was reminded to maintain adequate capacity of the wetsep to avoid any overflow. The
Contractor was reminded to provide trays for general refuse. The
Contractor was reminded to maintain adequate capacity for the wetsep. Works
Area – Portion N-C The
Contractor was reminded to clear the materials other than chemical containers
in the drip tray. The
Contractor was reminded to remove the deposited silt in the channel. |
The
Contractor has rectified all of the observations as identified during
environmental site inspections in the reporting month.
The
Contractor had submitted application form for registration as chemical waste
producer under the Contract. Sufficient
numbers of receptacles were available for general refuse collection and
sorting.
Wastes
generated during this reporting period include mainly construction wastes
(inert and non-inert). Reference has
been made to the waste flow table prepared by the Contractor (Appendix
L). The quantities of different
types of wastes are summarized in Table
2.10.
Table 2.10 Quantities of Different Waste Generated in the Reporting Month
|
Month/Year |
Inert Construction Waste (a)
(tonnes) |
Imported Fill (tonnes) |
Inert Construction Waste
Re-used (tonnes) |
Non-inert Construction Waste (b)
(tonnes) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|
|
Category L |
Category M (Mp
& Mf) |
|||||||
|
August 2015 |
62,367 |
0 |
0 |
246 |
300 |
0 |
0 |
0 |
|
Notes: |
||||||||
|
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
||||||||
The Contractor was advised to properly maintain on
site C&D materials and waste collection, sorting and recording system,
dispose of C&D materials and wastes at designated ground and maximize
reuse/ recycle of C&D materials and wastes.
The Contractor was also reminded to properly maintain the site tidiness
and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was
reminded to treat properly and store temporarily in designated chemical waste
storage area on site in accordance with the Code of Practice on the Packaging,
Labelling and Storage of Chemical Wastes.
The
status of environmental licensing and permit is summarized in Table 2.11 below.
Table 2.11 Summary of Environmental Licensing and Permit Status
|
License/
Permit |
License
or Permit No. |
Date
of Issue |
Date
of Expiry |
License/
Permit Holder |
Remarks |
|
Environmental
Permit |
EP-354/2009/D |
13 March
2015 |
Throughout the
Contract |
HyD |
Application for VEP on 3 March 2015 to supersede EP-354/2009/C |
|
Construction
Dust Notification |
363510 |
19 August
2013 |
Throughout
the Contract |
DBJV |
- |
|
Chemical
Waste Registration |
5213-422-D2516-01 |
10
September 2013 |
Throughout
the Contract |
DBJV |
- |
|
Construction
Waste Disposal Account |
7018108 |
28 August
2013 |
Throughout
the Contract |
DBJV |
Waste disposal in Contract No. HY/2012/08 |
|
Waste Water
Discharge License |
WT00017707-2013 |
18 November
2013 |
30 November
2018 |
DBJV |
For site WA18 |
|
Waste Water
Discharge License |
WT00019248-2014 |
5 June 2014 |
30 June
2019 |
DBJV |
For site Portion N6 and Reclamation Area E |
|
Construction
Noise Permit |
GW-RW0350-15 |
14 July
2015 |
13 December
2015 |
DBJV |
For site
WA23 |
|
Construction Noise Permit |
GW-RW0140-15 |
29 March 2015 |
28 September 2015 |
DBJV |
For Portion N6 |
|
Construction Noise Permit |
GW-RW0311-15 |
20 July 2015 |
19 October 2015 |
DBJV |
For Dredging and Reclamation Works |
|
Construction Noise Permit |
GW-RW0150-15 |
1 April 2015 |
30 September 2015 |
DBJV |
For GI Works at Southern Landfall |
|
Notes: |
|||||
|
HyD =
Highways Department DBJV = Dragages
– Bouygues Joint Venture VEP =
Variation of Environmental Permit |
|||||
In
response to the site audit findings, the Contractors carried out all corrective
actions.
A
summary of the Implementation Schedule of Environmental Mitigation Measures (EMIS)
is presented in Appendix C. The necessary mitigation measures relevant to
this Contract were implemented properly.
No
Action Level or Limit Level exceedances were recorded in the air quality
monitoring of this reporting month.
Cumulative
statistics are provided in Appendix K.
The
Environmental Complaint Handling Procedure is provided in Figure 2.4.
No
environmental complaint was received in the reporting period.
No notification
of summons and prosecution were received in the reporting period.
Statistics
on complaints, notifications of summons and successful prosecutions are
summarized in Appendix K.
As
informed by the Contractor, the major works for the Project in September 2015
are summarized in Table 3.1.
Table 3.1 Construction Works to Be Undertaken in the Coming Month
|
Works to be undertaken |
|
Land-based Works |
|
·
Box Culvert Extension at Works Area – Portion N-A; ·
Installation of Tower Crane at Works Area – Portion
N-C; ·
Base Slap Construction for Ventilation Shaft at
Works Area – Portion N-C; ·
TBM Tunnel Works at Works Area – Portion N-B; and ·
Modification and Maintenance Works for Slurry
Treatment Plant at Works Area – Portion N-C. |
Potential
environmental impacts arising from the above upcoming construction activities
in the next reporting month of September 2015 are mainly associated with dust,
marine ecology and waste management issues.
The
tentative schedule for environmental monitoring in September 2015 is provided in
Appendix
F.
This
Twenty-second Monthly EM&A Report presents the findings of the
EM&A activities undertaken during the period from 1 to 31 August 2015, in accordance
with the Updated EM&A Manual and the requirements of EP-354/2009/D.
Air
quality (including 1-hour TSP and 24-hour TSP) and dolphin monitoring were
carried out in this reporting month. No Action Level or Limit Level
exceedances were recorded in the air quality monitoring of this reporting
month.
A
total of six (6) groups of twenty-one (21) Chinese White Dolphin
sightings were recorded during the two sets of surveys
in August 2015. All six sightings were
made in NWL during the two sets of surveys in August 2015. All six sightings were made on primary lines
during on-effort search, and none of the dolphin groups was associated with
operating fishing vessel. Whilst one (1)
Limit Level exceedance was observed for the quarterly dolphin monitoring data
between June 2015 and August 2015.
No
unacceptable impact from the construction activities of the TM-CLKL Northern
Connection Sub-sea Tunnel Section on Chinese White Dolphins was noticeable from
general observations during the dolphin monitoring in this reporting month.
Environmental
site inspection was carried out four (4) times in August 2015. Recommendations on remedial actions
recommended for the deficiencies identified during the site audits were
properly implemented by the Contractor.
No
non-compliance event was recorded during the reporting period.
No
environmental complaint was received during the reporting period.
No
summons/ prosecution was received during the reporting
period.
The
ET will keep track on the construction works to confirm compliance of
environmental requirements and the proper implementation of all necessary
mitigation measures.
