table of Contents
Executive
Summary
1.1 Background
1.2 Scope
of Report
1.3 Organization
Structure
1.4 Summary
of Construction Works
2.1 Air
quality
2.2 Water
Quality Monitoring
2.3 Dolphin
Monitoring
2.4 EM&A
Site Inspection
2.5 Waste
Management Status
2.6 Environmental
Licenses and Permits
2.7 Implementation
Status of Environmental Mitigation Measures
2.8 Summary
of Exceedances of the Environmental Quality Performance Limit
2.9 Summary
of Complaints, Notification of Summons and Successful Prosecutions
3.1 Construction
Activities for the Coming Month
3.2 Key
Issues for the Coming Month
3.3 Monitoring
Schedule for the Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
Under
Contract No. HY/2012/08,
Dragages – Bouygues Joint Venture (DBJV) is
commissioned by the Highways Department (HyD) to
undertake the design and construction of the Northern Connection Sub-sea Tunnel
Section of the Tuen Mun – Chek Lap Kok Link Project (TM-CLK
Link Project) while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET) in accordance with Environmental
Permit No. EP-354/2009/A. Ramboll Environ Hong
Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO). Subsequent applications for
variation of environmental permits (VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014
and 13 March 2015, respectively.
The construction phase of the
Project commenced on 1 November 2013 and will tentatively be completed by the
end of 2018. The impact monitoring of
the EM&A programme, including air quality, water
quality, marine ecological monitoring and environmental site inspections, were commenced
on 1 November 2013.
This is the Forty-eighth Monthly EM&A
report presenting the EM&A works carried out during the period from 1 to 31
October 2017 for the Contract No.
HY/2012/08 Northern
Connection Sub-sea Tunnel Section (the “Project”) in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, major activities in the reporting period included:
Land-based
Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Excavation of Sub-sea Tunnel – TBM tunnel;
·
Corbel Construction – TBM Tunnel;
·
Phase 2 Surcharge Removal – Portion N-A;
·
Bulk Excavation – Portion S-A;
·
CSM treatment, Jet Grouting works and D-wall
Construction; and
·
Ground Freezing Works – Portion S-A
There was no
dredging, reclamation or marine sheet piling works in open waters during this
reporting period.
A summary of monitoring and audit
activities conducted in the reporting period is listed below:
24-hour TSP Monitoring 9 sessions
1-hour TSP Monitoring 9 sessions
Impact Dolphin Monitoring 2 sessions
Joint Environmental Site Inspection 4 sessions
Implementation
of Marine Mammal Exclusion Zone
There was
no dredging, reclamation or marine sheet piling works in open waters during
this reporting period. Thus, Passive Acoustic Monitoring (PAM) and the
day-time monitoring of Dolphin Exclusion Zone (DEZ) by dolphin observers were
not in effect during the reporting period.
Summary of
Breaches of Action/Limit Levels
Breaches
of Action and Limit Levels for Air Quality
Two (2) Action Level exceedances of
1-hour TSP and one (1) Action Level exceedance of 24-hour TSP were recorded on
21 October 2017. Two (2) Action Level exceedances
of 1-hour TSP were recorded on 27 October 2017.
Investigation reports will be provided in the
next monthly EM&A report. Investigation reports of air quality
exceedances on 12, 18 and 27 September 2017 are provided in Appendix K.
Breaches
of Action and Limit Levels for Dolphin Monitoring
Due to monthly variation in dolphin occurrence within the
survey area, it would be more appropriate to draw conclusion on whether any
unacceptable impacts on dolphins have been detected in relation to the
construction activities of this Project in the quarterly EM&A reports,
where comparison on distribution, group size and encounter rates of dolphins
between the quarterly impact monitoring period and baseline monitoring period
will be made.
Environmental
Complaints, Non-compliance & Summons
No non-compliance with EIA
recommendations,
EP conditions and other requirements associated with the construction of this Contract
was recorded in this reporting period.
One (1) environmental complaint case regarding light
pollution at Tuen Mun Pier
was referred by IEC on 25 October 2017. The complaint investigation report is under
preparation by the ET and will be provided in the next monthly report.
No environmental summons was
received in this reporting period.
Reporting
Change
There was no reporting change
required in the reporting period.
Upcoming Works for the Next Reporting Month
Works to be undertaken in the next
monitoring period of November 2017 include the following:
Land-based
Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of North Ventilation Building – Portion
N-C;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Excavation of Sub-sea Tunnel – TBM tunnel;
·
Corbel Construction – TBM Tunnel;
·
Phase 2 Surcharge Removal – Portion N-A;
·
Bulk Excavation – Portion S-A;
·
CSM treatment, Jet Grouting works and D-wall
Construction; and
·
Ground Freezing Works – Portion S-A
Marine-based
Works
·
Seawall Enhancement works – Portion N-C
Future Key
Issues
Potential environmental impacts
arising from the above upcoming construction activities in the next reporting
month of November 2017 are mainly associated with dust, marine water quality, marine
ecology and waste management issues.
According to the findings of the Northwest New
Territories (NWNT) Traffic and Infrastructure Review conducted by the Transport
Department, Tuen Mun Road,
Ting Kau Bridge, Lantau Link and North Lantau Highway
would be operating beyond capacity after 2016. This forecast has been based on the estimated
increase in cross boundary traffic, developments in the Northwest New
Territories (NWNT), and possible developments in North Lantau, including the
Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong –
Zhuhai – Macao Bridge (HZMB). In order
to cope with the anticipated traffic demand, two new road sections between NWNT
and North Lantau – Tuen Mun
– Chek Lap Kok Link
(TM-CLKL) and Tuen Mun
Western Bypass (TMWB) are proposed.
An Environmental Impact Assessment (EIA) of TM-CLKL (the
Project) was prepared in accordance with the EIA Study Brief (No. ESB-175/2007) and the Technical
Memorandum of the Environmental Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (VEP) (EP-354/2009/A) was issued on 8 December
2010. Subsequent applications for
variation of environmental permits (VEPs), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were
granted on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
Under Contract No. HY/2012/08,
Dragages – Bouygues Joint Venture (DBJV) is
commissioned by the Highways Department (HyD) to
undertake the design and construction of the Northern Connection Sub-sea Tunnel
Section of TM-CLKL while AECOM Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the
Contract, ERM-Hong Kong, Limited (ERM) has been appointed as the Environmental
Team (ET). Ramboll Environ
Hong Kong Ltd. was employed by HyD as the Independent
Environmental Checker (IEC) and Environmental Project Office (ENPO).
Layout of the Contract components is
presented in Figure 1.1.
The organization structure of the Contract is shown in Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways
Department |
Engr 22/HZMB |
Chow Man
Lung, Andrew |
2762 4110 |
2762 4110 |
SOR (AECOM Asia
Company Limited) |
Chief
Resident Engineer |
Roger Man Andrew
Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
ENPO / IEC (Ramboll Environ Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465
2850 |
3465 2899 |
IEC |
Dr. F.C.
Tsang |
3465
2851 |
3465 2899 |
|
Contractor (Dragages – Bouygues Joint Venture) |
Environmental
Officer |
Bryan Lee |
2293 7323 |
2293 7499 |
|
24-hour
complaint hotline |
Rachel Lam |
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jovy Tam |
2271 3113 |
2723 5660 |
Table
1.2 Summary of Construction Activities Undertaken during the
Reporting Period
Construction Activities Undertaken |
Land-based Works |
·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Excavation of Sub-sea Tunnel – TBM tunnel; ·
Corbel Construction – TBM Tunnel; ·
Phase 2 Surcharge Removal – Portion N-A; ·
Bulk Excavation – Portion S-A; ·
CSM treatment, Jet Grouting works and D-wall
Construction; and ·
Ground Freezing Works – Portion S-A There was no
dredging, reclamation or marine sheet piling works in open waters during this
reporting period. |

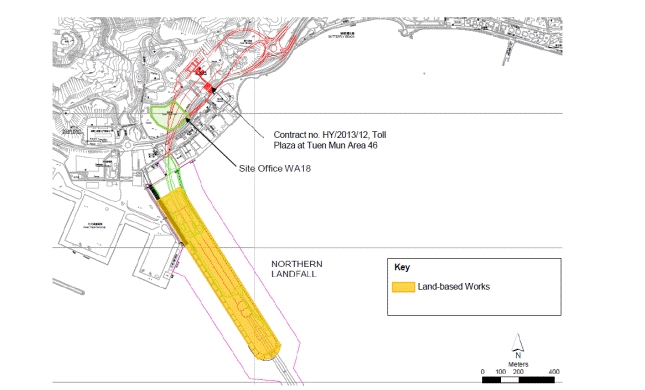

Figure 1.2 Locations of Construction Activities – October
2017
|
The EM&A programme
required environmental monitoring for air quality, water quality and marine
ecology as well as environmental site inspections for air quality, noise, water
quality, waste management, marine ecology and landscape and visual impacts. The EM&A requirements and related findings
for each component are summarized in the following sections
In accordance with the Updated EM&A Manual and the
Enhanced TSP Monitoring Plan, impact 1-hour TSP monitoring was conducted three
(3) times every six (6) days and impact 24-hour TSP monitoring was carried out once
every six (6) days when the highest dust impact was expected. 1-hr and 24-hr TSP monitoring frequency was
increased to three times per day every three days and daily every three days,
respectively, as excavation works for launching shaft commenced on 24 October
2014.
High volume samplers (HVSs) were used to carry out the
1-hour and 24-hour TSP monitoring on 3, 6, 9, 12, 18, 21, 24, 27 and 30 October
2017 at the five (5) air quality monitoring stations in accordance with the requirements
stipulated in the Updated EM&A Manual (Figure
2.1; Table 2.1). Wind meter was installed at the rooftop of
ASR5 for logging wind speed and wind direction.
Details of the equipment deployed are provided in Table 2.2. Copies of the
calibration certificates for the equipment are presented in Appendix E.
Table 2.1 Locations of Impact Air Quality Monitoring Stations and
Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Dates |
Location |
Description |
Parameters
& Frequency |
ASR1 |
3,
6, 9, 12, 18, 21, 24, 27 and 30 October 2017 |
Tuen Mun Fireboat Station |
Office |
TSP monitoring 1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3
times in every 6 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour in every 6 days Enhanced TSP
monitoring (commenced on 24 October 2014) 1-hour Total Suspended Particulates (1-hour TSP, µg/m3), 3
times in every 3 days 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour in every 3 days |
ASR5 |
|
Pillar
Point Fire Station |
Office |
|
AQMS1 |
|
Previous
River Trade Golf |
Bare
ground |
|
ASR6 |
|
Butterfly
Beach Laundry |
Office |
|
ASR10 |
|
Butterfly
Beach Park |
Recreational
uses |
Table 2.2 Air Quality
Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended
Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model: Vantage Pro 2 (S/N: AS160104014) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The Action and Limit Levels of the air quality
monitoring is provided in Appendix D. The Event and Action plan is presented in Appendix J.
The schedule for air quality monitoring in October 2017
is provided in Appendix F. Impact air quality monitoring on 15 October
2017 was cancelled due to adverse weather.
The monitoring results for 1-hour TSP and 24-hour TSP
are summarized in Tables 2.3 and 2.4, respectively. Detailed impact air quality monitoring results
and graphical presentations are presented in Appendix G.
Table 2.3 Summary of 1-hour TSP Monitoring Results in this Reporting
Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
217 |
64
- 439 |
331 |
500 |
ASR5 |
178 |
74
- 368 |
340 |
500 |
AQMS1 |
114 |
41
- 234 |
335 |
500 |
ASR6 |
139 |
58
- 388 |
338 |
500 |
ASR10 |
102 |
34
- 307 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in this Reporting
Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
157 |
88
- 220 |
213 |
260 |
ASR5 |
106 |
78
- 160 |
238 |
260 |
AQMS1 |
77 |
39
- 160 |
213 |
260 |
ASR6 |
85 |
41
- 138 |
238 |
260 |
ASR10 |
91 |
37
- 205 |
214 |
260 |
The weather condition during the monitoring period
varied from sunny to cloudy. The major
dust sources in the reporting period included construction activities under the
Contract as well as nearby traffic emissions.
A total of 9 1-hour TSP and 24-hour
TSP monitoring were undertaken in which four (4) Action Level exceedances of
1-hr TSP and one (1) Action Level exceedance of 24-hr TSP were recorded in this
reporting month.
Meteorological information collected at the ASR5,
including wind speed and wind direction, is provided in Appendix H.
Marine works for Phase II reclamation of Northern
Landfall were substantially completed in the end of May. Thus, no impact marine water quality
monitoring was conducted during the reporting period. Impact marine water quality monitoring for
Northern Landfall will resume during the seawall enhancement works at Northern
Landfall in November 2017 in accordance with the requirement in the Contract
Specific EM&A Manual.
Impact dolphin monitoring is required to be conducted
by a qualified dolphin specialist team to evaluate whether there have been any
effects on the dolphins. In order to
fulfil the EM&A requirements and make good use of available resources, the
on-going impact line transect dolphin monitoring data collected by HyD’s Contract No. HY/2011/03 Hong
Kong-Zhuhai-Macao Bridge. Hong Kong Link Road - Section between Scenic
Hill and Hong Kong Boundary Crossing Facilities on the monthly basis is
adopted to avoid duplicates of survey effort.
Table 2.5 summarises the equipment used for the impact dolphin
monitoring.
Table 2.5 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) |
Garmin 18X-PC Geo One Phottix |
Camera |
Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens |
Laser Binocular |
Infinitor LRF 1000 |
Marine Binocular |
Bushell 7 x 50 marine binocular with compass and reticules |
Vessel for Monitoring |
65 foot single engine motor vessel with viewing platform 4.5m above
water level |
Dolphin monitoring should cover all transect lines in Northeast
Lantau (NEL) and the Northwest Lantau (NWL) survey areas twice per month
throughout the entire construction period. The monitoring data should be compatible with,
and should be made available for, long-term studies of small cetacean ecology
in Hong Kong. In order to provide a suitable
long-term dataset for comparison, identical methodology and line transects
employed in baseline dolphin monitoring was followed in the impact dolphin
monitoring.
The impact dolphin monitoring was carried out in the
NEL and NWL along the line transect as depicted in Figure 2.2. The co-ordinates
of all transect lines are shown in Table 2.6
below.
Table 2.6 Impact Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
815456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805476 |
820800* |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805476 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
821150* |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
821500* |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
821850* |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
822150* |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
822000* |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
821176 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
12 |
End
Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
The Action and Limit levels of impact dolphin monitoring
are shown in Appendix D. The Event and Action plan is presented in Appendix J.
Dolphin monitoring was carried out on 4, 9, 18 and 26 of
October 2017. The dolphin monitoring
schedule for the reporting month is shown in Appendix F.
Four groups of 8 Chinese White Dolphins sightings were
recorded during the two sets of surveys in October 2017. All dolphin sightings were made in NWL, while
none was sighted in NEL. All dolphin
sightings were made during on-effort search and were made on primary lines. One of the dolphin groups was associated with
an operating purse-seiner.
No dolphin sighting was made in the proximity
of the TM-CLKL alignment. The distribution of dolphin sightings during the
reporting month is shown in Figure 2.3.
Encounter rates of Chinese White Dolphins are deduced
from the survey effort and on-effort sighting data made under favourable conditions (Beaufort 3 or below) in October 2017
with the results present in Tables 2.7 and 2.8.
Table 2.7 Individual Survey Event Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: October 4th / 9th |
0.0 |
0.0 |
Set 2: October 18th / 26th |
0.0 |
0.0 |
|
NWL |
Set 1: October 4th / 9th |
1.9 |
9.3 |
Set 2: October 18th / 26th |
4.9 |
4.9 |
Note: Dolphin Encounter Rates
are deduced from the Two Sets of Surveys (Two Surveys in Each Set) in October
2017
in Northeast (NEL) and Northwest Lantau (NWL)
Table 2.8 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100
km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all
on-effort sightings per 100 km of survey effort) |
||
Primary
Lines Only |
Both Primary and Secondary Lines |
Primary
Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
3.5 |
2.6 |
7.0 |
5.2 |
Note:
Overall dolphin encounter rates (sightings per 100 km of survey effort) from
all four surveys are conducted in October 2017 on primary lines
only as well as both primary lines and secondary lines in Northeast and
Northwest Lantau.
Due
to monthly variation in dolphin occurrence within the survey area, it would be
more appropriate to draw conclusion on whether any unacceptable impacts on
dolphins have been detected in relation to the construction activities of this
Project in the quarterly EM&A reports, where comparison on distribution,
group size and encounter rates of dolphins between the quarterly impact
monitoring period and baseline monitoring period will be made.
There was no dredging, reclamation
or marine sheet piling works in open waters during this reporting period.
Thus, Passive Acoustic Monitoring (PAM) and the day-time monitoring of Dolphin
Exclusion Zone (DEZ) by dolphin observers were not in effect during the
reporting period.
Site inspections were carried out on a weekly basis to
monitor the implementation of proper environmental pollution control and mitigation
measures under the Contract. In the
reporting month, four (4) site inspections were carried out on 4, 11, 18 and 25
October 2017.
Key observations and recommendations during the site
inspections in this reporting period are summarized in Table 2.9.
Table 2.9 Specific Observations and Recommendations during the Weekly
Site Inspection in this Reporting Month
Inspection Date |
Observations |
Recommendations/ Remarks |
4 October 2017 |
Works
Area - Portion S-A Accumulated
rubbish should be removed from the waste container.. Works
Area - Portion S-B Stagnant
water should be removed and chemical labels should be provided for the
chemical drums. Accumulated
rubbish should be removed from the waste container. Works
Area – TBM tunnel Drip
tray should be provided for the chemical containers. Drip
tray should be provided for the chemical containers. |
Works
Area - Portion S-A The
Contractor was reminded to remove accumulated rubbish from the waste
container. Works
Area - Portion S-B The
Contractor was reminded to remove the stagnant water and provide chemical
labels for the chemical drums. The
Contractor was reminded to remove accumulated rubbish from the waste
container. Works
Area – TBM tunnel The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to provide drip tray for the chemical containers. |
11
October 2017 |
Works
Area –Portion N-C Water
spraying should be applied more frequently during dry conditions. Works
Area - Portion N-A Water
spraying should be applied more frequently during dry conditions. Reminder
from SOR: Works
Area - Portion N-C Stagnant
water should be removed and larvacide should be
sprayed regularly. Works
Area - Portion S-B Stagnant
water should be removed. |
Works
Area –Portion N-C The
Contractor was reminded to apply water spraying more frequently during dry
conditions. Works
Area - Portion N-A The
Contractor was reminded to apply water spraying more frequently during dry
conditions. Reminder
from SOR: Works
Area - Portion N-C The
Contractor was reminded to remove the stagnant water and spray larvacide regularly. Works
Area - Portion S-B The
Contractor was reminded to remove the stagnant water. |
18 October 2017 |
Works
Area – TBM tunnel Drip
tray should be provided for the chemical containers. Works
Area - Portion S-B Drip
tray should be provided for the chemical containers. |
Works
Area – TBM tunnel The
Contractor was reminded to provide drip tray for the chemical containers. Works
Area - Portion S-B The
Contractor was reminded to provide drip tray for the chemical containers. |
25
October 2017 |
Works
Area – Portion N-C Drip
tray should be provided for the chemical containers. Works
Area – Portion N-A "Stop
work" label should be put on the unused grouting machine. Works
Area - Portion S-B Slurry
paddles should be tidied up. |
Works
Area – Portion N-C The
Contractor was reminded to provide drip tray for the chemical containers. Works
Area – Portion N-A The
Contractor was reminded to put the "Stop work" label on the unused
grouting machine. Works
Area - Portion S-B The
Contractor was reminded to tidy up the slurry paddles. |
The Contractor has rectified all of the observations
as identified during environmental site inspections in the reporting month.
The Contractor had submitted application form for
registration as chemical waste producer under the Contract. Sufficient numbers of receptacles were
available for general refuse collection and sorting.
Wastes generated during this reporting period included
mainly construction wastes (inert and non-inert). Reference has been made to the waste flow
table prepared by the Contractor (Appendix L). The quantities of different types of wastes
are summarized in Table 2.10.
Table 2.10 Quantities of Different Waste Generated in the Reporting Month
Month/Year |
Inert Construction Waste (a)
(tonnes) |
Inert Construction Waste
Re-used (tonnes) |
Non-inert Construction Waste (b)
(tonnes) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
||
Category L |
Category M (Mp
& Mf) |
|||||||
October 2017 |
706 |
0 |
244 |
0 |
0 |
0 |
0 |
|
Notes: |
|
|||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
|
|||||||
The Contractor was advised to properly maintain on
site C&D materials and waste collection, sorting and recording system,
dispose of C&D materials and wastes at designated ground and maximize
reuse/ recycle of C&D materials and wastes.
The Contractor was also reminded to properly maintain the site tidiness
and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was
reminded to treat properly and store temporarily in designated chemical waste
storage area on site in accordance with the Code of Practice on the Packaging,
Labelling and Storage of Chemical Wastes.
The status of environmental licensing and permit is
summarized in Table 2.11 below.
Table 2.11 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental
Permit |
EP-354/2009/D |
13
March 2015 |
Throughout
the Contract |
HyD |
Application for VEP on 3 March 2015 to supersede EP-354/2009/C |
Construction
Dust Notification |
363510 |
19
August 2013 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Construction
Dust Notification |
403620 |
10 June 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Chemical
Waste Registration |
5213-422-D2516-02 |
18 January 2017 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Chemical
Waste Registration |
5213-951-D2591-01 |
25 May 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Construction
Waste Disposal Account |
7018108 |
28
August 2013 |
Throughout
the Contract |
DBJV |
Waste disposal in Contract No. HY/2012/08 |
|
|
|
|
|
|
Waste
Water Discharge License |
WT00017707-2013 |
18
November 2013 |
30
November 2018 |
DBJV |
For site WA18 |
Waste
Water Discharge License |
WT00018433-2014 |
6 March 2014 |
31 March 2019 |
DBJV |
N6 Site |
Waste
Water Discharge License |
WT00019248-2014 |
5
June 2014 |
30
June 2019 |
DBJV |
For site Portion N6 and Reclamation Area E |
Waste
Water Discharge License |
WT00025944-2016 |
15 December 2016 |
31 December 2021 |
DBJV |
Southern Landfall |
Marine
Dumping Permit |
EP/MD/18-036 |
21 October 2017 |
20 November 2017 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Construction
Noise Permit |
GW-RW0538-17 |
16 October 2017 |
15 April 2018 |
DBJV |
For
Urmston Road in front of Pillar Point |
Construction
Noise Permit |
GW-RW0279-17 |
13 June 2017 |
12 December 2017 |
DBJV |
WA23
@ Tsing Yi |
Construction Noise Permit |
PP-RS0019-17 |
31 August 2017 |
30 November 2017 |
DBJV |
Southern Landfall (Percussive Piling) |
Construction Noise Permit |
GW-RS0878-17 |
11 October 2017 |
2 April 2018 |
DBJV |
Southern Landfall |
Notes: |
|||||
HyD
= Highways Department DBJV
= Dragages – Bouygues Joint Venture VEP
= Variation of Environmental Permit |
In response to the site audit findings, the
Contractors carried out all corrective actions.
A summary of the Implementation Schedule of
Environmental Mitigation Measures (EMIS) is presented in Appendix C.
The necessary mitigation measures relevant to this Contract were implemented
properly.
Two (2) Action Level exceedances of 1-hour TSP and one
(1) Action Level exceedance of 24-hour TSP were recorded on 21 October
2017. Two (2) Action Level exceedances of
1-hour TSP were recorded on 27 October 2017.
Investigation reports will be provided in the next monthly EM&A
report. Investigation reports of air
quality exceedances on 12, 18 and 27 September 2017 are provided in Appendix K.
Cumulative statistics are provided in Appendix K.
The Environmental Complaint Handling Procedure is provided
in Figure 2.4.
One
(1) environmental complaint case regarding light pollution at Tuen
Mun Pier was referred by IEC on 25 October 2017. The complaint investigation report is under
preparation by the ET and will be provided in the next monthly report.
No environmental summons was received in this
reporting period.
Statistics on complaints, notifications of summons and
successful prosecutions are summarized in Appendix K.
As informed by the Contractor, the major works for the
Project in November 2017 are summarized in Table
3.1.
Table 3.1 Construction Works to Be Undertaken in the Coming Month
Works to be undertaken |
Land-based
Works ·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of North Ventilation Building – Portion
N-C; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Excavation of Sub-sea Tunnel – TBM tunnel; ·
Corbel Construction – TBM Tunnel; ·
Phase 2 Surcharge Removal – Portion N-A; ·
Bulk Excavation – Portion S-A; ·
CSM treatment, Jet Grouting works and D-wall
Construction; and ·
Ground Freezing Works – Portion S-A Marine-based
Works ·
Seawall Enhancement works – Portion N-C |
Potential environmental impacts arising from the above
upcoming construction activities in the next reporting month of November 2017 are
mainly associated with dust, marine water quality, marine ecology and waste
management issues.
The tentative schedule for environmental monitoring in
November 2017 is provided in Appendix F.
This Forty-eighth Monthly
EM&A Report presents the findings of the EM&A activities undertaken
during the period from 1 to 31 October 2017, in accordance with the Updated
EM&A Manual and the requirements of EP-354/2009/D.
Air quality (including 1-hour TSP and 24-hour TSP) and
dolphin monitoring were carried out in this reporting month. Four (4) Action Level exceedance of
1-hour TSP and one (1) Action Level exceedance of 24-hour TSP were recorded in
the air quality monitoring of this reporting month. Investigation reports will be provided in the
next monthly EM&A report.
Investigation reports of air quality exceedances on 12, 18 and 27
September 2017 are provided in Appendix K.
Four groups of 8 Chinese White Dolphins sightings were
recorded during the two sets of surveys in October 2017. All dolphin sightings were made in NWL, while
none was sighted in NEL. All dolphin
sightings were made during on-effort search and was
made on primary lines. One of the
dolphin groups was associated with an operating purse-seiner.
Environmental site inspection was carried out four (4)
times in October 2017. Remedial actions recommended for the
deficiencies identified during the site audits were properly implemented by the
Contractor.
No non-compliance event was recorded during the
reporting period.
One
(1) environmental complaint case regarding light pollution at Tuen Mun Pier was referred by IEC
on 25 October 2017. The complaint
investigation report is under preparation by the ET and will be provided in the
next monthly report.
No environmental summons was received in this
reporting period.
The ET will keep track on the construction works to
confirm compliance of environmental requirements and the proper implementation
of all necessary mitigation measures.
