table of
Contents
Executive
Summary
1.1 Background
1.2 Scope of Report
1.3 Organization Structure
1.4 Summary of Construction Works
2.1 Air quality
2.2 Dolphin Monitoring
2.3 EM&A Site Inspection
2.4 Waste Management Status
2.5 Environmental Licenses and
Permits
2.6 Implementation Status of
Environmental Mitigation Measures
2.7 Summary of Exceedances of the
Environmental Quality Performance Limit
2.8 Summary of Complaints,
Notification of Summons and Successful Prosecutions
3.1 Construction Activities for
the Coming Month
3.2 Key Issues for the Coming
Month
3.3 Monitoring Schedule for the
Coming Month
4 Conclusions
and recommendations
4.1 Conclusions
Under Contract
No. HY/2012/08, Dragages – Bouygues Joint Venture (DBJV) is commissioned by
the Highways Department (HyD) to undertake the design and construction of the
Northern Connection Sub-sea Tunnel Section of the Tuen Mun – Chek Lap Kok Link
Project (TM-CLK Link Project) while AECOM Asia Company Limited was
appointed by HyD as the Supervising Officer.
For implementation of the environmental monitoring and audit (EM&A)
programme under the Contract, ERM-Hong Kong, Limited (ERM) has been appointed
as the Environmental Team (ET) in accordance with Environmental Permit No. EP-354/2009/A. Ramboll Hong Kong Ltd. was employed by HyD as
the Independent Environmental Checker (IEC) and Environmental Project Office
(ENPO). Subsequent
applications for variation of environmental permits (VEP), EP-354/2009/B, EP-354/2009/C and
EP-354/2009/D, were granted on 28
January 2014, 10 December 2014 and 13 March 2015, respectively.
The construction phase of the Project commenced on 1
November 2013 and will tentatively be completed by the end of 2018. The impact monitoring of the EM&A
programme, including air quality, water quality, marine ecological monitoring
and environmental site inspections, were commenced on 1 November 2013.
This is the Fifty-seventh Monthly EM&A report
presenting the EM&A works carried out during the period from 1 to 31 July
2018 for the Contract No. HY/2012/08 Northern Connection
Sub-sea Tunnel Section (the “Project”) in
accordance with the Updated EM&A Manual of the TM-CLK
Link Project. As informed by the
Contractor, major activities in the reporting period included:
Land-based Works
·
Box Culvert Extension at Works Area – Portion N-A;
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Cross Passage Construction by Pipe Jacking – TBM
Tunnel;
·
Corbel & OVHD Construction – TBM Tunnel;
·
Parapet wall and fireboard Installation – TBM Tunnel;
·
Bulk Excavation – Portion N-A; and
·
CSM treatment, Jet Grouting works and D-wall
Construction – Portion S-A
There was no dredging, reclamation or marine sheet
piling works in open waters during this reporting period.
A summary of monitoring and audit activities conducted
in the reporting period is listed below:
24-hour TSP Monitoring 10
sessions
1-hour TSP Monitoring 10
sessions
Impact Dolphin Monitoring 2 sessions
Joint Environmental Site Inspection 4 sessions
Implementation
of Marine Mammal Exclusion Zone
There was no dredging, reclamation or
marine sheet piling works in open waters during this reporting period.
Thus, Passive Acoustic Monitoring (PAM) and the day-time monitoring of Dolphin
Exclusion Zone (DEZ) by dolphin observers were not in effect during the
reporting period.
Summary of Breaches of Action/Limit Levels
Breaches of
Action and Limit Levels for Air Quality
No exceedance of 1-hour and 24-hour TSP was recorded
in this reporting month.
Breaches
of Action and Limit Levels for Dolphin Monitoring .
Due
to monthly variation in dolphin occurrence within the survey area, it would be
more appropriate to draw conclusion on whether any unacceptable impacts on
dolphins have been detected in relation to the construction activities of this
Project in the quarterly EM&A reports, where comparison on distribution,
group size and encounter rates of dolphins between the quarterly impact
monitoring period and baseline monitoring period will be made.
Summary of Marine Travel Route record
No
non-compliance with EIA recommendations, EP conditions and other requirements associated
with the marine travel route record of this Contract was recorded in July 2018.
Environmental Complaints, Non-compliance & Summons
No
non-compliance with EIA recommendations, EP conditions and other requirements
associated with the construction of this Contract was recorded in this
reporting period.
No
environmental complaint was received in this reporting period.
No environmental summons was received in this
reporting period.
Reporting Change
There was no reporting change required in the reporting
period.
Upcoming Works for the Next Reporting Month
Works to be undertaken in the next monitoring period
of August 2018 include the following:
Land-based Works
·
Construction of Cross Passage Tympanum – TBM tunnel;
·
Cross Passage Construction by Pipe Jacking – TBM
tunnel;
·
Cross Passage Lining Installation – TBM Tunnel;
·
Parapet wall and fireboard Installation – TBM Tunnel
·
Corbel & OVHD Construction – TBM Tunnel;
·
Bulk Excavation – Portion S-A; and
·
CSM treatment, Jet Grouting works and D-wall
Construction – Portion S-A
There will be no dredging, reclamation or marine sheet
piling works in open waters during next reporting period.
Future Key Issue
Potential environmental impacts arising from the above
upcoming construction activities in the next reporting month of August 2018 are
mainly associated with dust, marine ecology and waste management issues.
According to the findings of the Northwest New Territories
(NWNT) Traffic and Infrastructure Review conducted by the Transport Department,
Tuen Mun Road, Ting Kau Bridge, Lantau Link and North Lantau Highway would be
operating beyond capacity after 2016.
This forecast has been based on the estimated increase in cross boundary
traffic, developments in the Northwest New Territories (NWNT), and possible
developments in North Lantau, including the Airport developments, the Lantau
Logistics Park (LLP) and the Hong Kong – Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated traffic
demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek
Lap Kok Link (TM-CLKL) and Tuen Mun Western Bypass (TMWB) are proposed.
An Environmental Impact Assessment (EIA) of TM-CLKL
(the Project) was prepared in accordance with the EIA Study Brief (No.
ESB-175/2007) and the Technical
Memorandum of the Environmental Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the
Environmental Impact Assessment Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA Report
(EIAO Register Number AEIAR-146/2009), an Environmental Permit (EP-354/2009)
for TM-CLKL was granted by the Director of Environmental Protection (DEP) on 4
November 2009, and EP variation (VEP) (EP-354/2009/A) was issued on 8 December
2010. Subsequent applications for
variation of environmental permits (VEPs), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D,
were granted on 28 January 2014, 10 December 2014 and 13 March 2015,
respectively.
Under Contract
No. HY/2012/08, Dragages – Bouygues Joint Venture (DBJV) is commissioned by
the Highways Department (HyD) to undertake the design and construction of the
Northern Connection Sub-sea Tunnel Section of TM-CLKL while AECOM
Asia Company Limited was appointed by HyD as the Supervising Officer. For implementation of the environmental
monitoring and audit (EM&A) programme under the Contract, ERM-Hong Kong,
Limited (ERM) has been appointed as the Environmental Team (ET). Ramboll Hong
Kong Ltd. was employed by HyD as the Independent Environmental Checker (IEC)
and Environmental Project Office (ENPO).
Layout of the Contract components is
presented in Figure 1.1.
The organization structure of the Contract is shown in
Appendix A. The key personnel contact names and contact
details are summarized in Table 1.1
below.
Table 1.1 Contact Information of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways
Department |
Engr 22/HZMB |
Chow Man Lung,
Andrew |
2762 4110 |
2762 4110 |
SOR (AECOM Asia
Company Limited) |
Chief Resident
Engineer |
Roger Man Andrew
Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
ENPO / IEC (Ramboll Hong
Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465
2850 |
3465 2899 |
IEC |
Dr. F.C. Tsang |
3465
2851 |
3465 2899 |
|
Contractor (Dragages – Bouygues Joint Venture) |
Environmental
Officer |
Bryan Lee |
2293 7323 |
2293 7499 |
|
24-hour
hotline |
|
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jasmine Ng |
2271 3311 |
2723 5660 |
Table 1.2 Summary of Construction Activities Undertaken during the
Reporting Period
Construction Activities Undertaken |
Land-based Works |
·
Box Culvert Extension at Works Area – Portion N-A; ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Cross Passage Construction by Pipe Jacking – TBM
Tunnel; ·
Corbel & OVHD Construction – TBM Tunnel; ·
Parapet wall and fireboard Installation – TBM
Tunnel; ·
Bulk Excavation – Portion N-A; and ·
CSM treatment, Jet Grouting works and D-wall
Construction – Portion S-A |

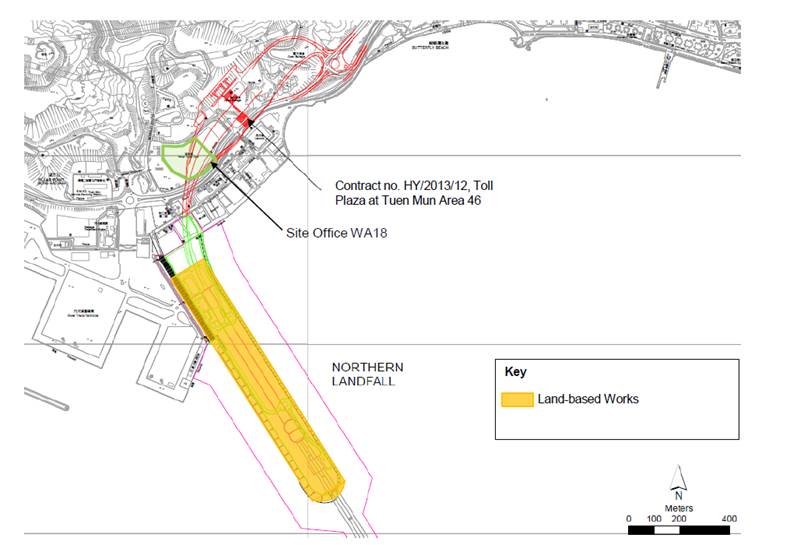

Figure 1.2 Locations of Construction Activities – July 2018
|
The EM&A programme required environmental
monitoring for air quality, water quality and marine ecology as well as
environmental site inspections for air quality, noise, water quality, waste
management, marine ecology and landscape and visual impacts. The EM&A requirements and related
findings for each component are summarized in the following sections
In accordance with the Updated EM&A Manual and the
Enhanced TSP Monitoring Plan, impact 1-hour TSP monitoring was conducted three (3)
times every six (6) days and impact 24-hour TSP monitoring was carried out once
every six (6) days when the highest dust impact was expected. 1-hr and 24-hr TSP monitoring frequency was
increased to three times per day every three days and daily every three days,
respectively, as excavation works for launching shaft commenced on 24 October
2014.
High volume samplers (HVSs) were used to carry out the
1-hour and 24-hour TSP monitoring on 3, 6, 9, 12, 15, 18, 21, 24, 27 and 30
July 2018 at the five (5) air quality monitoring stations in accordance with
the requirements stipulated in the Updated EM&A Manual (Figure 2.1; Table 2.1). Wind meter was installed at the rooftop of
ASR5 for logging wind speed and wind direction.
Details of the equipment deployed are provided in Table 2.2. Copies of the
calibration certificates for the equipment are presented in Appendix E.
Table
2.1 Locations of Impact Air Quality Monitoring
Stations and Monitoring Dates in this Reporting Period
Monitoring Station |
Monitoring Dates |
Location |
Description |
Parameters
& Frequency |
ASR1 |
3,
6, 9, 12, 15, 18, 21, 24, 27 and 30 July 2018 |
Tuen
Mun Fireboat Station |
Office |
TSP monitoring
1-hour Total Suspended
Particulates (1-hour TSP, µg/m3), 3 times in every 6 days
24-hour Total Suspended
Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 6
days Enhanced TSP monitoring (commenced on 24 October 2014)
1-hour Total Suspended Particulates
(1-hour TSP, µg/m3), 3 times in every 3 days
24-hour Total Suspended
Particulates (24-hour TSP, µg/m3), daily for 24-hour in every 3
days |
ASR5 |
|
Pillar
Point Fire Station |
Office |
|
AQMS1 |
|
Previous
River Trade Golf |
Bare
ground |
|
ASR6 |
|
Butterfly
Beach Laundry |
Office |
|
ASR10 |
|
Butterfly
Beach Park |
Recreational
uses |
Table 2.2 Air
Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total
Suspended Particulate (TSP) High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model: Vantage Pro 2 (S/N: AS160104014) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The Action and Limit Levels of the air quality
monitoring is provided in Appendix D. The Event and Action plan is presented in Appendix J.
The schedule for air quality monitoring in July 2018
is provided in Appendix F.
The monitoring results for 1-hour TSP and 24-hour TSP
are summarized in Tables 2.3 and 2.4, respectively. Detailed impact air quality monitoring
results and graphical presentations are presented in Appendix G.
Table 2.3 Summary of 1-hour TSP Monitoring Results in this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
112 |
45
- 283 |
331 |
500 |
ASR5 |
134 |
20
- 236 |
340 |
500 |
AQMS1 |
87 |
50
– 138 |
335 |
500 |
ASR6 |
92 |
22
- 215 |
338 |
500 |
ASR10 |
48 |
17
- 91 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
50 |
19
- 70 |
213 |
260 |
ASR5 |
69 |
47
- 101 |
238 |
260 |
AQMS1 |
42 |
25
- 54 |
213 |
260 |
ASR6 |
47 |
23
- 72 |
238 |
260 |
ASR10 |
34 |
17
- 50 |
214 |
260 |
The weather condition during the monitoring period
varied from sunny to cloudy. The major dust
sources in the reporting period included construction activities under the
Contract as well as nearby traffic emissions.
A total of 10 1-hour TSP and 24-hour TSP monitoring
were undertaken in which no exceedance of 1-hour and 24-hour TSP was recorded
in this reporting month.
Meteorological information collected at the ASR5,
including wind speed and wind direction, is provided in Appendix H.
Seawall Enhancement Works at Northern Landfall has
been completed on 31 December 2017.
Notification of suspension of water quality monitoring has been approved
by EPD on 2 March 2018.
Impact dolphin monitoring is required to be conducted by
a qualified dolphin specialist team to evaluate whether there have been any
effects on the dolphins. In order to
fulfil the EM&A requirements and make good use of available resources, the
on-going impact line transect dolphin monitoring data collected by HyD’s Contract No. HY/2011/03 Hong Kong-Zhuhai-Macao Bridge. Hong Kong
Link Road - Section between Scenic Hill and Hong Kong Boundary Crossing
Facilities on the monthly basis is adopted to avoid duplicates of survey
effort.
Table 2.5
summarises the equipment used for the impact dolphin monitoring.
Table 2.5 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning
System (GPS) |
Garmin 18X-PC Geo One Phottix |
Camera |
Nikon D90 300m 2.8D fixed focus Nikon D90 20-300m zoom lens |
Laser Binocular |
Infinitor LRF 1000 |
Marine Binocular |
Bushell 7 x 50 marine binocular with compass and reticules |
Vessel for Monitoring |
65 foot single engine motor vessel with viewing platform 4.5m above
water level |
Dolphin monitoring should cover all transect lines in
Northeast Lantau (NEL) and the Northwest Lantau (NWL) survey areas twice per
month throughout the entire construction period. The monitoring data should be compatible
with, and should be made available for, long-term studies of small cetacean
ecology in Hong Kong. In order to
provide a suitable long-term dataset for comparison, identical methodology and
line transects employed in baseline dolphin monitoring was followed in the
impact dolphin monitoring.
The impact dolphin monitoring was carried out in the
NEL and NWL along the line transect as depicted in Figure 2.2. The co-ordinates of all transect lines are
shown in Table 2.6 below.
Table 2.6 Impact Dolphin Monitoring Line Transect Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||
1 |
Start
Point |
804671 |
815456 |
13 |
Start
Point |
816506 |
819480 |
1 |
End
Point |
804671 |
831404 |
13 |
End
Point |
816506 |
824859 |
2 |
Start
Point |
805476 |
820800* |
14 |
Start
Point |
817537 |
820220 |
2 |
End
Point |
805476 |
826654 |
14 |
End
Point |
817537 |
824613 |
3 |
Start
Point |
806464 |
821150* |
15 |
Start
Point |
818568 |
820735 |
3 |
End
Point |
806464 |
822911 |
15 |
End
Point |
818568 |
824433 |
4 |
Start
Point |
807518 |
821500* |
16 |
Start
Point |
819532 |
821420 |
4 |
End
Point |
807518 |
829230 |
16 |
End
Point |
819532 |
824209 |
5 |
Start
Point |
808504 |
821850* |
17 |
Start
Point |
820451 |
822125 |
5 |
End
Point |
808504 |
828602 |
17 |
End
Point |
820451 |
823671 |
6 |
Start
Point |
809490 |
822150* |
18 |
Start
Point |
821504 |
822371 |
6 |
End
Point |
809490 |
825352 |
18 |
End
Point |
821504 |
823761 |
7 |
Start
Point |
810499 |
822000* |
19 |
Start
Point |
822513 |
823268 |
7 |
End
Point |
810499 |
824613 |
19 |
End
Point |
822513 |
824321 |
8 |
Start
Point |
811508 |
821123 |
20 |
Start
Point |
823477 |
823402 |
8 |
End
Point |
811508 |
824254 |
20 |
End
Point |
823477 |
824613 |
9 |
Start
Point |
812516 |
821303 |
21 |
Start
Point |
805476 |
827081 |
9 |
End
Point |
812516 |
824254 |
21 |
End
Point |
805476 |
830562 |
10 |
Start
Point |
813525 |
821176 |
22 |
Start
Point |
806464 |
824033 |
10 |
End
Point |
813525 |
824657 |
22 |
End
Point |
806464 |
829598 |
11 |
Start
Point |
814556 |
818853 |
23 |
Start
Point |
814559 |
821739 |
11 |
End
Point |
814556 |
820992 |
23 |
End
Point |
814559 |
824768 |
12 |
Start
Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
12 |
End
Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
The Action and Limit levels of impact dolphin
monitoring are shown in Appendix D. The Event and Action plan is presented in Appendix J.
Dolphin monitoring was carried out on 3, 9, 12 and 20
of July 2018. The dolphin monitoring
schedule for the reporting month is shown in Appendix F.
One group of 4 Chinese White Dolphins sightings were
recorded during the two sets of surveys in July 2018. The dolphin sighting was made in NWL, while
none was sighted in NEL. The dolphin
sighting was made on primary lines during on-effort search . It was not associated with any operating
fishing vessel.
No dolphin sighting was made in the proximity
of the TM-CLKL alignment. The distribution of dolphin sightings during the
reporting month is shown in Figure 2.3.
Encounter rates of Chinese White Dolphins are deduced
from the survey effort and on-effort sighting data made under favourable
conditions (Beaufort 3 or below) in July 2018 with the results present in Tables 2.7 and 2.8.
Table 2.7 Individual Survey Event Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort sightings per
100 km of survey effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: July 3rd
/ 9th |
0.0 |
0.0 |
Set 2: July 12th
/ 20th |
0.0 |
0.0 |
|
NWL |
Set 1: July 3rd
/ 9th |
0.0 |
0.0 |
Set 2: July 12th
/ 20th |
1.7 |
6.7 |
Note: Dolphin Encounter Rates
are deduced from the Two Sets of Surveys (Two Surveys in Each Set) in July 2018
in Northeast (NEL) and Northwest Lantau (NWL)
Table 2.8 Monthly Average Encounter Rates
|
Encounter rate (STG) (no. of on-effort dolphin sightings per 100
km of survey effort) |
Encounter rate (ANI) (no. of dolphins from all on-effort
sightings per 100 km of survey effort) |
||
Primary
Lines Only |
Both Primary and Secondary Lines |
Primary
Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
0.9 |
0.7 |
3.7 |
2.7 |
Note:
Overall dolphin encounter rates (sightings per 100 km of survey effort) from
all four surveys are conducted in July 2018 on primary lines
only as well as both primary lines and secondary lines in Northeast and
Northwest Lantau.
Due
to monthly variation in dolphin occurrence within the survey area, it would be
more appropriate to draw conclusion on whether any unacceptable impacts on
dolphins have been detected in relation to the construction activities of this
Project in the quarterly EM&A reports, where comparison on distribution,
group size and encounter rates of dolphins between the quarterly impact
monitoring period and baseline monitoring period will be made.
There was no dredging, reclamation or marine
sheet piling works in open waters during this reporting period. Thus,
Passive Acoustic Monitoring (PAM) and the day-time monitoring of Dolphin
Exclusion Zone (DEZ) by dolphin observers were not in effect during the
reporting period.
Site inspections were carried out on a weekly basis to
monitor the implementation of proper environmental pollution control and
mitigation measures under the Contract.
In the reporting month, four (4) site inspections were carried out on 4,
11, 18 and 25 July 2018.
Key observations and recommendations during the site
inspections in this reporting period are summarized in Table 2.9.
Table 2.9 Specific Observations and Recommendations during the Weekly Site
Inspection in this Reporting Month
Inspection Date |
Observations |
Recommendations/ Remarks |
4 July 2018 |
Works
Area – Portion N-C Drip
tray should be provided for the oil drums. Works
Area – Portion N-A Stagnant
water in the drip tray should be removed. Standard
NRMM label should be displayed on the generator. Works
Area – Portion S-B Drip
tray should be provided for the oil drums. Drip
tray should be provided for the oil drums. |
Works
Area – Portion N-C The
Contractor was reminded to provide drip tray for the oil drums. Works
Area – Portion N-A The
Contractor was reminded to remove the stagnant water in the drip tray. The
Contractor was reminded to displayed standard NRMM label on the generator. Works
Area – Portion S-B The
Contractor was reminded to provide drip tray for the oil drums. The
Contractor was reminded to provide drip tray for the oil drums. |
11
July 2018 |
Works
Area – TBM tunnel Accumulated
rubbish in the skip should be removed. Works
Area – Portion S-B Sand
bags should be provided to prevent the leakage of muddy substance to the sea. Reminder from the SOR Works
Area - Portion N-A The
hammer portion of the breaker should be wrapped with soundproof mat. |
Works
Area – TBM tunnel The
Contractor was reminded to remove the accumulated rubbish in the skip. Works
Area – Portion S-B The
Contractor was reminded to provide sand bags to prevent the leakage of muddy
substance to the sea. Reminder from the SOR Works
Area - Portion N-A The
Contractor was reminded to wrap the hammer protion of the breaker with
soundproof mat. |
18 July 2018 |
Works
Area – Portion N-C Drip
tray should be provided for the chemical containers. Drip
tray should be provided for the chemical containers. |
Works
Area – Portion N-C The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to provide drip tray for the chemical containers. |
25
July 2018 |
Works
Area - Portion N-C Drip
tray should be provided for the chemical containers. Drip
tray should be provided for the chemical containers. Works
Area - Portion N-A Stagnant
water on the concrete block should be cleared. Works
Area - Portion S-B Drip
tray should be provided for the chemical containers. |
Works
Area - Portion N-C The
Contractor was reminded to provide drip tray for the chemical containers. The
Contractor was reminded to provide drip tray for the chemical containers. Works
Area - Portion N-A The
Contractor was reminded to clear the stagnant water on the concrete block. Works
Area - Portion S-B The
Contractor was reminded to provide drip tray for the chemical containers. |
The Contractor has rectified all of the observations
as identified during environmental site inspections in the reporting
month.
The Contractor had submitted application form for
registration as chemical waste producer under the Contract. Sufficient numbers of receptacles were
available for general refuse collection and sorting.
Wastes generated during this reporting period included
mainly construction wastes (inert and non-inert), chemical wastes and marine
sediment. Reference has been made to the
waste flow table prepared by the Contractor (Appendix L). The quantities
of different types of wastes are summarized in Table 2.10.
Table 2.10 Quantities of Different Waste Generated in the Reporting Month
Month/Year |
Inert Construction Waste (a)
(tonnes) |
Inert Construction Waste Re-used (tonnes) |
Non-inert Construction Waste (b)
(tonnes) |
Imported
Fill (m3) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
||
|
Category L |
Category M (Mp & Mf) |
|||||||
July 2018 |
43,768 |
0 |
768 |
0 |
770 |
0 |
0 |
5,650 |
|
|
Notes: |
|
|||||||
|
(a) Inert
construction wastes include hard rock and large broken concrete, and materials
disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
|
|||||||
The Contractor was advised to properly maintain on
site C&D materials and waste collection, sorting and recording system,
dispose of C&D materials and wastes at designated ground and maximize
reuse/ recycle of C&D materials and wastes.
The Contractor was also reminded to properly maintain the site tidiness
and dispose of the wastes accumulated on site regularly and properly.
For chemical waste containers, the Contractor was
reminded to treat properly and store temporarily in designated chemical waste
storage area on site in accordance with the Code of Practice on the Packaging,
Labelling and Storage of Chemical Wastes.
The status of environmental licensing and permit is
summarized in Table 2.11 below.
Table 2.11 Summary of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental
Permit |
EP-354/2009/D |
13
March 2015 |
Throughout
the Contract |
HyD |
Application for VEP on 3 March 2015 to supersede
EP-354/2009/C |
Construction
Dust Notification |
363510 |
19
August 2013 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Construction
Dust Notification |
403620 |
10 June 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Chemical
Waste Registration |
5213-422-D2516-02 |
18 January 2017 |
Throughout
the Contract |
DBJV |
Northern Landfall |
Chemical
Waste Registration |
5213-951-D2591-01 |
25 May 2016 |
Throughout
the Contract |
DBJV |
Southern Landfall |
Construction
Waste Disposal Account |
7018108 |
28
August 2013 |
Throughout
the Contract |
DBJV |
Waste disposal in Contract No. HY/2012/08 |
Construction
Waste Disposal Account |
7021715 |
17
April 2018 |
17
July 2018 |
DBJV |
Vessel Disposal |
Waste
Water Discharge License |
WT00019248-2014 |
5
June 2014 |
30
June 2019 |
DBJV |
For site Portion N6 and Reclamation Area E |
Waste
Water Discharge License |
WT00025944-2016 |
15 December 2016 |
31 December 2021 |
DBJV |
Southern Landfall |
Marine
Dumping Permit |
EP/MD/19-009 |
28 June 2018 |
27 July 2018 |
DBJV |
Type 1 (Dedicated site) and Type 2 (Confined Marine
Disposal) |
Construction
Noise Permit |
GW-RW0538-17 |
16 April 2018 |
15 October 2018 |
DBJV |
For
Urmston Road in front of Pillar Point |
Construction Noise Permit |
PP-RS0026-17 |
3 April 2017 |
31 July 2018 |
DBJV |
Southern Landfall (Percussive Piling) |
Construction Noise Permit |
GW-RW0060-18 |
20 February 2018 |
19 August 2018 |
DBJV |
WA23
@ Tsing Yi |
Construction Noise Permit |
GW-RS0598-18 |
15 July 2018 |
14 January 2019 |
DBJV |
Southern
Landfall |
Notes: |
|||||
HyD
= Highways Department DBJV
= Dragages – Bouygues Joint Venture VEP
= Variation of Environmental Permit |
In response to the site audit findings, the
Contractors carried out all corrective actions.
A summary of the Implementation Schedule of
Environmental Mitigation Measures (EMIS) is presented in Appendix C. The necessary mitigation measures relevant to this Contract
were implemented properly.
No exceedance of 1-hour and 24-hour TSP was recorded
in this reporting month.
Cumulative statistics are provided in Appendix K.
The Environmental Complaint Handling Procedure is
provided in Figure 2.4.
No
environmental complaint was received in this reporting period.
No environmental summons was received in this
reporting period.
Statistics on complaints, notifications of summons and
successful prosecutions are summarized in Appendix
K.
As informed by the Contractor, the major works for the
Project in August 2018 are summarized in Table
3.1.
Table
3.1 Construction Works to Be Undertaken in the Coming Month
Works to be undertaken |
Land-based
Works ·
Construction of Cross Passage Tympanum – TBM tunnel; ·
Cross Passage Construction by Pipe Jacking – TBM
tunnel; ·
Cross Passage Lining Installation – TBM Tunnel; ·
Parapet wall and fireboard Installation – TBM Tunnel ·
Corbel & OVHD Construction – TBM Tunnel; ·
Bulk Excavation – Portion S-A; and ·
CSM treatment, Jet Grouting works and D-wall
Construction – Portion S-A There will be no dredging, reclamation or marine
sheet piling works in open waters during next reporting period. |
Potential environmental impacts arising from the above
upcoming construction activities in the next reporting month of August 2018 are
mainly associated with dust, marine ecology and waste management issues.
The tentative schedule for environmental monitoring in
August 2018 is provided in Appendix
F.
This Fifty-seventh Monthly EM&A Report presents
the findings of the EM&A activities undertaken during the period from 1 to
31 July 2018, in accordance with the Updated EM&A Manual and the
requirements of EP-354/2009/D.
Air quality (including 1-hour TSP and 24-hour TSP) and
dolphin monitoring were carried out in this reporting month.
No exceedance of 1-hour and 24-hour TSP was recorded
in this reporting month.
One group of 4 Chinese White Dolphins sightings were
recorded during the two sets of surveys in July 2018. The dolphin sighting was made in NWL, while
none was sighted in NEL. The dolphin
sighting was made on primary lines during on-effort search . It was not associated with any operating
fishing vessel.
Environmental site inspection was carried out four (4)
times in July 2018. Remedial
actions recommended for the deficiencies identified during the site audits were
properly implemented by the Contractor.
No non-compliance event was recorded during the
reporting period.
No
environmental complaint was received in this reporting period.
No environmental summons was received in this
reporting period.
The ET will keep track on the construction works to
confirm compliance of environmental requirements and the proper implementation
of all necessary mitigation measures.
