table of Contents
1.1
Background
1.2
Scope of Report
1.3
Organization Structure
1.4
Summary of Construction Works
2.1
Air quality
2.2
Water Quality Monitoring
2.3
Dolphin Monitoring
2.4
EM&A Site Inspection
2.5
Waste Management Status
2.6
Environmental Licenses and Permits
2.7
Implementation Status of Environmental Mitigation Measures
2.8
Summary of Exceedances of the Environmental Quality Performance
Limit
2.9
Summary of Complaints, Notification of Summons and Successful
Prosecutions
3.1
Construction Activities for the Coming Month
3.2
Key Issues for the Coming Month
3.3
Monitoring Schedule for the Coming Month
4
Conclusions and recommendations
4.1
Conclusions
Under
Contract No. HY/2012/08, Dragages – Bouygues
Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Northern Connection Sub-sea Tunnel Section of the Tuen
Mun – Chek Lap Kok Link Project (TM-CLK Link Project) while AECOM Asia Company Limited
was appointed by HyD as the Supervising Officer.
For implementation of the environmental monitoring and audit
(EM&A) programme under the Contract, ERM-Hong
Kong, Limited (ERM) has been appointed as the Environmental Team (ET) in
accordance with Environmental Permit No. EP-354/2009/A. Ramboll Hong Kong Ltd. was employed by HyD as
the Independent Environmental Checker (IEC) and Environmental Project Office
(ENPO). Subsequent applications for variation of environmental permits
(VEP), EP-354/2009/B, EP-354/2009/C and EP-354/2009/D, were granted on 28 January 2014, 10 December 2014 and 13
March 2015, respectively.
The construction phase of
the Contract commenced on 1 November 2013 and will
tentatively be completed by the end of 2019. The impact monitoring
of the EM&A programme, including air quality,
water quality, marine ecological monitoring and environmental site inspections,
were commenced on 1 November 2013.
This is the Seventy-second
Monthly EM&A report presenting the EM&A works carried out during the
period from 1 to 31 October 2019 for the Contract
No. HY/2012/08 Northern Connection Sub-sea Tunnel Section (the “Contract”) in accordance with the Updated EM&A Manual of the TM-CLK Link Contract. As informed by the Contractor, major activities in
the reporting period included:
Land-based Works
· Construction
of Thermal barrier – TBM tunnel;
· Construction
of Walkway Corbel & Cover – TBM Tunnel;
· Road
& Drainage works – Portion N-A
· RC
structure – Portion S-A;
· E&M
Platform Installation – Portion S-A
· Backfilling
– Portion S-A & S-C;
· Cut
& Cover Tunnel RC structure – Portion S-C
Marine-based Works
· Seawall
Modification Works – Portion S-B
A summary of monitoring and
audit activities conducted in the reporting period is listed
below:
24-hour TSP
Monitoring
10 sessions
1-hour TSP
Monitoring
10 sessions
Water Quality
Monitoring
13 sessions
Impact Dolphin
Monitoring
2 sessions
Joint Environmental Site
Inspection 5 sessions
Implementation of Marine
Mammal Exclusion Zone
Daily
marine mammal exclusion zone was in effect during the period of silt curtain
installation in open waters under this Contract. No sighting of the
Indo-Pacific humpback dolphin Sousa chinensis (i.e.
Chinese White Dolphin) was recorded in October 2019
during the exclusion zone monitoring.
Summary of Breaches of
Action/Limit Levels
Breaches of Action and Limit
Levels for Air Quality
Three (3) Action Level
exceedances of 1-hour TSP Monitoring were recorded in
the air quality monitoring of this reporting month.
Breaches of Action and Limit
Levels for Water Quality
Two (2) Action Level
exceedances for Depth-averaged suspended soilds were recorded in the water quality monitoring of this
reporting month.
Breaches of Action and Limit
Levels for Dolphin Monitoring
Due to monthly variation in dolphin occurrence within
the survey area, it would be more appropriate to draw conclusion on whether any
unacceptable impacts on dolphins have been detected in relation to the
construction activities of this Contract in the quarterly EM&A reports,
where comparison on distribution, group size and encounter rates of dolphins
between the quarterly impact monitoring period and baseline monitoring period
will be made.
Environmental Complaints,
Non-compliance & Summons
No non-compliance with EIA recommendations, EP conditions and other requirements associated with the construction
of this Contract was recorded in this reporting period.
No
environmental complaint was received in this reporting
period.
No environmental summons was received in this reporting period.
Reporting Change
Contract No. HY/2012/08 has
taken over the responsibility for implementation of dolphin monitoring from
HZMB HKLR Contract No. HY/2011/03 since October 2019.
Upcoming Works for the Next
Reporting Month
Works to be
undertaken in the next monitoring period of November 2019 include the
following:
Land-based Works
·
Construction of Thermal barrier – TBM tunnel;
·
Construction of Walkway Corbel & Cover – TBM Tunnel;
·
Road & Drainage works – Portion N-A
·
Gantry Crane Removal – Portion N-B
·
RC structure – Portion S-A;
·
E&M Platform Installation – Portion S-A
·
Backfilling – Portion S-A & S-C;
·
Cut & Cover Tunnel RC structure – Portion S-C
·
Tower Crane Removal – Portion S-C
Marine-based Works
·
Seawall Modification Works – Portion S-B
Future Key Issue
Potential
environmental impacts arising from the above upcoming construction activities in
the next reporting month of November 2019 are mainly associated with dust,
marine water quality, marine ecology and waste management issues.
According to the findings of
the Northwest New Territories (NWNT) Traffic and Infrastructure Review
conducted by the Transport Department, Tuen Mun Road, Ting Kau Bridge, Lantau
Link and North Lantau Highway would be operating beyond capacity after 2016.
This forecast has been based on the estimated
increase in cross boundary traffic, developments in the Northwest New
Territories (NWNT), and possible developments in North Lantau, including the
Airport developments, the Lantau Logistics Park (LLP) and the Hong Kong –
Zhuhai – Macao Bridge (HZMB). In order to cope with the anticipated
traffic demand, two new road sections between NWNT and North Lantau – Tuen Mun – Chek
Lap Kok Link (TM-CLKL) and Tuen
Mun Western Bypass (TMWB) are
proposed.
An Environmental Impact Assessment
(EIA) of TM-CLKL (the Project) was prepared in accordance with the EIA Study
Brief (No. ESB-175/2007) and the Technical Memorandum of the Environmental
Impact Assessment Process (EIAO-TM). The EIA Report was submitted under the Environmental Impact Assessment
Ordinance (EIAO) in August 2009. Subsequent to the approval of the EIA
Report (EIAO Register Number AEIAR-146/2009), an
Environmental Permit (EP-354/2009) for TM-CLKL was granted by the Director of
Environmental Protection (DEP) on 4 November 2009, and EP variation
(VEP) (EP-354/2009/A) was issued on 8 December 2010. Subsequent
applications for variation of environmental permits (VEPs), EP-354/2009/B,
EP-354/2009/C and EP-354/2009/D, were granted
on 28 January 2014, 10 December 2014 and 13 March 2015, respectively.
Under
Contract No. HY/2012/08, Dragages – Bouygues
Joint Venture (DBJV) is commissioned by the Highways Department (HyD) to undertake the design and construction of the
Northern Connection Sub-sea Tunnel Section of TM-CLKL while AECOM Asia Company Limited
was appointed by HyD as the Supervising Officer.
For implementation of the environmental monitoring and audit
(EM&A) programme under the Contract, ERM-Hong
Kong, Limited (ERM) has been appointed as the Environmental Team (ET). Ramboll Hong Kong Ltd. was employed by HyD as the
Independent Environmental Checker (IEC) and Environmental Project Office (ENPO).
Layout
of the Contract components is presented in Figure 1.1.
The organization structure
of the Contract is shown in Appendix A. The
key personnel contact names and contact details are
summarized in Table 1.1 below.
Table 1.1 Contact Information
of Key Personnel
Party |
Position |
Name |
Telephone |
Fax |
Highways
Department |
Engr 24/SD |
Ken T.M. Cheng |
2762 4062 |
3188 6614 |
SOR (AECOM Asia
Company Limited) |
Chief Resident
Engineer |
Roger Man Andrew Westmoreland |
2293 6388 2293 6360 |
2293 6300 2293 6300 |
ENPO / IEC (Ramboll Hong Kong Ltd.) |
ENPO Leader |
Y.H. Hui |
3465 2850 |
3465 2899 |
IEC |
Dr. F.C. Tsang |
3465 2851 |
3465 2899 |
|
Contractor (Dragages – Bouygues Joint Venture) |
Deputy Environmental
Manager |
Bryan Lee |
2293 7323 |
2293 7499 |
|
24-hour hotline |
|
2293 7330 |
|
ET (ERM-HK) |
ET Leader |
Jasmine Ng |
2271 3311 |
2723 5660 |
Table 1.2 Summary of
Construction Activities Undertaken during the Reporting Period
Construction
Activities Undertaken |
Land-based Works |
·
Construction of Thermal barrier – TBM tunnel; ·
Construction of Walkway Corbel & Cover – TBM Tunnel; ·
Road & Drainage works – Portion N-A ·
RC structure – Portion S-A; ·
E&M Platform Installation – Portion S-A ·
Backfilling – Portion S-A & S-C; ·
Cut & Cover Tunnel RC structure – Portion S-C Marine-based Works ·
Seawall Modification Works – Portion S-B |

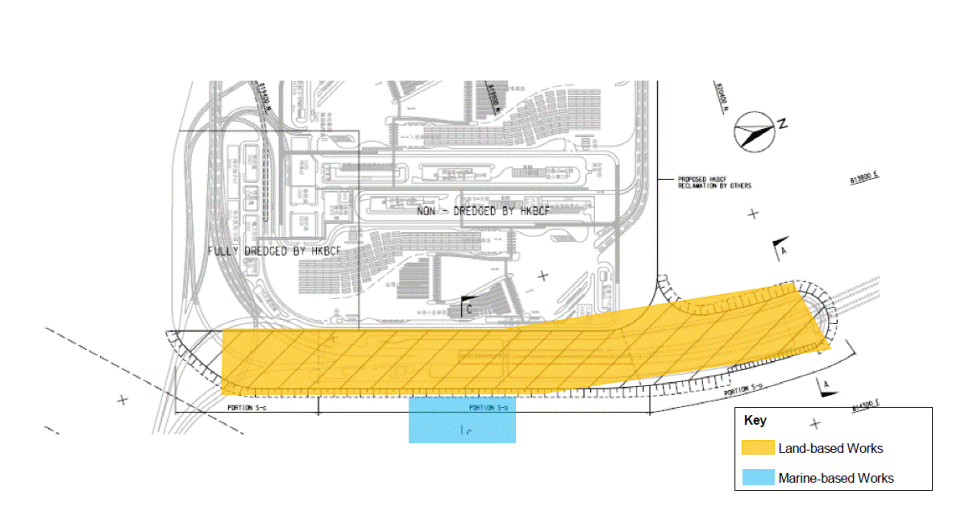

Figure 1.2 Locations of Construction Activities – October 2019
The EM&A programme required environmental monitoring for air
quality, water quality and marine ecology as well as environmental site
inspections for air quality, noise, water quality, waste management, marine
ecology and landscape and visual impacts. The EM&A requirements and
related findings for each component are summarized in
the following sections
In accordance with the
Updated EM&A Manual and the Enhanced TSP Monitoring Plan, impact 1-hour TSP
monitoring was conducted three (3) times every six (6) days and impact 24-hour
TSP monitoring was carried out once every six (6) days when the highest dust
impact was expected. 1-hr and 24-hr TSP monitoring frequency was increased to three times per day every three days and
daily every three days, respectively, as excavation works for launching shaft
commenced on 24 October 2014.
High volume samplers (HVSs) were used to carry out the 1-hour and
24-hour TSP monitoring on 2, 5, 8, 11, 14, 17, 20, 23, 26 and 29 October 2019
at the five (5) air quality monitoring stations in accordance with the
requirements stipulated in the Updated EM&A Manual (Figure 2.1; Table 2.1).
Wind meter was installed at the rooftop of ASR5
for logging wind speed and wind direction. Details of the equipment
deployed are provided in Table 2.2.
Copies of the calibration certificates for the equipment are presented in Appendix E.
Table 2.1 Locations of Impact Air Quality Monitoring
Stations and Monitoring Dates in this Reporting Period
Monitoring
Station |
Monitoring
Dates |
Location |
Description |
Parameters
& Frequency |
ASR1 |
2, 5, 8, 11, 14,
17, 20, 23, 26 and 29 October 2019 |
Tuen Mun
Fireboat Station |
Office |
TSP
monitoring Ÿ 1-hour Total Suspended Particulates (1-hour TSP, µg/m3),
3 times in every 6 days Ÿ 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour in every 6 days Enhanced
TSP monitoring (commenced on 24 October 2014) Ÿ 1-hour Total Suspended Particulates (1-hour TSP, µg/m3),
3 times in every 3 days Ÿ 24-hour Total Suspended Particulates (24-hour TSP, µg/m3),
daily for 24-hour in every 3 days |
ASR5 |
|
Pillar Point
Fire Station |
Office |
|
AQMS1 |
|
Previous River
Trade Golf |
Bare ground |
|
ASR6 |
|
Butterfly Beach
Laundry |
Office |
|
ASR10 |
|
Butterfly Beach
Park |
Recreational
uses |
Table 2.2 Air Quality Monitoring Equipment
Equipment |
Brand and Model |
High Volume Sampler |
Tisch Environmental Mass Flow Controlled Total Suspended Particulate (TSP)
High Volume Sampler (Model No. TE-5170) |
Wind Meter |
Davis (Model: Vantage Pro 2 (S/N:
AS160104014) |
Wind Anemometer for calibration |
Lutron (Model No. AM-4201) |
The Action and Limit Levels
of the air quality monitoring is provided in Appendix D. The
Event and Action plan is presented in Appendix K.
The schedule for air quality
monitoring in October 2019 is provided in Appendix F.
The monitoring results for
1-hour TSP and 24-hour TSP are summarized in Tables
2.3 and 2.4, respectively. Detailed impact air quality
monitoring results and graphical presentations are presented
in Appendix G.
Table 2.3 Summary of 1-hour TSP Monitoring Results in
this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
143 |
67 - 385 |
331 |
500 |
ASR5 |
191 |
69 - 288 |
340 |
500 |
AQMS1 |
118 |
56 - 204 |
335 |
500 |
ASR6 |
106 |
41 - 198 |
338 |
500 |
ASR10 |
64 |
35 - 136 |
337 |
500 |
Table 2.4 Summary of 24-hour TSP Monitoring Results in
this Reporting Period
Station |
Average (µg/m3) |
Range (µg/m3) |
Action Level (µg/m3) |
Limit Level (µg/m3) |
ASR1 |
90 |
46 - 147 |
213 |
260 |
ASR5 |
100 |
61 - 145 |
238 |
260 |
AQMS1 |
70 |
42 – 100 |
213 |
260 |
ASR6 |
74 |
47 - 111 |
238 |
260 |
ASR10 |
52 |
34 - 92 |
214 |
260 |
The weather condition during
the monitoring period varied from sunny to cloudy. The major dust sources
in the reporting period included construction activities under the Contract as
well as nearby traffic emissions.
A total of
10
1-hour TSP and 24-hour TSP monitoring were undertaken in this reporting
month. Three (3) Action Level exceedances of 1-hour TSP Monitoring were recorded in the air quality monitoring of this
reporting month.
Meteorological information
collected at the ASR5, including wind speed and wind direction, is provided in Appendix H.
The Seawall Modification
Works has commenced on 12 August 2019. Water quality monitoring was carried out in this reporting month.
In accordance with the
approved Environmental Review Report dated 21 March 2018 for the Change in
Design of Vertical Seawall to Sloping Seawall on Southern Landfall, Updated
Impact water quality monitoring programme and water
quality monitoring stations IS17, SR7 and IS(Mf)11 specified under the EM&A
Manual for HZMB HKBCF project will be adopted. (Figure 2.2; Table
2.5).
The Action and Limit Levels
of the water quality monitoring were adopted from the
EM&A Manual for HZMB HKBCF project. The Action and Limit Levels are provided in Appendix D.
Table 2.5 Locations of Water Quality Monitoring
Stations and the Corresponding Monitoring Requirements
Station ID |
Type |
Coordinates |
*Parameters, unit |
Depth |
Frequency |
|
|
|
Easting |
Northing |
|
|
|
IS(Mf)11 |
Impact Station (Close to HKBCF construction site) |
813562 |
820716 |
Ÿ Temperature(°C) Ÿ pH(pH unit) Ÿ Turbidity (NTU) Ÿ Water depth (m) Ÿ Salinity (ppt) Ÿ DO (mg/L and % of saturation) · SS (mg/L) |
3 water
depths: 1m below sea
surface, mid-depth
and 1m above sea bed. If the water depth is less than 3m, mid-depth
sampling only. If water depth less than 6m, mid-depth may be omitted. |
Impact monitoring: 3 days per week, at mid-flood and
mid-ebb tides during the construction period of the Contract. |
IS17 |
Impact
Station (Close to HKBCF construction site) |
814539 |
820391 |
|||
SR7 |
Sensitive
receivers (Tai Mo Do) |
814293 |
821431 |
|||
IS(Mf)9 |
Impact
Station (Close to HKBCF construction site) |
813273 |
818850 |
|
|
|
IS(Mf)16 |
Impact
Station (Close to HKBCF construction site) |
814328 |
819497 |
|
|
|
IS8(N) |
Impact
Station (Close to HKBCF construction site) |
814413 |
818570 |
|
|
|
SR4(N2) |
Sensitive
receiver (Tai Ho Inlet) |
814688 |
817996 |
|
|
|
SR4a |
Sensitive
receiver |
815247 |
818067 |
|
|
|
CS(Mf)3(N) |
Control
Station |
808814 |
822355 |
|
|
|
CS(Mf)5 |
Control
Station |
817990 |
821129 |
|
|
|
*Notes: In
addition to the parameters presented monitoring location/position, time,
water depth, sampling depth, tidal stages, weather conditions and any special
phenomena or works underway nearby were also recorded. Water Quality
Monitoring Station CS(Mf)3 was relocated to
CS(Mf)3(N) since 2 May 2017. Water Quality
Monitoring Station SR4 was relocated to SR4(N) since
2 March 2018. Water Quality
Monitoring Station SR4(N) was relocated to SR4(N2) since 12 June 2019 Water Quality Monitoring
Station IS8 was relocated to IS8(N) since 12 June
2019. |
Table 2.6 summarizes the equipment
used in the impact water quality monitoring programme. Copies of the calibration certificates are attached in Appendix E.
Table 2.6 Water Quality Monitoring Equipment
Equipment |
Model |
Multi-Parameters |
YSI ProDss 18A104824 |
Multi-Parameters |
YSI ProDss 0001C6A7 |
Multi-Parameters |
YSI ProDss 17H105557 |
Positioning Equipment |
Furuno GP-170 |
Water Depth
Detector |
Lowrance Mark 5x / Garmin Striker
4 |
The Action and Limit levels
of water quality impact monitoring are shown in Appendix D. The
Event and Action plan is presented in Appendix K.
The schedule for water
quality monitoring in October 2019 is provided in Appendix F.
Impact water quality
monitoring was conducted at all designated monitoring stations in the reporting
month. Results and graphical presentations of impact water quality
monitoring are presented in Appendix J.
In this reporting period, a total of thirteen (13) monitoring events were undertaken
in which Two (2) Action Level exceedances for Depth-averaged suspended soilds were recorded in the water quality monitoring.
Impact dolphin monitoring is
required to be conducted by a qualified dolphin specialist team to evaluate
whether there have been any effects on the dolphins. In order to fulfil
the EM&A requirements and make good use of available resources, Contract
No. HY/2012/08 has taken over the responsibility for implementation of dolphin
monitoring from HZMB HKLR Contract No. HY/2011/03 since October 2019.
Table 2.7 summarises the equipment used for the
impact dolphin monitoring.
Table 2.7 Dolphin Monitoring Equipment
Equipment |
Model |
Global Positioning System
(GPS) |
Garmin
18X-PC Geo One Phottix |
Camera |
Nikon D90 300m 2.8D fixed
focus Nikon D90 20-300m zoom
lens |
Laser Binocular |
Infinitor LRF 1000 |
Marine Binocular |
Bushell 7 x 50 marine binocular
with compass and reticules |
Vessel for
Monitoring |
65 foot single
engine motor vessel with viewing platform 4.5m above water level |
Dolphin monitoring should
cover all transect lines in Northeast Lantau (NEL) and the Northwest Lantau
(NWL) survey areas twice per month throughout the entire construction period.
The monitoring data should be compatible with, and should
be made available for, long-term studies of small cetacean ecology in
Hong Kong. In order to provide a suitable long-term dataset for
comparison, identical methodology and line transects
employed in baseline dolphin monitoring was followed in the impact dolphin
monitoring.
The impact dolphin
monitoring was carried out in the NEL and NWL along
the line transect as depicted in Figure 2.3. The co-ordinates of all transect
lines are shown in Table 2.8 below.
Table 2.8 Impact Dolphin Monitoring Line Transect
Co-ordinates
Line No. |
Easting |
Northing |
Line No. |
Easting |
Northing |
||||||||
1 |
Start Point |
804671 |
815456 |
13 |
Start Point |
816506 |
819480 |
|
|||||
1 |
End Point |
804671 |
831404 |
13 |
End Point |
816506 |
824859 |
|
|||||
2 |
Start Point |
805476 |
820800* |
14 |
Start Point |
817537 |
820220 |
|
|||||
2 |
End Point |
805476 |
826654 |
14 |
End Point |
817537 |
824613 |
|
|||||
3 |
Start Point |
806464 |
821150* |
15 |
Start Point |
818568 |
820735 |
|
|||||
3 |
End Point |
806464 |
822911 |
15 |
End Point |
818568 |
824433 |
|
|||||
4 |
Start Point |
807518 |
821500* |
16 |
Start Point |
819532 |
821420 |
|
|||||
4 |
End Point |
807518 |
829230 |
16 |
End Point |
819532 |
824209 |
|
|||||
5 |
Start Point |
808504 |
821850* |
17 |
Start Point |
820451 |
822125 |
|
|||||
5 |
End Point |
808504 |
828602 |
17 |
End Point |
820451 |
823671 |
|
|||||
6 |
Start Point |
809490 |
822150* |
18 |
Start Point |
821504 |
822371 |
|
|||||
6 |
End Point |
809490 |
825352 |
18 |
End Point |
821504 |
823761 |
|
|||||
7 |
Start Point |
810499 |
822000* |
19 |
Start Point |
822513 |
823268 |
|
|||||
7 |
End Point |
810499 |
824613 |
19 |
End Point |
822513 |
824321 |
|
|||||
8 |
Start Point |
811508 |
821123 |
20 |
Start Point |
823477 |
823402 |
|
|||||
8 |
End Point |
811508 |
824254 |
20 |
End Point |
823477 |
824613 |
|
|||||
9 |
Start Point |
812516 |
821303 |
21 |
Start Point |
805476 |
827081 |
|
|||||
9 |
End Point |
812516 |
824254 |
21 |
End Point |
805476 |
830562 |
|
|||||
10 |
Start Point |
813525 |
821176 |
22 |
Start Point |
806464 |
824033 |
|
|||||
10 |
End Point |
813525 |
824657 |
22 |
End Point |
806464 |
829598 |
|
|||||
11 |
Start Point |
814556 |
818853 |
23 |
Start Point |
814559 |
821739 |
|
|||||
11 |
End Point |
814556 |
820992 |
23 |
End Point |
814559 |
824768 |
|
|||||
12 |
Start Point |
815542 |
818807 |
24* |
Start Point |
805476* |
815900* |
|
|||||
12 |
End Point |
815542 |
824882 |
24* |
End Point |
805476* |
819100* |
|
|||||
The Action and Limit levels
of impact dolphin monitoring are shown in Appendix D. The
Event and Action plan is presented in Appendix K.
Dolphin monitoring was carried out on 8, 9, 14 and 29 of October 2019.
The dolphin monitoring schedule for the reporting
month is shown in Appendix
F.
One Chinese White Dolphins
sighting was recorded during the two sets of surveys
in October 2019. The dolphin sighting was made
in NWL, while none was sighted in NEL. The lone dolphin sighting was made during on-effort search and was made on primary
lines. The dolphin groups were not associated with any operating fishing
vessel.
No dolphin sighting was made in the proximity
of the TM-CLKL alignment. The distribution of dolphin sightings during the reporting month is shown in Figure 2.4.
Encounter rates of Chinese
White Dolphins are deduced from the survey effort and on-effort sighting data
made under favourable conditions (Beaufort 3 or
below) in October 2019 with the results present in Tables 2.9 and
2.10.
Table
2.9 Individual Survey Event
Encounter Rates
|
Encounter rate
(STG) (no. of on-effort
dolphin sightings per 100 km of survey effort) |
Encounter rate
(ANI) (no. of dolphins from all on-effort sightings per 100 km of survey
effort) |
|
Primary Lines Only |
Primary Lines Only |
||
NEL |
Set 1: October 8th / 9th |
0.0 |
0.0 |
Set 2: October 14th / 29th |
0.0 |
0.0 |
|
NWL |
Set 1: October 8th / 9th |
1.7 |
1.7 |
Set 2: October 14th / 29th |
0.0 |
0.0 |
Note: Dolphin Encounter Rates are deduced from the Two Sets of Surveys (Two
Surveys in Each Set ) in October 2019 in Northeast
(NEL) and Northwest Lantau (NWL)
Table 2.10 Monthly
Average Encounter Rates
|
Encounter rate (STG)
(no. of on-effort dolphin sightings per 100 km of
survey effort) |
Encounter rate
(ANI) (no.
of dolphins from all on-effort sightings per 100 km of survey effort) |
||
Primary Lines Only |
Both Primary and Secondary Lines |
Primary Lines Only |
Both Primary and Secondary Lines |
|
Northeast Lantau |
0.0 |
0.0 |
0.0 |
0.0 |
Northwest Lantau |
0.9 |
0.6 |
0.9 |
0.6 |
Note: Overall dolphin
encounter rates (sightings per 100 km of survey effort) from all four surveys are conducted in October 2019 on primary lines only
as well as both primary lines and secondary lines in Northeast and Northwest
Lantau.
Due to monthly variation in dolphin occurrence within
the survey area, it would be more appropriate to draw conclusion on whether any
unacceptable impacts on dolphins have been detected in relation to the
construction activities of this Contract in the quarterly EM&A reports,
where comparison on distribution, group size and encounter rates of dolphins
between the quarterly impact monitoring period and baseline monitoring period
will be made.
Daily marine mammal exclusion zone was in effect during the period of
silt curtain installation in open waters under this Contract. No sighting
of the Indo-Pacific humpback dolphin Sousa chinensis
(i.e. Chinese White Dolphin) was recorded in October
2019 during the exclusion zone monitoring.
Site inspections were carried out on a weekly basis to monitor the
implementation of proper environmental pollution control and mitigation
measures under the Contract. In the reporting month, five (5) site
inspections were carried out on 2, 9, 16, 23 and 30 October
2019.
Key observations and
recommendations during the site inspections in this reporting period are summarized in Table 2.11.
Table 2.11
Specific Observations and Recommendations during the Weekly Site Inspection in
this Reporting Month
Inspection Date |
Observations |
Recommendations/
Remarks |
2 October 2019 |
Works Area – Portion N-A Ÿ Water spraying should be
applied on main haul road. Ÿ NRMM label on machine should be
fixed. Works Area – Portion S-B Ÿ Water spraying should be
applied on main haul road. Ÿ Food waste in the waste skip
should be cleared. Reminder from the SOR Works Area - Portion S-B Ÿ Cover of the water barrier
should be provided. |
Works Area – Portion N-A Ÿ The Contractor was reminded to
apply water spraying on the main haul road. Ÿ The Contractor was reminded to
fix the NRMM label on machine. Works Area – Portion S-B Ÿ The Contractor was reminded to
apply water sraying on the main haul road. Ÿ The Contractor was reminded to
clear the food waste in the waste skip. Reminder from the SOR Works Area - Portion S-B Ÿ The Contractor was reminded to
provide the cover of the water barrier. |
9 October 2019 |
Works Area – TBM tunnel Ÿ Food waste should be removed
and better housekeeping should be maintained. Works Area – Portion S-A Ÿ Cement bages
should be covered with tarpaulin sheets. Reminder from the SOR Works Area – TBM tunnel Ÿ Stagnant water should be
cleared. Works Area - Portion S-A Ÿ Stagnant water should be
cleared. |
Works Area – TBM tunnel Ÿ The Contractor was reminded to
remove the food waste and maintain better housekeeping. Works Area – Portion S-A Ÿ The Contractor was reminded to
cover the cement bags with tarpaulin sheets. Reminder from the SOR Works Area – TBM tunnel Ÿ The Contractor was reminded to
clear the stagnant water. Works Area - Portion S-A Ÿ The Contractor was reminded to
clear the stagnant water. |
16 October 2019 |
Works Area – Portion S-A Ÿ Faded NRMM label should be
replaced. Works Area – Portion S-B Ÿ Food waste in the skip should
be cleared. Works Area – Portion N-A Ÿ Drip tray should be provided
for the chemical containers. Reminder from the SOR Works Area – Portion S-A Ÿ Stagnant water should be
cleared. Works Area – Portion N-A Ÿ Lifting eyes should be filled
with sand. |
Works Area – Portion S-A Ÿ The Contractor was reminded to
replace the faded NRMM label. Works Area – Portion S-B Ÿ The Contractor was reminded to
clear the food waste in the skip. Works Area – Portion N-A Ÿ The Contractor was reminded to
provide drip tray for the chemical containers. Reminder from the SOR Works Area – Portion S-A Ÿ The Contractor was reminded to
clear the stagnant water. Works Area – Portion N-A Ÿ The Contractor was reminded to
fill the lifting eyes with sand. |
23 October 2019 |
Works Area – Portion S-A Ÿ Cement batching station should
be sheltered on top and 3 sides. Ÿ Cement bags should be covered
with tarpaulin sheets. Works Area – TBM tunnel Ÿ Cement bages
should be covered with tarpaulin sheets. Reminder from the SOR Works Area – TBM tunnel Ÿ Covers of the water barrier
should be provided. |
Works Area – Portion S-A Ÿ The Contractor was reminded to
shelter the cement batching station on top and 3 sides. Ÿ The Contractor was reminded to
cover the cement bags with tarpaulin sheets. Works Area – TBM tunnel Ÿ The Contractor was reminded to
cover the cement bags with tarpaulin sheets. Reminder from the SOR Works Area – TBM tunnel Ÿ The Contractor was reminded to
provide covers for the water barrier. |
30 October 2019 |
Works Area – Portion S-A Ÿ The faded NRMM label on the air
compressor should be replaced. Works Area – Portion S-B Ÿ Food waste should be removed. Works Area – Poriton N-A Ÿ Food waste from the skip should
be removed. Ÿ The damaged NRMM label should
be replaced. Reminder from the SOR Works Area – Portion N-A Ÿ The oil leakage should be
fixed. |
Works Area – Portion S-A Ÿ The Contractor was reminded to
replace the faded NRMM label on the air compressor. Works Area – Portion S-B Ÿ The Contractor was reminded to
remove the food waste. Works Area – Poriton N-A Ÿ The Contractor was reminded to
remove the food waste from the skip. Ÿ The Contractor was reminded to
replace the damaged NRMM label. Reminder from the SOR Works Area – Portion N-A Ÿ The Contractor was reminded to
fix the oil leakage. |
The Contractor has rectified
all of the observations as identified during environmental site inspections in
the reporting month.
The Contractor had submitted
application form for registration as chemical waste producer under the
Contract. Sufficient numbers of receptacles were available for general
refuse collection and sorting.
Wastes generated during this
reporting period included mainly construction wastes (inert and
non-inert). Reference has been made to the waste
flow table prepared by the Contractor (Appendix M). The quantities of different types of
wastes are summarized in Table 2.12.
Table 2.12
Quantities of Different Waste Generated in the Reporting Month
Month/Year |
Inert Construction Waste (a) (tonnes) |
Inert Construction Waste Re-used (tonnes) |
Non-inert Construction Waste (b) (tonnes) |
Recyclable Materials (c) (kg) |
Chemical Wastes (kg) |
Marine Sediment (m3) |
|||
Category L |
Category M (Mp & Mf) |
Mixed (L+M) |
|||||||
October 2019 |
8,366 |
0 |
754 |
524,090 |
5,800 |
0 |
0 |
0 |
|
Notes: |
|
||||||||
(a) Inert
construction wastes include hard rock and large broken concrete, and
materials disposed as public fill. (b) Non-inert
construction wastes include general refuse disposed at landfill. (c) Recyclable
materials include metals, paper, cardboard, plastics, timber and others. |
|
||||||||
The Contractor was advised
to properly maintain on site C&D materials and waste collection, sorting
and recording system, dispose of C&D materials and wastes at designated
ground and maximize reuse/ recycle of C&D materials and wastes. The
Contractor was also reminded to properly maintain the
site tidiness and dispose of the wastes accumulated on site regularly and
properly.
For chemical waste
containers, the Contractor was reminded to treat
properly and store temporarily in designated chemical waste storage area on
site in accordance with the Code of Practice on the Packaging, Labelling and
Storage of Chemical Wastes.
The status of environmental
licensing and permit is summarized in Table 2.13 below.
Table 2.13 Summary
of Environmental Licensing and Permit Status
License/ Permit |
License or Permit No. |
Date of Issue |
Date of Expiry |
License/ Permit Holder |
Remarks |
Environmental Permit |
EP-354/2009/D |
13 March 2015 |
Throughout the Contract |
HyD |
Application for VEP
on 3 March 2015 to supersede EP-354/2009/C |
Construction Dust Notification |
363510 |
19 August 2013 |
Throughout the Contract |
DBJV |
Northern
Landfall |
Construction Dust Notification |
403620 |
10 June 2016 |
Throughout the Contract |
DBJV |
Southern
Landfall |
Chemical Waste Registration |
5213-422-D2516-02 |
18 January 2017 |
Throughout the Contract |
DBJV |
Northern
Landfall |
Chemical Waste Registration |
5213-951-D2591-01 |
25 May 2016 |
Throughout the Contract |
DBJV |
Southern
Landfall |
Construction Waste Disposal Account |
7018108 |
28 August 2013 |
Throughout the Contract |
DBJV |
Waste disposal
in Contract No. HY/2012/08 |
Construction Waste Disposal Account |
7021715 |
4 July 2019 |
14 October 2019 |
DBJV |
Vessel Disposal |
Construction Waste Disposal Account |
7021715 |
4 October 2019 |
14 January 2020 |
DBJV |
Vessel Disposal |
Waste Water Discharge License |
WT00031435-2018 |
2 August 2018 |
31 August 2023 |
DBJV |
Southern
Landfall |
Waste Water Discharge License |
WT00034060-2019 |
25 July 2019 |
30 June 2024 |
DBJV |
Northern
Landfall (4 Discharge Point) |
Marine Dumping Permit |
EP/MD/20-013 |
19 May 2019 |
18 November 2019 |
DBJV |
Type 1 (Open Sea
Disposal) |
Construction
Noise Permit |
GW-RW0406-18 |
27 April 2019 |
15 October 2019 |
DBJV |
Urmston Road in front of Pillar Point |
Construction
Noise Permit |
GW-RW0406-18 |
17 October 2019 |
15 April 2020 |
DBJV |
Urmston Road in front of Pillar Point |
Construction
Noise Permit |
GW-RW0374-19 |
20 August 2019 |
19 February 2020 |
DBJV |
WA23 @ Tsing Yi |
Construction
Noise Permit |
GW-RS0766-19 |
2 September 2019 |
25 February 2020 |
DBJV |
Southern Landfall |
Construction
Noise Permit |
GW-RW0179-19 |
27 April 2019 |
15 October 2019 |
DBJV |
Urmston Road in front of Pillar Point |
Notes: |
|||||
HyD = Highways Department DBJV = Dragages
– Bouygues Joint Venture VEP = Variation of Environmental Permit
|
In response to the site
audit findings, the Contractors carried out all corrective actions.
A summary of the
Implementation Schedule of Environmental Mitigation Measures (EMIS) is presented in Appendix C. The necessary mitigation measures
relevant to this Contract were implemented properly.
Threes (3) Action Level
exceedance of 1-hour TSP Monitoring were recorded in the air quality monitoring
of this reporting month.
Two (2) Action Level
exceedances for Depth-averaged suspended soilds were recorded in the water quality monitoring of this
reporting month.
Cumulative statistics are provided in Appendix L.
The Environmental Complaint
Handling Procedure is provided in Figure 2.5.
No environmental complaint was received in this
reporting period.
No environmental summons was received in this reporting period.
Statistics on complaints,
notifications of summons and successful prosecutions are
summarized in Appendix
L.
As informed by the
Contractor, the major works for the Contract in November 2019 are summarized in Table 3.1.
Table
3.1 Construction Works to Be Undertaken in the Coming Month
Works to be
undertaken |
Land-based Works ·
Construction of Thermal barrier – TBM tunnel; ·
Construction of Walkway Corbel & Cover – TBM Tunnel; ·
Road & Drainage works – Portion N-A ·
Gantry Crane Removal – Portion N-B ·
RC structure – Portion S-A; ·
E&M Platform Installation – Portion S-A ·
Backfilling – Portion S-A & S-C; ·
Cut & Cover Tunnel RC structure – Portion S-C ·
Tower Crane Removal – Portion S-C Marine-based Works ·
Seawall Modification Works – Portion S-B |
Potential environmental impacts arising from the above upcoming
construction activities in the next reporting month of November 2019 are mainly
associated with dust, marine water quality, marine ecology and waste management
issues.
The tentative schedule for
environmental monitoring in November 2019 is provided in Appendix F.

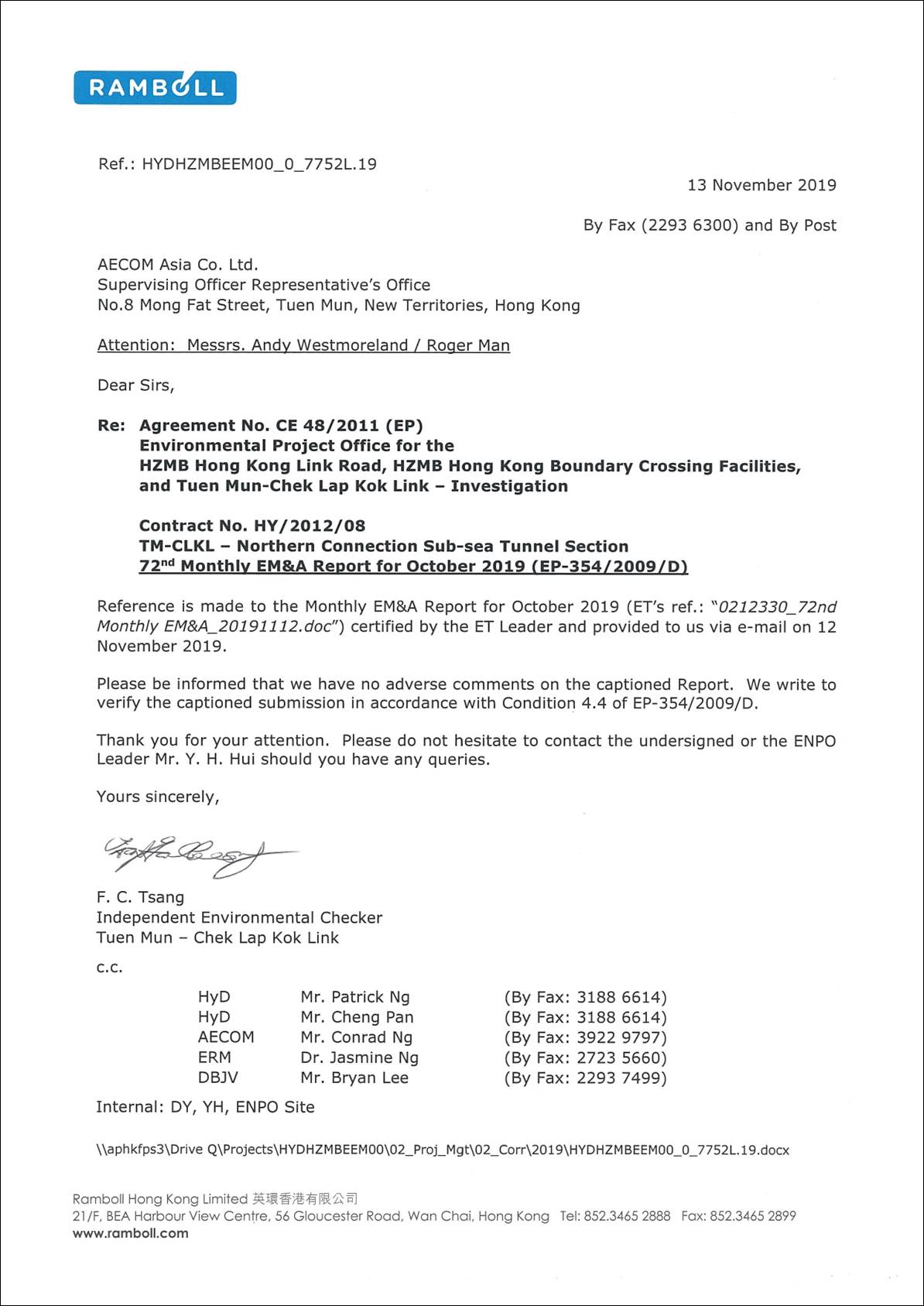

This Seventy-second
Monthly EM&A Report presents the findings of the
EM&A activities undertaken during the period from 1 to 31 October 2019, in
accordance with the Updated EM&A Manual and the requirements of
EP-354/2009/D.
Air quality (including 1-hour TSP and 24-hour TSP), water quality
monitoring and dolphin monitoring were carried out in
this reporting month.
Three (3) Action Level
exceedances of 1-hour TSP Monitoring were recorded in
the air quality monitoring of this reporting month.
Two (2) Action Level
exceedances for Depth-averaged suspended soilds were recorded in the water quality monitoring of this
reporting month.
One Chinese White Dolphins
sighting was recorded during the two sets of surveys
in October 2019. The dolphin sighting was made
in NWL, while none was sighted in NEL. The lone dolphin sighting was made during on-effort search and was made on primary
lines. The dolphin groups were not associated with any operating fishing
vessel.
Environmental site inspection was carried out
five (5) times in October 2019. Remedial actions recommended
for the deficiencies identified during the site audits were
properly implemented by the Contractor.
No non-compliance
event was recorded during the reporting period.
No environmental complaint was received in this
reporting period.
No environmental summons was received in this reporting period.
The ET will keep track on the construction works to confirm compliance
of environmental requirements and the proper implementation of all necessary
mitigation measures.
